Prefab Home Building Process Ontario: Complete Stage-by-Stage Guide for 2026
Building a prefab home in Ontario follows eight distinct stages — from initial design and site assessment through factory construction, delivery, on-site assembly, and final occupancy — with a total project timeline of four to eight months for most projects.
The central advantage of prefab construction is that factory build and site preparation occur simultaneously, compressing the overall construction timeline by three to six months compared to sequential traditional construction.
Understanding each stage before signing any contract is what separates Ontario prefab home buyers who reach occupancy on schedule from those who encounter delays, cost overruns, and financing gaps that could have been avoided.
Get a detailed cost estimate, build timeline, and expert guidance tailored to your Ontario property.
How the Prefab Home Building Process Differs From Traditional Construction
Most Ontario home buyers researching prefab arrive with one of two misconceptions — either that prefab is a lesser form of construction that cuts corners on quality, or that it is simply a faster version of the same site-built process.
Both assumptions are wrong, and both lead buyers to evaluate prefab homes in Ontario on the wrong criteria.
The prefab building process is not a faster version of conventional construction.
It is a fundamentally different construction methodology — one where the manufacturing process, the quality control regime, the inspection sequence, and the project timeline structure are all organized around a different logic than traditional homes built entirely on a jobsite.
The Parallel Build Advantage — Why Prefab Is Faster
The fundamental difference between prefab and site-built construction is not the factory — it is the simultaneity.
In traditional construction every stage must be completed sequentially before the next begins.
Foundation before framing, framing before mechanical rough-in, rough-in before insulation and vapour barrier, and so on through a linear twelve to eighteen month process where one delay cascades through every subsequent stage.
In prefab construction the factory build and the site preparation happen at the same time.
While your new home is being precision-built in a climate-controlled environment — framed, insulated, vapour barrier installed, mechanicals roughed in, interior finishes applied — your foundation is being excavated and poured, your site is being graded, and your utility access is being planned.
This parallel construction model is what compresses a twelve to eighteen month site-built timeline into four to eight months without compromising structural integrity or building quality.
What the Parallel Build Means for Your Ontario Project

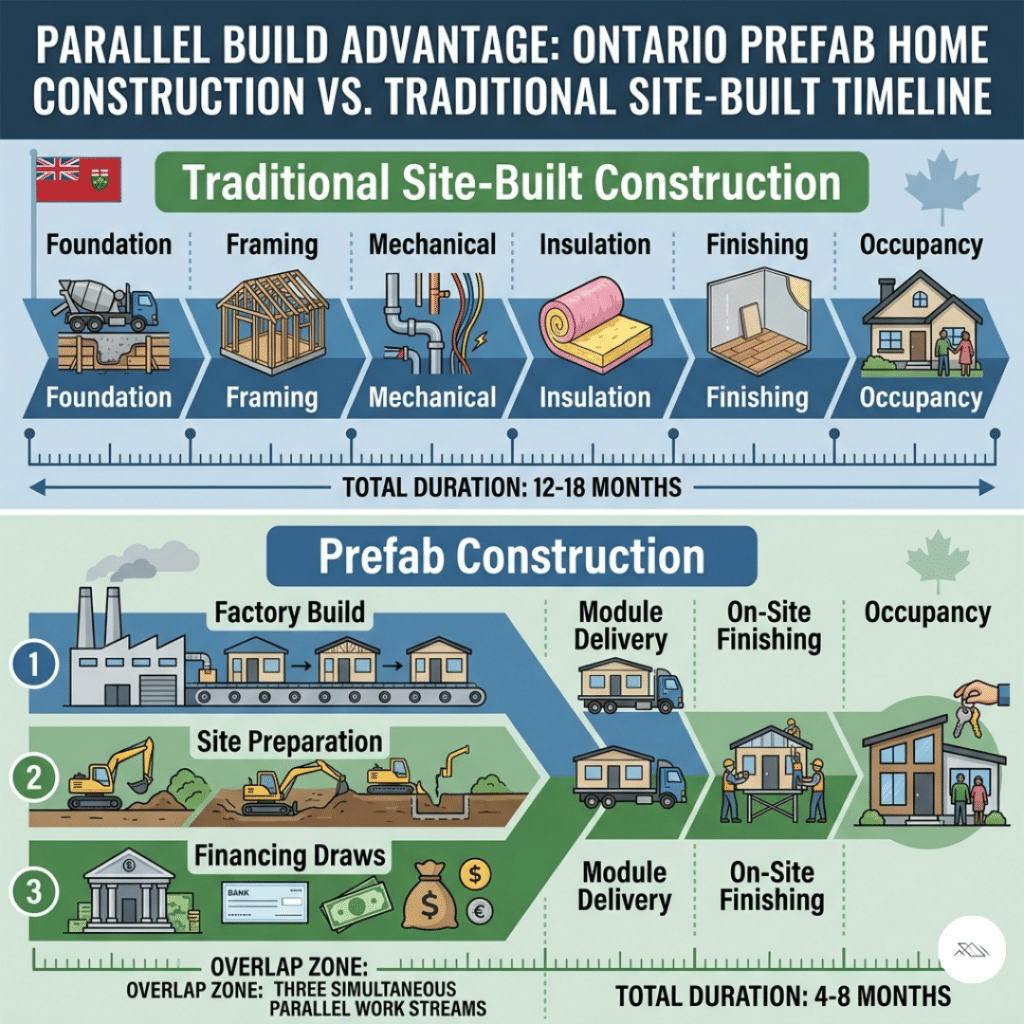

The diagram below shows why prefab construction compresses a twelve to eighteen month site-built timeline into four to eight months — not because corners are cut, but because three major work streams run simultaneously rather than sequentially.
The prefab advantage is simultaneity — factory construction and site work happen in parallel, compressing a 12–18 month timeline into 4–8 months without compromising quality.
For Ontario home buyers the parallel build advantage has three direct financial consequences beyond timeline compression.
• Construction mortgage interest is charged only during the build period — a four to eight month prefab timeline produces approximately $15,000 to $23,000 less construction interest than an eighteen month site-built timeline on a $400,000 loan.
• Seasonal scheduling is more achievable — a prefab build started in spring can reach occupancy before winter without the weather delays and weather conditions that push site-built projects into the following year.
• And the controlled factory environment produces a more consistent build outcome than traditional homes where weather conditions, labour shortages, and material delivery affect quality at every stage.
→ Prefab Home Financing Ontario — construction mortgage details | → Cost of Prefab Homes Ontario — complete pricing guide
The Eight Stages of the Ontario Prefab Home Building Process
The eight stages below represent the complete building process for a new prefab home in Ontario — from initial site assessment through final occupancy.
Stages 3, 4, and 5 occur simultaneously, which is where the prefab timeline advantage is created and where most Ontario home buyers are surprised by how much progress is happening in parallel.
Understanding the simultaneity of Stages 3, 4, and 5 is the most important conceptual shift any Ontario buyer can make before beginning a prefab construction project.
It is the mechanism behind the timeline advantage and the reason the building process produces a better outcome under Ontario’s challenging weather conditions than sequential site-built construction.

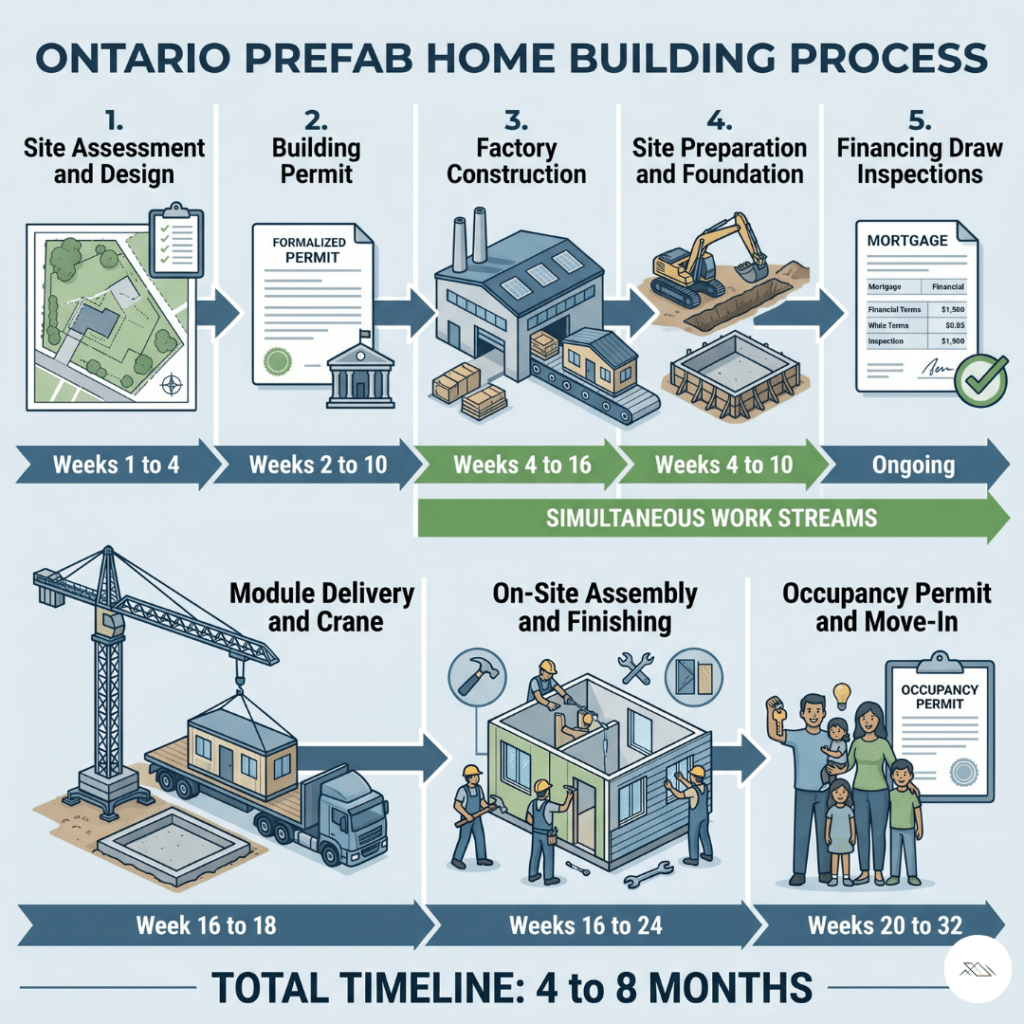

The eight stages below represent the complete building process for a new prefab home in Ontario.
Stages 3, 4, and 5 are shown overlapping — this is where the parallel build advantage is created and where three major work streams advance simultaneously.
The Ontario prefab process follows eight stages from site assessment to occupancy — with Stages 3–5 running in parallel to achieve a 4–8 month timeline.
Stage 1 — Site Assessment and Design Finalization
Timeline: Weeks 1–4
The prefab building process in Ontario begins before any house plans are finalized — with a site assessment that determines everything that follows.
The site assessment evaluates four variables that directly affect your foundation type, your site prep requirements, your utility access costs, and your permit application.
Soil conditions and bearing capacity determine which foundation types are structurally appropriate for your building site.
A site with unstable soil, poor drainage, or high water table eliminates slab on grade options and may require a full poured concrete foundation with drainage systems — increasing foundation construction costs meaningfully.
Sites with Canadian Shield bedrock require engineered pier systems designed for specific rock surface conditions.
A geotechnical soil assessment completed before contract signing eliminates soil condition surprises before they become project timeline problems.

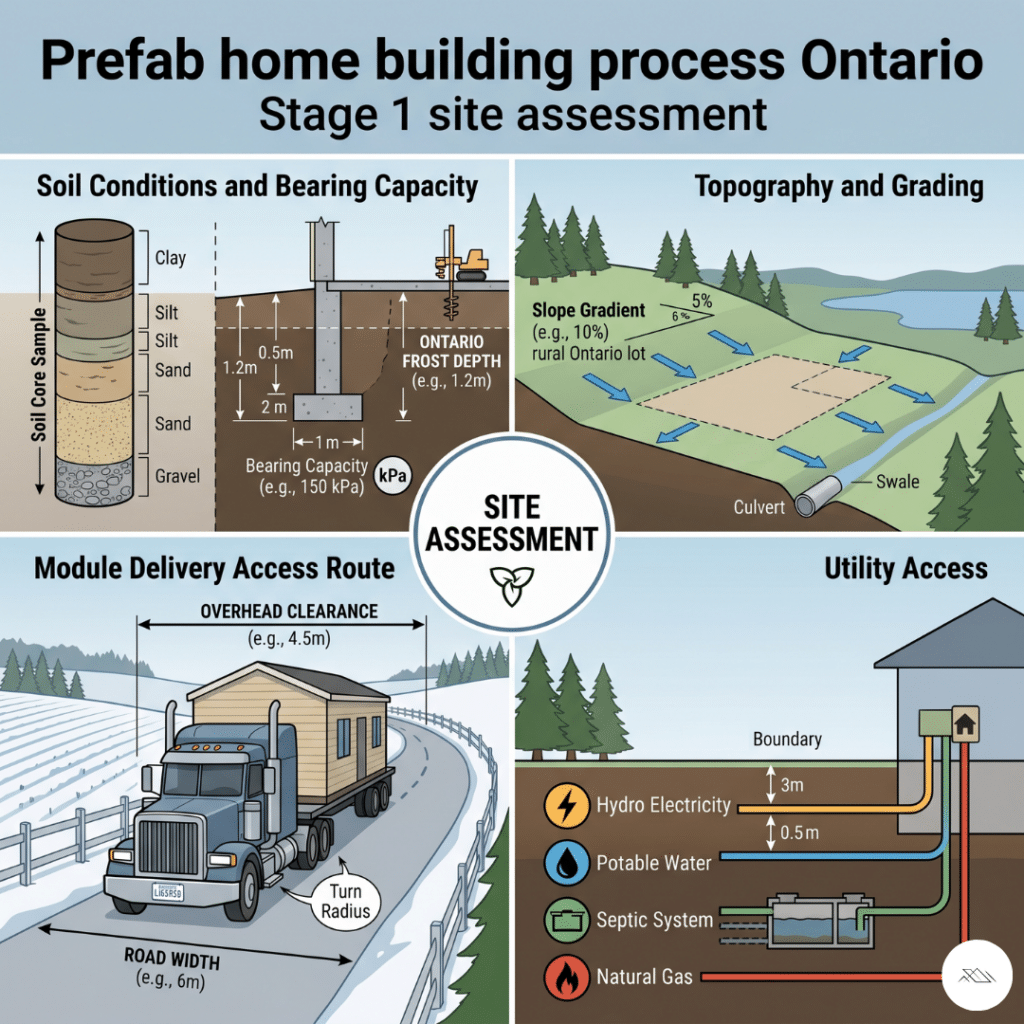

The four site variables below determine your foundation type, your site preparation costs, your permit application requirements, and your delivery logistics — all before a single drawing is finalized or a factory production slot is booked.
Stage 1 assesses four variables — soil, topography, delivery access, and utilities — to define foundation type, site costs, and feasibility, with early soil testing helping avoid costly surprises.
Topography and grading assess slope levels, drainage patterns, and the site work required before foundation excavation begins.
Significant slope on a rural lot may require substantial grading plans and earthwork before the foundation contractor can begin.
Flat, cleared sites with good drainage require minimal site work — typically $8,000 to $25,000.
Sloped lots or sites with drainage challenges may require $30,000 to $80,000 in site prep before foundation work begins.
Access routes for module delivery confirm whether standard flatbed transport systems are feasible or whether specialized delivery equipment is required.
Road width, overhead clearance for power lines, turn radius at the building site entry, and bridge weight ratings on township roads all affect delivery logistics and cost.
Rural lots in cottage country and Northern Ontario frequently require route assessment in Stage 1 — not as a delivery day afterthought.
Utility access availability — municipal water and sewer versus well and septic system, natural gas versus propane, hydro line proximity — determines the utility connection cost component of your total project budget.
Rural lots requiring well drilling and septic approvals add $25,000 to $70,000 to total project costs that must be budgeted and financed alongside the home package itself.
Once the site assessment is complete, the design process begins.
For buyers selecting from My Own Cottage’s model catalogue this stage involves confirming the floor plan, specifying design options and interior finishes, and receiving engineered drawings specific to your site conditions.
For buyers pursuing our custom builds or custom designs this stage includes architectural consultation, structural engineering, and energy-efficient building envelope design.
The end product of Stage 1 is a complete set of permit-ready drawings that can be submitted to the local municipality simultaneously with factory build preparation — eliminating the sequential delay that occurs when buyers wait until designs are finalized before beginning the approval process.
Stage 2 — Building Permit Application and Approval
Timeline: Weeks 2–10 depending on local municipality
Building permit approval in Ontario is the stage most home buyers underestimate — and the one most likely to determine your actual occupancy date.
Every prefab home requires a building permit from the local municipality where the home will be located regardless of where the manufacturing facility is situated.
The permit application must be submitted to the local municipality, not the provincial government and not the factory’s municipality.
The permit application package for a prefab home in Ontario must include engineered architectural drawings showing the complete home design and room sizes, a site plan showing foundation location and setbacks from property lines, and grading plans confirming drainage away from the structure.
Soil conditions and foundation engineering documentation must confirm that the chosen foundation type is appropriate for your specific site conditions, alongside CSA-A277 certification records from the manufacturing facility confirming factory construction meets Ontario Building Code requirements.
Zoning compliance confirmation that the proposed home meets local bylaws on lot coverage, setbacks, height, and land use designation must also be included.
Any property within conservation authority jurisdiction requires conservation authority approval before the municipal building permit review can proceed.
Municipal permit timelines vary significantly by location across Ontario. GTA municipalities typically process complete applications in four to eight weeks.
Rural municipalities in smaller Ontario counties can process permits in two to four weeks on straightforward applications — but timelines extend significantly when planning departments are understaffed or when the building site falls within conservation authority jurisdiction.
Properties in Agricultural designations or Greenbelt areas face the longest rural permit timelines — twelve to sixteen weeks is realistic when land use questions require additional review before the permit application can proceed.
Conservation authority jurisdiction is the permit consideration most commonly overlooked by buyers in Ontario cottage country and rural areas.
Properties within 30 to 120 metres of a watercourse, wetland, or floodplain require conservation authority approval before the municipal building permit can be issued — adding four to eight weeks to the approval process on waterfront and near-water rural lots.
Identifying conservation authority jurisdiction in Stage 1 rather than discovering it during the permit review prevents the most consequential timeline disruption in the Ontario prefab building process.
The critical planning insight is that your permit application should be submitted in the first weeks of the project — before factory production begins — so that permit approval and factory construction timelines align rather than sequence.
A permit that takes eight weeks is not a problem if the factory build takes eight weeks simultaneously.
It becomes a project timeline problem only if factory construction completes before the permit arrives and the delivery window cannot be held.
My Own Cottage submits complete permit-ready documentation packages for every Ontario build — covering every item the local municipality requires and specifically addressing any conservation authority, septic system, or rural servicing conditions that apply to your specific building site.
→ External link: Ontario Building Code
Stage 3 — Factory Construction in a Controlled Environment
Timeline: Weeks 4–16 concurrent with Stages 4 and 5
Factory construction is where the CSA-A277 certification standard earns its significance.
In a CSA certified manufacturing facility every prefab home is built on an assembly line production model — each module moving sequentially between specialized trade stations until complete.
Factory construction in a CSA-A277 certified manufacturing facility is fundamentally different from site-built construction in one critical way — every system is installed, inspected, and verified while still fully accessible, before any wall is closed and before any module leaves the facility.
Stage 3 takes place in a CSA A277 certified factory, where framing, insulation, mechanical systems, and finishes are completed on an assembly line under strict quality control — eliminating weather delays and build variability.
Framing, insulation, vapour barrier, mechanical rough-in, plumbing rough-in, electrical rough-in, drywall, interior finishes, wall panels, roof panels, and exterior cladding all occur in a controlled factory environment under quality control procedures that meet Canadian Standards Association audit requirements.
The controlled environment of factory construction eliminates the weather conditions that affect site-built construction quality at every stage.
Insulation and vapour barrier installed in a dry, climate-controlled factory setting achieve the airtightness specifications required for energy-efficient homes consistently — a standard that is genuinely difficult to replicate in site-built construction.
In conventional construction, weather conditions, labour shortages, and coordination gaps between sequential trades introduce quality variability at every stage of the building envelope installation.
The manufacturing process for a standard Ontario prefab home takes six to twelve weeks in the factory depending on model size, design complexity, and current production queue.
A compact two-bedroom model in the 900 to 1,200 square foot range typically reaches factory completion in six to eight weeks.
A full-sized family home in the 1,800 to 2,400 square foot range typically takes ten to twelve weeks.
Custom builds with non-standard design options may take twelve to sixteen weeks in the manufacturing facility.
During factory construction every module is inspected at multiple stages by CSA-A277 accredited third-party inspectors who verify compliance with Building Code requirements before the modules leave the facility.
This inspection sequence is one of the most misunderstood aspects of the prefab building process.
Many Ontario home buyers assume the factory build is less regulated than site-built construction.
In fact, the CSA-A277 quality control inspection regime is more rigorous than typical site-built construction inspections — every structural, mechanical, electrical, and insulation system is inspected while still fully accessible in the factory.
In site-built construction, many of these same systems are closed behind drywall before inspectors arrive, making comprehensive verification at every stage structurally impossible.
The inspection records travel with the modules and are presented to municipal building officials at the building site — eliminating the need for municipal inspectors to travel to the manufacturing facility while maintaining full Building Code requirements compliance throughout the construction project.
→ External link: CSA A277 — Canadian Standards Association
Stage 4 — Site Preparation and Foundation Construction
Timeline: Weeks 4–10 concurrent with Stage 3
While your home is being built in the manufacturing facility, your building site is being prepared to receive it.
Site preparation and foundation construction occur simultaneously with factory construction — this is the parallel build stage where the prefab timeline advantage over traditional construction is created.
Site preparation covers excavation and grading, tree removal if required, access route preparation for module delivery trucks, and preliminary utility trench work for underground services.
Stage 4 runs in parallel with factory construction — your foundation is excavated, formed, and poured while your home is built, compressing the total timeline to 4–8 months.
The scope and construction costs of site preparation vary significantly across Ontario’s diverse geography and soil conditions.
A flat, cleared rural lot with good road access and stable soil conditions requires minimal site work — typically $8,000 to $25,000.
A sloped lot in Muskoka or the Kawarthas with Canadian Shield bedrock, limited road access, and a long utility trench may require $40,000 to $80,000 in site prep before foundation work begins.
Foundation construction follows site preparation and must be complete and cured before module delivery.
Ontario prefab homes are installed on one of three foundation types.
A poured concrete full foundation provides basement storage and structural depth on stable soil conditions and is the most common foundation type for family-sized homes across Ontario.
A concrete slab on grade suits flat sites in southern Ontario where frost depth requirements are manageable and where the buyer does not require below-grade living space or crawl space storage.
Concrete piers or helical piers are engineered for waterfront sites with bedrock close to the surface, rocky terrain, or sites where excavation is impractical due to soil conditions or conservation authority restrictions.
Crawl space foundations — a shallow below-grade space that provides access to mechanical systems without full basement excavation — are increasingly common on rural lots where full foundation construction costs are high and where the buyer’s living space needs do not require below-grade rooms.
The foundation type is confirmed in the site assessment stage and engineered by a licensed structural engineer for your specific soil conditions and building site.
Concrete poured foundations typically require four to six weeks from pour to full cure strength capable of supporting module installation.
This timeline aligns with the factory construction schedule for most standard models — site preparation and foundation work beginning in Week 4 to 6 and completing by Week 10 to 14 to receive modules being produced simultaneously in the same period.
Stage 5 — Construction Mortgage Draw Inspections
Timeline: Ongoing through Stages 3, 4, 6, and 7
For the majority of Ontario home buyers financing through a construction mortgage, Stage 5 runs concurrently with every other stage — it is the financing event layer that overlays the physical building process and directly affects cash flow management throughout the construction project.
Construction mortgages release funds at verified milestones rather than as a lump sum at project start — and the lender requires an independent inspection confirming each milestone before releasing the next draw tranche.
The standard draw milestone sequence for an Ontario prefab construction mortgage follows four release points.
The initial deposit draw at contract signing covers the manufacturing facility deposit and permit fees.
The foundation draw at confirmed foundation completion covers site preparation and foundation construction costs.
The factory completion draw at confirmed CSA-A277 factory build completion covers manufacturing costs.
The final occupancy draw at confirmed occupancy permit covers on-site assembly and finishing costs.
The practical implication of this draw structure is that construction costs at each stage must be covered before the next draw is released — meaning cash flow management during the build period is a separate planning exercise from the financing approval itself.
Lead times between milestone completion and draw release — typically five to ten business days for inspection scheduling and fund processing — must be factored into the project timeline to prevent cash flow gaps that delay contractors waiting for funds to proceed to the next stage.
My Own Cottage provides clients with a milestone-aligned documentation schedule that confirms each draw trigger date before the construction project begins — eliminating the cash flow uncertainty that most commonly causes prefab projects to stall between draw releases.
→ Prefab Home Financing Ontario — complete construction mortgage guide
Stage 6 — Module Delivery and Crane Installation
Timeline: 1–3 days for delivery and placement
Module delivery day is the most visually dramatic moment in the prefab building process — and one of the most precisely choreographed.
Modules leave the manufacturing facility on specialized flatbed transport systems sized to Ontario’s highway and rural road dimension limits.
Delivery route planning begins in Stage 1 — confirming road width, bridge weight ratings on township roads, overhead clearance for power lines, and turning radius at the building site entry.
On delivery day a crane lifts each module from the transport vehicle and lowers it onto the permanent foundation in sequence.
A single-storey two-module home can typically be crane-set in a single day.
A larger multi-module home requires two to three days of crane work to set all modules and complete initial anchoring.
Once modules are set on the permanent foundation they are anchored, aligned, and connected to each other — both structurally and through the mechanical, electrical, and plumbing systems that were roughed in at the factory.
The factory module connections are designed to mate precisely at junction points, which is why the engineering drawings produced in Stage 1 must be finalized before factory construction begins.
Any change to module dimensions or junction point locations after factory production starts is extremely costly — prefab building is a high-quality, precision manufacturing process that rewards early design decisions and penalizes late changes more severely than traditional construction methods.
Regional delivery considerations in Ontario vary significantly by location.
Urban GTA lots may have power line clearance issues, narrow residential streets, or neighbouring structures that limit crane positioning — requiring specialized short-reach crane equipment or temporary power line lifting by the utility provider.
Rural Muskoka and Northern Ontario sites may have unpaved access routes, weight-restricted township roads, or seasonal restrictions on heavy vehicle access that require delivery timing to align with road condition windows.
These access conditions must be assessed and resolved in Stage 1 — not addressed for the first time on delivery day.
Stage 7 — On-Site Assembly and Finishing
Timeline: Weeks 14–24 depending on scope and design complexity
On-site assembly and finishing is the stage where factory-built modules become a complete, occupancy-ready primary residence.
Despite the majority of the home being built in the manufacturing facility, on-site work remains substantial and accounts for a significant portion of the total project timeline.
Rural lots requiring well and septic system completion, waterfront sites with conservation authority-restricted grading windows, and custom builds with elevated interior finishes specifications all extend the on-site stage meaningfully beyond the standard finishing scope.
On-site work covers utility hookups — connecting the home to municipal water and sewer or activating the well and septic system, completing gas or propane connections, and energizing the electrical service through the local hydro distribution connection.
Exterior finishing completes any siding, roofing, eavestroughing, and cladding work not completed at the factory — scope varies by model and package specification.
Connection point finishing seals and finishes the junction lines between modules, which are left accessible at the factory to allow for transport without damaging sealed surfaces.
Interior finishes complete any trim, cabinetry, fixture installation, or flooring work specified in the home package but not completed in the controlled environment.
On-site structure additions — decks, porches, garages, and front steps — are built during this stage and must be covered by the building permit and pass municipal inspection before the occupancy permit can be issued.
These additions are the most common source of Stage 7 timeline extension because they depend on contractors and material lead times that are outside the factory’s production control.
Labor costs for on-site assembly and finishing vary significantly by region. GTA and urban Ontario on-site labor costs are the highest in the province.
Northern Ontario and remote rural lots may have limited local trades availability — requiring contractors to travel to the building site at increased cost and with longer scheduling lead times.
Confirming on-site trades availability and lead times in Stage 1 prevents the most common Stage 7 schedule gap — a completed factory build waiting for an on-site finishing contractor with a six-week booking lead time.
Effective project management during Stage 7 requires coordinating between the module connection crew, the utility hookup trades, the exterior finishing contractors, and the on-site structure builders simultaneously.
My Own Cottage provides project management support through Stage 7 to ensure all on-site trades are sequenced correctly and that Building Code requirements for on-site work are met before the occupancy permit inspection is requested.
Stage 8 — Inspections, Occupancy Permit, and Move-In
Timeline: Weeks 20–32 from project start
The occupancy permit is issued by the local municipality after building officials confirm that all requirements of the building permit have been met on the completed home.
For a CSA-A277 certified prefab home the inspection package includes factory module inspection records from the accredited third-party inspector, foundation and site inspection confirmation from local building officials, and mechanical and electrical final inspections confirming all utility hookups are complete and safe.
The final occupancy inspection covers the completed on-site assembly and finishing work — once passed, the local municipality issues the occupancy permit and the home is cleared for move-in.
Stage 8 marks completion — the occupancy permit is issued, financing converts, and your home is move-in ready, typically within 4–8 months.
The home warranty enrollment must be confirmed before the occupancy permit application is submitted.
My Own Cottage homes are built by a builder registered with the Home Construction Regulatory Authority and enrolled in Tarion Warranty Corporation coverage — the Ontario statutory warranty program that protects every new home buyer in the province.
Coverage includes one year for workmanship and materials defects, two years for water penetration, and seven years for major structural defects.
This warranty coverage applies equally to prefab and site-built homes built by HCRA registered builders and is a legal requirement for most newly constructed homes sold to homeowners in Ontario.
Warranty coverage is also a financing requirement — most construction mortgage lenders require confirmation of Tarion enrollment or equivalent structural warranty coverage before issuing the final draw at occupancy.
Lenders view the warranty as a risk mitigation confirmation that the home meets Ontario’s highest standards for new residential construction.
Once the occupancy permit is issued the construction mortgage converts to a standard residential mortgage at current term rates.
This conversion ends the construction-period interest-only payment structure on staged draws and begins standard amortizing principal and interest payments on the full mortgage amount — the financing event that marks the transition from construction project to permanent primary residence.
→ External link: Tarion Warranty Corporation | → External link: HCRA Ontario Builder Directory
Ontario Prefab Building Process Timeline — What to Realistically Expect
The timeline below shows how all eight stages fit together across a typical Ontario prefab home project.
The overlap between Stages 3, 4, and 5 is where the prefab timeline advantage over traditional construction is created — and where most Ontario home buyers are surprised to discover that three major work streams are advancing simultaneously.
| Stage | Activity | Typical Timeline |
|---|---|---|
| Stage 1 | Site assessment and design finalization | Weeks 1–4 |
| Stage 2 | Building permit application and approval | Weeks 2–10 |
| Stage 3 | Factory construction | Weeks 4–16 |
| Stage 4 | Site preparation and foundation construction | Weeks 4–10 |
| Stage 5 | Construction mortgage draw inspections | Ongoing |
| Stage 6 | Module delivery and crane installation | Days within Week 16–18 |
| Stage 7 | On-site assembly and finishing | Weeks 16–24 |
| Stage 8 | Inspections and occupancy permit | Weeks 20–32 |
| Total | Project start to move-in | 4–8 months |
What Causes Timeline Extensions in Ontario
Municipal permit delays are the most common cause of construction timeline extension in Ontario prefab projects — particularly in municipalities with understaffed planning departments or where the building site falls within conservation authority jurisdiction or an Agricultural land use designation.
Properties affected by recent changes to land use planning rules under the More Homes Built Faster Act, 2022 can face additional review requirements that extend permit timelines beyond what buyers typically anticipate when setting their project start date.
Submitting a complete permit application package in Week 1 of the project rather than waiting until designs are fully finalized is the single most effective action a buyer can take to protect their project timeline.
Site conditions surprises — subsurface rock, poor drainage, contaminated soil, or utilities in unexpected locations — extend site preparation and foundation construction timelines by two to six weeks depending on the nature of the issue and the remediation required.
A geotechnical soil assessment completed before contract signing eliminates the majority of soil conditions surprises before they become construction project problems.
Utility connection delays — particularly hydro service connections in rural Ontario — can delay occupancy by four to eight weeks when distribution system upgrades are required for properties not currently served.
Confirming utility access connection timelines with the relevant provider before finalizing the project start date prevents this from becoming a late-project surprise that pushes a summer move-in into a winter occupancy.
Material lead times for specialty items — custom windows, specific exterior cladding systems, or engineered mechanical equipment — can extend Stage 7 finishing timelines if not ordered in Stage 1.
The controlled factory environment absorbs most material coordination efficiently for standard specifications.
Non-standard design flexibility choices with long manufacturing lead times must be identified in Stage 1 to prevent factory completion from waiting on undelivered components.
Labor shortages in specific trades — crane operators, utility connection specialists, or finishing contractors in rural and Northern Ontario markets — can add two to four weeks to delivery and finishing stage timelines when booking lead times are not confirmed early in the construction project.
Confirming all on-site trades availability and lead times in Stage 1 prevents the most common Stage 7 schedule gap.
Ontario Prefab Building Process — Regional Considerations
GTA and Urban Ontario
Urban Ontario builds face the most complex permit environments in the province — GTA municipalities have the highest permit fees, the most detailed application requirements, and the longest typical review timelines.
Development charges in high-growth GTA municipalities add $50,000 to $75,000 to total project costs for a single detached home.
More Homes Built Faster Act provisions have simplified some permitting requirements for garden suites, laneway homes, and accessory dwelling unit builds in GTA municipalities — making prefab garden suite and ADU construction more accessible than at any previous point in Ontario’s housing history.
Module delivery on dense urban GTA lots requires detailed route planning, potential traffic management permits, and crane positioning assessments that add construction costs and complexity to the delivery stage.
Lots with limited side access or neighbouring structures close to property lines require engineering assessment of crane reach and lift angles before delivery day planning is finalized.
These assessments must occur in Stage 1 to avoid delivery day surprises that delay installation.
Muskoka and Cottage Country
Cottage country builds in Muskoka, Haliburton, and the Kawarthas face the most geographically varied building conditions in Ontario.
Canadian Shield bedrock on waterfront rural lots eliminates slab foundation options and frequently requires engineered pier systems designed for specific rock surface conditions.
Conservation authority jurisdiction overlaps with municipal planning across most of Ontario’s cottage country regions — requiring conservation authority approval for any building within 30 to 120 metres of a watercourse or wetland before the municipal building permit can proceed.
Road access to waterfront and rural cottage country properties frequently requires assessment for heavy vehicle delivery — many township roads in Muskoka and Haliburton have seasonal weight restrictions that limit flatbed module delivery to specific calendar windows.
Planning delivery timing around these restrictions in Stage 1 rather than as a delivery day consideration prevents the most costly single delay in cottage country prefab projects.
Northern Ontario
Northern Ontario builds benefit most from the controlled factory environment because the energy-efficient building specifications required for cold climate performance are difficult to achieve consistently in site-built construction under Ontario’s northern weather conditions.
R-40 wall assemblies, triple-glazed windows, and high-performance airtightness detailing all demand installation precision that the factory setting delivers reliably — and that outdoor winter construction cannot.
The factory setting eliminates weather delays and cold-weather installation quality risks that are particularly consequential for high-performance building envelopes in Northern Ontario’s climate.
Longer delivery distances from southern Ontario manufacturing facilities to Northern Ontario building sites add transportation costs — typically $5,000 to $35,000 depending on distance and route complexity.
These costs must be included in the total project budget and financed as part of the construction mortgage.
Lower land costs in Northern Ontario municipalities partially offset the higher transportation and site preparation costs compared to equivalent GTA builds.
Rural Ontario
Rural lots requiring well drilling and septic system design and installation add $25,000 to $70,000 to total project costs above the home package price — costs that must be included in the construction mortgage financing or supplemented through HELOC or personal loan financing.
Septic approvals in Ontario can have four to twelve week lead times depending on municipality and the complexity of the percolation testing required.
Initiating septic approvals in Stage 1 simultaneously with the permit application prevents septic approval from becoming the critical path item that delays occupancy on rural Ontario builds.
Hydro service connections in rural Ontario where distribution line extension is required can add four to eight weeks of connection lead time that must be planned in Stage 1.
Unlike urban sites where hydro connection is a routine utility hookup, rural sites requiring distribution system upgrades involve utility planning timelines that are entirely outside the project team’s control.
Confirming hydro connection requirements and lead times with the local utility provider in Stage 1 is one of the highest-value planning actions available on any rural Ontario prefab project — and one of the most consistently overlooked.
→ Cost of Prefab Homes Ontario — regional cost breakdown | → Affordable Prefab Homes Ontario — full affordability guide
My Own Cottage — Managing the Ontario Prefab Building Process
Every My Own Cottage consultation begins with a complete site assessment and total project cost estimate for your specific Ontario property — covering site work, foundation type, utility access, permits, factory production scheduling, financing draw alignment, and on-site finishing.
All of this happens before you commit to anything.
My Own Cottage manages the complete eight-stage prefab building process for Ontario home buyers — from initial site assessment and permit application through factory construction in a controlled factory environment, module delivery, on-site assembly, and occupancy permit.
Every build includes a complete permit-ready documentation package covering site assessment, engineered drawings, CSA-A277 certification, construction timeline, and milestone-aligned financing draw schedule that meets both municipal and lender submission requirements simultaneously.
Every home is built to the highest standards in a CSA certified manufacturing facility and enrolled in Tarion home warranty coverage through a registered HCRA builder.
This means every My Own Cottage home qualifies for standard residential mortgage financing, CMHC insurance, and full Ontario statutory warranty coverage — regardless of model size or build location.
There’s no obligation.
We provide a complete project timeline and all-in cost estimate for your specific Ontario building site before you commit to anything.
We build and deliver across Ontario — from urban GTA lots and Ottawa properties to waterfront Muskoka builds, rural Ontario properties, and Northern Ontario sites including areas around Thunder Bay and beyond.
→ Prefab Homes for Sale Ontario — browse models by size and price | → Prefab Homes Ontario — complete hub
Frequently Asked Questions — Prefab Home Building Process Ontario
What are the steps involved in the prefab home building process in Ontario?
The Ontario prefab home building process follows eight distinct stages. Stage 1 is site assessment and design finalization — evaluating soil conditions, access routes, utility availability, and grading before engineering drawings are produced. Stage 2 is building permit application and approval from the local municipality — submitted simultaneously with Stage 3 to protect the project timeline. Stage 3 is factory construction in a CSA-A277 certified manufacturing facility — typically six to twelve weeks in a controlled environment. Stage 4 is site preparation and foundation construction — occurring simultaneously with Stage 3, which is where the prefab timeline advantage over conventional construction is created. Stage 5 is construction mortgage draw inspections — the financing event layer that runs concurrently through every build stage. Stage 6 is module delivery and crane installation — typically one to three days at the building site. Stage 7 is on-site assembly and finishing — utility hookups, exterior finishing, interior finishes, and on-site structure completion. Stage 8 is final inspections and occupancy permit — issued by the local municipality after all Building Code requirements are confirmed. Total timeline from project start to move-in is four to eight months for most Ontario prefab home projects.
How much does it typically cost to build a prefab home in Ontario?
Total prefab home project costs in Ontario typically range from $350,000 to $800,000 or more depending on model size, site conditions, location, and finish specifications — but the home package price is only one component of that total. The home package itself ranges from approximately $130 to $300 per square foot for the factory-built structure. Foundation construction adds $15,000 to $85,000 depending on foundation type and site conditions. Site preparation and grading adds $8,000 to $60,000 depending on terrain and rural servicing requirements. Utility connections add $8,000 to $70,000 depending on whether the property has municipal services or requires well and septic system installation. Building permits and development charges add $5,000 to $75,000 depending on municipality — GTA municipalities at the higher end, rural municipalities at the lower end. Delivery beyond the builder’s standard service radius adds $5,000 to $35,000 for remote Ontario sites. These additional costs collectively add $80,000 to $200,000 above the home package price on most Ontario prefab projects. My Own Cottage provides a complete all-in project cost estimate covering every line item before you commit to any model or sign any agreement — because approaching a lender with only the package price as your total project cost is the most common and most expensive mistake in Ontario prefab home planning.
What are the initial steps for building a prefab home in Ontario?
The first step in the Ontario prefab home building process is a site assessment — evaluating your specific property for soil conditions, foundation type suitability, access routes for module delivery, utility availability, and conservation authority jurisdiction. Site assessment results determine your foundation type, your site preparation costs, and the specific requirements your permit application must address. The second step, which should begin simultaneously with the site assessment, is selecting your home design and confirming your total project cost — model price plus all site costs — before approaching any lender for financing pre-approval. The third step is submitting your building permit application to the local municipality with a complete package of engineered drawings, site plan, grading plans, and CSA-A277 certification documentation. Submitting the permit application as early as possible in the process — before factory production begins — is the single most important timeline protection action available on any Ontario prefab project, because permit approval and factory construction can then occur simultaneously rather than sequentially. My Own Cottage recommends every buyer obtain mortgage pre-approval before model selection and submit their permit application before factory production is scheduled.
What permits are required for building a prefab home in Ontario?
Every prefab home in Ontario requires a building permit from the local municipality where the home will be located — regardless of where the manufacturing facility is situated. The building permit application must include engineered architectural drawings, a site plan showing foundation location and property line setbacks, grading plans, soil and foundation engineering, CSA-A277 certification documentation from the factory, and zoning compliance confirmation. Electrical and plumbing permits are typically required separately as part of the on-site completion work. Properties within conservation authority jurisdiction — typically within 30 to 120 metres of a watercourse or wetland — require conservation authority approval before the municipal building permit review can proceed, adding four to eight weeks to the approval timeline. Properties with private water and septic require septic system approval from the local health unit before the building permit is issued. Rural lots in Agricultural or Greenbelt land use designations may require additional provincial review under applicable land use planning legislation. My Own Cottage submits complete permit-ready documentation packages for every Ontario build, covering every item the local municipality requires and specifically addressing any conservation authority, septic approval, or rural servicing conditions that apply to your specific building site.
What are the Ontario Building Code requirements for modular homes?
All prefab and modular homes in Ontario must meet the same Ontario Building Code technical requirements as site-built homes — including foundation and anchorage specifications, room sizes and ceiling heights, structural requirements for snow and wind loads specific to the building location, plumbing, electrical, HVAC, fire safety, and energy efficiency standards. The primary mechanism for demonstrating Building Code compliance in factory-built construction is CSA-A277 certification — the Canadian Standards Association standard for factory quality control programs and module inspection. In a CSA-A277 certified manufacturing facility, accredited third-party inspectors verify Building Code compliance at multiple stages of factory production before modules leave the facility. Once modules arrive at the building site, municipal building officials verify that foundation construction, module anchoring, site connections, and all on-site finishing work meet Building Code requirements as covered in the building permit. The building permit holder — typically the builder — is responsible for ensuring that both the factory-built components and all site work meet applicable Building Code requirements throughout the construction project. If modules are purchased from a manufacturer outside Ontario, the buyer must confirm independently that the modules meet Ontario’s Building Code — being sold to an Ontario buyer does not automatically mean the product meets Ontario standards.
What site preparation is needed for a prefab home in Ontario?
Site preparation for a prefab home in Ontario covers four primary work areas before foundation construction can begin. Excavation and grading removes topsoil, establishes the building pad at the correct elevation, and creates drainage patterns that direct water away from the structure — scope and cost vary significantly based on lot topography and soil conditions. Tree removal and clearing prepares the building area and creates a clear access route for module delivery trucks and the crane on installation day — access route preparation is a site prep requirement that is frequently overlooked until delivery day planning begins. Utility trenching installs underground service lines for water, sewer, gas, and electrical conduit from the point of connection to the home’s service entry location — rural lots requiring long trench runs to reach well and septic locations or hydro service points add meaningfully to site preparation costs. Access road preparation on rural lots without paved road access to the building site may require gravel placement, culvert installation, or temporary road construction capable of supporting the weight of module transport vehicles and the crane. Total site preparation costs range from $8,000 to $25,000 on flat, cleared, serviced lots with good access to $40,000 to $80,000 on sloped, treed, or remote rural lots with complex access and servicing requirements.
Can I customize the design of a prefab home in Ontario?
Yes — the level of design customization available on an Ontario prefab home depends on the builder and the building system they use. At My Own Cottage, buyers can customize their home at multiple levels. Model selection provides a range of floor plans, room configurations, and square footage options designed for different site conditions and lifestyle needs — from compact two-bedroom models to full-sized family homes. Interior finish customization allows buyers to specify flooring, cabinetry, countertop, fixture, and trim specifications from a curated selection of high-quality options during the design process. Structural customization — modifying room layouts, window placement, ceiling heights, or exterior cladding systems — is available on custom build packages where the engineering drawings are developed from the buyer’s specific requirements rather than from a standard floor plan template. The key design process principle in prefab construction is that all customization decisions must be finalized before factory production begins — the precision manufacturing process that produces consistent quality and airtightness in the controlled factory environment requires complete, finalized drawings before the assembly line sequence starts. Design changes after factory production begins are extremely costly and can delay the construction timeline significantly. My Own Cottage guides every buyer through a complete design finalization process before any factory production is scheduled.
What financing options are available for prefab homes in Ontario?
Ontario prefab homes are financed through four primary structures depending on whether the home is under construction or already built and whether the land is owned or leased. A construction mortgage with staged progress draws is the most common financing structure for new Ontario prefab home builds — funds are released at verified build milestones rather than as a lump sum, and interest is charged only on the funds released at each stage. A completion mortgage releases the full mortgage amount in a single transaction once the home is installed and certified as complete — available for high factory-completion models where the majority of construction occurs in the factory before delivery. A standard residential mortgage applies to already-built CSA-A277 certified prefab homes permanently affixed to a foundation on owned land — same lenders, same rates, and same CMHC insurance eligibility as equivalent site-built homes. A HELOC or home equity loan finances garden suite and accessory dwelling unit builds on existing properties using equity in the existing home rather than a new construction mortgage. CMHC mortgage insurance is available for qualifying Ontario prefab home builds with as little as 5% down when the home is CSA-A277 certified, permanently affixed to a foundation, and used as the buyer’s owner-occupied primary residence on owned land. For a complete guide to construction mortgages, CMHC insurance, chattel versus traditional mortgages, HST rebates, and the five-step financing process specific to Ontario prefab home buyers, see our Prefab Home Financing Ontario guide.
How do financing draws align with the prefab building process stages?
Construction mortgage draw releases are tied to verified build milestones — meaning the financing timeline and the physical building timeline must be planned together from the start of the project. The initial deposit draw at contract signing covers the manufacturing facility deposit and permit application fees — typically 10% to 15% of the total project cost. The foundation draw releases when foundation construction is confirmed complete — covering site preparation and foundation costs that represent the largest single on-site expenditure before module delivery. The factory completion draw releases when CSA-A277 factory build completion is confirmed by the accredited third-party inspector — covering manufacturing costs that represent the largest single project expenditure. The final occupancy draw releases when the occupancy permit is issued — covering on-site assembly, finishing, and all remaining project costs. Each draw release requires an independent lender inspection confirming the milestone has been reached, with five to ten business days of processing time between inspection and fund release. Cash flow management between draw releases — covering contractor invoices that arrive before the next draw is processed — is the most common source of construction project stress for Ontario prefab home buyers who have not planned the draw timeline in detail before the build begins.
What happens on delivery day for a prefab home in Ontario?
Module delivery day begins with the arrival of specialized flatbed transport systems carrying the factory-built modules from the manufacturing facility to the building site. A crane lifts each module from the transport vehicle and lowers it onto the prepared permanent foundation in sequence — a single-storey two-module home can typically be crane-set in a single day, while a larger multi-module family home may require two to three days of crane work. Once modules are set on the foundation they are anchored, aligned, and initially connected at junction points where the mechanical, electrical, and plumbing systems roughed in at the factory mate with the corresponding connections in the adjacent module. Weather conditions on delivery day must be assessed in advance — wind speed limits apply to safe crane operations and may require rescheduling if conditions exceed safe operating thresholds. Regional access conditions affect delivery day planning significantly — urban GTA lots may require temporary power line lifting, traffic management permits, or specialized short-reach crane equipment, while rural and cottage country sites may have seasonal road weight restrictions that dictate the delivery window. Buyers are welcome to observe delivery day — it is the most visually distinctive moment of the entire construction project and the single event that most clearly communicates the efficiency advantage of prefab construction over traditional site-built methods.
What on-site work is required after the modules are delivered?
Substantial on-site work remains after module delivery regardless of the home package’s factory completion percentage. Utility hookups connect the home to municipal water and sewer or activate the well and septic system, complete gas or propane connections, and energize the electrical service through the local hydro distribution connection — all requiring licensed trades and utility provider coordination. Exterior finishing completes any siding, roofing, eavestroughing, and cladding work not factory-applied. Connection point finishing seals and finishes the junction lines between modules where they were left accessible for transport without damaging sealed surfaces. Interior finishing completes trim, fixture installation, and flooring work specified in the home package but not completed at the factory. On-site structures including decks, porches, front steps, and garages must be built, inspected, and passed before the occupancy permit can be issued. Rural lots requiring well and septic system completion, waterfront sites with conservation authority-restricted grading windows, and custom builds with elevated interior finishes specifications all extend the on-site stage meaningfully beyond standard finishing scope. Total on-site work duration ranges from four to ten weeks depending on home package size, design complexity, site conditions, and the scope of on-site structures included in the building permit.
Does Tarion warranty cover prefab homes in Ontario?
Yes — Ontario statutory warranty coverage under Tarion applies to prefab homes built by HCRA registered builders on permanent foundations in the same way it applies to site-built homes. My Own Cottage homes are built by a builder registered with the Home Construction Regulatory Authority and enrolled in Tarion Warranty Corporation coverage — the Ontario statutory warranty program that protects every new home buyer in the province. Coverage includes one year for workmanship and materials defects, two years for water penetration, and seven years for major structural defects. The home must be built on a permanent foundation, the builder must be licensed by the HCRA, and the home must be a new home sold to a homeowner rather than a self-build or owner-supplied materials project. Tarion enrollment is also a requirement of most construction mortgage lenders — confirming enrollment before the occupancy permit application is submitted satisfies both the regulatory requirement and the lender’s final draw release condition simultaneously. Buyers can verify builder registration through the HCRA Ontario Builder Directory before signing any contract.
What is the prefab building process for a garden suite or ADU in Ontario?
The prefab building process for a garden suite or accessory dwelling unit on an existing Ontario property follows the same eight stages as a primary home build — site assessment, building permit, factory construction, site preparation, module delivery, on-site assembly, and occupancy permit — with several important distinctions specific to secondary dwelling construction. The site assessment must evaluate the existing property’s utility capacity to support a secondary dwelling, setback distances from the existing home and property lines, and access routes for module delivery through or around the existing property. The building permit application must confirm that the ADU meets local zoning bylaws for secondary dwellings — More Homes Built Faster Act provisions have simplified ADU permitting in many Ontario municipalities and eliminated development charges for qualifying garden suite builds, meaningfully reducing total project costs. Foundation type for a garden suite is typically a slab on grade or concrete piers to minimize excavation impact on the existing property. HELOC financing using equity in the existing property is the most common financing structure for garden suite builds — eliminating the draw inspection sequence of a construction mortgage and providing flexible cash flow management throughout the construction project. A garden suite generating $1,800 to $2,500 per month in rental income can effectively service the HELOC debt independently, making it one of the strongest investment cases available to Ontario property owners in the current housing market.
Can I visit the factory during my home’s construction?
Yes — factory tours during the construction project are available and encouraged for My Own Cottage buyers. Seeing your home at various stages of the manufacturing process in the controlled factory environment is the most effective way to understand the quality control advantages of CSA-A277 certified factory construction over conventional site-built methods. You can observe the assembly line production process, see the third-party inspection regime in action, and verify the construction materials and specifications being applied to your specific build at close range — something that is impossible to do on a site-built construction project where systems are closed behind drywall before most buyers visit the site. Factory visits are coordinated with the production schedule to ensure your visit aligns with stages of the construction project that are visually informative and do not disrupt the production workflow. Framing and structural stage visits show the building envelope and structural system clearly. Mechanical and insulation stage visits demonstrate the vapour barrier, insulation installation, and airtightness detailing that produces the energy-efficient performance specifications your home is designed to achieve. Contact My Own Cottage to schedule your factory visit at the stage of the build that best matches your interests.
Ready to Begin Your Ontario Prefab Home Building Process?
Understanding the complete eight-stage building process before signing any contract is what separates Ontario home buyers who reach occupancy on schedule — on their timeline, within their budget — from those who encounter delays, cost overruns, and financing gaps.
Better preparation is the difference, and it starts before any model is selected or any contract is signed.
My Own Cottage walks every Ontario buyer through a complete project assessment before any commitment is made — site evaluation, permit requirements, factory production scheduling, financing draw alignment, and total project cost specific to your land, your model, and your timeline.
No surprises. No hidden costs. No pressure.
Just honest numbers and a clear eight-stage process map for your specific Ontario build.
🧑💼 Request a Free Consultation
📲 Call Us Directly: (705) 345-9337
🏘️ View Our Design Catalogue
✅ Ontario-Built | ⚡ Energy-Efficient | 🏡 Fully Customizable | 🚚 Fast Delivery
Alternatively, for your convenience, you can also simply fill out the contact form below and we’ll get back to you soon! 👇
Verified External Resources
Ontario Building Code — Official provincial regulations governing prefab and modular home construction in Ontario.
CSA A277 — Canadian Standards Association certification standard for factory construction quality control.
Tarion Warranty Corporation — Ontario’s new home warranty provider covering statutory warranty coverage for prefab homes built by registered builders.
HCRA — Home Construction Regulatory Authority — Ontario Builder Directory confirming registered builder licensing for new home construction.
CMHC — Canada Mortgage and Housing Corporation — Federal housing authority covering modular and prefab home financing eligibility.
