Prefab Home Permits Ontario: Costs, CSA A277, and What to Decide Before You Apply (2026)

Every prefab home in Ontario requires a building permit from the local municipality where the home will be located — regardless of where the manufacturing facility is situated or how much of the structure was completed in a controlled environment.

For CSA A277 certified factory-built homes, the permit documentation package includes factory inspection records that satisfy Ontario Building Code requirements at the municipal level, significantly simplifying the approval process compared to non-certified construction.

Plan your permit, timeline, and budget with a prefab specialist before you apply.

Last updated: April 17th, 2026
Written by building specialists at My Own Cottage

What most Ontario homeowners do not realize before signing a builder contract is that the permit process is not primarily a regulatory exercise — it is a financial planning exercise.

The decisions you make before submitting your building permit application determine your timeline, your total permit cost, and whether your Tarion warranty coverage applies at all.

This guide covers those decisions with specific numbers rather than general guidance, because the difference between a $4,791 permit in the Town of Lincoln and a $8,073 permit in Perth — on the same 300 square metre home — is a financial decision disguised as a regulatory one.

Do Prefab Homes Need a Building Permit in Ontario?

Yes — prefab homes in Ontario require a building permit from the local municipality where the home will be located.

This applies to every construction method — modular, panelized, kit, and factory-built homes of every type — and to every project size from a small house or garden suite to a full-sized family home.

The building permit requirement applies regardless of whether modules are CSA A277 certified and regardless of how complete the factory build is when modules arrive at the building site.

What CSA A277 factory certification changes is the inspection pathway — not the permit requirement itself.

A CSA-certified prefab modular home still requires a building permit, site inspections, and an occupancy permit from the local municipality.

The certification determines how the factory-built components are inspected and who conducts those inspections, which has significant consequences for your timeline and your administrative burden.

Ontario’s Building Code — O. Reg. 332/12 — applies to all residential buildings including every prefab and modular home regardless of where the manufacturing process occurred.

Part 9 of Ontario’s Building Code governs houses and small buildings.

Part 8 governs on-site sewage systems on rural properties without municipal services.

The Ontario Building Code requirements apply equally to prefab modular homes and traditional homes built entirely on a jobsite — the construction methods differ, but the technical requirements do not.

One persistent misconception worth addressing directly: Ontario does not enforce a province-wide minimum floor area for permanent dwellings.

The Ontario Building Code sets minimum room sizes — a bedroom must be at least 7 square metres, habitable rooms must have a minimum ceiling height of 2.1 metres — but there is no prescribed minimum gross floor area for a single detached dwelling.

A 200 square foot tiny home on a permanent foundation is legally possible under the Ontario Building Code if all room, egress, fire safety, and service requirements are met.

Minimum size, where it exists, is set at the municipal zoning level — not the provincial building code level.

External link: Ontario Building Code O. Reg. 332/12

The Decision That Determines Your Permit Timeline — CSA A277 Certified or Not

The single most consequential decision in the Ontario prefab home permit process is one that most property owners make without realizing it is a decision at all — whether to work with a CSA A277 certified modular home builder or a non-certified manufacturer.

This choice determines which of two fundamentally different inspection pathways your project follows, and the two pathways produce dramatically different outcomes in terms of timeline, administrative complexity, and financial certainty.

The two inspection pathways below produce fundamentally different permit experiences — one predictable and documentation-driven, one negotiated and municipality-dependent.

The pathway is determined entirely by whether the manufacturing facility holds CSA A277 certification.

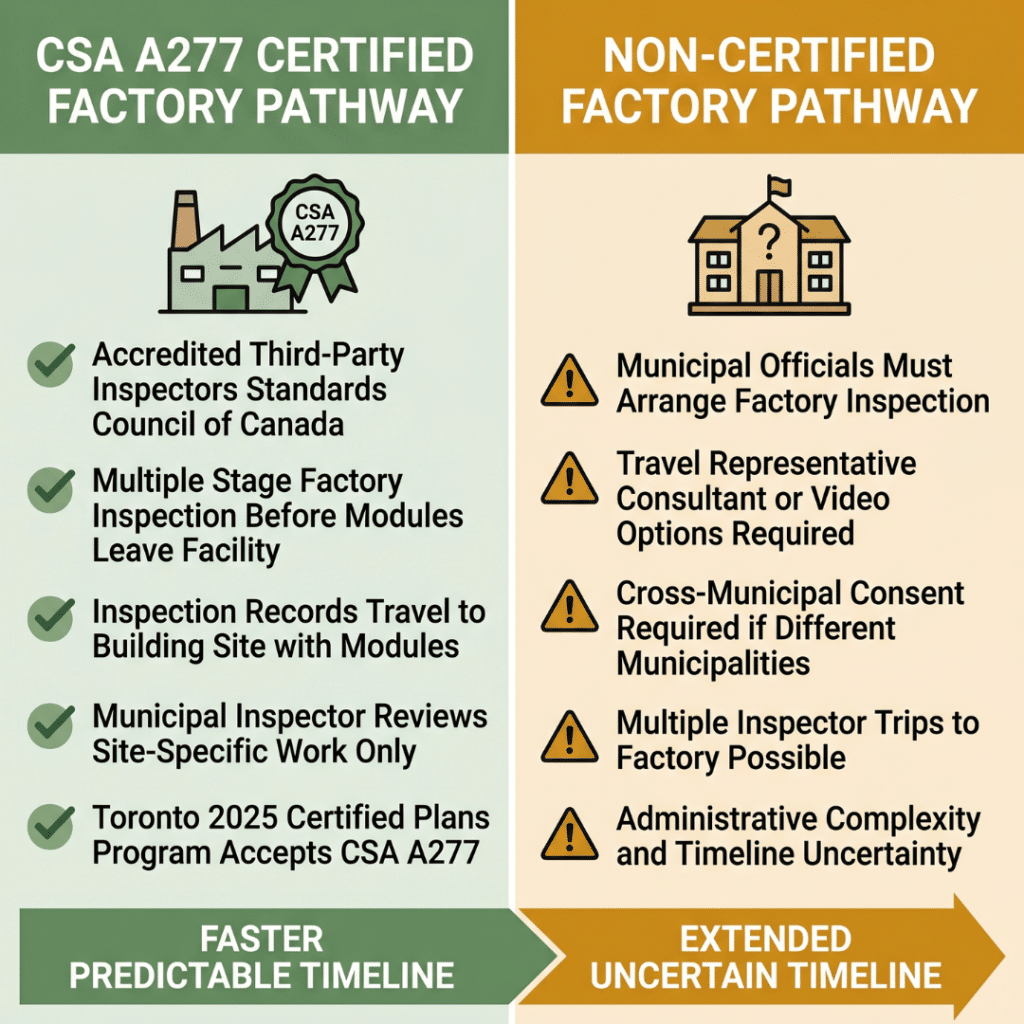

Prefab home permits Ontario CSA A277 certified factory inspection pathway versus non-certified municipally-led inspection pathway comparison showing accredited Standards Council of Canada third-party inspector process producing permit-ready documentation for municipal building official versus complex municipal official travel appointment representative or video inspection requirement adding weeks of administrative complexity and timeline uncertainty to Ontario building permit approval

Two permit pathways exist for Ontario prefab homes: CSA A277 certified factories use accredited third-party inspections with documentation delivered to site, while non-certified builds require municipally coordinated factory inspections. The certified pathway is faster, more predictable, and less administratively complex — now recognized by Toronto’s 2025 Certified Plans Program.

The CSA A277 Certified Pathway — What It Does for Your Timeline

CSA A277 is the Canadian Standards Association standard for factory certification of buildings — specifically, the procedure for factory certification that governs how prefab and modular construction facilities are audited, how individual modules are inspected, and how compliance documentation is produced and transferred to municipal building officials.

When modules are built in a CSA-certified manufacturing facility, accredited third-party inspectors authorized by the Standards Council of Canada verify compliance with Ontario Building Code requirements at multiple stages of the manufacturing process.

Framing and structural systems, insulation and vapour barrier, mechanical systems rough-in, plumbing rough-in, and electrical rough-in are all inspected and verified in the controlled environment of the factory — while still fully accessible — before any module leaves the manufacturing facility.

The CSA A277 certification records and factory inspection documentation travel with the modules to the building site and are presented to municipal building officials at the time of installation.

The building inspector then focuses their inspection on site-specific work — foundation construction, grading, module anchoring, utility connections, and on-site finishing — rather than independently verifying the factory-built systems that the CSA standards inspection has already certified.

This is the mechanism that makes the certified pathway faster and more predictable.

My Own Cottage builds every home in a CSA A277 certified manufacturing facility and provides the complete factory certification documentation package as part of the building permit application for every Ontario build.

The Non-Certified Pathway — What It Requires From You

When modules are not built under CSA A277 factory certification, building officials from the municipality that issued the building permit must inspect the modules — at the manufacturing facility — before they can leave.

The municipality has options: officials may travel to the factory at the project’s expense, appoint a qualified representative, accept reports from engineers or architects retained by the permit holder, or use alternative inspection methods such as live video.

Each option adds administrative complexity that the certified pathway eliminates.

If the manufacturing facility is in a different municipality from where the home will be installed, the building officials from the home’s municipality must consent to the inspection process before any module production can begin.

Multiple site inspections by municipal officials may be required during factory construction.

The homeowner must negotiate the inspection approach before factory production starts — adding uncertainty at the most time-sensitive stage of the project.

If you are purchasing modules from a supplier outside Ontario, you must independently confirm that those modules meet Ontario’s Building Code.

Being sold to an Ontario buyer does not automatically mean the product meets Ontario Building Code requirements — this is a risk that buyers researching lower-cost imported modules must understand before signing any contract.

Toronto’s 2025 Policy Change — What CSA A277 Now Means in Ontario’s Largest Market

Toronto’s Certified Plans Program — expanded in March 2025 — represents the most significant municipal endorsement of CSA A277 certified factory construction in Ontario’s history.

Toronto Building now accepts CSA A277 certification in lieu of conducting its own factory inspections.

The Certified Plans Program expansion now covers modular homes, garden suites, laneway homes, and multiplexes — allowing pre-reviewed drawings to bypass full plan examination and compress permit timelines substantially.

This means a property owner in Toronto working with a CSA A277 certified modular home builder benefits from both the streamlined factory inspection pathway and the Certified Plans Program’s accelerated review — a dual advantage unavailable to non-certified builders in the same market.

This 2025 policy change has not been covered in any Ontario prefab home guide available to buyers today — making it the most significant Toronto-specific permit development that most GTA prefab buyers are currently unaware of.

It represents the most current Toronto-specific permit advantage available to prefab buyers in 2026, and it is available exclusively to buyers working with CSA A277 certified builders.

External link: CSA A277 — Canadian Standards Association | → External link: Toronto Building — Certified Plans Program Backgrounder 2025 | → External link: CHBA — Code Compliance for Modular Construction

What Ontario Prefab Home Permits Actually Cost — By Municipality

Until now, Ontario homeowners researching prefab home permits have had no way to compare building permit costs across municipalities before choosing a build location.

The verified 2024-2025 fee data below fills that gap — giving property owners the specific numbers needed to make site-selection decisions before signing any contract.

Municipal Permit Fee Comparison — 300 m² Prefab Home

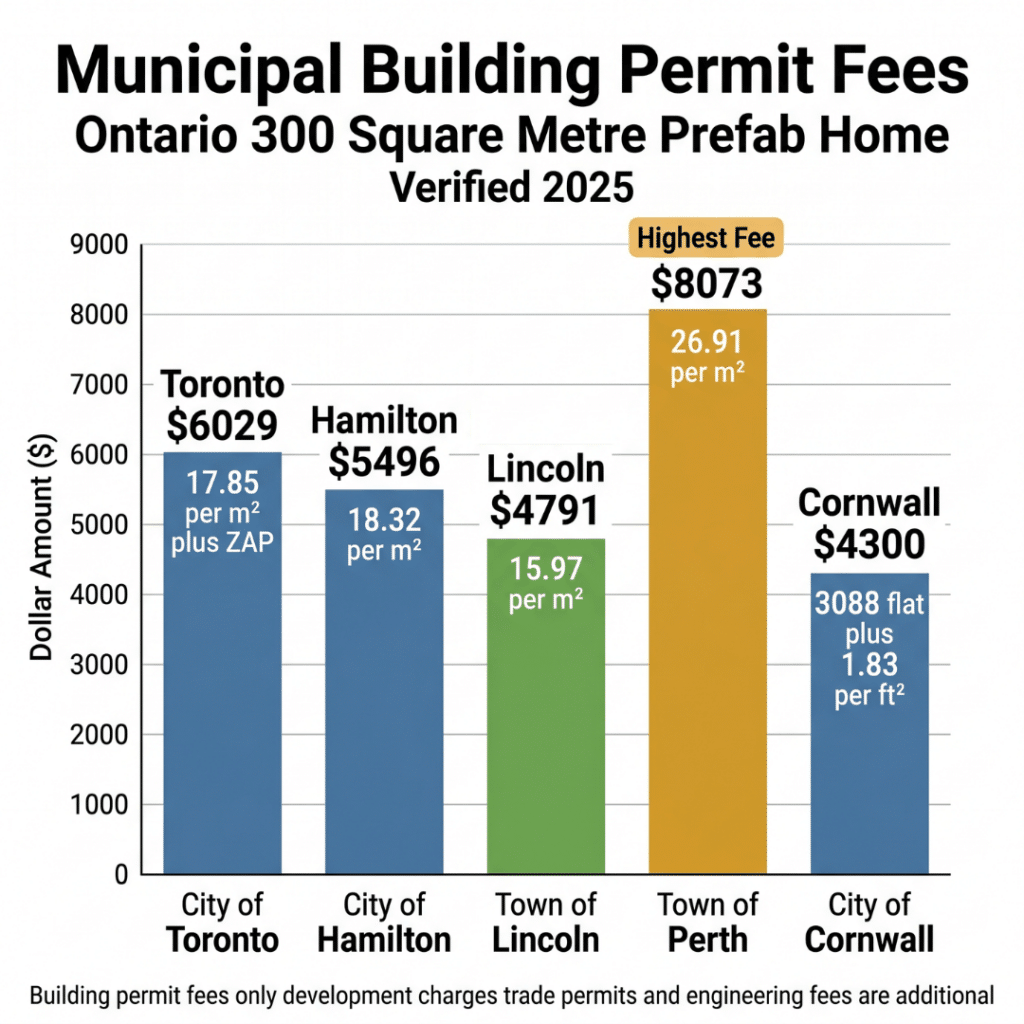

Prefab home permits Ontario municipal building permit fee comparison bar chart showing verified 2025 fee data for City of Toronto approximately $6,029 City of Hamilton approximately $5,496 Town of Lincoln approximately $4,791 lowest fee Town of Perth approximately $8,073 highest fee and City of Cornwall approximately $4,300 on a standard 300 square metre prefab home with note that building permit fees only excludes development charges trade permits and engineering fees

2025 permit fees for a 300 m² prefab home range from $4,300 (Cornwall) to $8,073 (Perth) — a $3,782 difference before other costs. Municipality choice impacts total project cost.

The table below presents the data in a convenient text format for additional reference.

MunicipalityPermit Fee StructureApprox. Cost on 300 m² Home
City of Toronto$17.85/m² + $619.60 ZAP + $54.16/unit~$6,029
City of Hamilton$18.32/m²~$5,496
Town of Lincoln$15.97/m²~$4,791
Town of Perth~$26.91/m² (~$2.50/ft²)~$8,073
City of Cornwall$3,088 flat + $1.83/ft² over 1,400 ft²~$4,300

These verified permit fees represent only the building permit itself — electrical permits, plumbing permits, septic system permits on rural properties, and development charges are additional costs that vary further by municipality and project type.

Budget $3,500 to $13,500 for total permit-related costs excluding development charges on most Ontario residential prefab home projects.

See our Cost of Prefab Homes Ontario guide for the complete all-in project cost breakdown including home package, site preparation, foundation, and utility connection costs.

Development Charges — The Largest Variable Permit Cost

Development charges are municipal fees collected at the time of permit issuance to fund local infrastructure growth.

They represent the single most variable cost in the Ontario prefab home permit picture — ranging from zero in some rural municipalities to $50,000 to $75,000 in high-growth GTA municipalities for a single detached home.

The More Homes Built Faster Act, 2022 — Bill 23 — eliminated development charges for qualifying accessory residential units and garden suites across Ontario.

For a property owner adding a prefab garden suite to an existing urban residential lot, this elimination represents a direct reduction in total project cost that can reach $20,000 to $30,000 in GTA municipalities before a single dollar of construction is spent.

The development charge elimination is the most significant financial consequence of Bill 23 for prefab garden suite projects and the one most commonly overlooked when buyers calculate their total project budget.

Confirm development charge treatment with the specific local municipality before finalizing any project budget.

Municipal bylaws vary and some municipalities have applied specific conditions to exemptions beyond the provincial minimum requirements.

What Permit Costs You Cannot Control and What You Can

Permit fees and development charges are largely determined by municipal location — a site-selection decision made before the permit process begins.

Engineering fees — P.Eng-sealed structural drawings for foundations, crane-set connections, and custom configurations — add $3,000 to $8,000 to total pre-construction professional costs and are required regardless of municipality.

Conservation Authority permit fees add $500 to $3,000 on properties within regulated areas.

The controllable variables are builder selection and municipal location.

A CSA A277 certified builder who provides a complete permit-ready documentation package eliminates the engineering coordination costs that buyers managing the permit process independently must commission separately.

Choosing a building site in a municipality with a lower permit fee structure — or one where the Certified Plans Program applies — can reduce permit-stage costs by $2,000 to $4,000 on an equivalent project.

External link: More Homes Built Faster Act

The Five Decisions That Determine Your Permit Experience

Every Ontario prefab home permit journey is shaped by five decisions — most of which are made before the building permit application is submitted and all of which carry direct financial consequences.

The five decisions below are made before the building permit application is submitted — and each one carries a direct financial consequence that determines your total permit cost, your timeline, and whether your warranty and financing apply as expected.

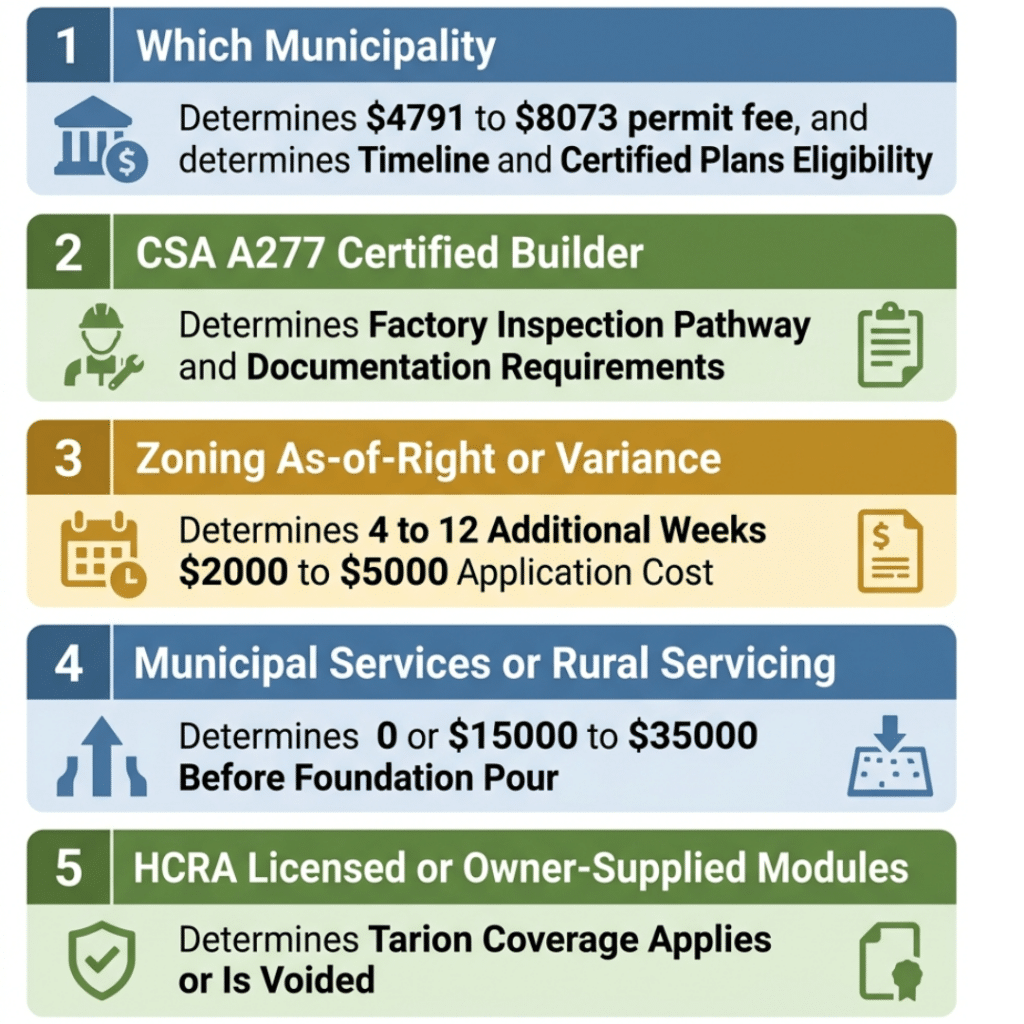

Prefab home permits Ontario five pre-application decisions framework showing Decision 1 which municipality determines permit fee $4,791 to $8,073 and timeline Decision 2 CSA A277 certified builder determines factory inspection pathway and weeks of timeline Decision 3 zoning as-of-right or variance determines four to twelve additional weeks and $2,000 to $5,000 Decision 4 municipal services or rural servicing determines zero or $15,000 to $35,000 Part 8 septic costs Decision 5 HCRA licensed full service or owner supplied modules determines Tarion warranty coverage applicability each with financial consequence stated

Five pre-application decisions — location, builder certification, zoning, servicing, and procurement — determine timeline, complexity, and total project cost.

Decision 1 — Which Municipality? Determines Permit Fee, Timeline, and Certified Plans Eligibility

Municipal location determines permit fee structure, development charge exposure, permit processing timeline, Conservation Authority jurisdiction, and — for Toronto builds — eligibility for the Certified Plans Program.

The difference between the lowest and highest municipal permit fees in this comparison represents a $3,282 spread on a 300 square metre home before any other costs are considered.

The development charge differential between a rural Ontario municipality and a high-growth GTA municipality can represent $50,000 to $75,000 in additional project cost on the same home.

Municipal location is the highest-leverage site-selection decision available to any Ontario prefab home buyer.

Decision 2 — CSA A277 Certified Builder? Determines Inspection Pathway and Documentation Requirements

Choosing a CSA A277 certified modular home builder over a non-certified manufacturer determines whether the factory inspection occurs through accredited third-party inspectors with documentation provided to your municipality — or through a municipally-led process requiring negotiation, travel, and multiple inspections at your expense.

The certified pathway eliminates weeks of administrative process and several thousand dollars in inspection coordination costs.

It also determines whether a Toronto property owner qualifies for the Certified Plans Program timeline compression.

My Own Cottage provides the complete CSA A277 certification or equivalent documentation package for every Ontario build as a standard part of the building permit application — eliminating independent engineering and documentation costs for homeowners.

Ready to browse models from a CSA A277 certified Ontario builder? See our Prefab Homes for Sale Ontario catalogue — floor plans, specifications, and pricing for every model we deliver across the province.

Decision 3 — Zoning As-of-Right or Variance Required? Determines Four to Twelve Additional Weeks

Confirming zoning compliance before commissioning any drawings or scheduling factory production is the first step that protects every Ontario prefab home project timeline.

If the proposed home complies as-of-right with the local municipality’s zoning by-laws — meeting all lot coverage, setback, height, and use requirements without exception — the building permit application can proceed immediately.

If the proposed home does not comply as-of-right, a minor variance application to the Committee of Adjustment or a zoning by-law amendment is required before a building permit can be issued, adding four to twelve weeks and $2,000 to $5,000 in application costs to the project timeline.

Agricultural land is the hard barrier most rural property owners discover after purchasing land rather than before.

Ontario’s Planning Act restricts residential development on prime agricultural land to farm-related dwellings.

A property zoned Agricultural — A1 or A2 in most Ontario municipal zoning by-laws — cannot legally accommodate a prefab primary residence without a rezoning or severance that adds six to eighteen months to the timeline and may not be approved.

Confirm zoning designation and permitted uses with the local planning department before purchasing any rural land intended for a prefab home project.

Decision 4 — Municipal Services or Rural Servicing? Determines $0 or $15,000 to $35,000 Before Foundation Pour

A prefab home on a lot with municipal water and sewer service requires utility connections from the street to the home — typically $8,000 to $18,000 depending on lot depth and existing service proximity.

A prefab home on a rural lot without municipal services requires a septic system permitted under Part 8 of the Ontario Building Code, a private well, and hydro service connection that collectively add $15,000 to $35,000 in pre-construction costs before the foundation is poured.

The Part 8 sewage system permit is a separate approval from the local health unit or Conservation Authority — not issued by the same municipal building department that issues the building permit.

A P.Eng-sealed site-specific septic design based on percolation testing is required. Septic approval timelines in Ontario range from four to twelve weeks depending on municipality and soil conditions.

Initiating the Part 8 application simultaneously with the building permit application rather than sequentially prevents septic approval from becoming the critical path item that delays occupancy on rural Ontario builds.

Decision 5 — HCRA-Licensed Full-Service or Owner-Supplied Modules? Determines Tarion Coverage and Financing Eligibility

Every builder and vendor of a new home in Ontario must be licensed by the Home Construction Regulatory Authority.

HCRA registration is the prerequisite for Tarion Warranty Corporation coverage — the Ontario statutory warranty program that provides one year for workmanship and materials defects, two years for water penetration and major systems, and seven years for major structural defects.

Tarion coverage is voided in three specific circumstances that buyers routinely discover after signing contracts rather than before.

If you supply your own modules — sourcing factory-built components directly from a manufacturer and hiring a separate contractor to complete site work — Tarion protections may not apply to the factory-supplied components.

If the vendor or installer is not licensed by HCRA, Tarion coverage is voided regardless of how high-quality the construction is.

If the home cannot be occupied in all seasons, it does not qualify for Tarion coverage.

In each of these circumstances the buyer must rely on whatever contractual warranty the builder provides — which most construction mortgage lenders treat as insufficient for final draw release.

Verify HCRA registration through the HCRA Ontario Builder Directory before signing any contract with any builder.

External link: HCRA Ontario Builder Directory | → External link: Tarion — What Is Not Covered | → External link: Tarion — The New Home Warranty

Zoning Requirements — As-of-Right, Bill 23, and What Rural Buyers Must Know

What Bill 23 Changed for Prefab Garden Suites and Secondary Units

The More Homes Built Faster Act, 2022 grants as-of-right permission for up to three residential units on most urban residential lots in Ontario — the primary residence plus two additional residential units.

Municipalities are prohibited from banning accessory residential units or garden suites.

Development charge exemptions apply to qualifying additional residential units.

The practical consequence for prefab buyers is significant and underexplained in every current Ontario prefab permit result we have seen.

The comparison below shows exactly what Bill 23 eliminated for Ontario garden suite projects and what the building permit process still requires — so buyers can understand precisely what “as-of-right permission” means before contacting their local planning department.

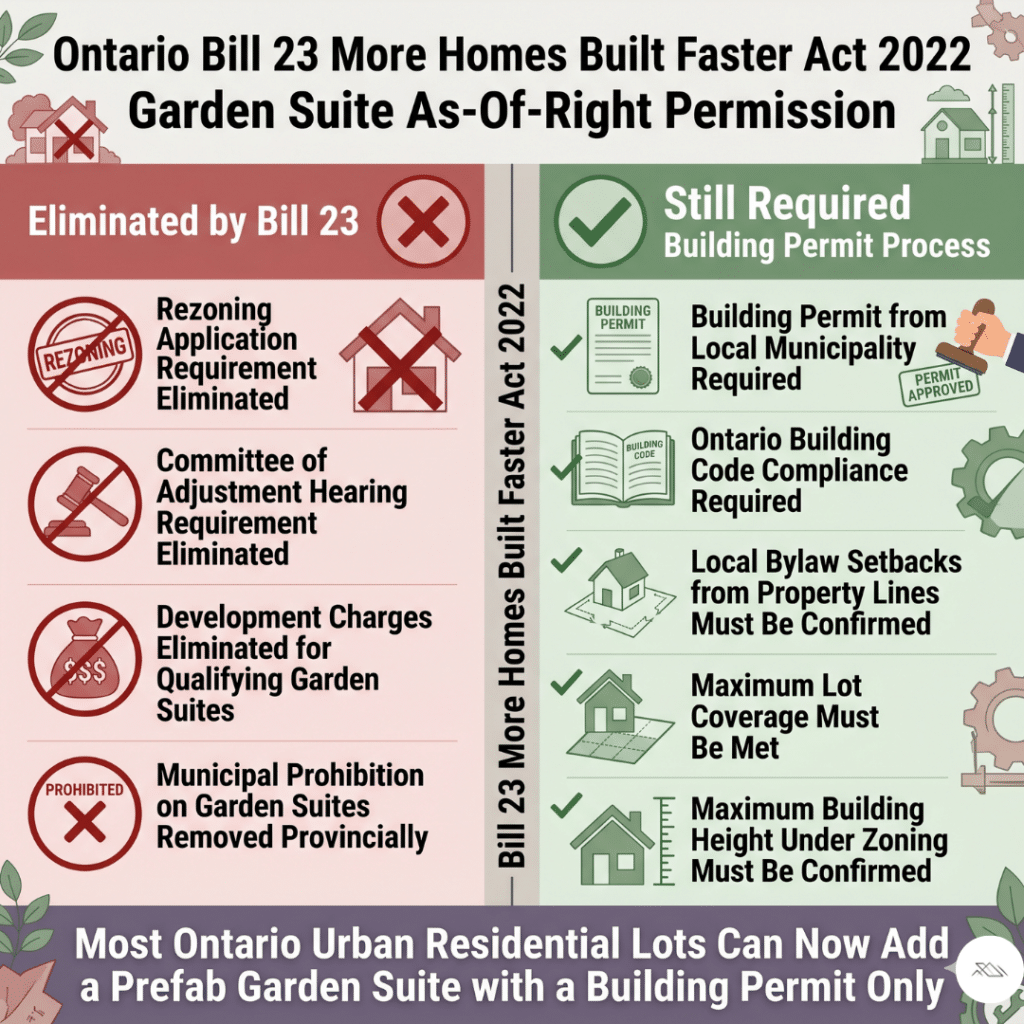

Prefab home permits Ontario Bill 23 More Homes Built Faster Act garden suite as-of-right permission comparison showing what Bill 23 eliminated including rezoning application requirement Committee of Adjustment hearing requirement development charges for qualifying accessory residential units and municipal prohibition on garden suites versus what building permit process still requires including building permit from local municipality Ontario Building Code compliance local bylaw setbacks lot coverage and building height confirmation

Bill 23 removes rezoning, hearings, and development charges for most urban lots — leaving a streamlined building permit focused on zoning compliance.

A property owner who wants to add a prefab garden suite to an existing urban residential lot does not need a rezoning application, a minor variance, or a Committee of Adjustment hearing.

They need only a building permit that confirms the specific garden suite design meets the local bylaws on setbacks, lot coverage, building height, and floor area.

This is because the rezoning barrier that previously made secondary unit construction administratively complex has been eliminated provincially for most urban residential lots.

The permit barrier remains — but it is a building permit, not a planning approval, which is a dramatically simpler and faster process.

Garden suites built as rental income properties on existing lots represent one of the strongest current investment cases in the Ontario prefab market precisely because Bill 23 eliminated the planning barrier, the development charge barrier, and the rezoning barrier simultaneously.

A prefab garden suite can now be added to most Ontario urban residential lots with only a building permit application and the standard approval process — no public hearing, no committee application, no development charge.

For the complete guide to prefab garden suite construction costs, rental income calculations, and the eight-stage building process — see our Additional Dwelling Unit Ontario guide.

When You Need a Minor Variance and What It Costs

A minor variance is required when the proposed prefab home or garden suite does not comply with one or more provisions of the local municipality’s zoning by-laws.

For example, when the required setback from a property line cannot be achieved due to lot geometry, or when the proposed building height exceeds the maximum permitted in the specific zone.

The minor variance process involves a formal application to the Committee of Adjustment, a public notice period during which neighbouring property owners may provide comments, and a Committee hearing where the variance request is evaluated against four tests:

• Whether the variance is minor in nature

• Desirable for the appropriate development of the land

• Consistent with the general intent of the official plan

• Consistent with the general intent of the zoning by-law

Approval is not guaranteed.

Timeline is four to twelve weeks from application to decision. Cost is $2,000 to $5,000 in application fees plus professional representation if required.

Identifying potential minor variance requirements in Stage 1 of the project planning process — before any drawings are commissioned or factory production is scheduled — is the highest-value early action on any Ontario prefab home project.

My Own Cottage’s site assessment confirms zoning compliance and identifies potential variance requirements before any design or construction commitment is made.

Agricultural Land — The Hard Barrier Most Rural Buyers Discover Too Late

Ontario’s Planning Act restricts residential development on prime agricultural land to farm-related dwellings.

A property zoned Agricultural cannot legally accommodate a prefab primary residence without rezoning or a severance that may take six to eighteen months and may not be approved by the local planning department regardless of the quality of the application.

Buyers who purchase rural land intending to build a prefab home and discover an Agricultural zoning designation after closing face one of the most expensive and time-consuming problems in the Ontario residential construction process.

Confirm the zoning designation and permitted residential uses with the local municipality before purchasing any rural land for a prefab home project.

The Inspection Sequence — Factory, Site, and Occupancy

Factory Inspection — What CSA A277 Covers Before Delivery

For CSA A277 certified factory builds, third-party inspectors accredited by the Standards Council of Canada verify compliance at multiple stages of the manufacturing process before any module leaves the manufacturing facility.

Framing and structural systems, insulation and vapour barrier, mechanical systems rough-in, plumbing rough-in, electrical rough-in, interior finishes installation, and all other building systems are inspected while still fully accessible in the controlled environment.

This is the inspection regime that makes CSA A277 certified modular construction more thoroughly inspected than conventional construction.

In site-built homes many of these same systems are concealed behind drywall before municipal inspectors arrive, making comprehensive verification structurally impossible.

On-Site Inspection Sequence — Foundation Through Occupancy

Municipal building officials conduct on-site inspections covering foundation construction and anchorage, site preparation and grading, module installation and connection, all utility connections, and on-site finishing work.

For CSA A277 certified modular homes, the factory inspection records are presented to the building inspector at the time of module installation — the on-site inspection focuses on the site-specific work that cannot be completed in the manufacturing facility.

The occupancy permit is issued by the local municipality only after building officials confirm that all requirements of the building permit have been satisfied — both factory-built and site-built components.

Tarion warranty enrollment must be confirmed before the occupancy permit application is submitted.

The construction mortgage converts to a standard residential mortgage at current term rates after occupancy permit issuance — the financing event that marks the end of the construction process and the beginning of permanent residential occupancy.

For the complete eight-stage prefab home building process from site assessment through occupancy permit — see our Prefab Home Building Process Ontario guide.

ESA and TSSA — The Two Inspections Outside Municipal Authority

Electrical work requires authorization from the Electrical Safety Authority — operating independently of the municipal building permit process.

For CSA A277 certified factory-built modules, the manufacturer obtains an ESA inspection at the plant for factory-installed electrical systems.

The on-site electrical connection and service entrance require a separate ESA inspection and authorization.

Gas and propane installations are governed by the Technical Standards and Safety Authority independently of both the municipal building permit and the ESA.

Confirm ESA and TSSA authorization requirements with the specific licensed contractors before scheduling any on-site utility connections.

Tarion Warranty — What It Covers and Specifically When It Does Not

The Three Tarion Exclusions That Buyers Discover Too Late

Tarion’s one-year workmanship, two-year major systems, and seven-year structural coverage applies to every new prefab and modular home sold by an HCRA-licensed vendor to an owner-occupant on a permanent foundation.

The seven-year structural warranty remains with the home even if it is sold during the coverage period.

Coverage is automatic when the vendor holds HCRA registration and the specific project is enrolled in Tarion before the occupancy permit application is submitted.

Coverage is voided under three specific conditions that buyers must understand before signing any contract.

First — owner-supplied modules.

If you source factory-built modules directly from a manufacturer and hire a separate contractor to complete site work and finishing, Tarion’s protections may not apply to the factory-supplied components.

The vendor relationship — the HCRA-licensed builder who sells you the home — is the legal anchor for Tarion coverage.

Splitting the procurement between a module supplier and a site contractor breaks that anchor.

Second — non-HCRA-licensed vendor.

If the builder or vendor is not licensed by the Home Construction Regulatory Authority at the time of sale, Tarion coverage is voided regardless of construction quality.

An unlicensed vendor cannot enroll a project in Tarion.

Buyers who discover this after occupancy have no Tarion recourse and must rely on contractual warranty from an unlicensed vendor — which most construction mortgage lenders treat as insufficient for final draw release.

Third — seasonally occupied homes.

Homes that cannot be occupied in all seasons do not qualify for Tarion statutory warranty coverage.

This condition is most commonly triggered on cottage country and waterfront builds where the property and septic system are designed for three-season use only.

HCRA Registration — How to Verify Before Signing

The HCRA Ontario Builder Directory is publicly accessible and allows buyers to confirm a builder’s current registration status, any conditions on their licence, and any disciplinary history before signing any purchase agreement.

Search the builder’s legal name rather than their trade name to ensure the correct entity is returned.

Confirm that the registration is active — not suspended, revoked, or conditional — before proceeding.

External link: HCRA Ontario Builder Directory

CMHC Financing and the Construction Draw Misalignment

The Canada Mortgage and Housing Corporation insures construction mortgages for qualifying prefab and modular homes when the home is CSA A277 certified, permanently affixed to a permanent foundation, and used as the buyer’s owner-occupied primary residence on owned land.

CMHC-insured construction mortgages are available with as little as 5% down for qualifying buyers — the same financing terms available for equivalent site-built new homes.

The financing complexity that no competitor in the current Ontario prefab permit SERP addresses is the construction draw misalignment that most modular buyers encounter without anticipating it.

Modular manufacturers typically require 80% of the total purchase price paid before modules leave the manufacturing facility — because the factory has produced a near-complete home and needs payment before releasing it for transport.

CMHC-insured construction mortgages release funds incrementally against on-site completion milestones — foundation complete, factory completion confirmed, delivery and crane-set complete, and occupancy permit issued.

The gap between the factory’s 80% payment requirement and the lender’s draw schedule creates a cash flow requirement that most buyers are not prepared for at contract signing.

The practical mitigation strategies available are a bridge financing facility to cover the factory payment before the construction draw is released.

A negotiated draw schedule with the lender accommodates the factory payment milestone, a manufacturer deposit guarantee replaces the full 80% payment with a smaller deposit until delivery, or a HELOC on an existing property to bridge the gap.

Resolve the draw schedule alignment with your lender before signing any modular home construction contract.

The misalignment is resolvable — but it is not resolvable at factory delivery day when the manufacturer is waiting for payment and the lender’s draw has not yet been released.

For the complete guide to construction mortgages, CMHC insurance, HELOC financing, and draw schedule alignment — see our Prefab Home Financing Ontario guide.

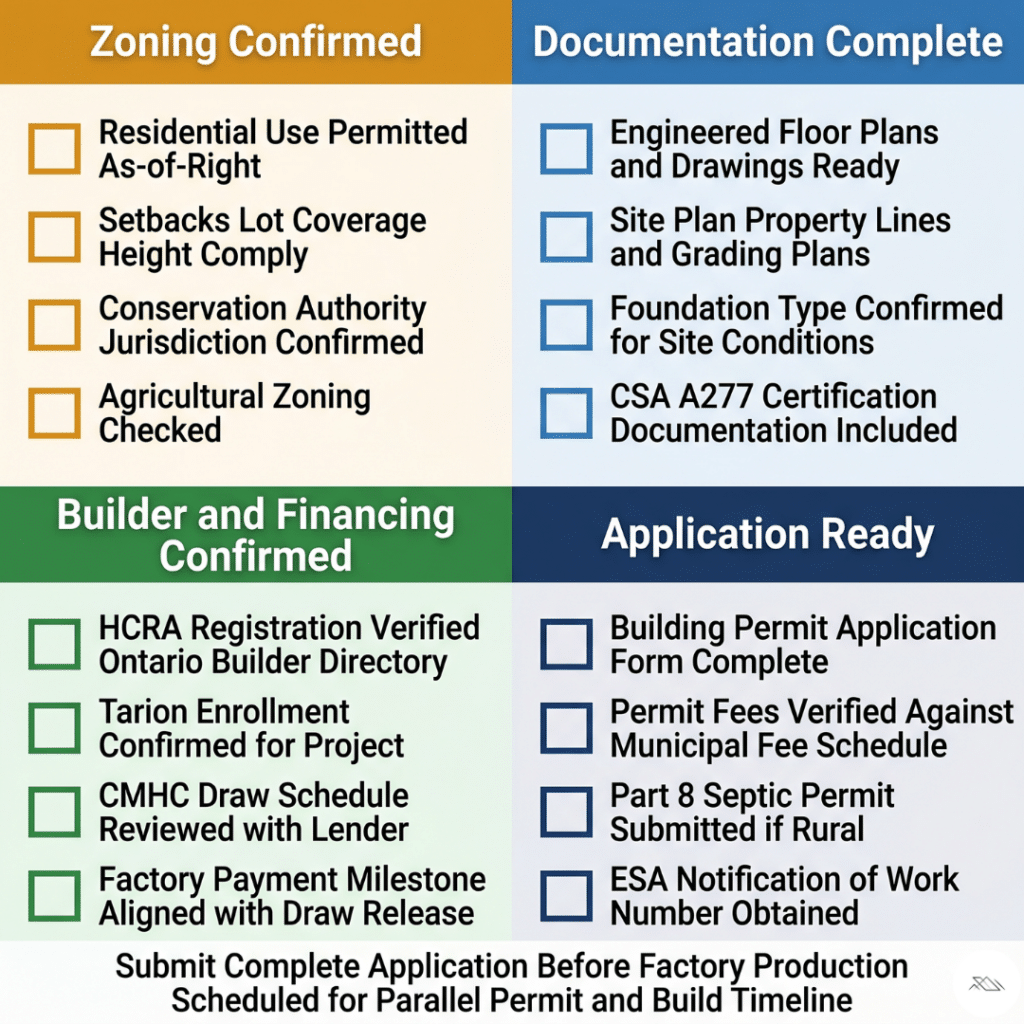

Ontario Prefab Permit Checklist — Pre-Submission Confirmation

The checklist below covers every pre-submission confirmation required before your Ontario prefab home building permit application is ready to submit — organized into the four sequential categories that align with the five decisions covered in this guide.

Prefab home permits Ontario complete pre-submission building permit checklist four categories showing Zoning Confirmed with residential use permitted setbacks lot coverage Conservation Authority jurisdiction and agricultural zoning checked Documentation Complete with engineered floor plans site plan foundation type and CSA A277 certification Builder and Financing Confirmed with HCRA registration Tarion enrollment CMHC draw schedule and factory payment alignment Application Ready with permit application form permit fees Part 8 septic and ESA notification

The pre-submission checklist covers four stages — zoning, documentation, builder and financing, and application readiness — enabling parallel permit approval and factory construction for a four to eight month timeline.

Use this checklist before submitting your building permit application.

A complete application submitted before factory production is scheduled allows permit approval and factory construction to occur simultaneously — the parallel build model that produces the four to eight month prefab timeline advantage.

Zoning Confirmed

• Residential use is permitted on the specific lot under the applicable zoning by-laws

• Setbacks, lot coverage, and building height comply as-of-right with local bylaws

• Conservation Authority jurisdiction confirmed — approval initiated if applicable

• Agricultural zoning checked — no farm-dwelling restriction applies

Documentation Complete

• Engineered floor plans and architectural drawings prepared or received from builder

• Site plan showing foundation location, property lines, grading plans, and utility connections

• Foundation type confirmed for specific site conditions

• CSA A277 factory certification documentation included in permit package

Builder and Financing Confirmed

• Builder HCRA registration verified through Ontario Builder Directory

• Tarion enrollment confirmed for specific project

• Construction draw schedule reviewed with lender — factory payment milestone aligned

• CMHC bridge financing or HELOC confirmed if draw misalignment applies

Application Ready

• Building permit application form complete

• Permit fees prepared — verified against specific municipal fee schedule

• Part 8 septic permit application submitted if rural property without municipal services

• ESA notification of work number obtained before electrical rough-in

Frequently Asked Questions — Prefab Home Permits Ontario

Do prefab homes need a building permit in Ontario?

Yes — every prefab home in Ontario requires a building permit from the local municipality where the home will be located, regardless of construction method or factory certification status.

The Ontario Building Code applies to all residential buildings including every prefab modular home, panelized home, and kit home regardless of where the manufacturing process occurred.

CSA A277 factory certification changes the inspection pathway — it does not eliminate the permit requirement.

A building permit, site inspections, and an occupancy permit are required for every prefab home in Ontario before any occupant can legally move in.

What is CSA A277 certification and do I need it in Ontario?

CSA A277 is the Canadian Standards Association standard for factory certification of buildings — the procedure for factory certification that governs how manufacturing facilities are audited and how modules are inspected by accredited third-party inspectors authorized by the Standards Council of Canada.

Ontario recognizes and accepts CSA A277 certification as the basis for factory inspection documentation presented to municipal building officials. Ontario does not mandate CSA A277 for all projects — it is mandatory in Alberta, Quebec, and Yukon.

However, Toronto now accepts CSA A277 certification in lieu of conducting its own factory inspections, and municipalities across Ontario increasingly use factory certification as the preferred pathway for approving modular home permit applications.

Choosing a CSA A277 certified builder is the most effective single action available to any Ontario prefab buyer for simplifying and accelerating the permit approval process.

How much does a building permit cost for a prefab home in Ontario?

Building permit fees for prefab homes in Ontario vary significantly by municipality.

On a 300 square metre home, verified 2025 fee data shows approximately $6,029 in Toronto, $5,496 in Hamilton, $4,791 in the Town of Lincoln, $8,073 in Perth, and $4,300 in Cornwall.

These are building permit fees only — electrical permits add $500 to $2,000, plumbing permits add $500 to $1,500, Part 8 septic permits on rural properties add $500 to $2,000, and development charges add $0 to $75,000 or more depending on municipality and project type.

Development charges have been eliminated for qualifying accessory residential units and garden suites under the More Homes Built Faster Act, 2022.

How long does a prefab home permit take in Ontario?

Building permit processing times vary significantly by municipality and application completeness.

GTA municipalities typically process complete applications in four to eight weeks.

Ottawa urban properties average approximately three to four weeks for straightforward applications.

Smaller Ontario municipalities may process applications in two to four weeks.

Properties within Conservation Authority jurisdiction, Agricultural land use designations, or where minor variance applications are required face the longest timelines — twelve or more weeks in complex cases.

The most effective action available to any Ontario prefab buyer is submitting a complete, fully-documented application before factory production is scheduled — allowing permit approval and factory construction to occur simultaneously through the parallel build model that produces the prefab timeline advantage.

Does Bill 23 allow me to add a prefab garden suite without a rezoning application?

Yes — for most urban residential properties in Ontario.

The More Homes Built Faster Act, 2022 grants as-of-right permission for up to three residential units on most urban residential lots, including garden suites, and municipalities are prohibited from banning additional residential units.

Development charge exemptions apply to qualifying garden suite and accessory residential unit builds.

The practical consequence is that a property owner can add a prefab garden suite to most Ontario urban residential lots with only a building permit application — no public hearing, no Committee of Adjustment application, no development charge, and no rezoning.

Setbacks, lot coverage, and building height requirements under the local bylaws still apply to the specific garden suite design and must be confirmed with the local planning department before any design is finalized.

Is a prefab home covered by Tarion warranty?

Only when the vendor is licensed by the Home Construction Regulatory Authority.

Tarion coverage includes seven-year structural, two-year major systems including plumbing, heating, and electrical, and one-year workmanship and materials defects.

Coverage is voided when a buyer supplies their own modules directly, when the vendor or installer is not HCRA-licensed at the time of sale, or when the home cannot be occupied in all seasons.

Most construction mortgage lenders require confirmation of Tarion enrollment before issuing the final draw at occupancy — meaning a project where Tarion coverage does not apply may face financing complications at the worst possible project stage.

Verify HCRA registration through the public Ontario Builder Directory before signing any purchase agreement.

Can I put a prefab home on agricultural land in Ontario?

Generally no — without a zoning amendment or minor variance that may take six to eighteen months and may not be approved.

Ontario’s Planning Act restricts residential development on prime agricultural land to farm-related dwellings.

A parcel zoned Agricultural A1 or A2 in most Ontario municipal zoning by-laws cannot accommodate a prefab primary residence without rezoning or a land severance.

Buyers who purchase rural land under the assumption that a prefab home can be placed on any rural property routinely discover the agricultural land restriction after closing — when the cost and timeline of the rezoning process are already certain.

Confirm the zoning designation and permitted residential uses with the local municipality before purchasing any rural land intended for a prefab home project.

What permits are required beyond the building permit?

The building permit is the primary approval required for Ontario prefab home construction — but several additional permits are required before occupancy.

A separate electrical permit pulled by a licensed electrical contractor is required for all electrical work, with ESA authorization required before energization.

A separate plumbing permit pulled by a licensed plumber covers all plumbing work.

Conservation Authority approval is required before the building permit can be issued on properties within regulated jurisdiction.

Part 8 septic system permits from the local health unit or Conservation Authority are required on rural properties without municipal services.

Ontario One Call must be contacted before any site excavation — including foundation construction — to locate buried utilities.

Crane permits and traffic management permits may be required for module delivery on urban lots with restricted access.

How does the CMHC construction mortgage draw schedule work for modular homes?

CMHC-insured construction mortgages release funds incrementally against on-site completion milestones rather than as a lump sum.

Modular manufacturers typically require 80% of the total purchase price paid before modules leave the manufacturing facility — creating a misalignment between the factory payment requirement and the lender’s draw release schedule.

Most buyers encounter this misalignment at contract signing rather than at factory delivery, when it is easiest to resolve.

Bridge financing, negotiated draw schedules, HELOC facilities on existing properties, and manufacturer deposit arrangements are the practical solutions.

The critical step is reviewing the draw schedule alignment with the lender before signing any modular construction contract — not after modules have been produced and the manufacturer is waiting for payment.

What is the difference between a CSA A277 modular home and a CSA Z240 manufactured home?

CSA A277 governs the factory certification procedure for volumetric modular buildings — three-dimensional modules built on a permanent foundation and subject to full Ontario Building Code compliance at every stage.

CSA Z240 MH governs manufactured homes built on a chassis — the standard that applies to mobile and manufactured homes of the trailer type.

The two categories have distinct permit, inspection, zoning treatment, and financing pathways. CSA A277 modular homes are treated as houses under Ontario residential zoning and qualify for standard residential mortgages.

CSA Z240 MH manufactured homes may face zoning restrictions outside licensed mobile home parks and are frequently financed through chattel loans rather than standard residential mortgages.

The two are routinely conflated by buyers and occasionally by lenders — confirm which standard applies to any factory-built home before evaluating financing options.

Do I need a Conservation Authority permit for my prefab home?

Properties within Conservation Authority jurisdiction — typically within 30 to 120 metres of a watercourse, wetland, or floodplain — require Conservation Authority approval before the local municipality can issue a building permit.

Conservation Authorities in Ontario include the Toronto and Region Conservation Authority, Conservation Halton, Grand River Conservation Authority, Mississippi Valley Conservation Authority, Lake Simcoe Region Conservation Authority, and others covering different watershed regions.

The Conservation Authority review evaluates proposed construction for natural hazard impacts, water quality implications, and ecological feature effects.

The approval process adds four to sixteen weeks to the permit timeline on properties within jurisdiction.

Identifying Conservation Authority jurisdiction before purchasing land or commissioning any drawings is the most effective way to protect project timelines on waterfront and rural Ontario builds.

Should I hire a professional to handle my Ontario prefab home permit application?

Yes — for most Ontario prefab home buyers, working with an experienced CSA A277 certified builder who manages the complete permit application process is the most effective and cost-efficient approach to the permit stage.

A full-service certified builder prepares the engineered drawings, CSA A277 certification documentation, site plan, grading plans, foundation engineering, and zoning compliance confirmation required by the local building department — eliminating the need to separately commission an architect, structural engineer, and permit consultant.

My Own Cottage manages the complete building permit process for every Ontario build as a standard part of every project — confirming zoning compliance, initiating any Conservation Authority approvals, and submitting the complete documentation package to the local municipality before any factory production is scheduled.

Ready to Begin Your Ontario Prefab Home Permit Process?

The permit process is a financial planning exercise before it is a regulatory compliance exercise.

The buyers who reach occupancy on schedule — within their budget, with full Tarion coverage, and with their construction mortgage draw schedule aligned — are the ones who made the five decisions covered in this guide before signing any builder contract.

My Own Cottage provides complete permit-ready documentation packages for every Ontario build and begins every project with a permit readiness assessment for the specific property.

We confirm zoning compliance, Conservation Authority jurisdiction, along with septic and utility servicing requirements.

This establishes the complete documentation package required by the local municipality, and aligns the financing draw schedule with the construction timeline before any model is selected or any commitment is made.

No surprises. No hidden costs. No pressure.

Get started today with a free prefab home permit consultation.

🧑‍💼 Request a Free Consultation
📲 Call Us Directly: (705) 345-9337
🏘️ View Our Design Catalogue

✅ Ontario-Built | ⚡ Energy-Efficient | 🏡 Fully Customizable | 🚚 Fast Delivery

Alternatively, for your convenience, you can also simply fill out the contact form below and we’ll get back to you soon! 👇

Contact Us

We usually respond within 24 hours!

Verified External Resources

Ontario Building Code — O. Reg. 332/12 — The primary provincial technical standard governing all prefab and modular home construction in Ontario including permit requirements, Part 9 residential building standards, and Part 8 on-site sewage system requirements.

Ontario.ca — Building a Modular House — Official Ministry of Municipal Affairs and Housing guide covering modular home construction, permit requirements, and OBC compliance.

CSA A277 — Canadian Standards Association — The factory certification standard for prefab and modular buildings — the primary mechanism for demonstrating Ontario Building Code compliance for factory-built modules.

CHBA — Code Compliance for Modular Construction — Canadian Home Builders’ Association guidance confirming that Ontario recognizes but does not mandate CSA A277, with CSA Z240 MH and CSA Z250 standards explained.

Toronto Building — Certified Plans Program Backgrounder 2025 — Toronto Building’s March 2025 confirmation that the Certified Plans Program now covers modular homes and that Toronto accepts CSA A277 certification in lieu of factory inspections.

More Homes Built Faster Act — Bill 23 — Overview of Bill 23 provisions including as-of-right three-unit permission, development charge eliminations for accessory residential units, and municipal zoning changes affecting garden suite and secondary unit construction.

Tarion — The New Home Warranty — Ontario’s new home warranty program covering statutory warranty for prefab homes built by HCRA registered builders.

Tarion — What Is Not Covered — Specific Tarion exclusions including owner-supplied modules and non-HCRA-licensed vendor situations that void statutory warranty coverage.

HCRA — Home Construction Regulatory Authority — Ontario Builder Directory for verifying builder licensing status before signing any purchase agreement.

Ontario Planning Act — R.S.O. 1990, c. P.13 — The provincial statute governing zoning by-laws, official plans, and land use permissions including agricultural land restrictions.
