Prefab Home Permits Muskoka 2026: The Four-Layer Approval Framework — Verified Costs and Timelines
Last updated: April 29th, 2026
Written by building specialists at My Own Cottage
Getting a prefab home permit in Muskoka is not a single form submitted to a single office.
It is a four-layer simultaneous approval process — each layer enforced by a different authority, each with its own fee, its own document requirements, and its own timeline that runs independently of the others.
Miss one layer entirely, wait for one approval before starting the next, or submit an incomplete document package to any of the four authorities — any of these errors adds months to your building project in a region where the practical construction window runs from late April to early November.
This guide includes the complete four-layer framework with verified permit fees by township, confirmed development charge figures, Conservation Authority permit triggers, and the one date every Muskoka prefab buyer must know before any permit application is prepared.
Before diving into the framework: your lot scenario determines which combination of these layers applies to your specific build.
Three scenarios cover the vast majority of Muskoka prefab permit situations. Identify yours before reading further.
Reviewing a Muskoka prefab permit application and site assessment — the critical first step before committing to land or a build.
Scenario A — Primary dwelling on your own Muskoka lot: All four layers apply. Full OBC Part 9 compliance, development charges payable at permit issuance, Conservation Authority permit if within 30 metres of a waterbody.
Scenario B — Sleeping cabin or accessory structure on an existing cottage property: Three layers apply in most cases. No development charges on non-residential accessory structures in most municipalities. Simplified permit scope. Fox Den at 505 sq ft and similar compact designs sized specifically for this pathway.
Scenario C — Water-access-only lot: All four layers apply — identical permit requirements to road-accessible lots, significantly higher logistics complexity and site cost. Barge delivery, marine-staged foundation work, and seasonal scheduling constraints apply to everything that follows permit issuance.
My Own Cottage manages the complete permit application process for every Muskoka build — initiating all four approval streams simultaneously as standard. Every project begins with a complete site assessment confirming which scenario applies to your specific lot before any design commitment is made.
For the complete overview of prefab home construction across all Muskoka lot types see our prefab homes Muskoka buyer’s guide. For the provincial permit context see our prefab home permits Ontario guide.
Get a verified permit feasibility assessment for your specific Muskoka lot — before purchasing land or signing any contract.
Your Lot Scenario Determines Your Permit Pathway
Before any permit application is prepared, your lot scenario determines which approval layers apply, what the complete cost stack looks like, and how long the process will take.
| Scenario | Est. Timeline | Est. Permit Cost Stack |
|---|---|---|
| Primary dwelling — road-accessible | 6–12 months | CAD $15,000–$50,000+ |
| Accessory sleeping cabin | 4–8 months | CAD $5,000–$20,000 |
| Water-access-only lot | 8–14 months | CAD $18,000–$60,000+ |
All four approval layers apply to primary dwelling and water-access scenarios. Three layers typically apply to accessory sleeping cabins on existing properties. Timeline begins at first complete application submission — not at initial inquiry. Costs exclude factory price, foundation work, and site preparation.
The urban serviced lot in Bracebridge or Gravenhurst is the fastest and most predictable permit pathway in the District.
The Township of Muskoka Lakes waterfront residential scenario — with the most stringent shoreline controls in Ontario, mandatory Conservation Authority review, and high-water mark survey requirements — is the most complex.
Understanding which scenario applies before purchasing real estate is the single most consequential pre-purchase due diligence step available to a Muskoka prefab buyer.
Not sure which scenario applies to your lot? We confirm it at site assessment — before any design commitment is made.
The Four Layers — What Each Authority Requires and When
No single authority governs the complete Muskoka prefab permit process. Four distinct regulatory layers must be navigated simultaneously — not sequentially.
The diagram below shows exactly how these layers interact and why treating them sequentially is the single most common cause of multi-month delays.

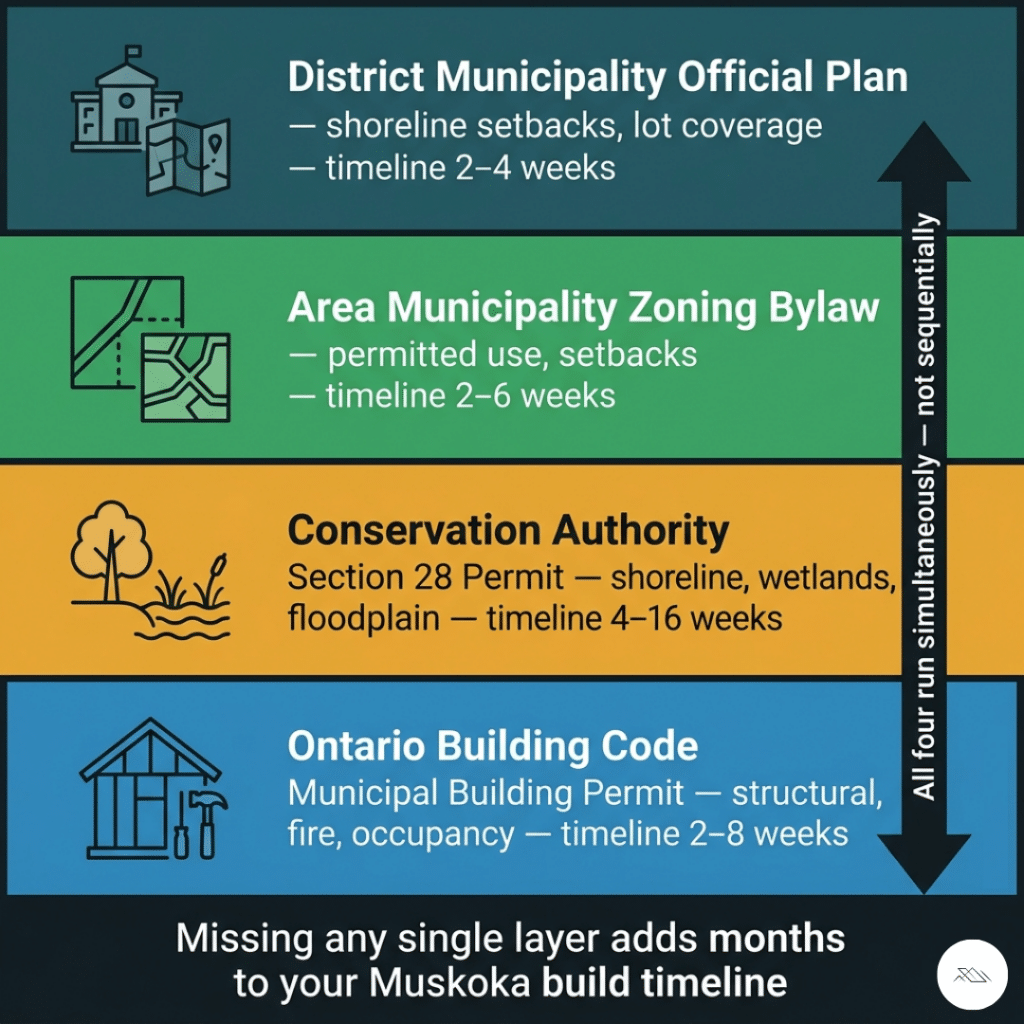

The four approvals required for a Muskoka prefab home — all initiated simultaneously. Sequential applications are the primary cause of 6–12 month delays.
The Simultaneous Application Rule — Why Sequential Kills Your Timeline
The most consistent cause of Muskoka prefab permit timelines extending to 12 months or more is sequential application — waiting for zoning confirmation before starting the Conservation Authority application, or waiting for the CA permit before submitting the building permit application.
Initiating all four approval streams simultaneously from a complete first submission is the strategy that compresses the timeline to 6 months on most road-accessible lots.
The OBC sets a legislated review period of 10 business days for complete residential permit applications. That clock does not start until the municipality deems the submission complete. Every incomplete document triggers a deficiency notice and resets the effective review clock.
My Own Cottage’s permit management process initiates all four streams simultaneously and submits complete documentation packages to prevent clock resets.
We initiate all four approval streams simultaneously and submit complete documentation packages on every Muskoka build — preventing the clock resets that add months to timelines.
Layer 1 — The District Municipality of Muskoka Official Plan
The District Municipality of Muskoka administers the upper-tier Official Plan that establishes the policy framework for all land use across all six lower-tier area municipalities. It does not issue building permits — but it sets the constraints within which every building permit must comply.
Key provisions affecting every Muskoka prefab project under the Official Plan:
Shoreline setbacks: Principal structures are generally required to be set back a minimum of 20 to 30 metres from the high-water mark depending on the specific municipality and zoning sub-category. The high-water mark must be formally established by a licensed Ontario Land Surveyor before any site plan is prepared — it is not estimated from current water level. Structures placed even slightly within the setback zone are subject to stop-work orders and may require removal.
Near-shore zone lot coverage: Within the first 60 metres from the high-water mark, total lot coverage by buildings and impervious surfaces is typically restricted to approximately 10 percent.
Natural vegetation buffer: A 15-metre natural vegetation buffer is generally required along the water’s edge. My Own Cottage’s crane-set modular installation — completed in a single day on pre-installed helical piers — disturbs a fraction of the ground that months of on-site framing activity requires. This minimal site disturbance footprint is a documented advantage in District Official Plan compliance for waterfront lots.
Accessory structure size limits: Secondary structures including sleeping cabins, bunkies, and guest cottages are typically limited to approximately 600 square feet of floor area in most Muskoka municipalities. My Own Cottage’s Fox Den at 505 sq ft and the Lake View at 741 sq ft are sized with these limits in mind — confirm the specific limit for your township and zoning category before any design selection.
The District’s Planning Department is the entry point for Official Plan interpretation. Source: District Municipality of Muskoka Official Plan.
Layer 2 — Area Municipality Zoning Bylaw
Each of Muskoka’s six lower-tier municipalities implements the District Official Plan through its own zoning bylaw — with its own permitted uses, setback dimensions, lot coverage calculations, and accessory structure provisions.
There is no single Muskoka District building department. Building permits are issued at the area municipality level.
The table below summarizes the key zoning classification and permitted use information for each of Muskoka’s six area municipalities — the Layer 2 detail that determines what your building permit application must demonstrate compliance with before the municipality will accept it.
| Municipality | Primary Zone | Key Constraint |
|---|---|---|
| Muskoka Lakes Township | Waterfront Residential (WR) | Most stringent; governs Big Three lakes |
| Town of Bracebridge | Shoreline Residential (SR1) | Confirm SR3/SR4 lot size minimums |
| Town of Gravenhurst | Shoreline Residential | Confirm by zoning designation |
| Town of Huntsville | Waterfront Residential | Varies by waterbody |
| Township of Lake of Bays | Waterfront Residential | CA overlay on most shoreline lots |
| Township of Georgian Bay | Waterfront and Coastal | Coastal and island provisions — confirm before purchase |
Lot coverage approximately 10% within 60 metres of HWM across all waterfront zones. Accessory structure cap approximately 600 sq ft in most municipalities — Georgian Bay variable. Confirm current requirements with your specific township before any design selection.
Source: District Municipality of Muskoka Official Plan and area municipality zoning bylaws.
Layer 3 — Conservation Authority Section 28 Permit
Under Ontario Regulation 179/06, any development within a regulated area — typically within 30 metres of a shoreline, wetland boundary, or floodplain limit — requires a Section 28 permit from the applicable Conservation Authority in addition to the municipal building permit.
This is a separate approval from the municipal permit, not a substitute for it.
Muskoka is primarily served by the Muskoka Watershed Council. The Lake Simcoe Region Conservation Authority has jurisdiction over southern fringe properties.
Confirming which Conservation Authority has jurisdiction over your specific lot — before purchasing land — is essential for any waterfront or near-shore build.
Conservation Authority permit processing timelines range from four to sixteen weeks depending on application complexity and seasonal workload during peak cottage construction season.
Complex shoreline properties on Lake Muskoka, Lake Rosseau, or Lake Joseph may require a Natural Heritage Evaluation — adding CAD $5,000 to $25,000 to the soft cost budget and further extending the timeline.
The CA permit application must be initiated simultaneously with the building permit application. The municipality will not issue a building permit until Conservation Authority approval is confirmed.
Layer 4 — Ontario Building Code Municipal Building Permit
The building permit from the applicable area municipality is the construction approval that authorises the placement, connection, and occupation of a prefab home on your Muskoka lot. It is the final permit in the sequence — but it should not be the last application initiated.
What a complete Muskoka prefab permit application contains
All of the following must be submitted simultaneously in the first application package. Missing any single item triggers a deficiency notice:
• Completed application form via Cloudpermit (where applicable) or paper submission
• Site plan drawn to scale showing structure placement, all setback dimensions, drainage, and driveway access
• Architectural and structural drawings prepared or reviewed by a BCIN-registered designer or P.Eng. registered in Ontario
• Grading and drainage plan
• CSA A277 certification label and factory inspection report package — this is the most commonly missing item in first submissions from buyers who purchased a non-certified prefab product
• Septic design for rural lots under OBC Part 8 (Ontario Building Code O. Reg. 332/12)
• OBC SB-12 energy compliance documentation for year-round builds in Climate Zone 6
• HCRA builder registration confirmation
• Conservation Authority permit confirmation where the lot is within a regulated area
• Entrance permit from MTO or municipal roads authority where a new driveway connects to a provincial highway or county road
What CSA A277 certification does for your building permit review
CSA A277 is the Canadian Standards Association’s factory process certification confirming that a modular home manufacturer’s quality management systems and construction methods consistently meet Ontario Building Code requirements.
It is not a product performance standard — it is a process certification.
CSA A277 certification replaces repeated municipal inspections with factory-verified documentation — compressing the Muskoka permit timeline by weeks.
In Muskoka’s area municipalities, where building inspection capacity is limited during the peak cottage construction season, the CSA A277 factory inspection documentation allows building officials to accept the factory-stage inspection records in lieu of re-examining the interior structural and mechanical assemblies of each module on-site.
This administrative advantage is more pronounced in rural Muskoka townships than anywhere else in Ontario. CSA A277-certified modular homes also carry different implications for warranty coverage under the Ontario New Home Warranties Plan Act and for conventional mortgage financing through CMHC.
Non-certified factory-built products — expandable studio pods, bunkie kits, park-model units — do not benefit from this inspection pathway and may require full on-site factory assembly inspection by the municipal building official, adding weeks to the review process.
Cloudpermit:
Several Muskoka municipalities — including the Township of Muskoka Lakes and the Town of Bracebridge — use the Cloudpermit digital platform for online building permit applications, document uploads, real-time status tracking, and inspection scheduling.
Account setup at cloudpermit.com. Not every Muskoka municipality uses Cloudpermit — confirm your specific township’s submission process before preparing the application package.
For the most detailed Cloudpermit walkthrough currently in the hub, see our prefab homes Bracebridge guide.
Permit Costs by Township — The Numbers No Competing Page Publishes
The specific cost data buyers need most is often left out. The Official Township of Muskoka Lakes building department page publishes no development charge figures. Tech Home Ltd publishes no permit fee data. Total Site Services publishes no figures of any kind.
The tables below are the only verified Muskoka prefab permit cost reference in the query cluster.
Development Charges by Municipality
Development charges are levied at both the District and local municipal levels, payable at building permit issuance. They fund growth-related capital infrastructure — roads, water and sewer services, parks, and emergency services.
The visual below highlights the key figures every Muskoka prefab buyer must understand, including the single highest development charge and the January 1 deadline that determines whether you pay this year’s rate or next year’s indexed increase.
Verified Muskoka development charges by township — Bracebridge urban reaches CAD $32,903. Rates are indexed annually on January 1, making permit timing a direct cost decision.
| Municipality | Development Charge |
|---|---|
| Bracebridge — urban lot | CAD $32,903 combined |
| Bracebridge — rural lot | CAD $15,535 combined |
| Gravenhurst | CAD $9,221 |
| Huntsville | CAD $9,734 |
| Township of Muskoka Lakes | Confirm with township |
| Township of Lake of Bays | Confirm with township |
| Township of Georgian Bay | Confirm with township |
By-law references: Bracebridge No. 2024-034, Gravenhurst 2024-110, Huntsville 2024-130 — all effective January 1, 2026.
Sources: bracebridge.ca/development-charges, muskoka.on.ca/development-fees. Development charges are indexed annually.
For Huntsville-specific permit fees, By-law 2024-130 development charges, and North Muskoka terrain realities see our prefab homes Huntsville guide.
Complete Soft Cost Stack
Beyond development charges, every Muskoka prefab permit project involves six additional professional fee categories that most first-time buyers omit from initial estimates.
| Cost Category | Typical Muskoka Range | Notes |
|---|---|---|
| Municipal building permit fee | CAD $3,500–$12,000 | Varies by township and declared construction value |
| Development charges | CAD $9,221–$32,903 | By township — see table above |
| Conservation Authority permit fee | CAD $500–$3,000 | Base fee; Natural Heritage Evaluation additional |
| Natural Heritage Evaluation (if required) | CAD $5,000–$25,000 | Triggered by complex waterfront CA reviews |
| Ontario Land Surveyor — high-water mark | CAD $2,500–$6,000 | Mandatory for all waterfront lots |
| Licensed Septic System Designer | CAD $3,000–$8,000 | Mandatory for OBC Part 8 compliance on rural lots |
| Geotechnical engineer — bedrock assessment | CAD $3,000–$8,000 | Recommended for all Canadian Shield lots |
| BCIN designer or P.Eng. drawings | CAD $3,000–$8,000 | Required for permit submission |
| Total soft cost range | CAD $15,000–$50,000+ | Consistently the most underestimated budget line |
HST at 13 percent applies to professional fees. Occupancy permit application is a separate fee payable at project completion — confirm current rate with your area municipality.
For the complete all-in site budget framework across all lot types and model tiers see our Muskoka prefab home prices guide.
Shoreline Setbacks by Township — The Distance That Determines Your Floor Plan
Muskoka’s defining feature is its waterfront — and shoreline setbacks vary in their application and enforcement across the District’s six area municipalities.
Getting the setback wrong before purchasing land is expensive. Getting it wrong after purchasing land is worse.
| Municipality | Setbacks (Principal / Accessory) | Key Note |
|---|---|---|
| Muskoka Lakes Township | 30 m / 20 m from HWM | Most stringent; WR zoning on Big Three lakes |
| Town of Bracebridge | 30 m / 20 m from HWM | SR1 zone; Lake Muskoka shoreline |
| Town of Gravenhurst | 30 m / 20 m from HWM | Confirm by zoning designation |
| Town of Huntsville | 30 m / 20 m from HWM | Varies by waterbody |
| Township of Lake of Bays | 30 m / 20 m from HWM | CA overlay common |
| Township of Georgian Bay | 30 m / Variable from HWM | Coastal and island provisions |
HWM = High Water Mark, formally established by licensed Ontario Land Surveyor. Conservation Authority buffers may impose stricter requirements than the zoning bylaw minimum — whichever is greater applies.
Source: District Municipality of Muskoka Official Plan and area municipality zoning bylaws. Confirm current requirements with your specific township before any design or floor plan selection.
What the high-water mark survey actually means for your build:
The high-water mark is not the current shoreline. It is a legally defined elevation established by a licensed Ontario Land Surveyor based on historical water level data. It is routinely 2 to 5 metres inland from where the water sits on a calm summer day.
A Muskoka lakeside lot that looks perfectly positioned for a cottage may have significantly less buildable area than its visual shoreline suggests once the HWM setback is formally established.
My Own Cottage confirms the HWM setback implication for every waterfront lot at site assessment — before any floor plan or home design is selected.
For lot-specific setback confirmation in Bracebridge see our prefab homes Bracebridge guide. For Gravenhurst waterfront lots see our prefab homes Gravenhurst guide.
The January 1 Deadline — The One Date Every Muskoka Prefab Buyer Must Know
Development charges across the District of Muskoka are indexed annually on January 1. The current year’s rates are locked for any buyer who submits a complete building permit application before that date.

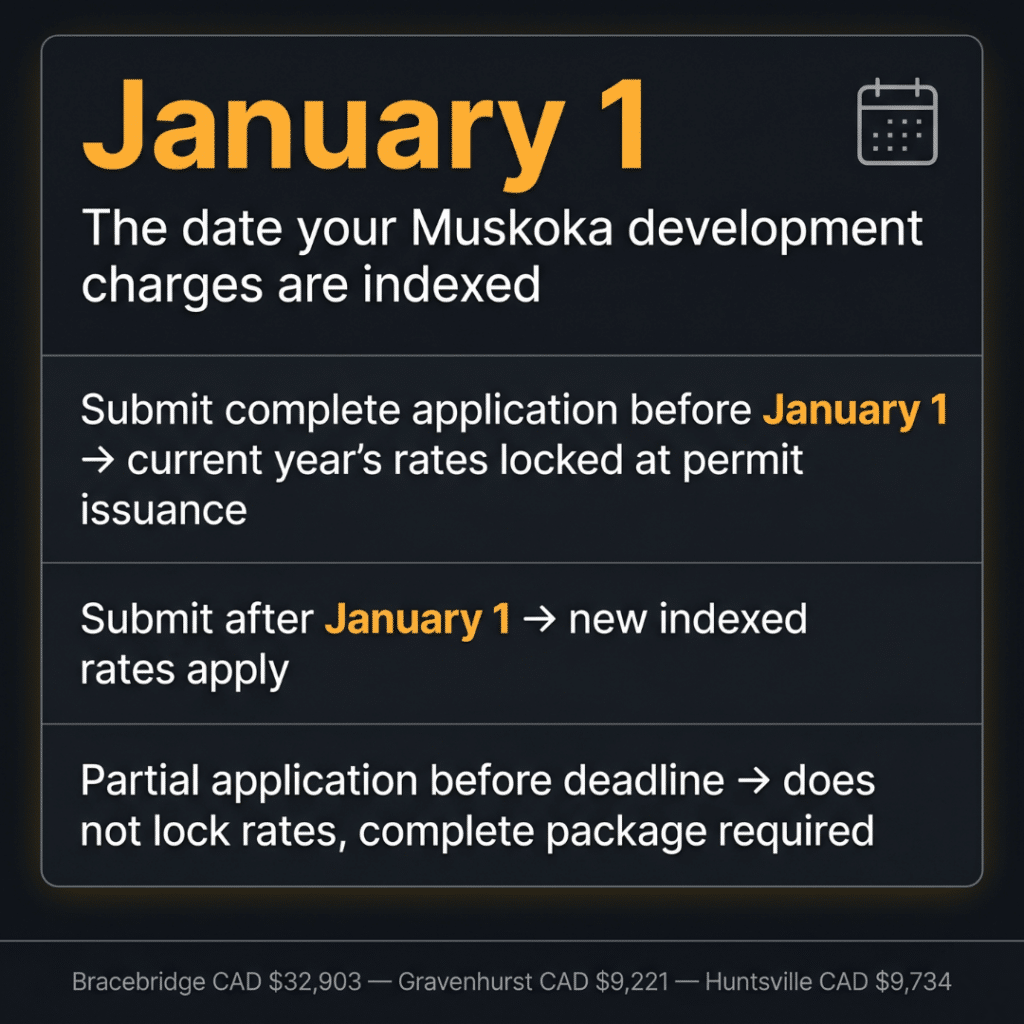

The visual below shows exactly what happens depending on when your application is submitted — and why only a complete permit application submitted before January 1 locks the current year’s rates.
January 1 is the cutoff that determines your development charges. A complete application before the deadline locks current rates — partial submissions do not.
On an urban Bracebridge lot, the combined Town and District development charge is CAD $32,903 at current 2026 rates. If rates index upward on January 1, 2027, a buyer who submitted before the deadline pays the 2026 rate at permit issuance — regardless of when the permit is ultimately issued.
A buyer who submits after the deadline pays the new indexed rate.
This is the most actionable cost-saving strategy available in the Muskoka prefab permit process — and it appears on zero competing pages in this SERP.
The strategy requires a complete application package submitted before January 1. A partial application submitted before the deadline does not lock the current rate. The clock starts when the municipality receives a complete submission — all documents, all drawings, all supporting approvals.
For buyers in the planning stage in Q3 or Q4, this deadline is the single most compelling reason to accelerate the site assessment, floor plan selection, and engineer drawing process rather than deferring to the following spring.
See our affordable prefab homes Muskoka guide for the complete permit timing strategy as part of the five cost-reduction framework.
Seasonal vs Year-Round — The Classification That Shapes the Entire Permit
The Ontario Building Code classifies dwellings as seasonal (Part 9 with relaxed provisions) or year-round residential (full Part 9 requirements including SB-12 energy compliance).
This single classification decision — made before the permit application is prepared, not after — determines your insulation requirements, foundation type, heating systems specification, plumbing winterisation obligations, Tarion warranty coverage eligibility, and CMHC mortgage insurance eligibility.
A seasonal classification may reduce upfront construction cost by CAD $30,000 to $80,000.
A cottage permitted as seasonal cannot legally serve as a year-round primary residence, cannot qualify for standard Tarion home warranty coverage on year-round residential terms, and faces more restrictive financing conditions through conventional lenders.
Confirm which classification you are building to at the first consultation — before any permit application is prepared and before any floor plan or home design is finalised.
For the complete OBC compliance framework for year-round Muskoka builds including SB-12 R-value requirements and Climate Zone 6 mechanical specifications see our four-season prefab cottages Muskoka guide.
My Own Cottage — Complete Permit Management for Muskoka Prefab Builds
My Own Cottage is based in Orillia and delivers OBC compliant, HCRA registered, Tarion enrolled prefab homes across the Muskoka District and Northern Ontario.
Our service areas include all six lower-tier Muskoka municipalities, Parry Sound area, and the full range of cottage country lot types from urban serviced lots in Bracebridge to water-access-only lots on Lake Muskoka.
This is the outcome most buyers are working toward — not a permit, but a completed, legally occupied home that performs through a full Muskoka winter.
A completed OBC-compliant prefab home in Muskoka winter conditions — cleared access, full snow load, and active occupancy confirming true year-round livability.
We manage the complete permit application process for every Muskoka build as standard:
• CSA A277 factory inspection documentation package preparation
• BCIN-compliant engineering drawings coordination
• Cloudpermit application submission and deficiency notice response
• Conservation Authority pre-consultation and Section 28 permit application
• Septic design coordination with a Licensed Septic System Designer
• Township building department engagement and chief building official early contact
• Occupancy permit application at project completion
Every permit project begins with a complete site assessment confirming your lot’s zoning classification, Conservation Authority jurisdiction, setback compliance, foundation type suitability for your Canadian Shield terrain, and verified all-in permit cost.
This happens before any design commitment is made and before any contract is signed.
Our project managers guide you through every step of the way from first site assessment through occupancy permit.
Verify our active HCRA registration at the Ontario Builder Directory before signing any purchase agreement.
No surprises. No hidden costs. No pressure.
🧑💼 Request a Free Consultation
📲 Call Us Directly: (705) 345-9337
🏘️ View Our Design Catalogue
✅ Ontario-Built | ⚡ Energy-Efficient | 🏡 Fully Customizable | 🚚 Fast Delivery
Alternatively, for your convenience, you can also simply fill out the contact form below and we’ll get back to you soon! 👇
Frequently Asked Questions — Prefab Home Permits Muskoka
Does every prefab home require a building permit in Muskoka?
Yes — every prefab or modular home intended for permanent or seasonal occupancy requires a building permit from the applicable area municipality before installation begins.
This applies across all six Muskoka municipalities: Muskoka Lakes Township, Bracebridge, Gravenhurst, Huntsville, Lake of Bays, and Georgian Bay.
The Ontario Building Code does not distinguish between site-built and factory-built dwellings for permit purposes — both must demonstrate compliance with the same structural, fire, and life-safety standards and applicable laws.
CSA A277 factory certification streamlines the inspection pathway but does not substitute for the building permit, foundation inspection, or occupancy permit required before legal occupation.
This applies equally to new Muskoka cottage builds, additions to an existing building on a cottage property, and accessory sleeping structures added to lots with an existing principal dwelling.
What are the permit requirements for a prefab home in Muskoka?
Every Muskoka prefab build must satisfy four distinct regulatory layers enforced by four different authorities — all initiated simultaneously, not sequentially.
Layer 1 is the District Municipality of Muskoka Official Plan, which sets shoreline setbacks, lot coverage limits, and accessory structure size limits.
Layer 2 is the area municipality zoning bylaw, which implements District policy at the lot level with township-specific permitted uses and setback dimensions based on your lot sizes and zoning category.
Layer 3 is the Conservation Authority Section 28 permit, required for development within 30 metres of a shoreline, wetland, or floodplain.
Layer 4 is the Ontario Building Code municipal building permit from the applicable area municipality.
All four must run in parallel. Initiating them sequentially is the single most common cause of Muskoka building permit timelines extending to 12 months or more.
Property owners who understand this framework before purchasing land are in a fundamentally different position than those who discover it after signing a contract.
What documents are required for a prefab home permit application in Muskoka?
A complete Muskoka prefab permits application requires all of the following submitted simultaneously in the first package:
• A completed application form via Cloudpermit or paper submission
• A site plan drawn to scale showing all setback dimensions and drainage
• Architectural and structural drawings by a BCIN-registered designer or P.Eng.
• A grading and drainage plan
• The CSA A277 certification label and factory inspection report package from the manufacturing facility
• Septic design for rural lots under OBC Part 8
• OBC SB-12 energy compliance documentation for year-round builds
• HCRA builder registration confirmation
• Conservation Authority permit confirmation where the lot is within a regulated area
The CSA A277 documentation package from the manufacturing facility is the most commonly missing item in first submissions — its absence immediately triggers a deficiency notice and resets the effective review clock.
A quality product built to high build quality standards in a certified factory is only as useful as the documentation that accompanies it at permit submission.
What are the steps to apply for a building permit for a prefab home in Muskoka?
A complete Muskoka prefab building permit application follows nine sequential steps — but steps 3 through 7 must run simultaneously, not one after another.
Step 1: Confirm your lot scenario — primary dwelling, accessory sleeping cabin, or water-access-only. This determines which of the four approval layers apply and what the complete permits application package must contain.
Step 2: Complete a site assessment confirming zoning designation, Conservation Authority jurisdiction, shoreline setback dimensions, and foundation type suitability before any floor plan or design concept is finalised.
Step 3: Engage a Licensed Septic System Designer for rural lots — septic design and the resulting septic permit must be in hand before the building permit application can be finalised.
Step 4: Commission a licensed Ontario Land Surveyor to establish the formal high-water mark on any waterfront lot.
Step 5: Obtain engineered manufacturer drawings and BCIN-reviewed site-specific drawings for the permit package. For custom home or custom design builds, additional drawing revisions may be required to reflect lot-specific modifications.
Step 6: Initiate Conservation Authority pre-consultation and Section 28 permit application simultaneously with the building permit application.
Step 7: Submit the complete building permit application via Cloudpermit with all documents included in the first submission.
Step 8: Respond promptly to any deficiency notices — each response resets the effective review clock if incomplete.
Step 9: Schedule all on-site inspections — foundation, utility connections, and final occupancy permit — through Cloudpermit or direct contact with the municipal building department.
My Own Cottage manages every step of the way from first site assessment through occupancy permit as standard for every Muskoka construction project.
How long do prefab home permits take in Muskoka?
Budget 6 to 12 weeks for permit approval on a complete road-accessible primary dwelling application.
The Ontario Building Code sets a legislated review period of 10 business days for complete residential applications — but that clock does not start until the municipality deems the submission complete.
Waterfront lots requiring Conservation Authority approval add four to sixteen weeks. Water-access-only lots add further logistics planning time to the building process.
The five most common causes of delay in order of frequency:
• Missing CSA A277 documentation from the manufacturing facility
• Incomplete site plan
• Conservation Authority pre-consultation not completed before submission
• Septic permit and septic design not yet in hand
• Piecemeal document submissions that reset the effective review clock
A complete first submission — all documents, all authorities, simultaneously — is the strategy that compresses the Muskoka building timeline from 12 months to 6 months on most road-accessible lots.
What is the average cost of permits for a prefab home in Muskoka?
Combined permit fees, development charges, and professional fees for a complete Muskoka prefab construction project typically total CAD $15,000 to $50,000 or more depending on lot type and municipality.
Development charges alone range from CAD $9,221 in Gravenhurst and CAD $9,734 in Huntsville to CAD $32,903 combined on urban Bracebridge lots.
Municipal building permit fees run CAD $3,500 to $12,000 by township and declared construction value.
Professional fees — septic designer, BCIN designer, Ontario Land Surveyor, geotechnical engineer — add CAD $8,000 to $30,000 depending on lot type.
Conservation Authority permit fees add CAD $500 to $3,000 at base, with Natural Heritage Evaluations adding a further CAD $5,000 to $25,000 on complex waterfront lots.
Development charges are payable at permit issuance and indexed annually on January 1 — a complete application submitted before that date locks the current year’s rates.
Note that demolition permits carry separate fees where an existing building or existing structure must be removed before a new prefab home is placed on the same footprint.
Is there a faster permit process for small prefab structures or sleeping cabins in Muskoka?
The accessory sleeping cabin pathway — a secondary structure added to an existing cottage property within the approximately 600 sq ft accessory structure size limit — typically moves faster than a primary dwelling permit.
This is because development charges generally do not apply to non-residential accessory structures, the septic permit process is often simplified where the existing septic system can accommodate additional load, and the regulatory scope is narrower.
Three of the four approval layers typically apply rather than all four. Timeline for a complete accessory structure application on a road-accessible lot typically runs 4 to 8 months.
This pathway also applies to tiny homes and compact modular structures used as guest cabins or bunkie replacements on existing cottage properties, provided they fall within the township’s accessory structure size limits.
My Own Cottage’s Fox Den at 505 square feet is sized specifically for this pathway. See our prefab bunkie Muskoka complete guide for the sleeping cabin regulatory framework by township.
Do I need a Conservation Authority permit for a prefab home near a lake in Muskoka?
Yes — if your property is within a regulated area, typically within 30 metres of a shoreline, wetland boundary, or floodplain limit.
Under Ontario Regulation 179/06, a Section 28 permit from the applicable Conservation Authority is required in addition to the municipal building permit — not instead of it.
In Muskoka, the Muskoka Watershed Council has jurisdiction over the majority of the District. The Lake Simcoe Region Conservation Authority covers the southern fringe.
Conservation Authority reviewers assess shoreline vegetation disturbance, water supply proximity, and stormwater management — all of which are directly affected by site work and foundation installation.
A crane-set modular installation on pre-installed helical piers disturbs significantly less ground than months of conventional site-built framing activity, which is a documented advantage in Conservation Authority permit applications.
CA approval must be confirmed before the municipal building permit is issued. Source: muskokawatershed.org.
What are the zoning laws affecting prefab homes in Muskoka?
Zoning for prefab homes in Muskoka is governed by each area municipality’s implementing zoning bylaw, which applies the District Municipality Official Plan’s land-use policy framework at the lot level.
The most relevant zoning classifications for Muskoka building projects are Waterfront Residential (WR) in the Township of Muskoka Lakes — governing Lake Muskoka, Lake Rosseau, Lake Joseph, and the Port Carling area — Shoreline Residential (SR1) in Bracebridge, and Rural Residential (RR) across inland lots in all six municipalities.
Each classification carries its own permitted uses, minimum lot sizes, maximum lot coverage limits, building height restrictions, and accessory structure provisions.
Zoning also determines whether additions — including Muskoka Room additions to an existing building — require a separate permit or fall within accessory structure provisions.
Zoning must be confirmed at the lot level before any floor plan or home building design is finalised.
My Own Cottage confirms the applicable zoning classification for every Muskoka lot at site assessment before any design concept is selected.
Can I get a turnkey prefab home service that includes permit management in Muskoka?
Yes — My Own Cottage delivers a complete turnkey prefab home service across Muskoka and Northern Ontario that includes the full permit management process as standard. This covers:
• CSA A277 factory inspection documentation preparation from our manufacturing facility
• BCIN-compliant engineering drawings coordination
• Cloudpermit application submission and deficiency notice response
• Conservation Authority pre-consultation and Section 28 permit application
• Septic design coordination with a Licensed Septic System Designer
• Township building department engagement
• Occupancy permit application at project completion
The permit management process runs simultaneously with factory manufacturing through the parallel build model — compressing the total timeline rather than adding permit waiting time on top of production time.
Every project begins with a complete site assessment confirming the permit scope, timeline, and all-in cost before any commitment is made.
Our quality homes are built to high build quality and energy efficiency standards at every price tier — and the permit process is managed with the same rigour as the construction itself.
Every step of the way from first site assessment through occupancy permit is coordinated by My Own Cottage’s project managers.
What are the development charges for a prefab home in Bracebridge?
Under By-law No. 2024-034 effective January 1, 2026, the combined development charge is CAD $32,903 for an urban serviced lot (Town of Bracebridge CAD $10,389 plus District of Muskoka urban CAD $22,514) or CAD $15,535 for a rural lot (Town CAD $10,389 plus District rural CAD $5,146).
Development charges are payable at permit issuance and indexed annually on January 1. A complete building permit application submitted before the indexing date locks in the current year’s rates — a meaningful saving on a CAD $32,903 charge if rates increase.
Sources: Bracebridge development charges, Muskoka development fees.
For Gravenhurst the confirmed rate is CAD $9,221 under By-law 2024-110.
For Huntsville the confirmed rate is CAD $9,734 under By-law 2024-130.
For the Lake of Bays Township and Georgian Bay Township, confirm current development fees directly with the applicable building services department before finalising any project budget.
How do I check the status of my prefab home permit application in Muskoka?
For municipalities using Cloudpermit — including the Township of Muskoka Lakes and the Town of Bracebridge — permit application status can be tracked in real time through your Cloudpermit account at cloudpermit.com.
Log in, navigate to your active application, and view the current review stage, any outstanding deficiencies, and scheduled inspection dates.
This is particularly useful for monitoring the safety standards review stage and the building services inspection schedule.
For municipalities not yet using Cloudpermit, contact the applicable building department directly by phone or email to request a status update.
My Own Cottage manages Cloudpermit status monitoring for every active permit application as part of the complete permit management process, responding to deficiency notices immediately to prevent clock resets and keep the construction project on schedule.
Where do I contact the local building department for prefab permits in Muskoka?
Building permits in Muskoka are issued by the applicable area municipality — not the District. The relevant contacts for the six Muskoka municipalities are:
Township of Muskoka Lakes — Cloudpermit applications accepted. Jurisdiction covers Port Carling, Lake Muskoka, Lake Rosseau, and Lake Joseph waterfront properties.
Town of Bracebridge — Cloudpermit applications accepted.
Town of Gravenhurst — The Planning Division is responsible for the review, development, and implementation of land use policies and by-laws including the Town’s Official Plan.
Town of Huntsville — Cloudpermit available.
Township of Lake of Bays — confirm current building department contact and submission process.
Township of Georgian Bay — confirm current building department contact and submission process.
For Conservation Authority permits: Muskoka Watershed Council.
For District of Muskoka septic permits and planning matters: Muskoka Land Development.
My Own Cottage coordinates directly with all applicable authorities for every Muskoka build — property owners do not need to manage these relationships independently.
Can prefab homes get financing in Muskoka given the permit complexity?
Yes — CSA A277 certified modular homes on permanent foundations qualify for conventional mortgage financing, CMHC insured financing with as little as 5 percent down for a primary residence, and standard construction draw mortgages through major banks and credit unions.
The permit complexity does not affect financing eligibility — what matters to lenders is CSA A277 certification status, permanent foundation type, OBC compliance documentation, and build quality standards achieved in the manufacturing facility.
Non-certified factory-built products do not qualify for conventional financing regardless of permit status. The construction draw mortgage structure releases funds at milestone inspections — foundation, module delivery, and final occupancy — which aligns with the Muskoka permit process’s inspection schedule.
Interior finishes, vapour barrier installation, heating systems including heat pumps, and all mechanical rough-ins are completed in the controlled factory environment and documented in the CSA A277 inspection package that lenders require.
My Own Cottage provides the complete CSA A277 documentation package that most lenders require for factory-built home mortgage approval. See our affordable prefab homes Muskoka guide for the complete CMHC financing framework.
Verified External Resources
Ontario Building Code — O. Reg. 332/12 — Primary provincial standard governing all prefab and modular home construction in Ontario including factory-built housing certification, Part 9 residential requirements, and Part 8 on-site sewage system standards.
Ontario Ministry of Municipal Affairs and Housing — Building Permits Overview — Provincial guidance on the building permit process for new residential construction including factory-built homes.
Ontario MMAH — Building a Modular House — Official Ontario guide to modular home construction, CSA A277 certification, and the municipal permit process for factory-built housing.
CSA Group — CSA A277 Standard — The Canadian Standards Association factory certification standard confirming that a manufacturer’s quality management systems meet Ontario Building Code requirements.
Cloudpermit — Ontario Building Permit Portal — The digital permit submission platform used by several Muskoka municipalities for online building permit applications.
HCRA — Home Construction Regulatory Authority — Builder licensing registry — HCRA registration is mandatory for any builder selling a new home in Ontario.
HCRA — Ontario Builder Directory — Verify My Own Cottage’s active HCRA registration before signing any purchase agreement.
Tarion — New Home Warranty Program — Ontario’s statutory new home warranty program — Tarion enrollment is mandatory for every My Own Cottage build.
Town of Bracebridge — Building Permits and Development Charges — Bracebridge Cloudpermit process, By-law No. 2024-034 development charges, and building services contact.
District of Muskoka — Development Fees and Charges — District DC rates effective January 1, 2026.
District of Muskoka — Planning and Economic Development — Upper-tier planning authority governing shoreline setbacks and land-use policy across all six Muskoka municipalities.
Township of Muskoka Lakes — Building, Demolition and Construction — Township building permit applications, Cloudpermit registration, and the most stringent shoreline controls in Ontario.
Town of Gravenhurst — Building Permits — Building permits for southern Muskoka including Lake Muskoka south shore.
Town of Huntsville — Building and Planning — Building permits, By-law 2024-130 development charges, and Northeastern Public Health septic authority for Huntsville area properties.
Muskoka Watershed Council — Conservation Authority permit jurisdiction and Section 28 permit requirements for Muskoka waterfront development.
For the complete District-wide guide to prefab home construction across all Muskoka lot types see our prefab homes Muskoka complete buyer’s guide.
For verified all-in cost scenarios across all Muskoka lot types see our Muskoka prefab home prices guide.
For the complete affordable prefab path including the January 1 permit timing cost-reduction strategy see our affordable prefab homes Muskoka guide.
For Bracebridge-specific Cloudpermit process and By-law No. 2024-034 development charges see our prefab homes Bracebridge guide.
For Huntsville-specific permit fees and North Muskoka terrain see our prefab homes Huntsville guide.
For Gravenhurst-specific permit fees and Lake Muskoka waterfront lot realities see our prefab homes Gravenhurst guide.
For the complete guide to prefab bunkie and sleeping cabin permit rules by township see our prefab bunkie Muskoka complete guide.
For four-season OBC compliance and SB-12 requirements see our prefab cottages Muskoka guide.
For the complete Ontario permit guide covering provincial approval layers see our prefab home permits Ontario guide.
For the complete Ontario prefab overview see our prefab homes Ontario guide.
