Cottage Builders Rideau Lakes: The Approval Order for Your Lot

Cottage builders Rideau Lakes: four bodies approve a cottage build in this township, not one.

The Township of Rideau Lakes issues building permits and septic permits. The United Counties of Leeds and Grenville decides land division.

A conservation authority regulates waterfront development. Parks Canada permits work over the bed of the Rideau Canal.

No fees or commitment. Bring your property and how you plan to use it.

✓ HCRA Licensed | ✓ Tarion Enrolled

Sean Stevenson, Chief Marketing Officer at My Own Cottage, an Ontario prefab home builder based in Orillia specializing in small prefab homes and modular cottages.

Written by Sean Stevenson, Chief Marketing Officer and Buyer Experience Lead, My Own Cottage Inc.

5 years guiding Ontario buyers • Updated 7 Sept 2026

You are holding a lot in Rideau Lakes Township, or closing on one. What follows names each body, states what it decides, and sets them in the order they run.

My Own Cottage Inc. is an HCRA-licensed, Tarion-enrolled prefab home and cottage builder based in Orillia, Ontario. We deliver anywhere in Ontario, we help with municipal permits, and licensed-trade installation affiliates handle foundation, site preparation and servicing.

Bring your roll number and your water frontage. An hour on the approval order costs less than a season lost to filing in the wrong sequence.

KEY TAKEAWAYS
1.

A building permit cannot be issued here if a planning approval is required first, so it is rarely the first step.

2.

Two conservation authorities hold parts of this township, and the boundary follows the watershed, not the village line.

3.

Parks Canada controls the canal bed, not your upland lot, but the federal permit runs on a longer clock.

4.

The Township issues septic permits itself, unlike neighbouring municipalities where a conservation authority does.

5.

Private road access is the norm on this shoreline, and it governs how a cottage reaches the site.

Who approves a cottage build in Rideau Lakes Township?

Four bodies approve a cottage build in Rideau Lakes Township, plus provincial ministries where a site triggers them. The Township is the body you deal with most, and the one that cannot act until the others have. Broader eastern Ontario coverage sits on our Kingston-area page.

Which body decides what

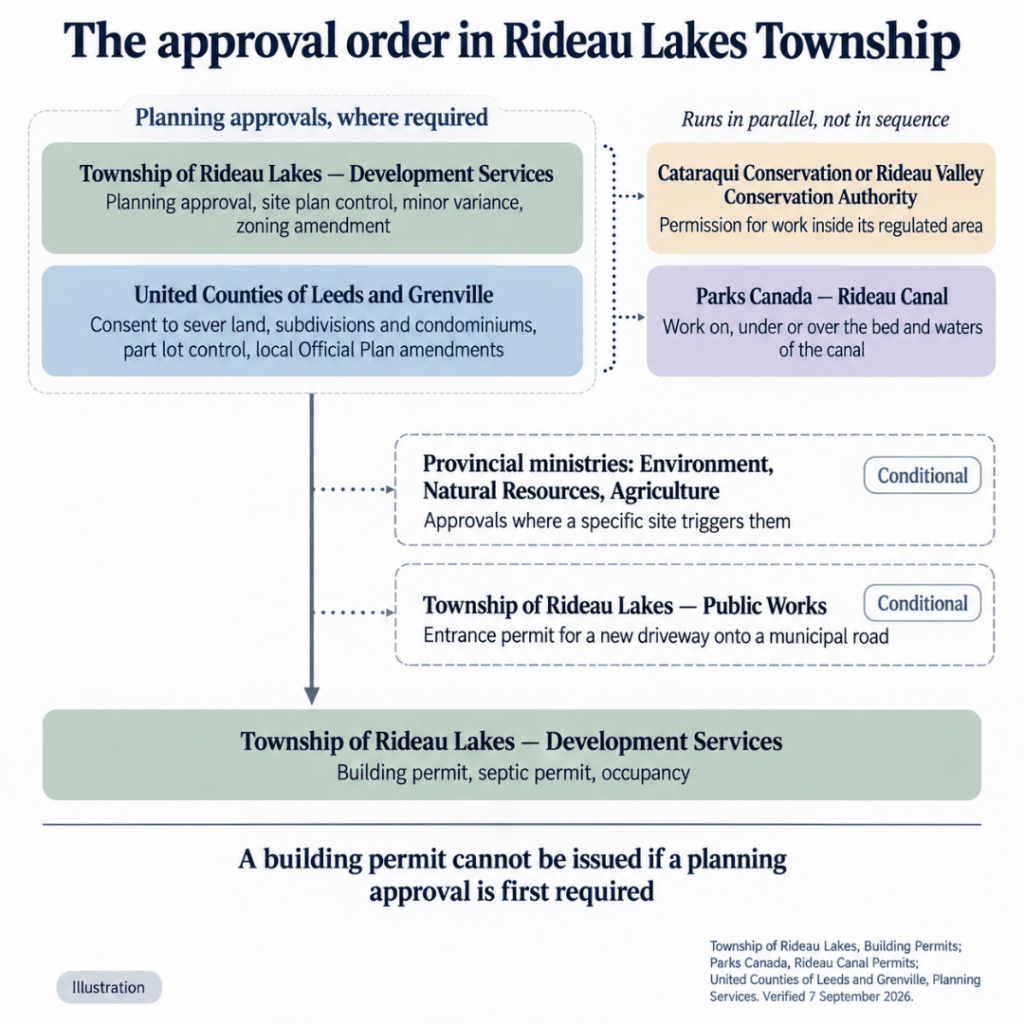

Approval sequence for a cottage build in Rideau Lakes Township, showing planning approvals, parallel authority reviews, conditional permits and the final building permit

The approval order for a cottage build in Rideau Lakes Township. The building permit closes the sequence, it does not open it, and a planning approval anywhere in the tier holds it up. Illustration.

Approving body What it decides What it does not decide
Township of Rideau Lakes, Development Services Building permits, septic permits, planning approval, site plan control, minor variance, zoning amendment, occupancy Whether the lot can be split; anything over the canal bed
Township of Rideau Lakes, Public Works Entrance Permit – through the Public Works Department Anything inside the lot line
United Counties of Leeds and Grenville Consent to sever land, subdivisions and condominiums, part lot control, local Official Plan amendments Your building permit
Cataraqui Conservation or Rideau Valley Conservation Authority Permission for work inside its regulated area Ontario Building Code compliance
Parks Canada, Rideau Canal Work on, under or over the bed and waters of the canal Anything landward of the canal bed
Provincial ministries: Environment, Natural Resources, Agriculture Approvals where a specific site triggers them The routine single-dwelling path

The Township lists ministry approvals as conditional.

Why the building permit is not the first step

The Township states the rule plainly: most construction requires a building permit, but a building permit cannot be issued if other planning approvals are first required. That sentence sets the whole order.

Which path a lot takes depends on two things.

Your lot Path What happens first
Complies with the zoning by-law, sits away from water Short Building permit application
Does not comply, or sits close to a lake or river Long Planning approval, then the building permit behind it

That is where municipal coordination stops being paperwork and starts costing weeks.

What changed: the comparison becomes a table, the bolded rule is the extractable sentence, and “Which path a lot takes depends on two things” gives the table a lead-in so it doesn’t sit under a heading unannounced.

The second section buries a sequenced requirement inside a sentence

The site plan requirement is a checklist — four distinct things that must appear on one drawing — and it currently runs as a single 38-word sentence with three commas and an “and”. A reader with a survey in front of them can’t check items off a sentence.

What has to be settled before you apply

Your site plan must show the sewage system location and the distance from every proposed structure to:

• the lot boundaries
• any right-of-way or easement
• the waterbody

You cannot draw that plan before you know where the septic can go.

The Township also requires the applicant to be the registered owner, or someone authorised in writing.

Prefabricated structures need a building permit like any other building, so choosing prefab cottages shortens nothing on this list — though how a cottage is built in sections before it reaches your lot is a different question from how it is approved.

Does your lot front the Rideau Canal, and what does that add?

Parks Canada owns and administers the bed of the Rideau Canal and its lakes and rivers, up to the original upper controlled water elevation. Fronting canal water does not put your cottage under federal jurisdiction. It puts the water in front of your cottage under federal jurisdiction.

What triggers a Parks Canada permit

A Parks Canada permit is required for any work on, under or over the bed and waters of the Rideau Canal. The trigger is where the work sits, not what type of structure it is, and repairs are treated the same as new work.

Work entirely above the high water mark falls outside that jurisdiction: dry upland boathouses need no federal permit, while docks and other structures reaching over the bed do. The canal runs from the Ottawa Locks to the south end of the Cataraqui River at Kingston, Parks Canada publishes the full list of waterbodies it administers, and a title search establishes how far your ownership extends toward the water.

Where the canal review falls in the sequence

The Parks Canada review runs early and in parallel with the municipal path, not after it. Parks Canada advises applying several months before the anticipated start date, and processing depends on application volume, site complexity and fish spawning windows.

The federal permit is not bolted on at the end of a build, and it does not accelerate because your delivery date is fixed.

What adjacent to the canal triggers on a planning application

Regulation under the Ontario Planning Act requires Parks Canada to be circulated as an adjacent landowner on development applications next to the canal, even where no in-water work is proposed. Severances, minor variances and zoning changes all reach them.

Parks Canada reviews those with the conservation authorities, as the Rideau Waterfront Development Review Team, then advises the Township and the Counties. Your application does not stop while that happens, but it is being read federally.

Which conservation authority covers a Rideau Lakes cottage lot?

Either Cataraqui Conservation or the Rideau Valley Conservation Authority covers a Rideau Lakes cottage lot, depending where in the township it sits. The boundary is the point buyers most often have to check, and it cannot be settled from a village name.

Both authorities count this township as theirs

Cataraqui Conservation names the Township of Rideau Lakes among its member municipalities, alongside Kingston, Brockville, Gananoque, Leeds and the Thousand Islands, South Frontenac and five others. The Rideau Valley Conservation Authority reports Rideau Lakes land inside its own watershed.

Parks Canada describes Cataraqui Conservation as operating from Newboro to Kingston, and the Rideau Valley Conservation Authority from Westport to Ottawa. Both endpoints sit inside or beside this township, so a lot near Newboro and a lot near Portland can answer to different authorities.

Why there is no village-by-village answer

Conservation authority jurisdiction follows the watershed, not the settlement. No list assigns Delta to one authority and Elgin to the other, because the boundary is a drainage divide and it can run through a single property.

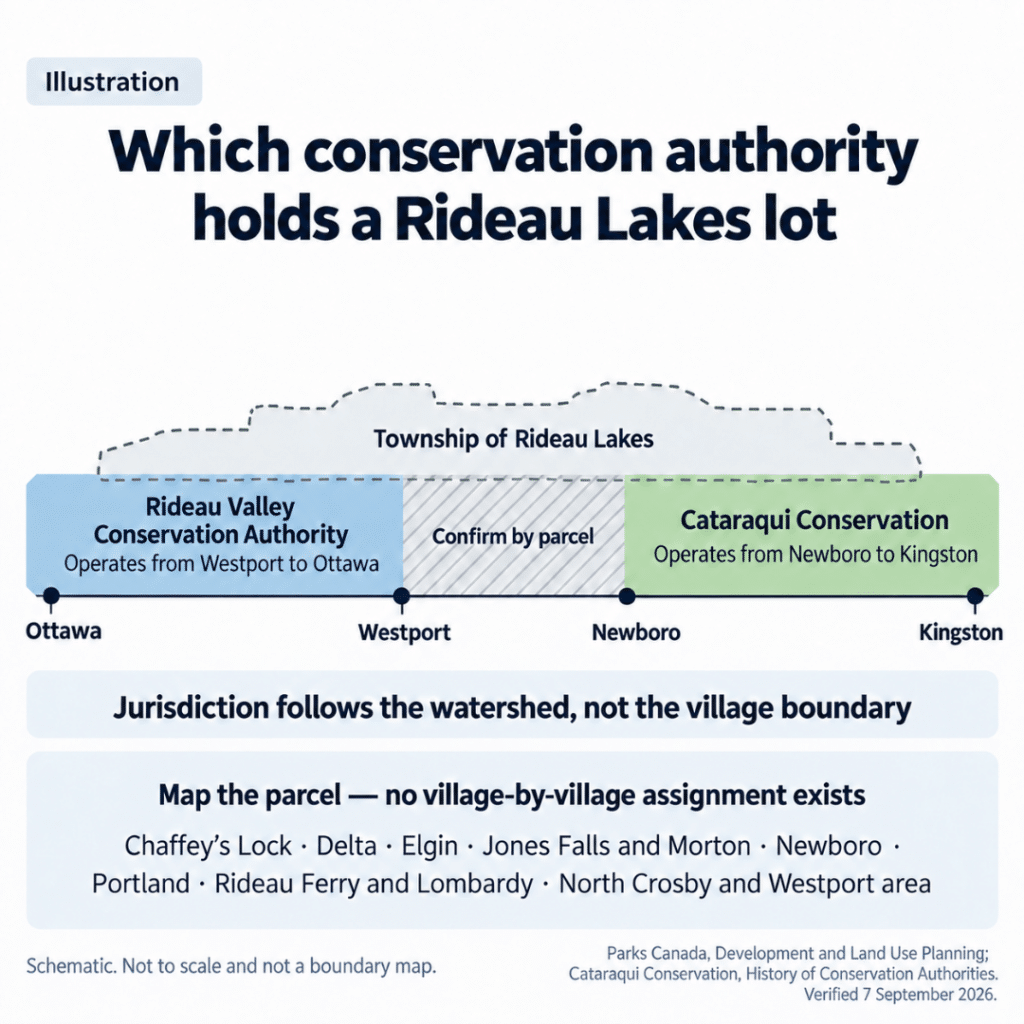

Cottage builders Rideau Lakes conservation authority schematic showing Rideau Lakes Township spanning Rideau Valley and Cataraqui Conservation areas, with the watershed split confirmed by parcel

Both authorities count Rideau Lakes Township as theirs. The boundary between them is a watershed divide, not a village line, so the parcel has to be mapped rather than assumed.

Map the parcel rather than assume. The Rideau Valley Conservation Authority publishes a GeoPortal, and Conservation Ontario publishes a Find a Conservation Authority page.

What the authority permit covers that a building permit does not

A conservation authority permit and a building permit answer different questions. A building permit asks whether the structure meets the Ontario Building Code; a conservation authority permission asks whether the work can happen in that location at all, inside a regulated area of shoreline, wetland or watercourse.

The Township lists conservation authority approval among the approvals that may be required before it will act, and its Official Plan encourages owners to consult Parks Canada and the relevant authority before filing rather than after a refusal.

The Township’s own advice is to consult before filing. If you are not sure which authority holds your parcel, settle it before anything is drawn.

How does septic approval work for Rideau Lakes cottages?

The Township of Rideau Lakes approves septic systems for cottages in the township, through its own Development Services Department. That is not the arrangement everywhere in this region, which is why the assumption trips buyers up.

Who issues the sewage system permit

Development Services issues the sewage system permit, from the Township office in Delta. Building and septic inspections run through the same office, and the Township names plumbing systems, including sewage systems, as work requiring a permit in their own right.

Neighbouring municipalities differ. The Rideau Valley Conservation Authority administers septic approvals for Ottawa, North Grenville and Smiths Falls, and the Mississippi Valley Conservation Authority does so for Westport, Tay Valley and four others. Rideau Lakes appears on neither list, and unlisted areas are directed to file with their own municipality.

What your site plan must show, and when

Your site plan must show the sewage system location drawn to scale, with the lot dimensions and the position of every proposed structure relative to the boundaries and to the waterbody. Because that plan accompanies the building permit application, the septic position is fixed while the cottage position is still open.

On a waterfront lot the septic location is also a planning question. Site plan control review for waterfront development examines drainage, septic system location, slope stability, erosion potential and the preservation of shoreline vegetation.

What site conditions constrain waterfront development here?

Bedrock, soil depth, slope and access constrain waterfront development in Rideau Lakes Township, and access is the condition that most often changes what a build costs.

Bedrock, soil depth and slope

The Township’s Official Plan identifies steep slopes, limited soil depth and sub-optimal soil percolation rates as conditions that can increase required water setbacks beyond the standard provision. Read that as a warning about the septic before it is a warning about the foundation.

Thin soil over rock constrains the leaching bed first, and the leaching bed constrains where the cottage can sit. Bedrock also changes the inspection path: under Part 8 of the Ontario Building Code, a sewage system built in clay soils or on bedrock can attract an additional subgrade inspection. How a foundation is chosen against those conditions is covered on our foundation options page.

Big Rideau Lake and lake sensitivity

Big Rideau Lake is treated differently from every other lake in the township. The Official Plan records it as the only cold-water lake in Rideau Lakes, managed as a lake trout lake by the Ministry of Natural Resources, and classified moderately sensitive on the basis of dissolved oxygen profiles and lake capacity modelling. All other township lakes are warm water lakes.

The Plan states that all township lakes can accommodate some limited additional development based on current water quality. Sensitivity does not stop a single-lot build, but it shapes how closely the shoreline portion is reviewed.

Private roads and water-access lots

Private road access is the historic norm on this shoreline rather than the exception. The Official Plan records that waterfront road access has generally been by private road, laid out to follow topography and vegetation rather than a grid.

That matters for a cottage delivered in sections in a way it does not matter for a load of lumber. Check the road agreement, the turning radii and the winter maintenance arrangement before you fix a building envelope. Some lots have no road frontage at all, and Parks Canada treats water-access-only properties as a distinct category.

Access is the question a drawing cannot answer. The road agreement, the turning radii, the winter maintenance arrangement and water-only frontage all decide what site work a lot needs — and site work is quoted separately against the lot.

Cottage builders Rideau Lakes buyers should know who they are contracting with

You sign one agreement with My Own Cottage Inc., and separate scoped work is carried out by licensed trades. Knowing which is which before you sign is the point of this section.

What My Own Cottage does

My Own Cottage Inc. is an HCRA-licensed, Tarion-enrolled prefab home and cottage builder based in Orillia, Ontario, and we deliver anywhere in Ontario. Our HCRA licence and Tarion enrolment are searchable by company name on the Ontario Builder Directory, the public record for both.

We help with municipal permits. Foundation, site preparation and servicing are carried out by licensed-trade installation affiliates — contracted trades rather than employees — quoted separately against your lot and set in the agreement before the build begins.

What the model price covers

Delivery and installation are two different things on a Rideau Lakes lot. The price shown against a preconfigured model covers the structure and delivery. Everything that happens to your ground is quoted separately.

Cottage builders Rideau Lakes consultation with My Own Cottage staff and prospective buyers discussing a cottage project at the company’s Orillia facility

A first consultation covers your property, how you intend to use the cottage and your timeline. Free, with no obligation.

Item Included in the model price
The structure Yes
Delivery to your lot Yes
Foundation No, quoted separately
Site preparation No, quoted separately
Servicing No, quoted separately
Municipal permits and charges No
Turnkey finishing No, quoted separately

On a Rideau Lakes lot the servicing line is the volatile one, because septic siting and shoreline constraints drive it. Custom cottages and prefab cottages face the same approval order here, and how the two compare on price and process is covered on our prefab versus traditional construction page.

The model price covers the structure and delivery. Everything else on this page happens to your ground. Before you compare numbers, see what the model price is attached to.

Which communities are inside Rideau Lakes Township?

The Township identifies its villages and hamlets as Chaffey’s Lock, Delta, Elgin, Jones Falls and Morton, Newboro, Portland, Rideau Ferry and Lombardy, and the North Crosby and Westport area. Waterfront development accounts for the majority of development activity across them.

Where Westport differs

The Village of Westport is a separate incorporated municipality with its own building department, listed by Parks Canada alongside the Township as a distinct municipality on the canal. The Township’s North Crosby and Westport area means surrounding township land, not the village.

Septic differs there too. Westport’s sewage system approvals are administered by the Mississippi Valley Conservation Authority, a third authority with no role inside Rideau Lakes Township. Check which municipality your civic address falls in before you file.

What actually differs between them

Two things differ between Rideau Lakes communities as building environments. The first is which conservation authority holds the site, since the Cataraqui and Rideau Valley operating areas meet between Newboro and Westport. The second is whether the water you front forms part of the Rideau Canal, which decides whether Parks Canada is in your sequence at all.

Building conditions in Frontenac County differ again, and that area is covered on its own page.

How we verified this

Claim verified Source Date checked
Permit sequence, septic through Development Services, site plan contents, ownership requirement, prefabricated structures need a permit Township of Rideau Lakes, Building Permits 7 September 2026
Site plan control review scope, setback increase conditions, private road norm, Big Rideau Lake classification, consult before filing Township of Rideau Lakes, Waterfront Development 7 September 2026
Canal bed jurisdiction, permit trigger, upland boathouse exemption, apply months ahead, canal extent, title search Parks Canada, Rideau Canal Permits 7 September 2026, page modified 19 January 2026
Two authorities and their operating areas, Planning Act circulation, Rideau Waterfront Development Review Team, Westport listed separately Parks Canada, Development and Land Use Planning 7 September 2026, page modified 5 November 2025
Rideau Lakes named a member municipality Cataraqui Conservation, History of Conservation Authorities 7 September 2026
Septic administration by municipality, unlisted areas file locally, Part 8 subgrade inspection on bedrock or clay Rideau Valley Conservation Authority, Apply for a Septic Permit 7 September 2026
Consent Granting Authority, subdivisions, part lot control, local Official Plan approvals United Counties of Leeds and Grenville, Planning Services 7 September 2026

Cottage Builders Rideau Lakes: Frequently Asked Questions

What permits do I need to build a cottage in Rideau Lakes Township?

You need a building permit from the Township of Rideau Lakes for new construction, and a septic permit from the same Development Services Department where the lot is not on municipal sewers. Depending on the site you may also need an entrance permit, planning approval or site plan control, permission from a conservation authority, and a Parks Canada permit for work over the canal bed. The Township cannot issue the building permit if a planning approval is required first, and notifying the Township for each required inspection is the applicant’s responsibility.

Do I need Parks Canada approval to build on the Rideau Canal?

You need Parks Canada approval only for work on, under or over the bed and waters of the Rideau Canal, including shoreline stabilisation and repairs to existing in-water structures. A cottage built entirely above the high water mark needs no Parks Canada permit. Separately, regulation under the Ontario Planning Act requires Parks Canada to be circulated for comment on severances, minor variances and zoning changes on land next to the canal.

Which conservation authority covers Rideau Lakes Township?

Both Cataraqui Conservation and the Rideau Valley Conservation Authority hold parts of Rideau Lakes Township. Cataraqui Conservation names the township among its member municipalities, and the Rideau Valley Conservation Authority reports township land inside its own watershed. Conservation authority jurisdiction follows the watershed rather than the village boundary, so a lot near Newboro and a lot near Portland can answer to different authorities. Map the parcel using Conservation Ontario’s lookup before filing.

Who approves septic systems for a Rideau Lakes cottage?

The Township of Rideau Lakes approves septic systems for cottages in the township, through its own Development Services Department. No conservation authority administers sewage system permits here, unlike Westport, Tay Valley and Smiths Falls, where a conservation authority does. The sewage system location must appear on the site plan filed with the building permit application, so the septic position is settled before the cottage position is final.

Can I build a prefab cottage on a Rideau Lakes lot with private or water-only access?

Yes, a prefab cottage can be built on a Rideau Lakes lot with private or water-only access. Private road access is the historic norm on Rideau Lakes waterfront property rather than the exception, and Parks Canada recognises water-access-only properties as a distinct category. Access removes no approval from the sequence. It governs how materials, licensed trades and a delivered structure reach the site, so road agreements, turning radii and winter maintenance should be checked before a building envelope is fixed.

How long do approvals take for a Rideau Lakes cottage build?

No published Township figure covers total approval time for a cottage build in Rideau Lakes, so any duration quoted for this township should be traced to its source before you plan around it. What is documented: Parks Canada advises applying several months before your anticipated start date, and its processing depends on application volume, site complexity and fish spawning windows. The Township cannot issue a building permit while a planning approval is outstanding, and for waterfront development it notes that relevant applications may sometimes be filed simultaneously.

Start with the sequence, not the drawings

Every approval named on this page depends on where the structure sits, and where the structure sits depends on where the septic can go. That order does not change, and reversing it is what puts a Rideau Lakes build a season behind.

Bring your roll number, your water frontage and whatever survey exists. Cottage builders Rideau Lakes buyers should expect a figure scoped against the actual lot, not against a floor area.

Get a scoped quote.

MY OWN COTTAGE

Contact Us

We usually respond within 24 hours!

DIRECT ENQUIRIES

About the Author

Sean Stevenson, Chief Marketing Officer at My Own Cottage, an Ontario prefab home builder based in Orillia specializing in small prefab homes and modular cottages.

Sean Stevenson is Chief Marketing Officer and Buyer Experience Lead at My Own Cottage Inc., an HCRA-licensed, Tarion-enrolled prefab home and cottage builder based in Orillia, Ontario. The company’s licence and enrolment are searchable by company name on the Ontario Builder Directory.

He works alongside the build team, guiding Ontario buyers through the part of a prefab cottage purchase that is easiest to underestimate: what the model price covers, what is quoted separately against the lot, and which approvals a specific municipality requires before anything is built.
