LSRCA Waterfront Permits Orillia: The Complete 2026 Guide to Fees, Timelines & the Lake Simcoe Protection Plan
Last updated: May 17th, 2026
Written by building specialists at My Own Cottage
Confirm your Orillia waterfront lot’s LSRCA permit path before you design, budget, or build.
✓ HCRA Licensed | ✓ Tarion Enrolled | ✓ OBC Compliant | ✓ Ontario-Built
If you own — or are purchasing — a waterfront property near Orillia, Lake Couchiching, or anywhere within the Lake Simcoe watershed, the Lake Simcoe Region Conservation Authority permit process is one of the most consequential regulatory steps you will face.
Unlike a City of Orillia building permit issued under the Ontario Building Code, an LSRCA permit is a separate legal requirement administered under Ontario Regulation 41/24 and Section 28 of the Conservation Authorities Act.
It applies to construction, site grading, fill placement, and shoreline work within regulated areas — and it runs in parallel with, not instead of, your municipal building permit.
This guide gives Orillia-area property owners and prefab home builders a clear, actionable understanding of which activities trigger an LSRCA permit, what the 2026 fee schedule looks like, how long the process takes, and what mistakes cost the most money.
For the broader market overview, including urban lot costs, prefab model planning, and full build budgeting, see our prefab homes Orillia guide.
For the complete Ontario-wide regulatory framework including CSA A277 certification and Tarion enrollment, see our prefab homes Ontario guide.
Confirm your Orillia waterfront lot’s LSRCA permit path before you design, budget, or build.
Quick Reference — LSRCA Contacts and Key Tools
| Planning & Permits hub | lsrca.on.ca/index.php/planning-permits/ |
| Do I Need a Permit? | lsrca.on.ca/index.php/planning-permits/do-i-need-a-permit/ |
| Regulation Map Viewer | maps.lsrca.on.ca/EH5Viewer/index.html?viewer=LSRCARegulations |
| Electronic applications | lsrca.formstack.com/forms/permit_application |
| Submit applications | [email protected] |
| Contact permits & regulations | [email protected] |
| Phone | 905-895-1281 / 1-800-465-0437 toll free |
| Office address | 120 Bayview Parkway, Newmarket, Ontario L3Y 3W3 |
| Public office hours | Monday–Thursday 8:30 am–4:30 pm (appointment recommended) |
| 2026 fees (summary) | Pre-consultation $780 · Intermediate $2,013 · Major $6,018 |
What Is the LSRCA and Why Does It Matter for Orillia Waterfront Properties?
The Lake Simcoe Region Conservation Authority (LSRCA) is one of Ontario’s 36 conservation authorities, mandated under the Conservation Authorities Act (R.S.O. 1990, c. C.27) to protect people and property from natural hazards and to conserve the water quality and ecological health of the Lake Simcoe watershed.
Its jurisdiction spans approximately 3,400 km² — draining through the Severn River into Georgian Bay and the broader St. Lawrence system — and includes Lake Couchiching, which connects to Lake Simcoe through the Atherley Narrows.

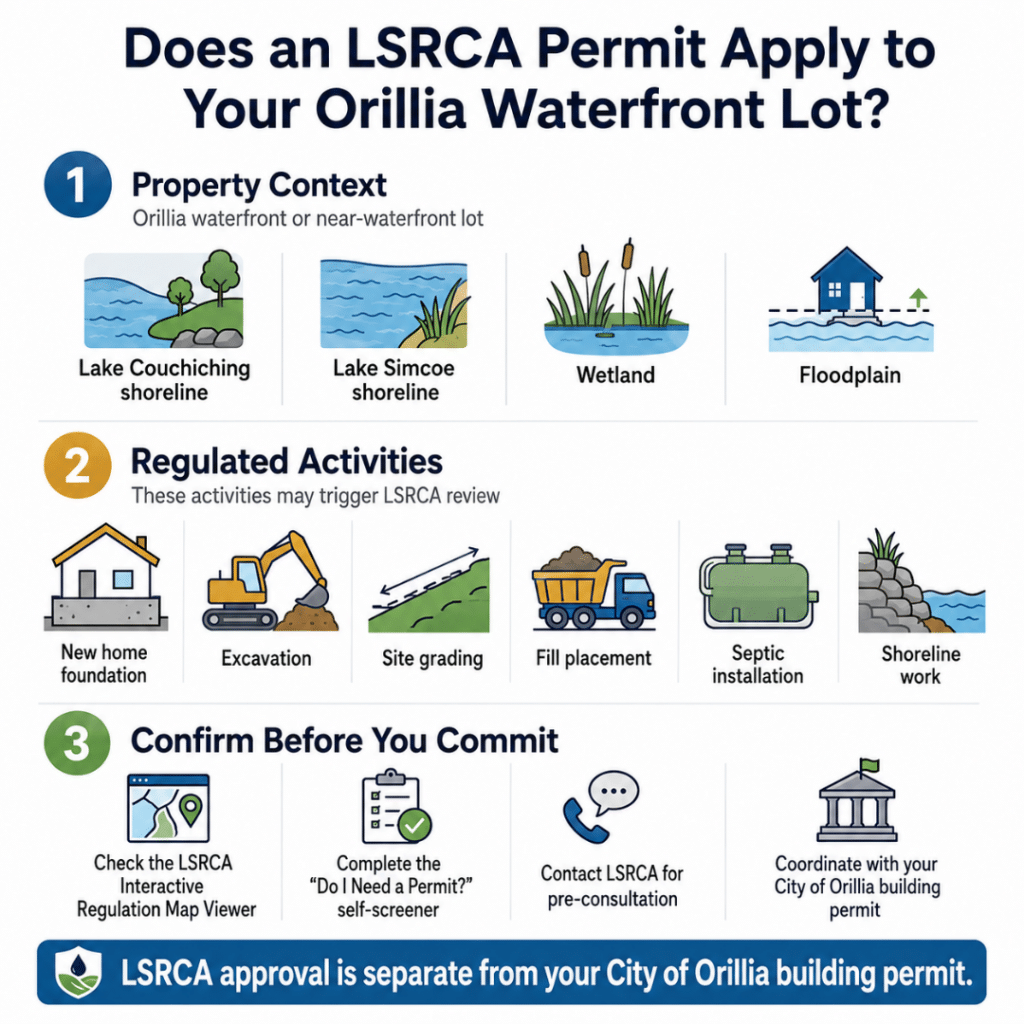

The visual below shows the practical jurisdiction question every buyer should answer before designing, grading, filling, installing septic, or altering the shoreline.
Orillia waterfront properties near Lake Couchiching and Lake Simcoe may require LSRCA review before construction, grading, fill placement, septic work, or shoreline changes move forward.
Because Orillia straddles both waterbodies, virtually every waterfront property around the city falls within LSRCA jurisdiction.
The same applies to adjacent Simcoe County municipalities — Ramara Township, Severn Township, Oro-Medonte Township — as well as Barrie, Innisfil, and member municipalities extending south through York Region toward the Kawartha Lakes.
For a verified side-by-side comparison of LSRCA jurisdiction, development charges, and regulatory complexity across all five build zones near Orillia, see our best places to build near Orillia guide.
The LSRCA administers Ontario Regulation 41/24, effective April 1, 2024, replacing O. Reg. 179/06. Any engineering report or guidance referencing O. Reg. 179/06 may be out of date — always verify current requirements against O. Reg. 41/24 directly with LSRCA staff.
The LSRCA is not the City of Orillia Building Division. The City issues building permits under the Ontario Building Code to ensure structural safety and occupancy standards.
The LSRCA issues separate development permits under O. Reg. 41/24 to protect people, property, and natural features from natural hazards.
For most waterfront builds around Orillia, both approvals are required before site preparation begins — running as parallel processes with separate fee structures, timelines, and contacts.
Running LSRCA and City permit applications sequentially is one of the most expensive scheduling mistakes a waterfront builder can make. We initiate both simultaneously on every build.
Why the LSRCA Has Unique Powers — The Lake Simcoe Protection Plan Overlay
The LSRCA is the only conservation authority in Ontario that also administers the Lake Simcoe Protection Act, 2008 and the Lake Simcoe Protection Plan (LSPP) — a legally binding provincial document, not a guideline.
The LSPP imposes four obligations directly material to waterfront property owners near Orillia:
• Phosphorus management: New development must demonstrate phosphorus loading to the lake will not increase post-construction. Standard septic systems are generally insufficient — enhanced, phosphorus-removing tertiary treatment systems are the norm within the watershed.
• Shoreline vegetation protection: The LSPP establishes a 30-metre naturally vegetated buffer target along Lake Simcoe’s shoreline. Near Lake Couchiching, the City of Orillia implements a 15-metre buffer under its own zoning policy — in addition to LSRCA and LSPP requirements.
• Natural heritage system protection: Development affecting woodlands, wetlands, wildlife habitat, and fish habitat is subject to natural heritage evaluation requirements.
• Stormwater quality: Development proposals must address stormwater quality and quantity to protect Lake Simcoe from nutrient loading.
This overlay means Orillia-area waterfront buyers face a more complex regulatory environment than comparable buyers in Muskoka or on non-watershed rivers. Understanding this before purchasing a lot — not after site work begins — is not optional.
Is My Waterfront Property in a Regulated Area?
The permit obligation arises when proposed development occurs within a regulated area — a geographically defined zone associated with natural hazards or ecologically sensitive features.
Types of Regulated Areas on Waterfront Lots
| Regulated Area Type | What Defines It | Common on Lake Couchiching Lots? |
|---|---|---|
| Shoreline hazard area | Flooding hazard limit + wave uprush + erosion hazard; most restrictive governs | Yes — most Lake Couchiching waterfront parcels |
| Floodplain | Low-lying land adjacent to watercourses draining to Lake Couchiching | Yes — areas adjacent to inflowing streams |
| Wetlands and wetland buffers | Coastal wetlands, Provincially Significant Wetlands; buffer zone activities also regulated | Yes — particularly southern Lake Couchiching shoreline |
| Steep slopes and unstable soils | Natural bluffs, unstable glaciolacustrine materials; geotechnical investigation often required | Yes — many Orillia waterfront lots include bluffed shorelines |
The Adjacent Allowance — Why You May Be Regulated Even When You’re Not at the Water
This is the concept that consistently surprises buyers and their real estate agents.
O. Reg. 41/24 extends regulation a defined distance inland beyond the hazard limit itself — a structure that appears set back from the waterline may still fall within the regulated area if it sits within the adjacent allowance landward of the hazard limit.

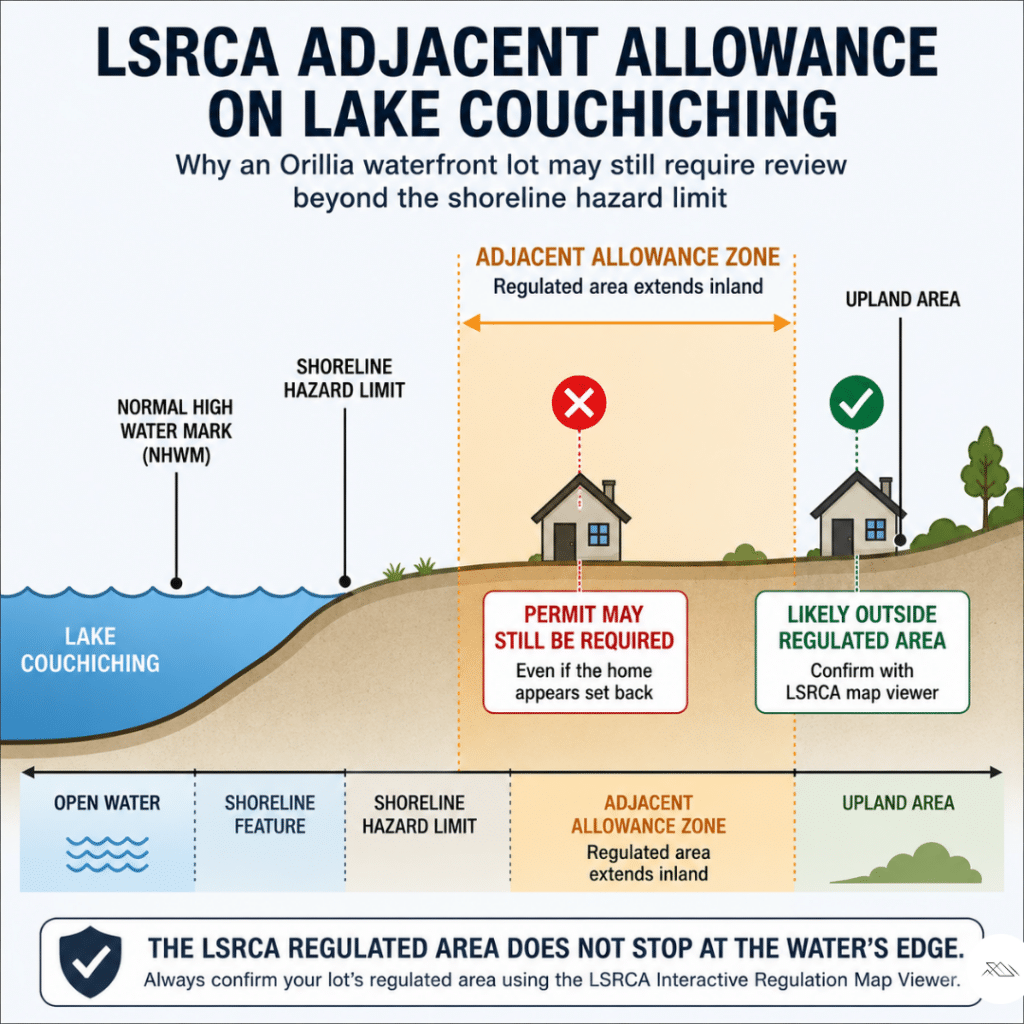

This diagram shows how an LSRCA regulated area can extend inland beyond the visible shoreline hazard limit, meaning a waterfront home may still require review even when it appears set back from the water.
On a Lake Couchiching lot with a shoreline hazard or bluffed terrain, assuming that visual setback from the shoreline means you are outside the regulated area is frequently incorrect — and can result in a stop-work order after construction has begun.
Three Steps to Screen Your Lot Before You Commit
• 1. Use the LSRCA Interactive Regulation Map Viewer — enter your property address or roll number; screenshot all regulated features on your parcel
• 2. Use the LSRCA “Do I Need a Permit?” self-screener — confirm whether your activity triggers a permit requirement and which tier applies
• 3. Contact the LSRCA directly — [email protected] or 905-895-1281 / 1-800-465-0437 toll free — before signing any purchase agreement on a waterfront lot
What Activities Require an LSRCA Permit Near Orillia?
Site grading, fill placement, crane staging, and dock construction all trigger permit requirements within regulated areas — not just building a house. The following six categories under O. Reg. 41/24 apply to Orillia waterfront lots.
| Activity Category | Examples | Notes |
|---|---|---|
| Construction of buildings or structures | New home, cottage, boathouse, dock, deck, additional dwelling units | Most new waterfront home builds = Major permit |
| Changes to use or size of existing structures | Converting seasonal cottage to year-round, increasing floor plans | Triggers review even without expanded footprint |
| Site grading | Regrading lot, levelling building pad, altering drainage | Any grading within regulated area requires permit |
| Fill placement | Foundation pad, driveway, access track, crane staging, module delivery route | Even temporary fill placement is regulated |
| Interference with watercourses | Culvert installation, bank work, Trent-Severn Waterway adjacent works | Parks Canada permit may also apply on Trent-Severn frontage |
| Interference with wetlands | Any activity affecting wetland hydrology or extent; buffer zone activities regulated | Provincially Significant Wetlands receive highest protection |
For garden suites and additional dwelling units on Orillia lots near water, an LSRCA permit may be required in addition to the Bill 23 ARU permit pathway — see our prefab garden suite Orillia guide for the complete process.
For buyers planning seasonal-to-year-round cottage conversions on Orillia-area waterfront lots, see our prefab cottages in Orillia and Simcoe County guide.
Boathouses and docks on Lake Couchiching require an LSRCA permit. If your property fronts the Trent-Severn Waterway — which extends through the Kawartha Lakes system — a Parks Canada In-Water and Shoreline Works Permit may also be required.
Routine maintenance of existing lawfully constructed structures and certain minor works may be exempt — but always confirm with the LSRCA self-screener before disturbing any ground in a regulated area.
For the City of Orillia building permit process that runs alongside the LSRCA process, see our prefab home permits Orillia guide.
How Much Does an LSRCA Permit Cost? The 2026 Fee Schedule
LSRCA permit fees are calculated on a cost-recovery basis — more complex projects demand more technical review and cost more to permit.
2026 LSRCA Permit and Application Fee Schedule
| Fee Item | Amount (CAD) | Notes |
|---|---|---|
| Pre-Consultation Meeting | $780 | Credited against permit fee if complete application submitted within 12 months |
| Intermediate Permit Application | $2,013 | Moderate-risk projects — small structures, minor grading |
| Major Permit Application | $6,018 | New residential buildings within hazard limits; technical studies required |
| Schedule B Class EA Review | $6,650 + permit fee | Environmental Assessment projects |
| Schedule C Class EA Review | $9,392 + permit fee | Complex EA projects |
| Re-Submission (after 2 submissions) | 25% of review fee | $1,504.50 per round on a Major application |
| Retroactive Permit Surcharge | Base fee + 25% | Approval not guaranteed |
| Site Visits (not tied to open application) | $973 | Site conditions assessment independent of active permit |
| Minor Technical Review | $2,142 | |
| Major Technical Review | $4,080 |
Source: LSRCA Permit and Application Fees page and 2026 Fee Schedule PDF. Confirm current fees directly with the LSRCA before budgeting.
The pre-consultation meeting ($780) is credited against the permit fee if a complete application is submitted within 12 months — not an additional cost if you proceed efficiently.
Most new waterfront home builds near Orillia qualify as Major applications ($6,018). Re-submission after the second attempt adds $1,504.50 per round — making a complete first submission a genuine financial priority.
Total Soft Cost Budget for a Waterfront Build Near Orillia
The LSRCA permit fee is one line item. The budget stack below shows how those costs can combine into CAD $35,000–$75,000+ before foundation work even begins.

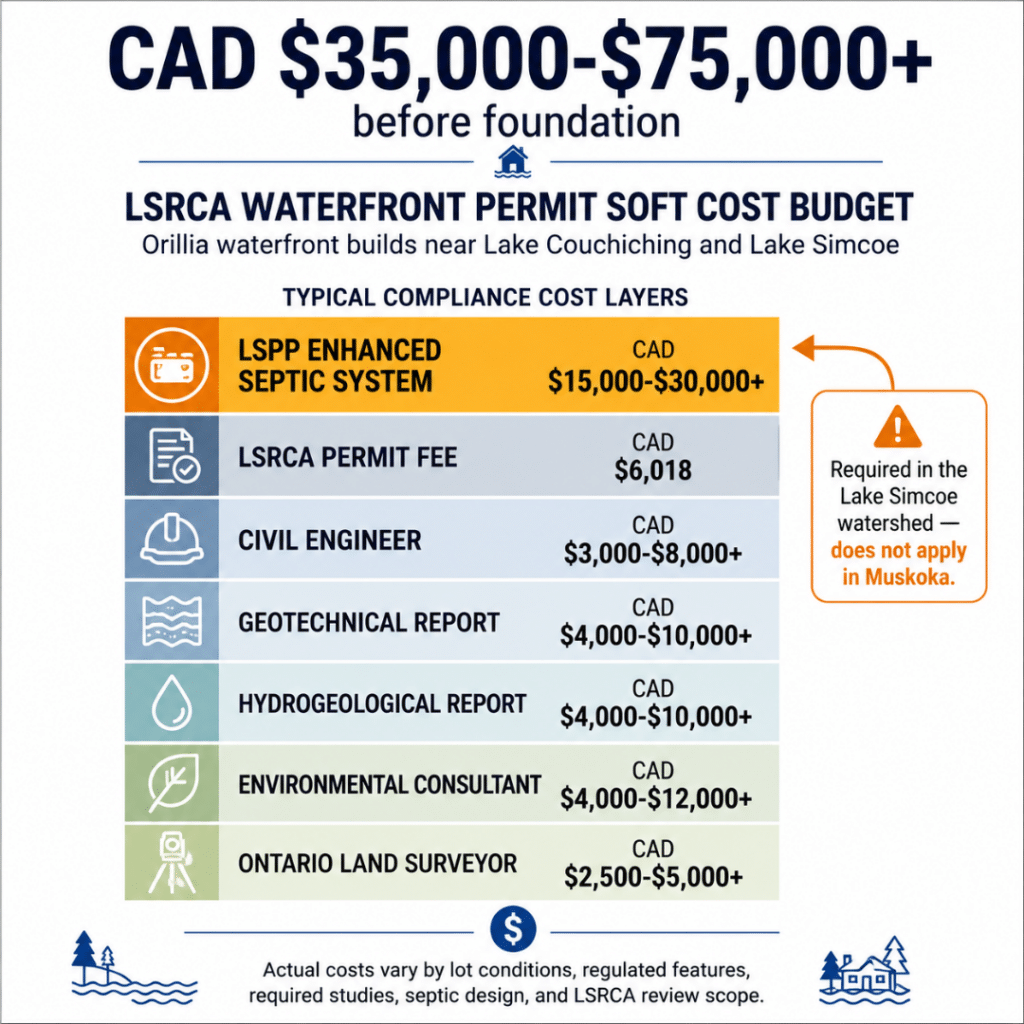

This soft cost budget stack shows how LSRCA permit fees, technical studies, professional reports, and the LSPP enhanced septic premium can combine into CAD $35,000–$75,000+ in waterfront build costs before foundation work begins.
A realistic compliance package for a new waterfront home near Orillia includes:
| Soft Cost Item | Typical Range (CAD) |
|---|---|
| Ontario Land Surveyor | $2,500–$5,000+ |
| Environmental Consultant / Natural Heritage Assessment | $4,000–$12,000+ |
| Hydrogeological Report | $4,000–$10,000+ |
| Geotechnical / Slope Stability Report | $4,000–$10,000+ |
| Civil Engineer (grading and drainage plans) | $3,000–$8,000+ |
| LSRCA Permit Fee (Major application) | $6,018 |
| LSPP Enhanced / Phosphorus-Removing Septic System | $15,000–$30,000+ above standard |
| Total soft cost estimate | CAD $35,000–$75,000+ |
Budget CAD $35,000–$75,000+ in soft costs before a single foundation is poured. Buyers who anchor on the factory price or prefab home package without accounting for the full site budget consistently encounter serious shortfalls at permit issuance.
For the complete all-in cost framework including site budget and local development charges, see our prefab home costs Orillia guide.
For the complete construction draw mortgage guide and how the factory deposit gap affects your LSRCA timeline, see our prefab home financing Ontario guide.
How Long Does an LSRCA Permit Take Near Orillia?
Under O. Reg. 41/24, the LSRCA has a 21-day statutory completeness review period.

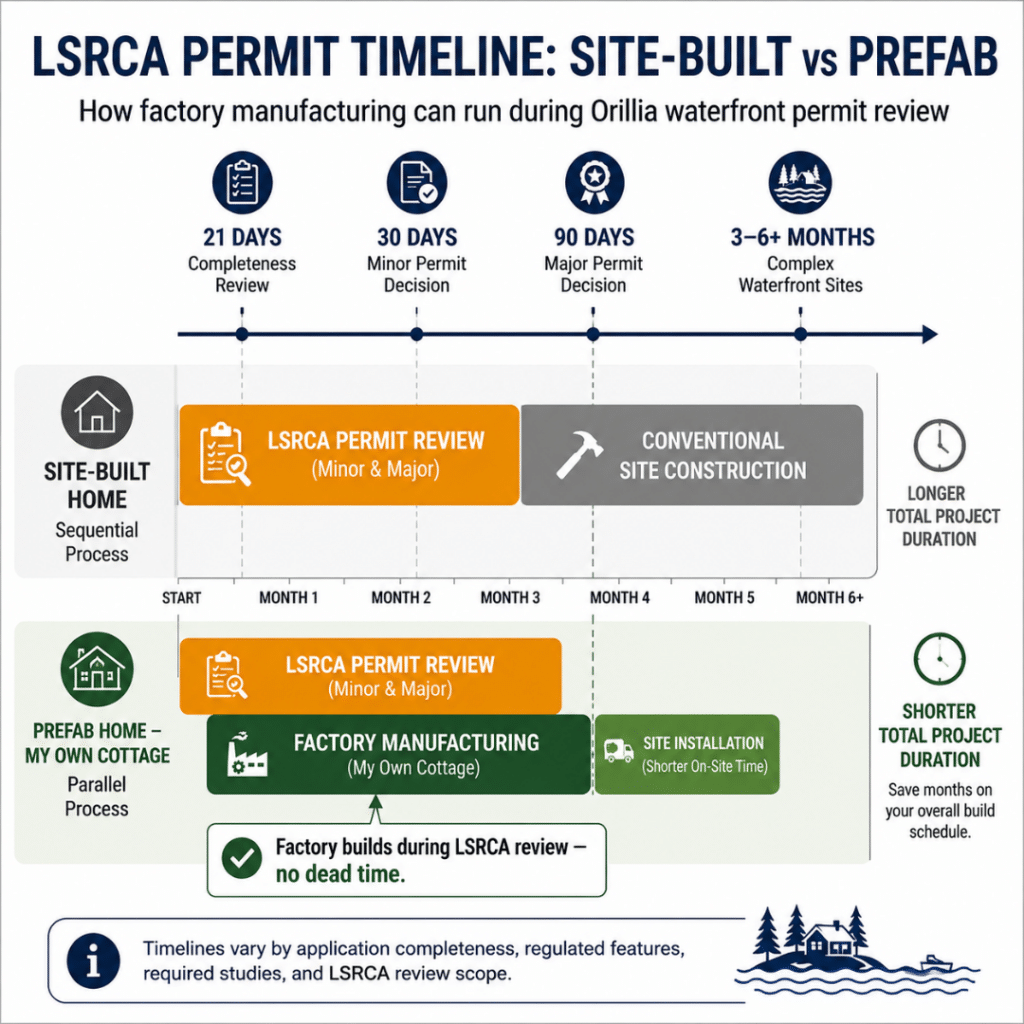

The timeline below shows how that parallel-path advantage can compress the overall project schedule for an Orillia waterfront build.
This timeline comparison shows how prefab construction can reduce dead time on Orillia waterfront projects by allowing factory manufacturing to run in parallel with LSRCA permit review.
A deficiency notice stops the clock and restarts it only when a complete resubmission is received.
Scenario-Based LSRCA Permit Timelines
| Project Type | Typical Timeline After Complete Submission |
|---|---|
| Minor works (small dock, minor grading, small accessory structure) | 4–8 weeks |
| Moderate complexity (cottage addition, accessory building near hazard limit) | 8–16 weeks |
| High complexity (new waterfront home within hazard limits, multiple technical studies) | 3–6+ months |
The most common delay causes: missing cross-sections or elevation drawings; unclear fill volume calculations; grading plans that don’t satisfy drainage requirements; and technical studies commissioned after submission rather than in advance.
One complete submission is always faster than three partial ones.
The Prefab Parallel-Path Advantage
For prefab home buyers, the LSRCA review timeline is an opportunity rather than dead time.
Factory manufacturing can begin as soon as design is finalised — before the LSRCA permit is in hand. While LSRCA staff review a Major application (potentially 3–6 months), your home is being built in the Orillia factory.
Module delivery and crane set are scheduled to coincide with permit issuance rather than follow it.
This parallel-path model compresses the overall project schedule considerably compared to a site-built home where no above-grade construction can begin until all permits are in hand.
For the complete permit sequence for a waterfront prefab build, see our prefab home permits Orillia guide.
How to Apply for an LSRCA Permit — Eight Steps
Before diving into the details, the visual below shows the full LSRCA permit application process for waterfront and regulated-area builds near Orillia.

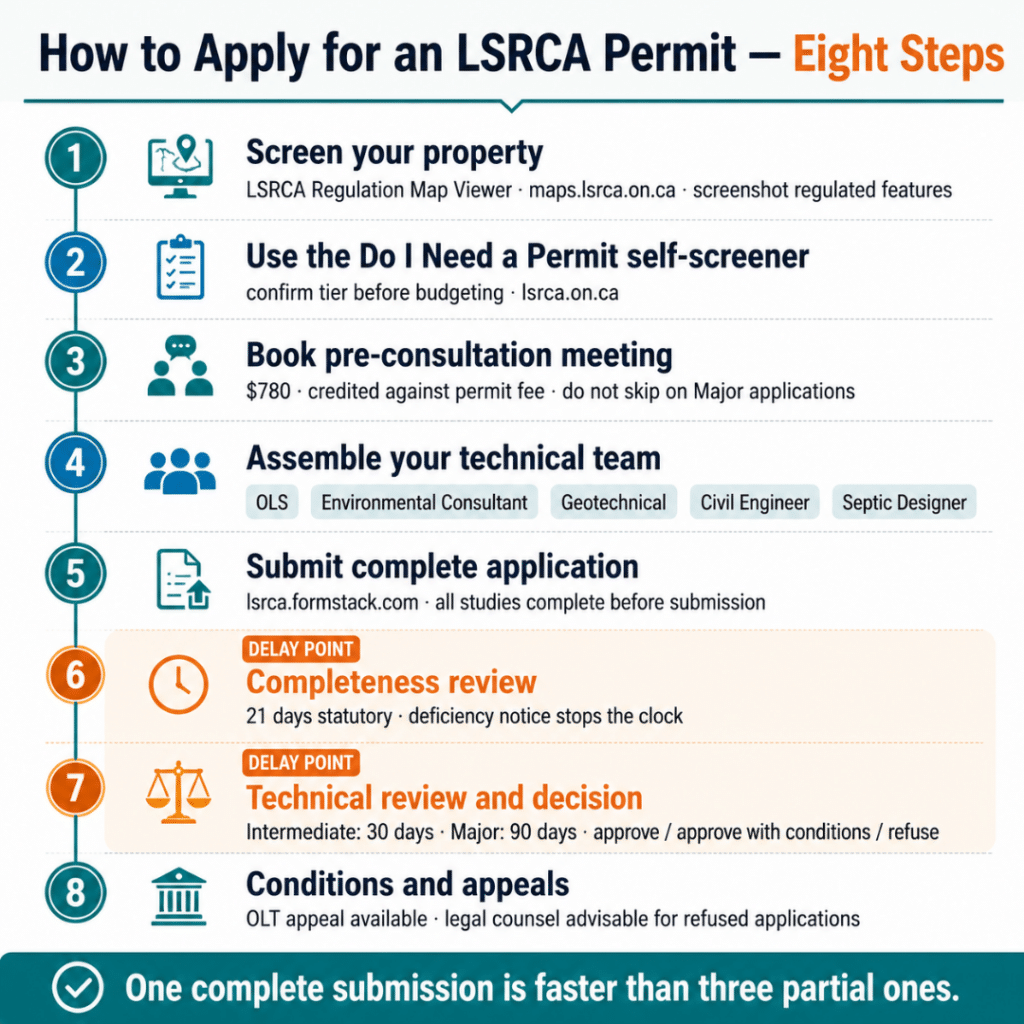

Eight-step visual guide to the LSRCA permit application process for waterfront and regulated-area builds near Orillia, from property screening through permit decision and appeal options.
Step 1 — Screen your property using the LSRCA Interactive Regulation Map Viewer. Enter your address or roll number, screenshot regulated features, and save results before proceeding.
Step 2 — Use the self-screener at lsrca.on.ca/index.php/planning-permits/do-i-need-a-permit/ to confirm whether your activity triggers a permit and which tier applies. Do not assume the tier — confirm it before budgeting.
Step 3 — Book a pre-consultation meeting ($780, credited against your permit fee) before the formal application. LSRCA staff identify likely technical study requirements and advise on completeness. Skipping this step on a Major application near the hazard limit is a false economy.
Step 4 — Assemble your technical team based on pre-consultation feedback: Ontario Land Surveyor, Environmental Consultant, Geotechnical Engineer (if applicable), Hydrogeologist (if applicable), Civil Engineer, and Certified Septic Designer for the LSPP-compliant system. Have all studies complete before submitting — not after the first deficiency notice.
Step 5 — Submit a complete application via the LSRCA Formstack portal to [email protected] with all supporting documentation: site plans, technical studies, application form, and payment. Application completeness is the single biggest factor in timeline management.
Step 6 — LSRCA completeness review (21 days). Staff confirm whether the application is complete. A deficiency notice stops the review clock — respond fully, not partially, to restart it.
Step 7 — Technical review and decision. Intermediate applications: 30-day decision after completeness. Major applications: 90-day decision. LSRCA may approve, approve with conditions, or refuse.
Step 8 — Conditions and appeals. Review all conditions carefully before proceeding. If refused or conditions are unacceptable, an appeal to the Ontario Land Tribunal is available under the Conservation Authorities Act. A permit application hearing before the LSRCA Board of Directors may be required before an OLT appeal. Legal counsel is advisable for OLT proceedings.
What Happens If You Build Without an LSRCA Permit?
Building without an LSRCA permit in a regulated area is a regulatory offence. LSRCA Compliance Officers are designated Provincial Offences Officers with authority to investigate, issue orders, and initiate prosecution.
If work was completed without a permit, a retroactive application is required: base fee plus a 25% surcharge — on a Major application, $7,522.50+.
Retroactive approval is not guaranteed. If the completed work is inconsistent with what the LSRCA would have approved, partial or full remediation may be required before any permit can issue.
Enforcement consequences include stop-work orders, remediation orders at the owner’s expense, prosecution under the Conservation Authorities Act, and property record flagging that creates complications for future permits and resale.
The lots most tempting for quick construction — low-lying parcels right at the water’s edge — are precisely those most likely to be within flood hazard or wetland buffer areas where unpermitted work carries the most severe consequences.
How Does the LSRCA Permit Process Affect a Prefab Home Build Near Orillia?
The LSRCA’s mandate under O. Reg. 41/24 is triggered by what happens on your lot — not by the construction method. A prefab home requires the same LSRCA review as a site-built home.
Site works that specifically trigger review on a prefab build include:
• Foundation excavation and grading
• Fill placement for the foundation pad and driveway, temporary access track near the shoreline
• Crane staging area
• Module delivery route near the floodplain
• Septic system installation
The LSPP Enhanced Septic Requirement
The Lake Simcoe Protection Plan requires phosphorus-reducing measures across the entire Lake Couchiching/Lake Simcoe watershed. For new or replacement septic systems, enhanced tertiary treatment systems are required — not a standard leaching bed.
These systems cost approximately $15,000–$30,000 CAD above a conventional system. Budget this as a baseline cost on any Orillia waterfront lot.
This requirement applies equally in Ramara Township, Severn Township, and across the broader watershed.
For the complete Ramara Township build guide including LSPP septic costs, the sequential LSRCA-before-building-permit requirement, and Lagoon City canal-front context, see our prefab homes Ramara Township guide.
For the complete Severn Township build guide including the three-layer waterfront approval framework and Parks Canada permit requirements, see our prefab homes Severn Township guide.
The Parallel-Path Scheduling Advantage
The LSRCA review timeline is not dead time for a prefab buyer. My Own Cottage’s Orillia factory begins manufacturing as soon as design is finalised and engineering is complete — your home is being built while the LSRCA reviews your application.
A completed My Own Cottage prefab home in a natural rural Ontario setting, showing the type of permanent, year-round build that can be planned around Orillia-area waterfront permits, site conditions, and LSRCA review.
Module delivery and crane set are scheduled to coincide with permit issuance, not follow it. The factory price is being converted into a finished structure rather than sitting idle while the clock runs.
My Own Cottage co-ordinates LSRCA pre-consultation, permit sequencing, and site preparation scheduling as part of the standard project management service for Orillia waterfront builds.
Verify our HCRA Licence #64773 at the Ontario Builder Directory — see our About Us page for full credential details.
Planning a prefab home on a waterfront lot near Orillia? Our team has navigated the LSRCA permit process across Lake Couchiching and the broader Simcoe County watershed and can guide you from lot screening through to occupancy.
• Request a Free Consultation
• Call Us Directly: (705) 345-9337
• View Our Design Catalogue
Alternatively, for your convenience, you can also simply fill out the contact form below and we’ll get back to you soon!
Frequently Asked Questions — LSRCA Waterfront Permits Orillia
Do I need an LSRCA permit to build near Lake Couchiching in Orillia?
Yes — in most cases. Any construction, site grading, fill placement, or shoreline work within an LSRCA regulated area requires a permit under Ontario Regulation 41/24.
For a new waterfront home near Lake Couchiching, both an LSRCA permit and a City of Orillia building permit are required — separate approvals with separate fees and timelines.
Screen your parcel at the LSRCA Interactive Regulation Map Viewer and use the Do I Need a Permit self-screener before committing to any design work or purchase agreement.
How much does an LSRCA permit cost in 2026?
Pre-consultation $780 (credited against the permit fee within 12 months); Intermediate permit $2,013; Major permit $6,018; Retroactive: base fee plus 25% surcharge.
Most new waterfront home builds near Orillia qualify as Major applications. Beyond the permit fee, total soft costs — land surveying, environmental assessment, geotechnical study, and LSPP-compliant septic — range from CAD $35,000–$75,000+.
How long does an LSRCA permit take for a waterfront build near Orillia?
Minor works: 4–8 weeks. Moderate complexity: 8–16 weeks. New waterfront home with multiple technical studies: 3–6+ months.
The 21-day completeness review clock stops on a deficiency notice and restarts only on a complete resubmission. An incomplete first submission is the single biggest cause of delay.
What is the difference between an LSRCA permit and a City of Orillia building permit?
Entirely separate approvals from separate organisations. The City of Orillia Building Division issues building permits under the Ontario Building Code for structural safety and occupancy.
The LSRCA issues development permits under O. Reg. 41/24 to protect people and natural features from natural hazards and preserve water quality in the Lake Simcoe watershed.
Both are required for most Orillia waterfront builds and run as parallel processes.
Does a prefab home require an LSRCA permit?
Yes. The LSRCA’s mandate is triggered by what happens on your lot — not by construction method.
Foundation excavation, fill placement, site grading, crane staging, module delivery, and septic installation all constitute regulated activities within a regulated area.
What prefab offers is a scheduling advantage: factory manufacturing proceeds in parallel with LSRCA review, compressing the overall project timeline.
What is the Lake Simcoe Protection Plan and how does it affect my build?
The LSPP is a legally binding provincial document under the Lake Simcoe Protection Act, 2008 applying to all development within the Lake Simcoe watershed — including all of Orillia.
Its phosphorus post-to-pre rule typically requires enhanced tertiary-treatment or phosphorus-removing septic systems at CAD $15,000–$30,000+ above a standard system.
It also establishes a 30-metre vegetated buffer on Lake Simcoe shorelines. The City of Orillia adds its own 15-metre buffer near Lake Couchiching.
What happens if I build without an LSRCA permit in Orillia?
A regulatory offence under the Conservation Authorities Act. LSRCA Compliance Officers can issue stop-work orders, require site remediation at the owner’s expense, and refer matters for prosecution.
A retroactive application is required and carries a 25% surcharge — but approval is not guaranteed. If the completed work is inconsistent with what the LSRCA would have approved, full site restoration may be required before any permit can issue.
Does the LSRCA Have Jurisdiction Over Waterfront Properties in Orillia?
Yes — the Lake Simcoe Region Conservation Authority has direct jurisdiction over waterfront properties in the City of Orillia.
The City of Orillia is an explicit member municipality of the LSRCA, and virtually every waterfront parcel in Orillia — on Lake Couchiching or Lake Simcoe — falls within the LSRCA’s regulated area under Ontario Regulation 41/24.
An LSRCA permit is required for construction, site grading, fill placement, and shoreline work within regulated areas on Orillia waterfront lots, in addition to a City of Orillia building permit from the City of Orillia Building Department.
The Severn Sound Environmental Association (SSEA) governs a separate watershed to the northwest and does not administer permits within the City of Orillia.
Property owners on the border of Ramara Township or Severn Township should confirm jurisdiction directly with the LSRCA at [email protected] or 905-895-1281, as their specific parcel may fall within the LSRCA regulated area regardless of municipal boundary proximity.
Never rely on a third-party summary to determine whether your waterfront lot requires LSRCA approval — confirm directly using the LSRCA Interactive Regulation Map Viewer before purchasing any Orillia-area waterfront property or beginning any site work.
Verified External Resources
The complete Orillia prefab market overview — build costs, urban lot planning, permit timelines, and the Muskoka comparison — is in our prefab homes Orillia guide.
Our guide to small prefab homes and ADU options in Orillia covers compact builds, accessory structures, and the LSRCA permit pathway for garden suites on waterfront lots near Lake Couchiching.
Verified 2026 permit fees, development charge amounts, LSRCA timelines, and the step-by-step sequence for a prefab home build are documented in our prefab home permits Orillia guide.
The complete all-in cost framework — including the LSRCA soft cost stack, LSPP septic premium, and development charges by lot type — is in our prefab home costs Orillia guide.
Ramara Township’s sequential LSRCA-before-building-permit requirement, the LSPP tertiary septic premium, and Lagoon City canal-front context are covered in our prefab homes Ramara Township guide.
The three-layer waterfront approval framework — Township permit, LSRCA, and Parks Canada for Trent-Severn frontage — is documented in our prefab homes Severn Township guide.
