Prefab Homes Orillia 2026: What You'll Actually Pay — Permits, Waterfront Rules, and Why Orillia Is Muskoka's Most Overlooked Alternative
Last updated: May 17th, 2026
Written by building specialists at My Own Cottage
Prefab homes in Orillia from CAD $180,000 — verified all-in costs by lot type below.
Or call us directly: (705) 345-9337.
If you’re researching prefab homes in Orillia, you’ve likely already noticed the problem: most of what’s online treats this as a cottage query — unlike more comprehensive resources on prefab homes in Ontario.
Design galleries, kit packages, and lifestyle photography — but nothing that tells you what a build actually costs on your specific lot type, what permits you’ll actually need, or why Orillia’s regulatory framework is categorically different from Muskoka’s.
This guide fixes that. It’s written for the buyer who is serious — whether you’re building a primary residence on a serviced city lot, a four-season home on a Lake Couchiching waterfront parcel, or adding a prefab garden suite to an existing Orillia property.
By the time you finish reading, you’ll know your realistic all-in cost range, your permit sequence, and exactly where My Own Cottage fits into the process.
Explore real prefab home designs — and understand what they’ll actually cost on your Orillia lot.
Why Orillia Is the Smartest Prefab Market in Central Ontario Right Now
The prevailing assumption — that “prefab homes Orillia” is a cottage query — misreads the market.
Orillia is a separated municipality within Simcoe County with a population of 33,411 (2021 Census), growing at 7.2% since 2016. It has municipal water, sewer, natural gas distribution, and transit infrastructure.
The majority of prefab buyers here are building primary residences, not seasonal retreats.
That distinction changes every decision in the build: the OBC classification, the permit pathway, the site budget, and the financing options available to you.
Gateway to Muskoka — Without the Muskoka Price Tag
Orillia Ontario sits at the pivot point between Simcoe County’s year-round housing market and the seasonal cottage living corridor that extends north through Parry Sound and into Northern Ontario — giving buyers access to both markets from a single, municipally-serviced location.
It lies approximately 1.5 hours north of Toronto via Highway 400 and Highway 11, and 45 minutes south of Bracebridge. By every measure, it is the gateway to cottage country — but it operates at a fundamentally different price point.
Lake Couchiching waterfront properties are actively listed in the CAD $640,000–$749,000 range.
Lake Couchiching offers calm, swimmable waterfront and natural shoreline just minutes from downtown Orillia — with entry pricing far below Muskoka lakes.
In contrast, entry-level waterfront on the Muskoka Big Three lakes (Muskoka, Rosseau, Joseph) starts above CAD $2M.
The Trent-Severn Waterway runs directly through Orillia at the Port of Orillia, giving waterfront buyers connected boating access to an inland network stretching from Lake Simcoe to the St. Lawrence system — at a fraction of the Muskoka premium.
For buyers whose budget or priorities extend into Muskoka, see our prefab homes Muskoka complete buyer’s guide.
The Case for Building New Here Instead of Buying Used
Orillia’s average home price was approximately CAD $731,000 in late 2024, easing to roughly CAD $625,000 by mid-2025, while sales volume rose approximately 25% year-over-year. That combination signals genuine demand, not speculative froth.
A new prefab home on a serviced Orillia lot — all-in, including foundation, permits, development charges, and HST — comes in at approximately CAD $290,000 to $400,000.
That figure competes directly with resale inventory carrying deferred maintenance, no warranty, and energy performance from a previous generation of building standards.
The new build wins on total cost of ownership. The question is which lot type you’re working with — and that’s where most buyers go wrong.
Modular vs. Kit vs. Manufactured — The Distinction That Determines Your Mortgage
“Prefab” is an umbrella term covering four meaningfully different construction methods. Which one you choose determines your building permit pathway, your mortgage eligibility, and your warranty coverage.
Getting this wrong costs money.
| Prefab Type | Compliance & Foundation |
|---|---|
| Modular | CSA A277 / OBC — Permanent foundation |
| Panelised | OBC site-built process — Permanent foundation |
| Kit / Package | OBC site-built process — Permanent foundation |
| Manufactured | CSA Z240 — Non-permanent chassis |
Not sure which prefab type your lot actually supports? We verify it before you commit.
Modular homes are built as three-dimensional volumetric modules in a controlled factory environment — insulation, wiring, plumbing rough-ins, and interior finishes completed before the unit leaves the building. Modules are transported by flatbed and crane-set onto a permanent foundation. Once set, a modular home is legally and structurally identical to a site-built home.
Kit or package homes supply a pre-engineered package of building materials — structural lumber, windows, doors, and hardware — but nothing else. The buyer sources all trades and manages construction on-site. The material package price looks lower upfront; once you add trade labour, project management, and carrying costs, the all-in figure routinely matches a turnkey modular contract — without the CSA A277 certification a factory-modular build delivers as standard.
Manufactured homes (built to CSA Z240 on a non-permanent chassis) are not relevant to freehold residential or waterfront development in Orillia and are included here only to prevent buyer confusion.
Throughout this guide, “prefab” refers to factory-built modular construction unless otherwise specified.
CSA A277 — The Certification That Unlocks Your Permit and Your Mortgage
CSA A277 (Procedures for Factory Certification of Buildings) is the standard that demonstrates a factory-built module meets Ontario Building Code requirements — verified by a third-party inspector during manufacturing, not after delivery.
My Own Cottage holds CSA A277 certification for specified models. QAI Laboratories is one accredited certification body that performs these inspections.

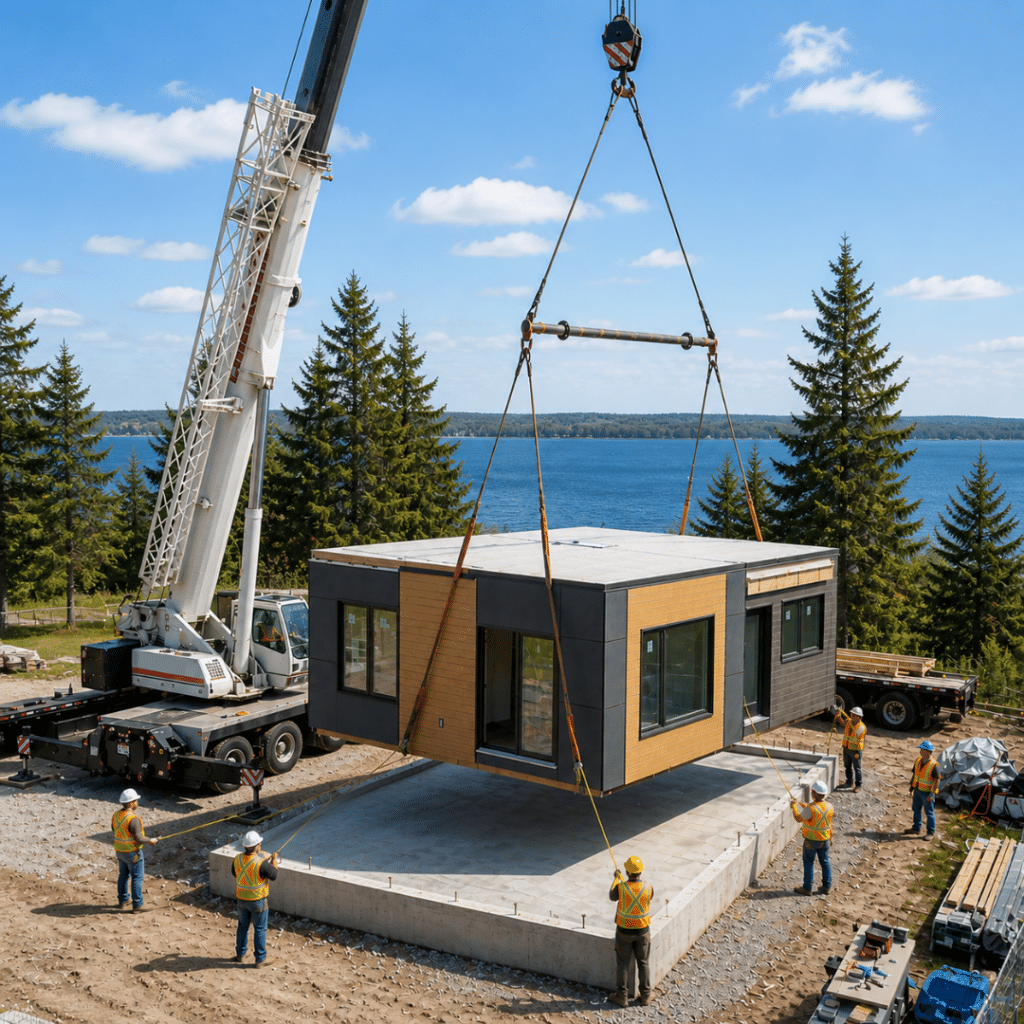

A CSA A277 certified modular home being crane-set onto its permanent foundation in Orillia — the same factory-built process that simplifies permits, improves build quality, and accelerates timelines.
The City of Orillia Building Division requires the CSA A277 documentation package as part of any modular home permit application.
Without it, a factory-built module cannot receive a building permit on an Orillia lot. Full stop.
Beyond permits, CSA A277 certification unlocks CMHC mortgage insurance and Tarion new home warranty enrollment — the two financial protections that make a prefab home financeable and warrantied on the same terms as a traditional home.
Why the Modular Advantage Is More Pronounced in Orillia Than in Muskoka
In Muskoka, a modular home’s site budget is dominated by well drilling (CAD $10,000–$20,000+) and engineered septic systems (CAD $20,000–$60,000+) because most lots are not municipally serviced.
In Orillia’s urban core, those costs disappear entirely. Municipal hookups replace them at a fraction of the price.
Delivery logistics are equally straightforward. Highway 11 and Highway 400 are the primary module delivery routes from GTA manufacturing facilities — direct corridors with no forced secondary road routing, no barge logistics, no marine premium.
Module widths up to 4.3 metres require MTO oversize/overweight permits through the HiQ system, but this is standard practice on Ontario highways. Crane rental and site installation in Orillia’s built environment uses conventional equipment without the complexity of remote waterfront access.
What a Prefab Home in Orillia Actually Costs — The Two-Budget Framework
Every prefab buyer in Orillia is managing two budgets simultaneously.

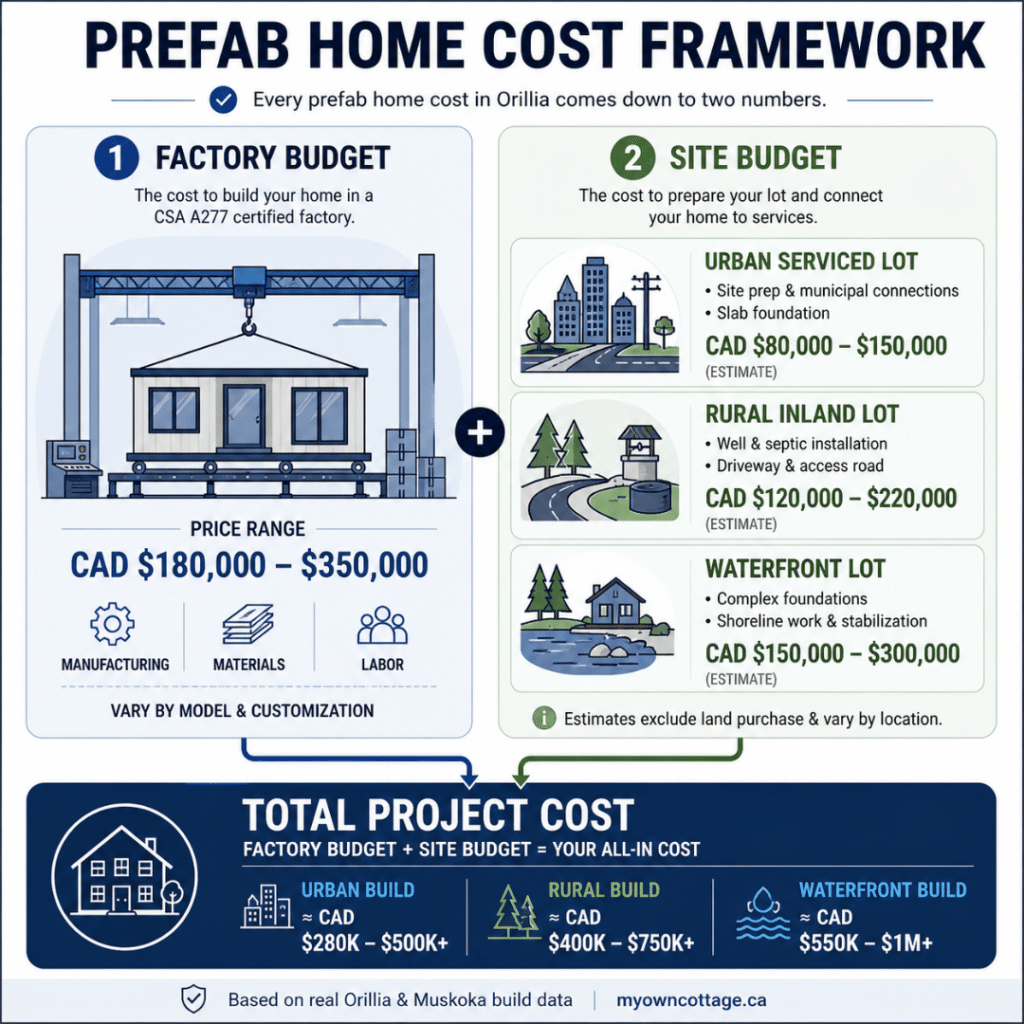

Understanding prefab home costs in Orillia starts with two numbers: factory price and site-specific costs. This diagram breaks down real-world budgets for urban, rural, and waterfront builds.
The first is the factory budget — what the manufacturer charges for design, production, and delivery.
The second is the site budget — everything required to receive the home: foundation, utility connections, permit fees, development charges, and site finishing.
The factory budget is relatively predictable. The site budget varies by a factor of three depending on your lot type.
Understanding that distinction before you start is the difference between a realistic project and a costly surprise.
Factory Price — The Verified Floor
My Own Cottage factory pricing starts at approximately CAD $180,000 finished for a compact modular home, in the CAD $150–$220 per square foot range for primary residences and CAD $150–$300 per square foot for cottage builds.
A 1,200 sq ft year-round modular home — the scale of our Lake View model — falls in the CAD $180,000–$294,000 supply-and-set range before site costs.
For a sense of the mid-range product tier, consider our 1,550 sq ft Hudson (three bedrooms, two bathrooms) or the 1,418 sq ft Solaris with its large windows and open living room layout.
Both are engineered for four-season Central Ontario conditions, while delivering meaningfully better energy efficiency and lower material waste through factory-controlled production.
My Own Cottage offers a catalogue of existing designs ranging from 505 sq ft compact models suited to ADU and tiny home applications through to multi-bedroom homes exceeding 2,500 sq ft.
For the complete guide to small prefab homes, bunkies, and ADU options in Orillia — including all-in pricing tiers and permit pathways — see our small prefab homes in Orillia guide.
Buyers who want a starting point without committing to a full custom design process can select from these home packages and modify finishes, layout configurations, and square footage parameters from there.
For buyers with specific site requirements or aesthetic goals, full custom design is available from the initial consultation.
These are factory prices. They do not include your lot, foundation, utility connections, permits, or development charges. That’s where the second budget comes in.
Site Budget by Lot Type — The Variable That Changes Everything
| Lot Type | Site Budget Range | Key Variables |
|---|---|---|
| Urban serviced (City of Orillia) | CAD $50,000–$90,000 | Municipal hookups; foundation; no septic or well |
| Rural inland (Severn / Ramara / Oro-Medonte) | CAD $80,000–$150,000 | Drilled well; engineered septic; hydro; gravel road access |
| Lake Couchiching waterfront | CAD $100,000–$180,000 | LSRCA permit; OLS for HWM; shoreline foundation; engineered septic |
The single most underappreciated cost variable in the Orillia prefab market is the urban lot’s elimination of well and septic costs.
A drilled well runs CAD $10,000–$20,000+. An engineered septic system runs CAD $20,000–$60,000+.
These are mandatory on every rural Simcoe County lot. On a serviced Orillia urban lot, they don’t exist.
That single distinction reduces your site budget by CAD $35,000–$80,000 compared to a rural build — before you’ve made a single other decision.
For buyers comparing Orillia against Muskoka lot types, see our Muskoka prefab home prices guide for the complete five-layer cost framework.
Development Charges — By-law 2024-113 and What It Adds to Your Budget
New residential construction in the City of Orillia is subject to development charges under By-law No. 2024-113, effective January 1, 2025, with updated rates from July 1, 2025 available at orillia.ca.
Development charges are payable at permit issuance — not at construction completion — and represent a meaningful line item that many buyers encounter for the first time when they pick up their permit.
Specific charge amounts must be confirmed directly with the City’s Treasury or Development Services department. Confirm before budgeting, not after.
One important exception: development charges are exempt for qualifying garden suites under Bill 23 provisions. If you are adding a prefab ADU to an existing Orillia lot, this exemption significantly improves the project economics.
All-In Cost Scenarios — Three Lot Types, Fully Calculated
| Scenario | Factory Price | All-In Estimate |
|---|---|---|
| Urban serviced, 1,200 sq ft, Orillia proper | CAD $180,000–$220,000 | CAD $290,000–$370,000+ |
| Rural inland, 1,500 sq ft, Severn / Ramara | CAD $220,000–$280,000 | CAD $370,000–$480,000+ |
| Lake Couchiching waterfront, 1,500 sq ft | CAD $220,000–$350,000 | CAD $450,000–$600,000+ |
HST at 13% applies to all new construction. Development charges are additional — confirm with the City. My Own Cottage provides verified all-in estimates specific to your lot type before any commitment is made.
For the complete line-item breakdown — including verified development charges, permit fees, foundation costs, utility connections, and HST calculations by lot type — see our prefab home costs Orillia guide.
Want a precise all-in cost for your specific Orillia lot? We calculate it before you commit.
City of Orillia Building Permits — Exactly What You Need and When
The Complete Application Package
The City of Orillia Building Division issues all building permits for new construction within city limits. Contact: 50 Andrew Street South, Suite 300, 705-329-7258.
A complete permit application for a new prefab home in Orillia requires all of the following, submitted simultaneously:
• Completed building permit application form
• Site plan showing lot dimensions, proposed building location, all setbacks, and distances from water bodies
• Architectural drawings (floor plans, elevations, cross-sections) — for modular homes, the factory’s certified drawings satisfy much of this requirement
• Structural drawings including engineered truss and floor system documentation — the CSA A277 factory certification package is central to this submission

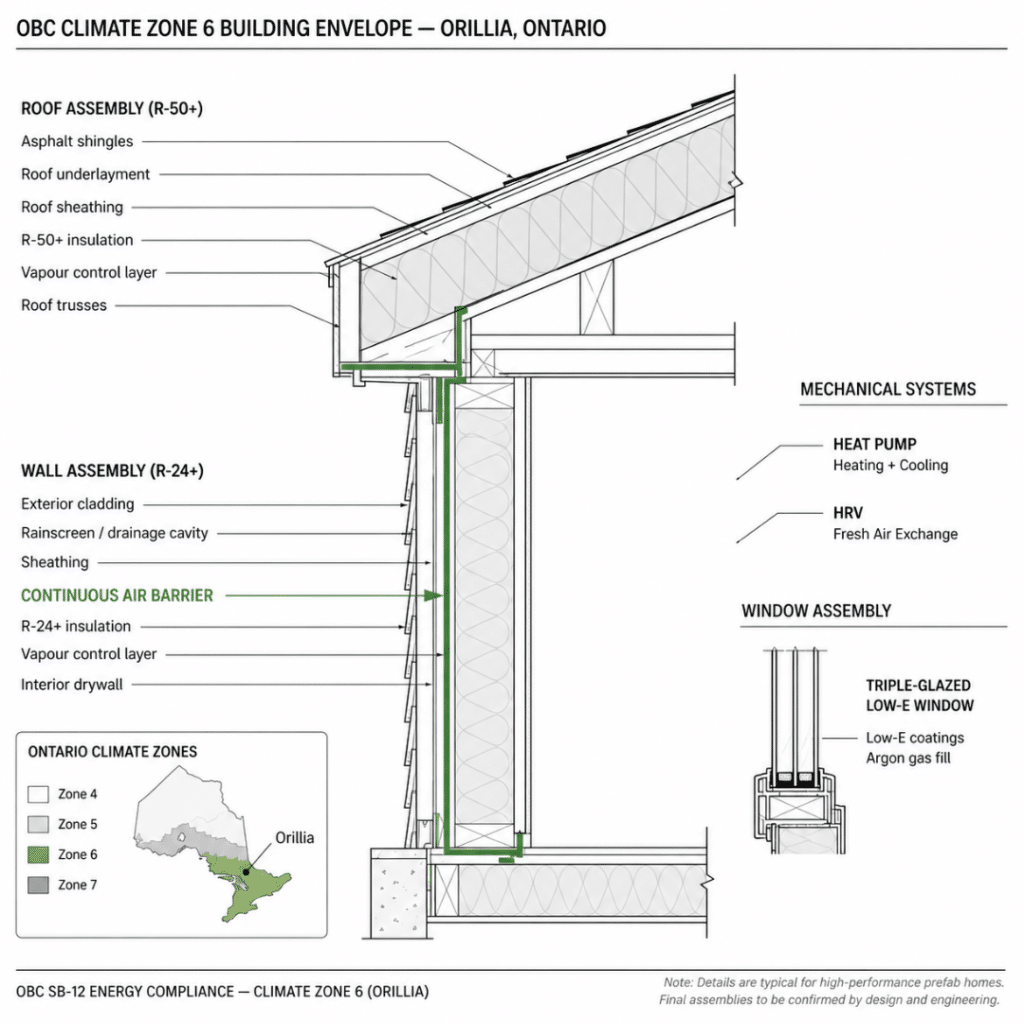

• Energy compliance documentation under OBC Division B Section 12 — R-2000 or ENERGY STAR certification packages satisfy this if applicable
• Grading and drainage plan where required by the Engineering Division
• LSRCA permit confirmation for any shoreline lot
The CSA A277 package is the most commonly missing component in first-time submissions. Its absence triggers a deficiency notice and resets the statutory review clock — meaning your timeline extends not by days but by weeks.
Verified Permit Fees — 2024 and 2025 Figures
| Fee Category | 2024 Rate | 2025 Rate |
|---|---|---|
| New multi-residential (per sq ft) | CAD $1.93 | Confirm with City |
| Accessory dwelling units / ADUs (per sq ft) | CAD $1.63 | Confirm with City |
| Accessory buildings (flat fee) | CAD $186.55 | CAD $192.71 |
| Decks (flat fee) | CAD $197.21 | CAD $203.72 |
| Finished basements | — | CAD $275.29 |
| Re-inspections | — | CAD $159.90 |
| Permit amendments | — | CAD $213.20 |
Source: City of Orillia official 2024 and 2025 Building Permit Fee Schedule documents at orillia.ca. Confirm current per-sq-ft residential rates directly with the Building Division at 705-329-7258 before finalizing your budget.
For a new prefab home of 1,500 sq ft assessed at the 2024 rate of CAD $1.93 per sq ft, the permit fee component alone is approximately CAD $2,895 before flat fees. It belongs in your numbers from day one.
Timeline from Application to Occupancy — Realistic Numbers
The Ontario Building Code Act (Section 7) establishes a statutory 10-business-day review period. The clock starts only when the municipality deems your submission complete — which is why a complete first submission matters so much.
For a standard urban residential lot in Orillia, expect 4–6 weeks from submission to permit issuance. Shoreline lots, floodplain overlays, or heritage adjacency can extend this and may require site plan approval as a precondition.
Factory manufacturing runs 10–16 weeks once engineering is finalized.
Because My Own Cottage uses a parallel build model — manufacturing begins concurrently with the permit review period — the factory timeline and the permit timeline overlap rather than stack.

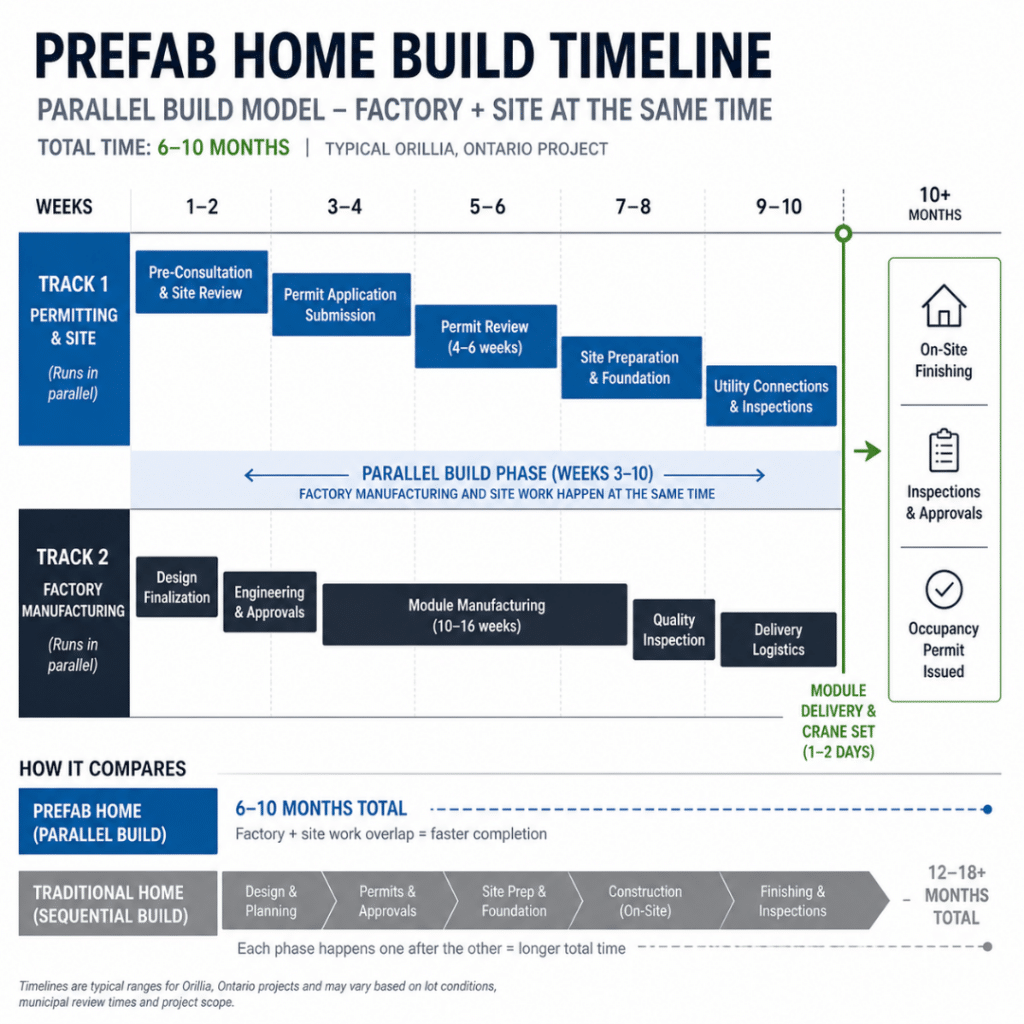

Total contract to occupancy for a standard Orillia urban lot: approximately 6–10 months.
For the complete step-by-step permit sequence — including verified 2025 fee rates, development charge amounts, LSRCA timelines, and the six most common permit mistakes — see our prefab home permits Orillia guide.
Prefab homes in Orillia are built using a parallel construction model — factory manufacturing and site work happen at the same time, reducing total project timelines to approximately 6–10 months compared to 12–18+ months for traditional construction.
This is meaningfully shorter than comparable Muskoka waterfront builds, where LSRCA processing adds 4–16 weeks that inland Orillia urban lots do not require.
Pre-Consultation — The Step Most Buyers Skip
The City of Orillia Development Services Division offers pre-consultation meetings for new construction projects.
For a shoreline lot, any parcel with floodplain adjacency, or a build with ADU complexity, a pre-consultation meeting before finalizing your design package prevents the costly revisions that happen when a design is commissioned without confirming setbacks and zoning conditions first.
City Planning Division pre-consultation line: 705-325-2622. For shoreline lots, pre-consultation is required — not optional — before any permit application is submitted.
LSRCA Permits for Lake Couchiching — The Waterfront Process, Step by Step
If your lot is adjacent to Lake Couchiching, you are operating under a dual-permit requirement that most buyers — and most prefab pages — do not address. Understanding it before you start saves months.
What O. Reg. 41/24 Means for Your Lake Couchiching Build
The Lake Simcoe Region Conservation Authority (LSRCA) administers permit requirements for the Lake Simcoe watershed, which includes Lake Couchiching.
An LSRCA permit is required under Ontario Regulation 41/24 — effective April 1, 2024, replacing the previous O. Reg. 179/06 — for any development within a regulated area adjacent to Lake Couchiching.
“Development” under O. Reg. 41/24 is broadly defined. It includes construction, site grading, fill placement or removal, and channel alterations — not just the placement of a building.
The LSRCA permit is a separate approval from the City of Orillia building permit. Both must be initiated simultaneously, not sequentially. Apply at lsrca.on.ca.
For the complete 2026 guide to LSRCA fees, permit timelines, the eight-step application process, and what the Lake Simcoe Protection Plan means for your septic budget, see our LSRCA waterfront permits Orillia guide.
The 15-Metre Buffer and Why the High Water Mark Is Not the Shoreline
The City of Orillia Shoreline Development Guidelines require a 15-metre buffer setback from the Lake Couchiching high water mark.
The diagram below shows exactly how this works in practice — and why confirming the HWM early is one of the most important steps in planning a prefab home on a waterfront property.
This diagram shows how the 15-metre shoreline buffer is measured from the formal high water mark (HWM) — not the visible waterline — which directly determines your buildable area on an Orillia waterfront lot.
This is measured from the formally established HWM — not the visible waterline, not the dock, not the approximate water’s edge. The visible shoreline and the legally established HWM are not the same point, and designing to the wrong one is an expensive mistake.
The 30-metre setback applies from Lake Simcoe itself. A minimum of 30% of your lot area must be naturalized within the shoreline buffer.
The Flood Hazard overlay zone under Zoning By-law Section 15.4 applies to flood-prone parcels. Confirm lot-specific setbacks with the City Planning Division at 705-325-2622 before commissioning any design work.
The Lake Simcoe Protection Plan — The Additional Layer Nobody Warns You About
Beyond the LSRCA permit requirement, the Lake Simcoe Protection Act and Lake Simcoe Protection Plan (2009) apply an additional layer of provincial environmental protection to the Lake Simcoe watershed, including Lake Couchiching.
This layer is more restrictive than the Conservation Authority framework that governs Muskoka waterfront builds — and it is the most commonly overlooked cost and timeline variable in Orillia waterfront projects.
Development proposals near Lake Couchiching must demonstrate conformity with the Protection Plan as well as LSRCA O. Reg. 41/24.
These are not redundant requirements — they operate in parallel. Budget for both the additional review time and the possibility of additional site design requirements before finalizing any waterfront project scope.
The Correct Permit Sequence — 10 Steps in Order
• 1. Pre-consultation with City Planning Division (705-325-2622) to confirm setbacks, floodplain status, and site plan requirements
• 2. LSRCA pre-application consultation at lsrca.on.ca to confirm regulated area status and application requirements
• 3. Ontario Land Surveyor engagement to formally establish the high water mark — budget CAD $2,500–$5,000
• 4. LSRCA permit application submitted simultaneously with City building permit application
• 5. City of Orillia building permit application submitted with complete package including CSA A277 documentation
• 6. LSRCA review — typically 4–12 weeks
• 7. City building permit issuance after LSRCA approval confirmed
• 8. Foundation installation and factory manufacturing commence concurrently
• 9. Module delivery and crane set
• 10. On-site inspections and occupancy permit
Do not submit the City permit application before engaging the LSRCA. Do not commission a design before completing step one.
The sequence matters, and reversing any of these steps adds cost and time that is difficult to recover from mid-project.
Adjacent Municipalities — Severn, Ramara, and Oro-Medonte
Buyers who cannot find suitable land within Orillia city limits frequently look north to Severn Township, east to Ramara, or southwest to Oro-Medonte.
Each municipality operates under its own regulatory framework with separate permit fees, septic requirements, and building processes.
Three-Municipality Permit Fee Comparison
City of Orillia vs. Severn Township
| Fee | City of Orillia | Severn Township |
|---|---|---|
| Base fee | — | CAD $173 |
| Per sq ft (residential) | CAD $1.93 (2024) | CAD $1.38 |
| Septic — Class 4 | N/A (municipal sewer) | CAD $694 |
| Septic — Class 2 | N/A | CAD $381 |
| Septic — Class 5 | N/A | CAD $532 |
City of Orillia vs. Ramara Township
| Fee | City of Orillia | Ramara Township |
|---|---|---|
| Base fee | — | Confirm at ramara.ca |
| Per sq ft (residential) | CAD $1.93 (2024) | Confirm at ramara.ca |
| Septic fees | N/A (municipal sewer) | Confirm directly at ramara.ca |
Severn Township (north and west of Orillia): Contact [email protected] or 705-325-2315 x246. Prefab homes in Severn Township and modular homes are permitted if OBC compliant. Rural lots at lower price points than urban Orillia. LSRCA jurisdiction applies to lots near Lake Couchiching and associated waterways. The 2025 Building Permit Guide is available at severn.ca.
Ramara Township (east and south of Orillia): Prefab and modular homes permitted if OBC compliant. Rural and shoreline lots with access to Lake Simcoe and associated waterways. LSRCA jurisdiction applies.
Confirm current setbacks and fees directly at ramara.ca before any design work is commissioned. For the complete Ramara Township permit process, LSPP framework, and all-in cost stack, see our prefab homes Ramara Township guide.
Oro-Medonte Township (southwest of Orillia): Connects to the Horseshoe Valley recreational market and the broader Georgian Bay and Barrie commuter corridor. Rural residential lots at Simcoe County price points. LSRCA jurisdiction applies near water bodies.
For buyers evaluating Central Muskoka as an alternative, see our guides to prefab homes in Bracebridge, prefab homes in Huntsville, and best places to build near Orillia guide.
OBC Energy Compliance — What Orillia’s Climate Actually Requires
Most Orillia prefab buyers are building primary residences, which means four-season OBC classification is the baseline — not an upgrade. This has real implications for building envelope and mechanical specifications that a seasonal cottage build does not share.
Minimal building envelope diagram showing R-24 wall insulation, R-50 roof insulation, and continuous air barrier required for OBC Climate Zone 6 compliance in Orillia.
Orillia sits in Climate Zone 6 under the Ontario Building Code, which sets minimum effective R-values for above-grade walls in year-round residential occupancy.
My Own Cottage targets R-24+ walls and R-50+ roofs — specifications that satisfy OBC building codes for four-season primary residences in this climate zone and meaningfully outperform older site-built homes on energy efficiency.
For mechanical systems, heat pumps have become the standard specification for new modular builds in Central Ontario.
They handle both heating and cooling efficiently across Orillia’s temperature range, and they integrate cleanly with the continuous air barrier and HRV systems that factory construction makes easier to install correctly than conventional site-built framing does.
The result is a low maintenance home with operating costs that typically run well below comparable traditional homes of the same square footage.
Snow load is a structural variable that factory engineering addresses at the design stage.
Every My Own Cottage build is engineered to meet or exceed the OBC ground snow load requirements for the Orillia region — a calculation that feeds directly into roof truss design, bearing wall specifications, and foundation type selection.
The appropriate foundation type for your build depends on soil conditions, frost depth, and whether you are building on a level urban lot, a sloped rural parcel, or a shoreline property with a fluctuating water table.
My Own Cottage assesses all of these variables during the pre-construction site evaluation, before any factory commitment is made.
Bill 23 Garden Suites — Adding a Prefab ADU to an Existing Orillia Lot
Ontario’s More Homes Built Faster Act, 2022 (Bill 23) requires Orillia to permit up to two additional dwelling units as-of-right on eligible residential lots: one within the main dwelling and one in a detached accessory structure such as a garden suite.
Prefab and modular units fully qualify as garden suites provided they meet OBC standards and hold CSA A277 certification.
For existing Orillia property owners, a prefab garden suite is one of the most financially efficient home improvements available — particularly given the Bill 23 development charge exemption and the speed of factory site installation relative to a conventional addition.
The Development Charge Exemption — The Number That Changes the Math
Development charges are exempt for qualifying garden suites under Bill 23 provisions. On a new principal dwelling, development charges represent a significant budget line payable at permit issuance. On a qualifying prefab garden suite, they do not apply.
This exemption makes a factory-modular garden suite on an existing Orillia lot one of the most cost-efficient prefab applications in the region.
A building permit is still required. Services — water, sewer, electrical — are typically routed via the main house’s existing connections, which simplifies site coordination considerably compared to a standalone new build.
Confirm your lot’s eligibility with the City of Orillia Building Division before ordering any factory unit. Lot coverage, setback compliance, and servicing availability vary by parcel.
Fox Den at 505 sq ft — Sized for the ADU Use Case
My Own Cottage’s Fox Den model at 505 sq ft (from CAD $229,500) is sized within typical accessory structure limits and is available with full four-season OBC specifications.
It suits rental income generation, multigenerational living, or a dedicated home office that functions as a standalone structure rather than a converted room.
The Fox Den (505 sq ft) — OBC compliant prefab garden suite designed for ADU use in Orillia, ideal for backyard installation under Ontario’s Bill 23 additional dwelling unit framework.
For buyers comparing home packages across size tiers, the Fox Den represents the best price-per-sq-ft entry point in our catalogue for a four-season, OBC-compliant accessory structure.
For the complete guide to building a prefab garden suite on your Orillia lot — including the ADU concierge program fast-track, all-in costs, permit sequence, and LSRCA rules — see our prefab garden suite Orillia guide.
Financing Your Orillia Prefab — What Lenders Actually Require
Prefab home financing in Ontario is more nuanced than a standard residential mortgage — and the type of home you build determines which financing pathway is available to you.
CSA A277-certified modular on owned land qualifies for a traditional residential mortgage. Major banks treat a CSA-certified modular home on a permanent foundation the same as a site-built home, provided certain conditions are met: full appraisal, building permit in hand or confirmed, and Tarion enrollment where applicable. CMHC mortgage insurance is available for buyers with less than 20% down.
Manufactured home on leased land requires a chattel loan — higher interest rates, shorter repayment terms, fewer lenders willing to participate. This structure is not relevant to freehold residential or waterfront development in Orillia.
Construction draw mortgage: most lenders will not fund a prefab home pre-delivery. A construction or draw mortgage is required during the build phase, with funds released in stages as milestones are reached. The parallel build model compresses the draw mortgage exposure period compared to a sequential approach.
What lenders require before approval: CSA A277 certification documentation, a full as-complete appraisal, building permit confirmation, and Tarion enrollment records.
Engage a lender experienced in Ontario modular home financing, and review CMHC’s guidance on mortgage loan insurance for factory-built homes before signing any factory contract. My Own Cottage can provide referrals — mention it when you book your consultation.
Review our prefab home financing Ontario guide to understand construction draws, appraisal requirements, site-cost documentation, and how lenders evaluate factory-built homes.
My Own Cottage — Prefab Homes Built in Orillia, for Orillia
My Own Cottage is physically based in Orillia at 12 Lankin Blvd #3, Orillia ON L3V 7B6. Phone: (705) 345-9337.
This is not a GTA builder with an Orillia landing page — it is an Orillia operation with deep local building experience, serving buyers across Simcoe County and the Muskoka corridor who want high-quality, low-maintenance homes built to modern living standards.
Every build is HCRA-licensed, Tarion enrolled, and OBC compliant. Buyers can verify any builder’s HCRA registration directly through the HCRA Ontario public registry before signing any purchase agreement.
Completed prefab home in Orillia, Ontario — a real My Own Cottage build demonstrating modern modular design, permanent foundation installation, and turnkey delivery on a serviced residential lot.
Permit coordination is included as a standard part of the turnkey design-to-delivery service. Site assessment is completed before any factory commitment is made, so the all-in cost estimate you receive reflects your actual lot conditions — not a generic range.
We have completed cottage builds and primary residence projects across Simcoe County, from lakefront parcels on Lake Couchiching to rural lots in Severn and Ramara — and the building experience that comes from working across that range of site conditions informs every estimate we provide.
Buyers who are explicitly cottage-focused rather than primary-residence-focused should review the benefits of prefab cottages in Ontario.
What Our Clients Have Built in the Orillia Area
A retired Toronto couple built a 960 sq ft year-round retirement home on the east shore of Lake Simcoe. This is an open-concept layout with floor-to-ceiling windows facing the water, upgraded to triple-pane windows and a solar-ready roofing system, delivered and installed in 12 weeks with foundation completed in parallel. Their energy costs are a fraction of what they paid in the city.
An outdoor enthusiast built a 720 sq ft rustic timber frame cottage on a forested lot north of Orillia — natural cedar cladding, propane fireplace, off-grid solar prep, and a loft-style second bedroom that generates approximately CAD $1,800 per month during peak summer season through short-term rental. CSA A277 certified; passed local inspection in under three days.
A local Orillia family at Couchiching Point added a 400 sq ft prefab guest cottage to their existing lakefront property — fully assembled and ready for use in seven weeks, ADU-compliant under local zoning, now generating rental income during peak cottage season.
Every client we work with across Ontario is guided through the process every step of the way — from the first design consultation through site installation, permit coordination, and final walkthrough.
"My Own Cottage delivered our Fox Den garden suite to our Orillia lot in under six months. Permit coordination, site assessment, and installation were all handled by their team. We had rental income within the year."
"From the very beginning, the team at My Own Cottage Inc. provided exceptional customer service and guidance throughout the early planning stages of my project. I was starting completely from scratch and honestly had very little understanding of what was involved in preparing to build a home. What stood out most was the wealth of knowledge, patience, and clarity they provided before anything even began."
"We compared traditional construction and prefab modular homes for our waterfront lot. The construction timeline, cost predictability, and the fact that My Own Cottage knew Muskoka's specific requirements made the decision straightforward. The finished build exceeded every expectation."
“Thank you very much for the great cooperation! We felt absolutely well taken care of. Feedback was always prompt, very professional, yet personal and individualized. Above all, the information provided in advance was very detailed and extremely helpful. My Own Cottage Inc. is absolutely recommendable!”
The goal is your own home or perfect home addition, built to the specifications your lot and lifestyle require, with the peace of mind that comes from working with a builder who is HCRA-licensed, Tarion enrolled, and physically present in the community where your home will stand.
Our modular construction methods reduce material waste and build time compared to traditional homes. We deliver quality homes that rival or exceed site-built homes in durability, energy performance, and long-term value.
This is a building process that is trusted by homeowners across Ontario and increasingly across North America as factory-built construction becomes the rational response to rising site-build costs and trade shortages.
We serve locally: The City of Orillia, Severn Township, Ramara Township, Oro-Medonte Township, and the broader Simcoe County and Muskoka corridor.
Ready to Build?
If you’ve read this far, you have a clearer picture of the Orillia prefab market than most buyers who have been researching for weeks.
The next step is straightforward: a free consultation with My Own Cottage, where we assess your specific lot, confirm your all-in cost range, and walk you through the permit process from application to occupancy.
We handle the regulatory complexity. You make the decisions that matter.
Ready to discuss your build?
Tap below to reach us by phone at (705) 345-9337, request a free consultation at myowncottage.ca, or view our design catalogue to start planning. We respond to all inquiries within one business day.
• Request a Free Consultation
• Call Us Directly: (705) 345-9337
• View Our Design Catalogue
Alternatively, for your convenience, you can also simply fill out the contact form below and we’ll get back to you soon!
Frequently Asked Questions — Prefab Homes Orillia
Is Orillia in Muskoka?
No. Orillia is a separated municipality within Simcoe County, not part of the District of Muskoka.
It operates under a separate regulatory framework — the City of Orillia Building Division as the permit-issuing authority and the Lake Simcoe Region Conservation Authority governing shoreline development, distinct from the Muskoka Watershed Council.
Orillia sits on the Highway 11 corridor that feeds into Gravenhurst, Bracebridge, and Huntsville — adjacent to Muskoka, governed and priced as a separate market.
What are the zoning and permit requirements for a prefab home in Orillia?
Every new prefab or modular home in the City of Orillia requires a building permit from the Building Division at 50 Andrew Street South, 705-329-7258.
The complete application must include CSA A277 factory certification documents, site plan, architectural and structural drawings, and energy compliance documentation under OBC Division B Section 12.
For shoreline lots, an LSRCA permit under O. Reg. 41/24 is also required and must be initiated simultaneously — not after — the City permit application.
How much does a prefab home cost in Orillia in 2026?
Factory pricing starts at approximately CAD $180,000 finished, ranging CAD $150–$220 per sq ft for primary residences.
All-in costs — foundation, utility connections, permits, development charges, and HST — range from CAD $290,000–$370,000+ for an urban serviced Orillia lot, CAD $370,000–$480,000+ for a rural inland lot in Severn or Ramara, and CAD $450,000–$600,000+ for a Lake Couchiching waterfront lot.
My Own Cottage provides a verified all-in estimate based on your specific lot before any commitment is made.
What are the benefits of prefab over traditional construction in Orillia?
Three advantages are specific to the Orillia market.
First, municipal services eliminate the well and septic costs (CAD $35,000–$80,000+) that rural and Muskoka builds require.
Second, the parallel build model — factory manufacturing concurrent with permitting and site preparation — compresses total build time to 6–10 months versus 12–18 months for conventional construction.
Third, factory-controlled production delivers tighter building envelopes, less material waste, and more consistent energy performance than site-built framing in Ontario’s weather conditions.
What energy efficiency standards do prefab homes in Orillia meet?
Orillia sits in Climate Zone 6 under the Ontario Building Code, requiring minimum effective R-20 to R-24 in above-grade walls for year-round residential occupancy.
My Own Cottage builds to R-24+ walls and R-50+ roofs, with heat pumps, HRV systems, triple-glazed low-E windows, and continuous air barriers as standard specifications.
These exceed OBC minimums and satisfy R-2000 and ENERGY STAR for New Homes compliance pathways.
The result is operating costs that typically run well below comparable traditional homes of the same square footage.
How long does it take to build a prefab home in Orillia?
Factory manufacturing takes 10–16 weeks once engineering is finalized.
Permit review on a standard urban Orillia lot runs 4–6 weeks from a complete submission.
Using a parallel build model, these timelines overlap rather than stack.
Total contract to occupancy for a standard urban lot: approximately 6–10 months. Shoreline lots requiring LSRCA review add 4–12 weeks to that timeline.
What is included in a turnkey prefab home from My Own Cottage?
The turnkey service covers design consultation and 3D rendering, engineering and CSA A277 factory certification, permit application coordination, factory manufacturing, delivery, crane set, foundation coordination, utility hookup oversight, and final walkthrough.
Site-specific costs — foundation, municipal hookups, grading — are quoted separately based on your actual lot assessment, which My Own Cottage completes before any factory commitment is made.
Optional additions include decks, septic design coordination for rural lots, and financing referrals.
What warranty covers a new prefab home in Orillia?
My Own Cottage enrolls every build in Tarion’s new home warranty program, which is mandatory for all new residential home sales in Ontario and is not optional or an upgrade.
Tarion provides deposit protection, one-year coverage for defects in work and materials, two-year coverage for water penetration and electrical, plumbing, and heating delivery systems, and seven-year coverage for major structural defects.
CSA A277 factory certification additionally ensures the building envelope and structural systems were third-party inspected during manufacturing — before the unit was delivered to your lot.
Does the LSRCA have jurisdiction over waterfront properties in Orillia?
Yes — the Lake Simcoe Region Conservation Authority has direct jurisdiction over waterfront properties in the City of Orillia.
The City of Orillia is an explicit member municipality of the LSRCA, and virtually every waterfront parcel in Orillia — on Lake Couchiching or Lake Simcoe — falls within the LSRCA’s regulated area under Ontario Regulation 41/24.
An LSRCA permit is required for construction, site grading, fill placement, and shoreline work within regulated areas, in addition to a City of Orillia building permit.
The Severn Sound Environmental Association (SSEA) governs a separate watershed to the northwest and does not administer permits within the City of Orillia. Confirm your lot’s regulated area status at the LSRCA Interactive Regulation Map Viewer before purchasing any Orillia waterfront property.
Verified External Resources
City of Orillia Building Permits and Inspections — Primary permit-issuing authority for all new prefab and modular home construction within the City of Orillia. Building Division at 50 Andrew Street South, Suite 300, Orillia ON L3V 7T5. Tel: 705-329-7258.
City of Orillia 2025 Building Permit Fee Schedule — Official fee schedule effective 2025, including accessory buildings (CAD $192.71), decks (CAD $203.72), finished basements (CAD $275.29), re-inspections (CAD $159.90), and permit amendments (CAD $213.20). Confirm current per-square-foot residential rates directly with the Building Division before budgeting.
City of Orillia Development Charges By-law No. 2024-113 — Development charges effective January 1, 2025 with updated rates from July 1, 2025. Confirm specific amounts directly with the City’s Treasury or Development Services department — development charges are payable at permit issuance and represent a significant all-in cost line item.
City of Orillia Shoreline Development Guidelines — Governing document for the 15-metre buffer setback from Lake Couchiching’s high water mark, the 30-metre setback from Lake Simcoe, the Flood Hazard overlay zone under Zoning By-law Section 15.4, and the minimum 30 percent lot area naturalization requirement. Pre-consultation with the City Planning Division at 705-325-2622 is required before any shoreline permit application.
Lake Simcoe Region Conservation Authority — Planning and Permits LSRCA permit applications for development within regulated areas adjacent to Lake Couchiching. The LSRCA permit under O. Reg. 41/24 is a separate approval from the City building permit — both must be initiated simultaneously. Online application at lsrca.on.ca.
Ontario Regulation 41/24 — Development, Interference with Wetlands and Alterations to Shorelines and Watercourses Regulation governing all development within LSRCA-regulated areas, effective April 1, 2024, replacing O. Reg. 179/06. Applies to all construction, grading, and fill placement adjacent to Lake Couchiching. Confirm regulated area status before purchasing any Orillia waterfront lot.
Lake Simcoe Protection Plan (2009) — Provincial plan providing an additional environmental protection layer for the Lake Simcoe watershed including Lake Couchiching — more restrictive than the framework applying in Muskoka. Development near Lake Couchiching must demonstrate conformity with this plan in addition to satisfying LSRCA permit requirements.
Severn Township 2025 Building Permit Guide — Complete permit process, requirements, and fee schedules for Severn Township effective 2025. Fee schedule: CAD $173 base plus CAD $1.38 per square foot residential. Septic permit fees: Class 4 CAD $694, Class 2 CAD $381, Class 5 CAD $532.
Contact: [email protected], 705-325-2315 x246.
Township of Ramara Building and Planning — Building permit information for Ramara Township, east and south of Orillia. Confirm current setback requirements and fee schedules directly with the Township before purchasing any Ramara lot.
Ontario Building Code O. Reg. 332/12 — Primary provincial standard governing all prefab and modular home construction in Ontario including Part 9 residential requirements, Part 8 on-site sewage system standards, and Division B Part 12 energy efficiency requirements for Climate Zone 6 occupancies.
Ontario.ca Factory-Built (Modular) Buildings — Official provincial guide to modular home construction, CSA A277 certification, and the municipal permit process for factory-built housing in Ontario.
Ontario.ca More Homes Built Faster Act, 2022 (Bill 23) — Legislation permitting up to two additional residential units as-of-right on eligible lots, including a detached garden suite. Prefab and modular units qualify if OBC-compliant and CSA A277 certified. Development charges are exempt for qualifying garden suites — confirm eligibility with the City of Orillia Building Division before ordering any unit.
HCRA Ontario Builder Directory — Verify any builder’s active HCRA registration before signing any purchase agreement. HCRA licensing is mandatory for any builder selling a new home in Ontario and is required for Tarion warranty coverage to apply.
Tarion New Home Warranty Program — Ontario’s statutory new home warranty covering deposit protection, one year workmanship and materials, two years major systems, and seven years major structural defects up to CAD $300,000. Every new prefab home in Orillia must be enrolled with Tarion before the occupancy permit application is submitted.
CMHC Mortgage Loan Insurance for Factory-Built Homes — Federal mortgage insurance eligibility for CSA A277 certified prefab homes on permanent foundations, with as little as 5 percent down for a primary residence. Confirm current eligibility requirements with your lender before finalising any budget.
Verified Internal Resources
Buyers evaluating Muskoka as an alternative to Orillia will find the complete lot-type breakdown, site cost framework, and model pricing in our prefab homes Muskoka buyer’s guide.
The five-layer cost framework for Muskoka builds — covering Shield bedrock foundations, water-access logistics, Conservation Authority permits, and model-tier pricing — is covered in full in our Muskoka prefab home prices guide.
Compact modular builds, bunkies, and ADU-sized homes on Orillia lots are a separate category with their own permit pathway and pricing structure. Our small prefab homes Orillia guide covers all three in detail.
If you’re adding a detached unit to an existing Orillia property, the Bill 23 DC exemption, the ADU concierge fast-track, and the complete permit sequence are documented in our prefab garden suite Orillia guide.
Our prefab home permits Orillia guide contains the verified 2026 fee schedule, development charge amounts by lot type, LSRCA sequencing requirements, and the six most common first-submission mistakes.
The gap between factory price and total project cost is where most Orillia prefab budgets go wrong. A full line-item breakdown — development charges, permit fees, foundation, utility connections, and HST by lot type — is available in our prefab home costs Orillia guide.
