Prefab Home Permits in Orillia: 2026 Fees, Zoning, LSRCA Rules, and Step-by-Step Process

Last updated: May 17th, 2026
Written by building specialists at My Own Cottage

If you have a prefab supplier quote in hand and a lot in the Orillia area, this guide is written for you — not for someone still deciding whether to build, but for someone who has decided and now needs to navigate the permit process without costly delays.

Orillia’s permitting environment has three features that distinguish it from the provincial baseline:

• 1. A dedicated prefab permit fee category at CAD $1.27 per square foot (the lowest residential rate on the City’s fee schedule)

• 2. Development charges payable in full at permit issuance rather than at closing

• 3. A parallel Conservation Authority approval requirement for waterfront lots near Lake Couchiching that most buyers discover too late

This page documents every stage of the permit process for prefab homes in Orillia, from pre-application through occupancy permit with verified 2025–2026 figures at every step.

For the broader permiting framework and how it applies across Ontario, see our prefab home permits Ontario guide.

Quick Stats — Prefab Home Permits in Orillia 2026

Prefab permit fee (2025 Schedule A)CAD $1.27/ft² — House Prefabricated (lowest residential rate)
Standard detached rate for comparisonCAD $1.68/ft² — prefab rate saves $492 on a 1,200 sq ft build
Development charges (large residential, July 2025)Wastewater CAD $4,791.48 + Water CAD $2,231.32 + additional categories
Statutory review period10 business days from complete submission
LSRCA permit requirementRequired for all lots near Lake Couchiching, Lake Simcoe, or any regulated watercourse or wetland
E-Permit portalcitywideportal.com
Building Division50 Andrew Street South, Suite 300 — 705-329-7258 — [email protected]

Sources: City of Orillia 2025 Permit Fee Schedule (Schedule A); DC Pamphlet effective July 1, 2025

Why Prefab Permits in Orillia Work Differently

The most common and most costly misconception: CSA A277 factory certification replaces the City of Orillia building permit. It does not.

Before we walk through the step-by-step permit process, it’s critical to understand that there is no single approval pathway for small prefab homes in Orillia.

The permits you need depend entirely on where your lot is located — within the City, on a Lake Couchiching waterfront property, or in a surrounding township like Severn or Ramara.

The diagram below shows exactly which pathway applies to your situation and which authorities are involved.

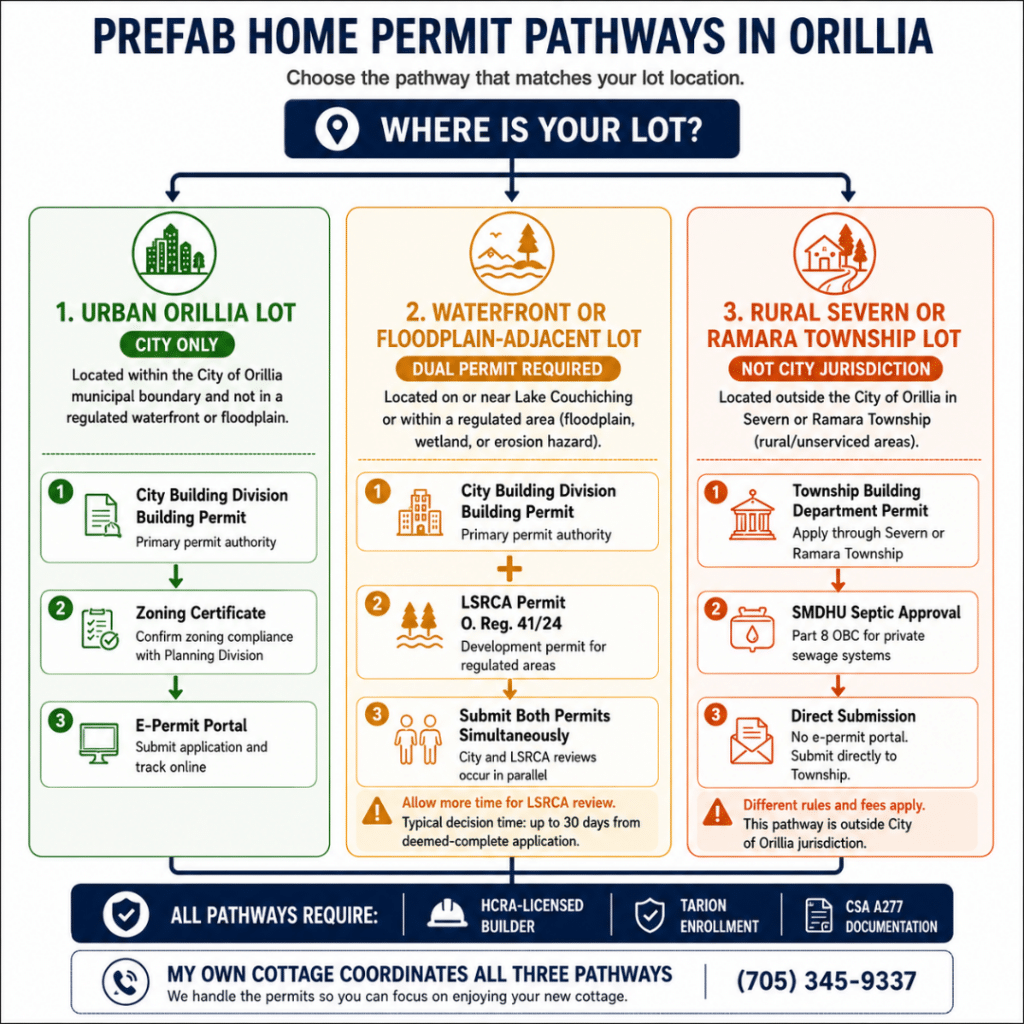

Prefab home permit pathways in Orillia Ontario — decision tree showing urban lot City permit only versus Lake Couchiching waterfront LSRCA dual permit versus Severn Ramara Township separate jurisdiction

Pathways for prefab home permits in Orillia vary by lot type — urban lots require only a City permit, while waterfront and rural properties introduce additional authorities. This diagram shows exactly which approvals apply before you start.

CSA A277 means a factory-built modular home’s construction was inspected by a third-party certification agency during manufacturing. That factory documentation streamlines certain aspects of the City’s plan review and may reduce the scope of some site inspections — but the Ontario Building Code Act provides no exemption for factory-built homes.

Every new prefab home in Orillia requires a City of Orillia building permit. The occupancy permit cannot be issued without one.

Depending on your lot, a new prefab home may require approvals from up to four bodies before site work begins:

• The City of Orillia Building Division (primary permit authority; 705-329-7258; [email protected])

• The City of Orillia Planning Division (zoning compliance and Zoning Certificate Pre-consultation line 705-325-2622)

• The Lake Simcoe Region Conservation Authority (development permit for regulated waterfront and floodplain lots; lsrca.on.ca)

• For rural unserviced lots, the Simcoe Muskoka District Health Unit (Part 8 OBC septic approval; smdhu.org)

For the broader CSA A277 framework and how it applies across Ontario, see our prefab home permits Ontario guide.

Step-by-Step Permit Process for a Prefab Home in Orillia

Step 1 — Obtain a Zoning Certificate Before Commissioning Any Design

Before the Building Division will begin reviewing a building permit application, the Planning Division must confirm the proposed prefab home complies with City of Orillia Zoning By-law No. 2014-44 (consolidated June 2, 2025).

This confirmation is a Zoning Certificate — a formal step, not a phone call.

If the proposed design cannot meet a zoning requirement — setback, lot coverage, height — a minor variance application to the Committee of Adjustment is required before building permit review can proceed. The Committee of Adjustment typically takes 4–12 weeks.

A prefab module that arrives before a variance is resolved incurs storage costs that compound daily while the permit clock has not yet started.

For properties within a site plan control area, Planning Division approval of a site plan agreement is an additional prerequisite.

Confirm both status points at pre-consultation (705-325-2622) — required for shoreline lots, strongly recommended for all others.

Step 2 — Check LSRCA Regulated Area Status Before Purchasing the Lot

If your lot is within approximately 30 metres of Lake Couchiching, Lake Simcoe, the Trent-Severn Waterway, or any mapped wetland or floodplain in the Orillia area, the LSRCA almost certainly has jurisdiction.

Under Ontario Regulation 41/24 (effective April 1, 2024, replacing O. Reg. 179/06), any construction, grading, or site alteration within a regulated area requires written LSRCA permission before work begins.

The City of Orillia Building Division requires proof of LSRCA permission — or written confirmation no permit is required — as part of its applicable law review before issuing a building permit.

Buyers who submit a City application without checking LSRCA status first discover this mid-review. The City file pauses while the LSRCA application is prepared.

This error routinely adds three to five months to a construction timeline that could have proceeded in parallel. Check regulated area status at lsrca.on.ca before signing any agreement of purchase and sale.

Step 3 — Prepare a Complete Drawing Package

Building permit applications for new prefab homes require construction drawings stamped by an Ontario-licensed engineer or architect. For CSA A277-certified modular units, the factory’s certified engineering package satisfies a significant portion of the structural drawing requirement.

A complete package includes: site plan, foundation plan and structural details, floor plans and elevations, cross-sections, energy compliance documentation under OBC Division B Section 12 (SB-12), and a grading and drainage plan.

The official City of Orillia new dwelling permit checklist — BD.F.413-New-Dwelling-20260126.pdf, updated January 2026 — is available at orillia.ca.

The CSA A277 documentation package is the most commonly missing component in first-time modular submissions. Its absence triggers a deficiency notice that resets the statutory review clock.

Step 4 — Submit via E-Permit and Run the LSRCA Application Simultaneously

All City of Orillia building permit applications are processed through the E-Permit Public Portal at citywideportal.com.

After submission, a pre-screen review (typically 2–3 business days) confirms the package is complete before formal departmental review begins. The statutory 10-business-day review clock under the Building Code Act, 1992 starts only when the application is deemed complete.

The LSRCA application is submitted separately and simultaneously — via lsrca.formstack.com — not after the City permit is confirmed.

Running both in parallel reduces overall regulatory wait time by 4–8 weeks on waterfront and floodplain-adjacent lots. This is the single most impactful schedule decision available to a waterfront buyer in Orillia.

Step 5 — Pay Fees and Development Charges at Permit Issuance

Once all departmental reviews are satisfied, the permit is ready for issuance. Permit fees and development charges are payable at permit issuance — not at application, not at construction start. DC funds in the full amount must be available on permit pickup day.

The 2025 prefab permit fee is CAD $1.27/sq ft (Schedule A).

Development charges under the July 2025 DC Pamphlet include wastewater at CAD $4,791.48 and water at CAD $2,231.32 for large residential units, plus additional service categories confirmed in the full pamphlet at orillia.ca.

Minimum building permit fee: CAD $150.00.

Simcoe County may levy separate County-level DCs — confirm full exposure with the Building Division at pre-application.

Step 6 — Book Inspections and Receive the Occupancy Permit

Inspections are booked through the E-Permit portal.

For a new prefab home, mandatory stages include: foundation (before backfill and before module delivery), module placement and assembly verification, rough-in electrical, rough-in plumbing, rough-in HVAC, insulation and air barrier, and final occupancy.

CSA A277-certified units may qualify for streamlined inspection at certain rough-in stages — confirm which stages with the Building Division at pre-application.

Permit expiry warning: A building permit expires if no inspection is requested within any 6-month period during construction.

For parallel-model prefab builds where factory manufacturing runs concurrent with site preparation, book the foundation inspection immediately after permit issuance to protect the permit through the factory build phase.

For the complete Orillia permit timeline by lot type, see our prefab homes Orillia buyer’s guide.

2025–2026 Orillia Building Permit Fee Table for Prefab Homes

The City of Orillia 2025 Schedule A includes a dedicated “House — Prefabricated” category — the lowest per-square-foot residential rate the City publishes.

This is a direct financial advantage for choosing factory-built over site-built construction.

Full 2025 Permit Fee Schedule — Residential Categories

Category2025 Fee Rate
House — Prefabricated$1.27 / ft²
House — Certified Model$1.38 / ft²
House — Detached / Semi-Detached / Row$1.68 / ft²
Additional Dwelling Units (ADUs)$1.68 / ft²
Multi-Residential Unit Buildings$1.99 / ft²
Interior Alterations / Renovations$0.34 / ft²
Finished Basement$275.29 flat
Accessory Building (Garage / Shed)$192.71 flat
Decks and Porches$203.72 flat
Re-inspections$159.90 flat
Permit amendments$213.20 flat
Minimum fee$150.00

Source: City of Orillia 2025 Permit Fee Schedule (Schedule A)

Worked example — 1,200 sq ft prefab home: 1,200 × $1.27 = $1,524.00

Same home at standard detached rate: 1,200 × $1.68 = $2,016.00 — prefab rate saves $492.00

Worked example — 500 sq ft prefab garden suite (ADU rate): 500 × $1.68 = $840.00

City of Orillia 2025 building permit fee comparison for prefab home versus standard detached — $1.27 per sq ft vs $1.68 per sq ft showing $492 savings on a 1200 sq ft prefab home

Prefab homes in Orillia are charged at a lower building permit rate — saving $492 on a typical 1,200 sq ft build compared to standard detached construction (2025 Schedule A).

House-Prefabricated vs. House-Certified Model

These categories are not interchangeable. Misclassifying at application causes fee adjustments that delay processing.

House — Prefabricated ($1.27/ft²) applies to homes assembled from factory-built modules or panels — the broadest prefab category, capturing most modular, panelised, and systems-built homes. My Own Cottage prefab builds fall here.

House — Certified Model ($1.38/ft²) applies to homes built from a pre-reviewed, standardised plan set the Building Division has previously approved.

Confirm which category applies with your builder before submitting the permit application.

Development Charges — What You’ll Pay at Permit Issuance

Building permit fees are only one component of upfront regulatory costs. Development charges are a separate and materially larger line item, levied under the Development Charges Act, 1997 to fund growth-related municipal infrastructure.

Verified DC Rates — July 2025

Orillia’s DCs are governed by By-law No. 2023-009 (amended 2024-113). Large residential unit rates under the July 1, 2025 DC Pamphlet:

ServiceLarge Residential DC Rate (July 2025)
WastewaterCAD $4,791.48
WaterCAD $2,231.32
Other City services (roads, parks, fire, etc.)Confirm via July 2025 DC Pamphlet

Rates are indexed — the rates at permit application time govern, not rates confirmed during earlier planning.

Simcoe County may levy additional County-level DCs. Confirm total DC exposure with the Building Division at 705-329-7258 at pre-application.

DCs are payable in full at permit issuance. Property owners who have not reserved these funds face a situation where the permit cannot be released on pickup day.

Bill 23 DC Exemptions for ADUs

A second residential unit on an eligible lot — such as a prefab garden suite on a lot already containing a principal dwelling — is fully exempt from development charges under Bill 23 (More Homes Built Faster Act, 2022).

A third unit receives a discounted rate.

The building permit is still required at $1.68/ft² (ADU category). For Orillia property owners adding a garden suite, this exemption eliminates several thousand dollars in upfront costs.

Zoning Requirements — What By-law 2014-44 Means for Your Build

Every new prefab home in Orillia must comply with Zoning By-law No. 2014-44 (consolidated June 2, 2025). Key dimensional standards in typical R1/R2 residential zones:

Rear yard setback: typically minimum 7.5 metres

Side yard setback: typically 1.2–1.8 metres depending on zone

Maximum lot coverage: typically 35–40% of total lot area

Maximum building height: typically 10–11 metres in R1/R2

Ceiling height: OBC minimums apply to all habitable space

These are general ranges — confirm specific parameters for your zone with the Planning Division before finalising any floor plans. Zoning By-law 2014-44 is available at orillia.ca.

Within Orillia’s urban boundary, Bill 23 permits a detached garden suite as-of-right on most residential lots — no rezoning required in most cases.

A prefab modular unit qualifies as a garden suite if OBC-compliant and CSA A277-certified; the applicable dimensional standards under By-law 2014-44 include a 1.2-metre minimum rear yard setback and a maximum height typically of 4 metres or one storey.

In Severn Township and Ramara Township, detached garden suites are generally not permitted as independent dwelling units in most rural zones — confirm with the relevant township before purchasing any lot outside Orillia’s urban boundary.

For the complete Bill 23 compliance guide — DC exemption mechanics, ADU concierge fast-track, and permit sequence — see our prefab garden suite Orillia guide.

For structure classification, foundation options, and pricing tiers for compact and ADU-scale builds, see our small prefab homes Orillia guide.

LSRCA Approval — Lake Couchiching, Lake Simcoe, and the Regulated Area Rule

What Triggers the LSRCA Permit Requirement

The LSRCA regulated area is calculated from the surveyed high water mark (HWM), which often sits several metres inland from what you see on site.

The diagram below shows exactly how this boundary works on a typical Lake Couchiching lot — and where you can (and cannot) build a small prefab home without additional approvals.

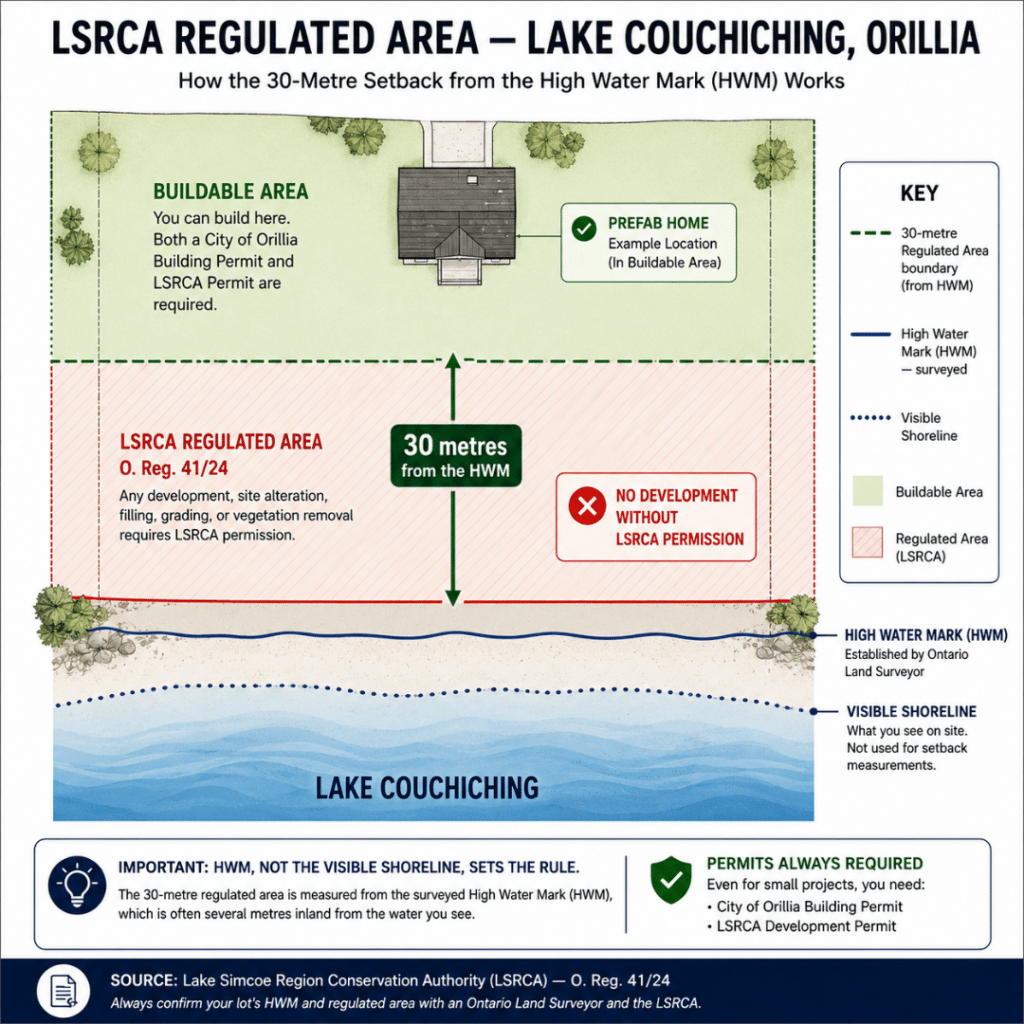

LSRCA regulated area diagram Lake Couchiching Orillia Ontario showing 30 metre setback from high water mark under O Reg 41/24 and buildable area requiring City of Orillia building permit and LSRCA permit for prefab home

On waterfront lots in Orillia, the LSRCA regulated area extends 30 metres from the surveyed high water mark — not the visible shoreline. Any prefab home within this zone requires both a City building permit and LSRCA approval under O. Reg. 41/24.

The LSRCA administers Ontario Regulation 41/24 for the Lake Simcoe watershed — including Lake Couchiching, Lake Simcoe’s northern shoreline, and associated wetlands, floodplains, and river/stream valley corridors in the Orillia area.

An LSRCA development permit is required for any construction, grading, or placing of fill within a regulated area.

“Development” is broadly defined — it includes module placement, foundation installation, and any grading that could affect drainage toward a regulated feature.

If your lot is within approximately 30 metres of Lake Couchiching, borders a regulated watercourse or wetland, or falls within a mapped floodplain, an LSRCA permit is almost certainly required before the City of Orillia will issue a building permit.

New construction on a shoreline or floodplain-adjacent lot is never exempt. Confirm regulated area status at lsrca.on.ca during lot due diligence — before any agreement of purchase and sale.

The Three Legislated Timelines Under O. Reg. 41/24

O. Reg. 41/24 introduced binding processing timelines — legislated obligations, not targets:

Complete application notice: LSRCA must notify the applicant within 21 days whether the application is complete

Decision on complete application: LSRCA has 30 days from deemed-complete date to issue a decision

Permit validity: Up to 60 months once issued

Applications are submitted via lsrca.formstack.com.

A complete application requires a site plan showing the proposed structure’s location relative to the regulated feature, a grading and drainage plan, construction details, and any supporting environmental documentation the LSRCA requests.

For the complete 2026 guide to LSRCA fees, the eight-step application process, and what the Lake Simcoe Protection Plan means for your septic budget, see our complete LSRCA waterfront permits Orillia guide.

The Parallel Submission Strategy — How to Save 4–8 Weeks

The most costly waterfront permit mistake: submitting the City application first, then discovering the LSRCA requirement mid-review.

The correct sequence:

• 1. Confirm LSRCA regulated area status during lot due diligence

• 2. Submit the LSRCA application simultaneously with or slightly before the City building permit application

• 3. Provide proof of LSRCA permission to the City as part of its applicable law review

Parallel processing reduces total regulatory wait time by 4–8 weeks — directly accelerating the construction timeline on a build where factory manufacturing is already running concurrently with site preparation.

Jurisdiction Comparison — City of Orillia vs. Severn Township vs. Ramara Township

Buyers searching “prefab home permits Orillia” frequently have lots that are not technically in the City of Orillia. For a verified side-by-side comparison of development charges, permit fees, LSRCA jurisdiction, and servicing requirements across all five build zones near Orillia, see our best places to build near Orillia guide.

Properties in Severn Township, Ramara Township, and Oro-Medonte Township regularly surface in Orillia-area real estate searches — each with its own building department, permit fees, and ADU rules.

Submitting to the City of Orillia Building Division for a Severn Township lot is a non-starter. The City has no jurisdiction and the application will be rejected.

City of Orillia

Building department: Building Division

Contact: 705-329-7258; [email protected]

Prefab permit fee: $1.27/ft² (2025 Schedule A)

Conservation authority: LSRCA (O. Reg. 41/24)

Septic authority: Municipal sewer (most urban lots)

ADU / garden suite: As-of-right under Bill 23

E-Permit system: Yes — citywideportal.com

Severn Township

Building department: Severn Building Department

Contact: [email protected]; 705-325-2315 x246

Prefab permit fee: CAD $173 base + $1.38/ft²

Conservation authority: LSRCA (O. Reg. 41/24)

Septic authority: SMDHU Part 8 OBC

ADU / garden suite: Generally not as-of-right

E-Permit system: No — direct submission

For the complete Severn Township build guide including permit fees, LSRCA waterfront context, and delivery logistics, see our prefab homes in Severn Township guide.

Ramara Township

Building department: Ramara Building Department

Contact: ramara.ca

Prefab permit fee: Confirm at ramara.ca

Conservation authority: LSRCA (O. Reg. 41/24)

Septic authority: SMDHU Part 8 OBC

ADU / garden suite: Generally not as-of-right

E-Permit system: No — direct submission

Confirm your lot’s municipal jurisdiction — not just postal code — before engaging any building department or permit portal.

For the complete Ramara Township build guide including LSRCA sequencing requirements, LSPP septic premium, and Lagoon City context, see our prefab homes Ramara Township guide.

Total Soft Cost Breakdown — What Permitting Actually Costs in Orillia

The biggest cost differences in Orillia don’t come from the home itself — they come from servicing, septic system requirements, and conservation authority approvals tied to your property.

The visual below shows how home building soft costs shift across urban, waterfront, and rural township lots.

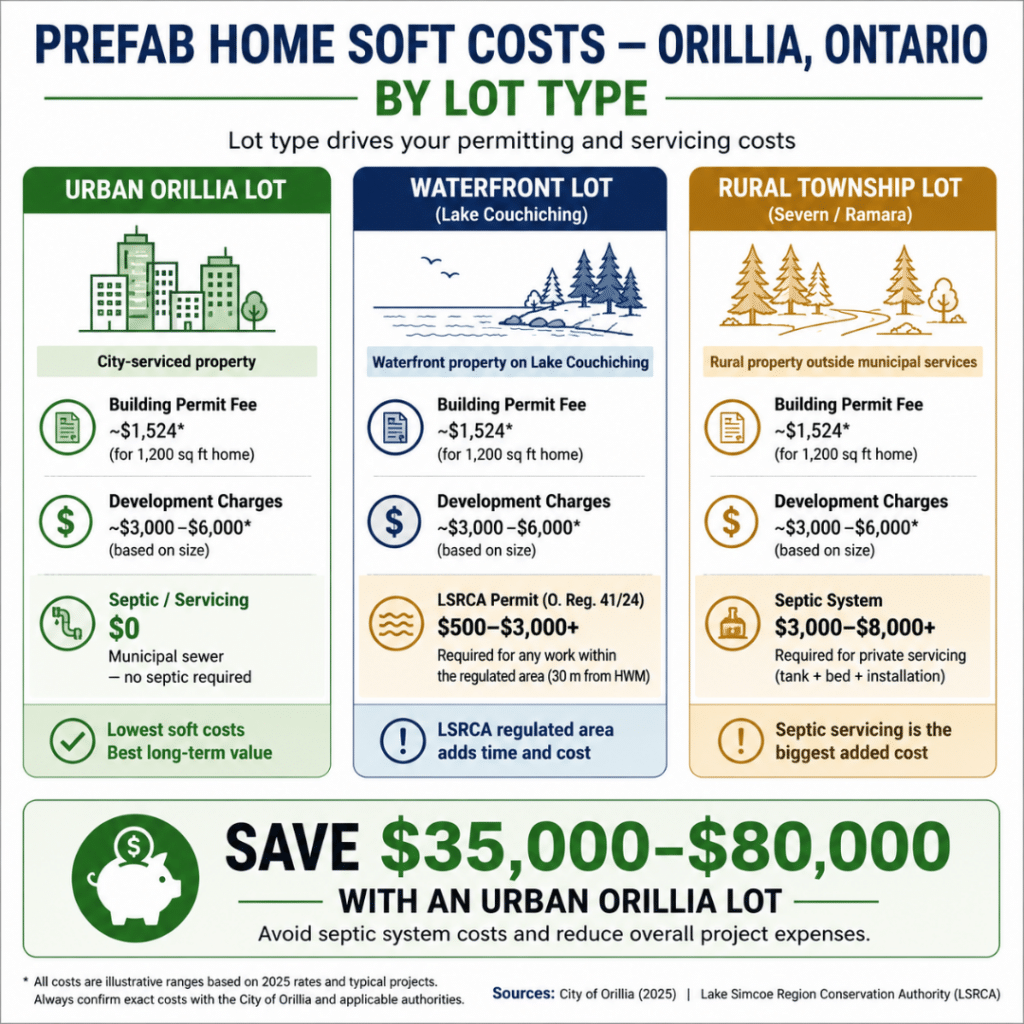

Prefab home soft costs in Orillia Ontario by lot type — urban City lot versus Lake Couchiching waterfront versus rural Severn Ramara Township showing septic costs savings and LSRCA permit requirements

Lot type drives your real cost. Urban Orillia lots avoid septic and save $35,000–$80,000, while waterfront and rural properties introduce LSRCA and septic costs that significantly affect total project pricing.

Cost ItemUrban Orillia LotLake Couchiching WaterfrontRural Township Lot
Design and engineering drawingsCAD $3,500–$7,000CAD $5,000–$10,000+CAD $3,500–$7,000
Zoning CertificateCAD $150–$300CAD $150–$300Confirm with township
Building permit fee (1,200 sq ft)CAD $1,524CAD $1,524CAD $1,829 est. (Severn)
Development chargesConfirm via DC PamphletConfirm via DC PamphletN/A — township rates apply
LSRCA permit feeN/A (inland lot)CAD $500–$3,000+N/A or confirm
Ontario Land Surveyor (HWM)N/ACAD $2,500–$5,000N/A
Tarion enrollmentCAD $750–$3,000CAD $750–$3,000CAD $750–$3,000
Septic design and SMDHU approvalN/A (municipal sewer)CAD $3,000–$8,000+CAD $3,000–$8,000+
Committee of Adjustment (if required)CAD $1,500–$3,000CAD $1,500–$3,000+Confirm with township

All figures are estimates. Confirm current amounts with each authority before finalising budgets.

The single most impactful variable: the urban Orillia lot’s elimination of the septic column.

Municipal water and sewer connections on a serviced City lot remove CAD $35,000–$80,000 from the site budget that every rural Simcoe County build must carry. This makes an urban Orillia lot materially more cost-efficient at the same factory price point.

For the complete all-in cost framework including verified development charges, foundation costs, utility connections, and HST calculations by lot type, see our prefab home costs Orillia guide.

Inspection Schedule — Stage by Stage

StageWhat Is InspectedTiming
FoundationFooting, foundation walls, waterproofing, drainageBefore backfill; before module delivery
Module placementSet on foundation, structural tie-downs, module connectionsAfter crane set; before interior finishing
Rough-in — electricalWiring, panel, groundingBefore wall closure
Rough-in — plumbingSupply lines, drain/waste/ventBefore wall closure
Rough-in — HVACDuctwork, heat pump mechanical, HRVBefore wall closure
Insulation and air barrierInstallation, building envelope continuityBefore drywall
Final occupancyComplete structural, mechanical, life safetyAfter all finishing

CSA A277-certified units may satisfy certain rough-in stages through factory inspection records — confirm applicable stages with the Building Division at pre-application.

Book the foundation inspection immediately after permit issuance to protect the permit through the factory manufacturing phase.

Six Common Permit Pitfalls — Prefab-Specific Mistakes in Orillia

1. Ordering the module before zoning is confirmed. If a minor variance is required, the Committee of Adjustment adds 4–12 weeks. A module on-site before variance resolution incurs crane standby costs and weather-exposure risk. The factory budget is spent; the permit clock has not started.

2. Assuming CSA A277 certification eliminates the building permit requirement. Factory certification streamlines portions of the plan review. It does not substitute for a City of Orillia building permit. There is no exemption under the Building Code Act, 1992.

3. Missing the LSRCA regulated area flag on a waterfront lot. The City file pauses while the LSRCA application is prepared and processed after the fact. This error routinely adds 3–5 months to a construction timeline that could have been managed in parallel from the start.

4. Not enrolling with Tarion before construction begins. Tarion enrollment must precede construction — not permit issuance, not first inspection. Construction lenders require Tarion confirmation before advancing draw mortgage funds. Missing this step creates a financing gap mid-build.

For the complete construction draw mortgage guide and CMHC eligibility framework, see our prefab home financing Ontario guide.

5. Underestimating development charges at permit pickup. DCs — wastewater CAD $4,791.48 + water CAD $2,231.32 + additional categories — are payable in full at permit issuance. Buyers who have not reserved these funds cannot receive the permit until payment is made, regardless of how far along the build otherwise is.

6. Submitting to the City of Orillia for a lot in Severn or Ramara Township. The City has no jurisdiction over adjacent township lots. Confirm municipal jurisdiction — not just postal code — before engaging any building department.

My Own Cottage — Permit Coordination as a Standard Service

The difference between a theoretical permit pathway and a completed project is execution.

This is what a completed small prefab home looks like once permitting, approvals, and inspections are handled correctly.

Completed My Own Cottage modular prefab home in Orillia area Simcoe County Ontario — real Severn Township build showing full permit coordination including township building permit, CSA A277 certification, and final occupancy

Completed 720 sq ft My Own Cottage modular home in Severn Township — a real build that navigated township permitting, CSA A277 certification, and final inspection to occupancy.

✓ HCRA Registered Builder  |  ✓ Tarion Enrolled — Every Build  |  ✓ CSA A277 Certified Manufacturing

My Own Cottage is physically headquartered in Orillia ON, L3V 7B6 — the only prefab home builder based in Orillia with direct permit office relationships and completed modular builds across the City of Orillia, Severn Township, and Ramara Township.

Permit coordination is a standard part of the turnkey design-to-delivery service.

Site assessment is completed before any factory commitment is made — confirming zoning compliance, LSRCA status, servicing, and development charge exposure before a single dollar is committed to manufacturing.

Every new home build is enrolled in Tarion before construction begins. HCRA registration is verifiable at hcraontario.ca.

The six pitfalls above are handled as standard operating procedure — not discovered mid-project.

Book a free consultation at myowncottage.ca, call us directly or view our design catalogue.

We respond within one business day.

Request a Free Consultation
• Call Us Directly: (705) 345-9337
• View Our Design Catalogue

Alternatively, for your convenience, you can also simply fill out the contact form below and we’ll get back to you soon!

Contact Us

We usually respond within 24 hours!

Frequently Asked Questions — Prefab Home Permits Orillia

What is the building permit fee for a prefab home in Orillia?

The City of Orillia 2025 Permit Fee Schedule (Schedule A) sets the House — Prefabricated rate at $1.27 per square foot — the lowest residential building permit category the City publishes.

For a 1,200 sq ft prefab home, the permit fee is $1,524.00. For a 500 sq ft prefab garden suite at the ADU rate of $1.68/ft², the fee is $840.00.

A minimum fee of $150.00 applies to any application. Confirm current rates with the Building Division at 705-329-7258 before finalising your budget.

Do I need an LSRCA permit in addition to a City of Orillia building permit?

Yes — if your lot is near Lake Couchiching, Lake Simcoe, or any regulated watercourse, wetland, or floodplain in the Orillia area.

The LSRCA permit under O. Reg. 41/24 is a separate approval from the City building permit and must be obtained concurrently with or prior to City permit issuance.

The City requires proof of LSRCA permission as part of its applicable law review. Check regulated area status at lsrca.on.ca before purchasing any Orillia-area waterfront property.

Does a CSA A277-certified modular home still need a City of Orillia building permit?

Yes. CSA A277 certification means factory-stage construction was inspected by a third-party body. It streamlines certain plan review stages and may satisfy some inspection requirements.

It does not substitute for a City of Orillia building permit under the Building Code Act, 1992.

What are development charges in Orillia for a new prefab home?

Development charges are levied under By-law No. 2023-009 (amended 2024-113) and are payable at building permit issuance.

The July 2025 DC Pamphlet sets large residential rates at CAD $4,791.48 for wastewater and CAD $2,231.32 for water, plus additional City and County service categories.

Rates are indexed — confirm the current schedule at permit application time, not during earlier planning.

How long does an LSRCA permit take?

Under O. Reg. 41/24: LSRCA must notify the applicant within 21 days whether the application is complete; the LSRCA has 30 days from deemed-complete date to issue a decision; the permit is valid for up to 60 months once issued.

Submit the LSRCA application simultaneously with the City building permit application to avoid adding these timelines sequentially.

When do I pay development charges in Orillia?

Development charges are payable at building permit issuance — not at application, not at construction start, not at mortgage draw. DC funds in the full amount must be available on the day the permit is issued.

Does Bill 23 affect prefab garden suite permits in Orillia?

Yes. Bill 23 requires Orillia to permit a detached garden suite as-of-right on most urban residential lots.

A prefab modular garden suite qualifies if OBC-compliant and CSA A277-certified.

The permit fee is $1.68/ft² (ADU category). Development charges are fully exempt for the second dwelling unit on an eligible lot. A building permit is still required.

In Severn Township and Ramara Township, detached garden suites are generally not permitted as independent dwelling units — confirm before purchasing any rural lot.

What if my lot is in Severn Township, not the City of Orillia?

The City of Orillia Building Division has no jurisdiction over Severn Township lots. Contact the Severn Township Building Department at [email protected] or 705-325-2315 x246. Fee schedule: CAD $173 base plus CAD $1.38/sq ft.

Detached garden suites are generally not permitted as independent dwelling units in most Severn Township rural zones.

How long is an Orillia building permit valid?

Under the Building Code Act, 1992, a building permit expires if no inspection is requested within any 6-month period during construction.

For prefab builds using the parallel manufacturing model, book the foundation inspection immediately after permit issuance — this single step protects the permit through the factory build phase.

What is the difference between a prefab home and a modular home for permit purposes in Orillia?

In Orillia’s 2025 fee schedule, House — Prefabricated ($1.27/ft²) is the broadest category and captures most factory-built homes including CSA A277-certified modular homes. House — Certified Model ($1.38/ft²) applies to homes built from a plan set previously reviewed and approved by the Building Division.

Both require a City of Orillia building permit — confirm which applies with your builder before submitting.

Does the LSRCA have jurisdiction over prefab home construction in Orillia?

Yes — the Lake Simcoe Region Conservation Authority has direct jurisdiction over waterfront development in the City of Orillia under Ontario Regulation 41/24.

The City of Orillia is a member municipality of the LSRCA watershed. Virtually every waterfront parcel in Orillia — on Lake Couchiching or Lake Simcoe — falls within the LSRCA’s regulated area.

The Severn Sound Environmental Association (SSEA) governs a separate watershed to the northwest and has no permit authority within the City of Orillia.

Confirm your lot’s status at the LSRCA Interactive Regulation Map Viewer before purchasing any Orillia-area waterfront property.

Additional Resources

For the complete Orillia prefab home market overview, see our prefab homes Orillia buyer’s guide.

The small prefab homes Orillia guide covers structure classification, foundation options, Bill 23 garden suite eligibility, and pricing tiers for compact and ADU-scale builds — including the 10 m² exemption rule and OBC minimum size requirements that determine your permit pathway.

For the complete all-in cost picture across all Orillia lot types — including verified development charges, permit fees, foundation costs, utility connections, and HST by lot type — the prefab home costs Orillia guide covers every line item before you commit.

Buyers whose budget or priorities extend into Muskoka will find lot-type cost comparisons, Conservation Authority permit requirements, and Shield bedrock foundation guidance in our prefab homes Muskoka guide.

The provincial framework — CSA A277 certification requirements, Tarion enrollment obligations, and how the Ontario Building Code treats factory-built homes across all municipalities — is documented in our prefab home permits Ontario guide.
