Port Carling cottage builders answer to two authorities. The Township of Muskoka Lakes sets the zoning under By-law 2014-14. The District of Muskoka controls the roads, the locks and seasonal load restrictions.

On a village-core or channel-side waterfront lot, the zone, the staging room and the delivery route decide the plan before any cottage design is chosen.

No fees, no commitment. Just bring your lot details and how you plan to use it.

✓ HCRA Licensed | ✓ Tarion Enrolled

Sean Stevenson, Chief Marketing Officer at My Own Cottage, an Ontario prefab home builder based in Orillia specializing in small prefab homes and modular cottages.

Written by Sean Stevenson, Chief Marketing Officer and Buyer Experience Lead, My Own Cottage Inc.

5 years guiding Ontario buyers • Updated 4 Sept 2026

My Own Cottage Inc. is an HCRA-licensed, Tarion-enrolled prefab home and cottage builder based in Orillia, Ontario. We deliver prefab cottages anywhere in Ontario, and Port Carling sits inside that.

This page covers what a shoreline lot here does to a build:

• The zone it carries

• The review it triggers

• The room it leaves for staging

• Whether a module can reach the placement point

Bring your roll number and a survey if you have one. The site consultation is free, no obligation, and is spent on your lot before anyone talks about a cottage design.

Building elsewhere in the District, or comparing municipalities first? Start with our Muskoka region guide.

KEY TAKEAWAYS
1.

Zoning By-law 2014-14 applies to every property in the Township of Muskoka Lakes, and the zone your lot carries sets what can be built.

2.

A lot near the village core can carry a commercial zone. A lot on the open lake basin does not.

3.

Site plan approval can be required before a building permit is issued, and the Site Plan Control By-law decides which lots that reaches.

4.

Two seasonal windows overlap in spring: District half-load restrictions and the Township’s tree permit blackout.

5.

Muskoka has no conservation authority, so there is no third agency to file with.

What zoning applies to a Port Carling lot?

Zoning By-law 2014-14 is the comprehensive zoning by-law applying to all properties in the Township of Muskoka Lakes. It regulates use, building location, lot coverage and height, so everything a designer can propose on your waterfront lot starts there.

Which zone is your lot in?

Confirm the zone before you commit to a lot. The Township directs owners to the Muskoka Lakes web map, or to the Planning Department for written zoning confirmation, and notes that GIS mapping does not give accurate property dimensions. A registered survey settles frontage and setbacks.

Ask for that confirmation with a date on it. The Township is rewriting the by-law now. The District approved its new Official Plan on November 20, 2023, and section 26(9) of the Planning Act requires the zoning by-law to be brought into conformity. As of the Township’s May 20, 2026 status update, a first draft was in preparation and paused until after the municipal election.

Shoreline setback measurement and the high-water reference are their own subject, covered in our guide to how shoreline setbacks are measured in Muskoka.

What does a village-core lot carry that a basin lot does not?

A core lot can sit in a commercial zone. A Township hearing notice for a property on Lock Street East lists its zoning as Community Commercial – Marina (C2) and Community Commercial – Community (C3). The same notice shows Indian River – Lake Muskoka as a Category 1 River/Lake on Schedule 29 of the by-law.

A commercial zone permits and prohibits different things than a waterfront residential one. Where a proposal does not fit, the route is a minor variance or a rezoning rather than a redesign.

AttributeVillage-core lotOpen-basin waterfront lot
ZoneCommunity Commercial – Marina (C2) or Community Commercial – Community (C3)Waterfront Residential – No Constraints (WR1-7)
Water body classificationIndian River – Lake Muskoka, Category 1 River/LakeLake Muskoka, Category 1
What it means for a buildCommercial permissions and prohibitions; a residential proposal may need a variance or rezoningResidential zone standards apply directly

How does the Indian River channel change a build here?

Channel adjacency adds a layer of review an open-basin lot may not carry. The by-law’s schedules treat the Indian River as its own water body category, and the Township’s site plan control powers reach residential development within 120 metres of an inland lake, wetland, or a river or stream valley.

What is a channel-side lot subject to?

Site plan approval, where it applies, comes before a building permit is issued. Site Plan Control By-law 2006-100 identifies which lakes, zones and proposals are captured. Approval is delegated to staff, and the agreement is registered on title.

Where a variance is needed instead, the Committee of Adjustment hears it, and a minor variance must meet all four tests in section 45(1) of the Planning Act. Hearings run in Council Chambers at 1 Bailey Street, in the village.

What does the bridge and lock schedule mean for your lot?

The District of Muskoka operates the Port Carling locks and the bridge over them. In 2026 the large lock opened May 4 and closes November 29, and lifting the bridge outside normal operating hours is by appointment. If your material route crosses that bridge, the village’s traffic pattern is part of your schedule.

Boathouses and docks are a separate subject, covered in our guide to shoreline structures and their permits.

Which Port Carling lot conditions change the build plan?

Two conditions do most of the work on a shoreline lot here: how much room it leaves beside the building envelope, and what time of year the route to it is open.

How much room does the lot leave for staging?

Laydown room is the constraint owners underestimate on a core lot. A build needs three things at once:

• Somewhere to put materials

• Somewhere for licensed trades to park

• Clear standing ground for a crane on placement day

There is a number attached to it. Under the Township’s Tree Conservation By-law, trees can be cleared to erect a building without a tree permit only within 4.5 metres (15 feet) of the outer edge of the building, structure or septic system. Where the structure sits on a variance to the front-yard or high-water setback, that margin narrows to 3 metres (10 feet). Anything wider is a permit application.

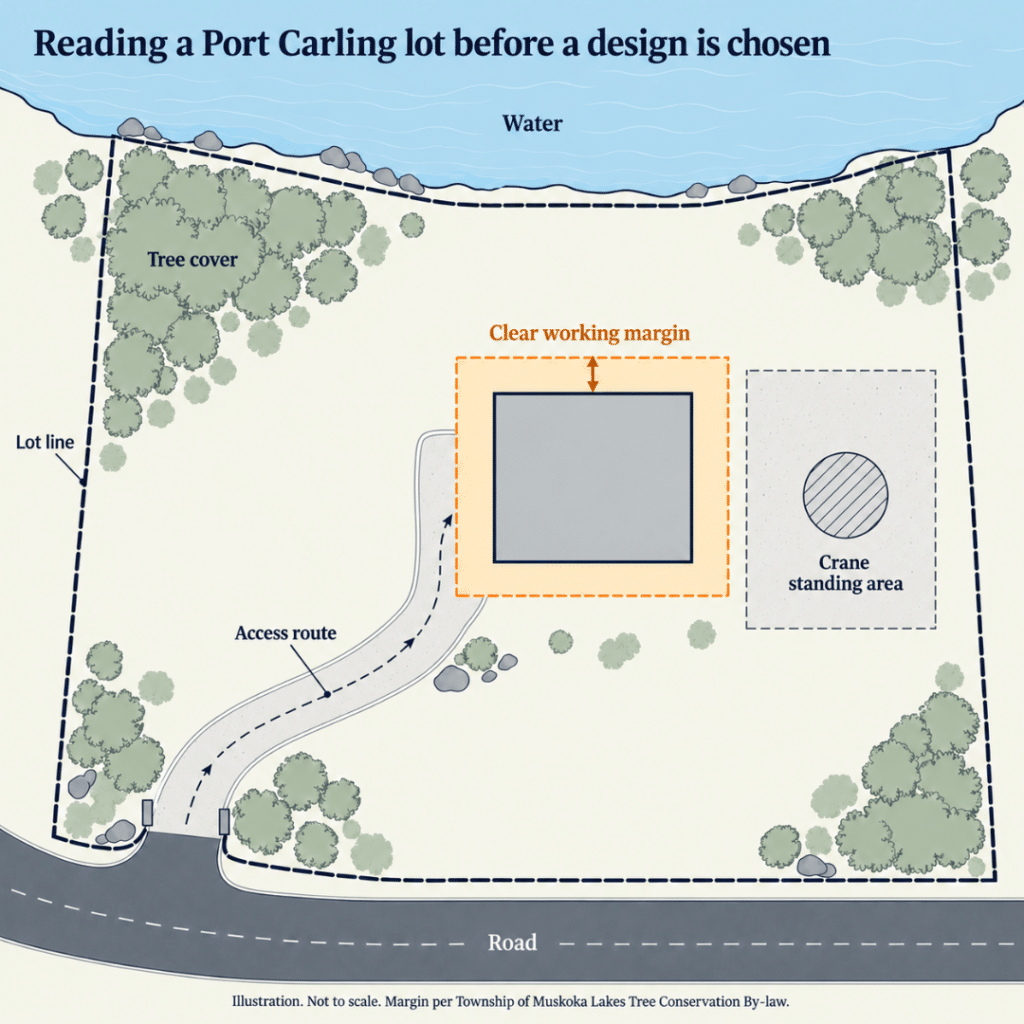

Port Carling Cottage Builders lot-access plan showing the building envelope, clear working margin, access route and crane standing area on a waterfront lot.

Your working margin is set by the Township's Tree Conservation By-law: 4.5 metres, or 15 feet, from the outer edge of the building. Where the structure sits on a setback variance, it narrows to 3 metres, or 10 feet. The crane needs its own ground on top of that.

When is the route open?

Muskoka municipalities apply half-load restrictions each spring to protect roads. When they are in effect, restricted roads are closed to vehicles exceeding 5 tonnes per axle. The restrictions generally run from March to May with exact dates set annually, and in 2026 they were lifted on May 16. Exemptions are not typically granted during that period.

A second window overlaps it. Tree permits are deemed not in effect from March 15 to April 30, with written exemptions at the Director’s discretion. Between the two, spring is the part of the year a Port Carling build plans around rather than through.

Can a module be delivered to your Port Carling lot?

Usually yes, and the route decides it rather than the model. Two waterfront cottages of the same size, one on a District road and one at the end of a shared private drive, are different delivery problems.

Which access route reaches your lot?

Three things decide whether a module arrives whole: route width, overhead clearance and turning radius. A truck that cannot make the turn at the end of a private drive does not get a second attempt, so the route is walked before the build is scheduled.

Excavation into bedrock is its own subject, covered in our guide to excavating into bedrock.

What permits does the move itself need?

An oversize or overweight permit is required year-round for any load exceeding the Ontario Ministry of Transportation’s legislated limits for height, length, width or weight. The District issues those for District roads. Load restrictions on District roads are set out in by-law and mapped on the District’s GeoHub.

Where does the crane sit?

A crane needs firm, level ground within reach of the placement point and a clear swing path. On a tight core lot that standing area is often the deciding constraint, so placement is planned against the survey before a foundation is designed.

Foundations and site preparation as a construction method sit outside this page, in our process and education material.

Send the lot address and we will walk the route, the turn and the crane ground before you commit to a model.

What changes on a water-access Port Carling lot?

The route does. An island lot is reached by barge and then by a single temporary access road, so landing and haul replace width and turning radius.

What access road is permitted on a water-access lot?

The Township’s Tree Conservation By-law exempts one temporary access road, no wider than 4.5 metres (15 feet), on a property accessible only by water. The by-law also requires that road to be re-vegetated once the building or septic permit is complete, so it is temporary work with a restoration obligation attached, not a driveway.

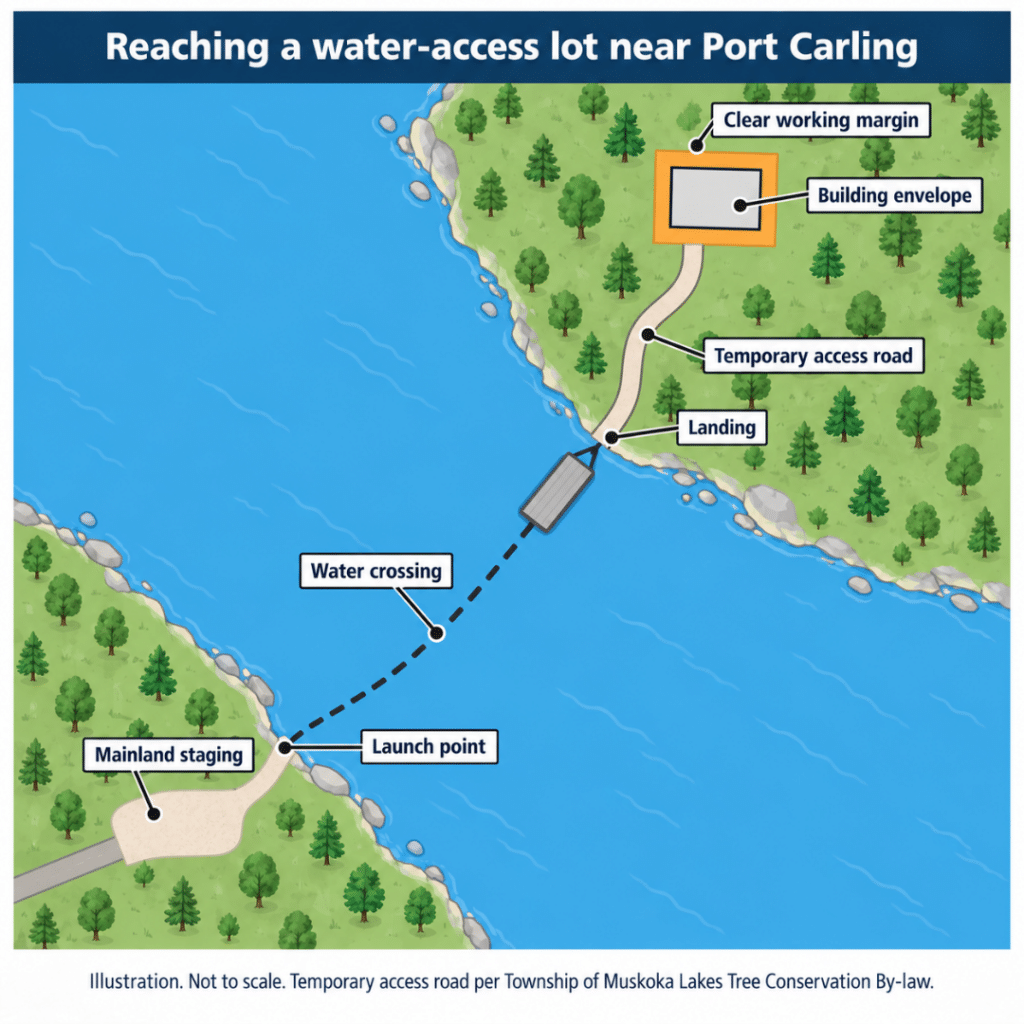

Port Carling Cottage Builders water-access lot diagram showing mainland staging, a barge crossing, shoreline landing, temporary access road and building envelope.

Reaching an island lot is four moves: stage on the mainland, cross by barge, land, then one temporary access road up to the building. The by-law allows a single road no wider than 4.5 metres, or 15 feet, and it has to be re-vegetated once the building or septic permit is complete.

Can we deliver to your water-access lot?

Yes, with a crossing in between. A module cannot drive to an island, so the water leg goes by barge.

What the crossing involves depends on the lot: the launch point, the distance, and what the landing will take. That is worked out with the route walk and the crane siting, before a build is scheduled.

Who signs off a Port Carling build?

Two municipal bodies, each with a different list, and no third one.

What does the Township of Muskoka Lakes decide?

The Township decides zoning. Its office is at 1 Bailey Street in the village.

DecisionWho makes it
Minor variances and consentsCommittee of Adjustment
Zoning by-law amendmentCouncil, after a Planning Committee meeting
Site plan approvalDelegated to staff
AppealsOntario Land Tribunal

Before you buy, a Municipal Record Search returns the zoning designation, permitted uses, planning approvals, issued building permits and any outstanding orders on a property. It runs against a roll number and takes up to 10 to 15 business days.

Building permit sequencing is covered in our guide to the permit process for a prefab build in Muskoka.

What does the District Municipality of Muskoka control?

The District controls the District road network, road permits including oversize and overweight moves, seasonal load restrictions, and the Port Carling locks and bridge. It also approved the Township’s Official Plan.

There is no third body. The District describes Muskoka as an area without a conservation authority and handles regional environmental matters itself. A Port Carling owner is not filing a separate conservation authority permit the way an owner one district south would.

Septic sizing and approval is a separate subject, covered in our guide to how septic capacity is sized and approved here.

What drives the quote on a Port Carling lot?

The lot drives it. Named as drivers, not as figures, because the numbers belong to your survey and your zone.

Which lot conditions add scope?

Six things:

• Whether the proposal fits the zone or needs a variance

• Whether site plan approval is triggered

• What the ground is

• How the lot drains

• Waterfront access

• The season the move happens in

If cost predictability is part of why you are looking at prefab, the lot is still the variable. What a cottage costs to build in Muskoka, in figures, is covered on our Muskoka cost page rather than here.

What does a model price cover, and what is separate?

A preconfigured model price covers the structure and its delivery. Turnkey finishing, foundation, site preparation, servicing, permits and municipal charges are separate and are quoted against your lot.

Foundation, site preparation and servicing are carried out by licensed-trade installation affiliates — contracted rather than employed — quoted separately and set in the agreement before the build. My Own Cottage helps with municipal permits.

What does a site consultation cover?

Four things: the zone your lot carries, the review a proposal would trigger, the access route and crane standing room, and what the municipal coordination looks like from there.

Delivery coordination and installation coordination follow from that assessment, not from the model you pick.

Port Carling Cottage Builders consultation with My Own Cottage staff and prospective buyers discussing a prefab cottage project at the Orillia facility.

A first consultation at our Orillia facility, 12 Lankin Blvd #3. It covers your lot, how you intend to use the cottage, and your timeline. No fee, no obligation.

A consultation tells you what the lot allows. A scoped quote puts the model price and the site work in two separate columns for your lot.

How do Port Carling cottage builders differ from one another?

Four kinds of firm quote custom homes, waterfront cottages and seasonal homes on a lot here, and they are not quoting the same thing. Read a quote for what it covers before you read it for its number.

Which kinds of firms quote a build here?

Firm typeWhat it bringsWhat you coordinate
Site-built custom cottage builderCustom design, drafting, project management and construction on the lotLittle; most of it sits with the builder
Excavation and site services contractorSite preparation, concrete work, foundations, road building and driveway buildingThe building itself, its approvals and permit coordination
Prefab supplierA building delivered to the siteSite work, municipal coordination and installation coordination
Prefab builder that coordinatesThe building, plus delivery coordination scheduled against site work and approvalsLess, but the site trades are contracted separately

Where do modular cottages help on a lot like this?

On a lot with no laydown room, the useful thing about modular cottages is that most of the assembly is not happening on the lot. Fewer trades on site, less stored material, less heavy traffic through a village street.

The trade-off is concentration. One day has to work: the route, the turn, the crane and the placement, which is why the access assessment comes before the design is finalised.

You now know which kind of builder we are. See what a preconfigured model actually is.

Lake Muskoka, Lake Rosseau and Lake Joseph lots have their own pages: lots on the main lake and lots on Rosseau. Smaller prefab cabins and bunkies are covered in our guides to smaller prefab builds in Muskoka and bunkies and secondary structures.

How we verified this page

ClaimSourceDate checked
Zoning By-law 2014-14 applies to all properties in the TownshipTownship of Muskoka Lakes, PlanningSeptember 4, 2026
Site plan control reaches residential development within 120 metres of an inland lake, wetland, or river or stream valley; By-law 2006-100 sets which lotsTownship of Muskoka Lakes, PlanningSeptember 4, 2026
A Lock Street East property zoned Community Commercial – Marina (C2) and Community Commercial – Community (C3); Indian River – Lake Muskoka as Category 1 River/Lake, Schedule 29Township of Muskoka Lakes, Committee of Adjustment notice A-28/25September 4, 2026
Official Plan approved November 20, 2023; comprehensive zoning by-law update paused until after the municipal election as of May 20, 2026Engage Muskoka Lakes, Township project pageSeptember 4, 2026
Tree clearing to erect a building exempt only within 4.5 m (15 ft) of the structure, 3 m (10 ft) with a setback variance; one temporary access road up to 4.5 m (15 ft) on water-access-only property, subject to re-vegetation; permits not in effect March 15 to April 30Township of Muskoka Lakes, Tree Conservation By-law 2022-107, ss. 3.2(d), 3.2(e), 3.2(k), 4.4, 9.2September 4, 2026
Half-load restrictions generally March to May, 5 tonnes per axle, lifted May 16 in 2026; oversize or overweight permit required year-roundDistrict Municipality of Muskoka, Load RestrictionsSeptember 4, 2026
District operates the Port Carling locks and bridge; 2026 large lock season opened May 4, closes November 29District Municipality of MuskokaSeptember 4, 2026
Muskoka is an area without a conservation authorityDistrict Municipality of Muskoka, Environmental InitiativesSeptember 4, 2026
My Own Cottage HCRA licence status and Tarion enrolment, searchable by company nameOntario Builder DirectorySeptember 4, 2026

Port Carling cottage builder FAQs

Do I need a minor variance to build on a Port Carling lot?

A minor variance is required only where the proposal does not meet the zone the lot carries under Township of Muskoka Lakes Zoning By-law 2014-14. Minor variances are decided by the Township’s Committee of Adjustment and must meet all four tests in section 45(1) of the Planning Act. Confirm the zone in writing before design work starts, because a variance adds a hearing to the schedule.

How close to the cottage can trees be cleared without a permit?

Trees can be cleared within 4.5 metres, or 15 feet, of the outer edge of the building, structure or septic system under the Township of Muskoka Lakes Tree Conservation By-law. Where the structure sits on a variance to the front-yard or high-water setback, that margin is 3 metres, or 10 feet. Wider clearing needs a tree permit, and the by-law’s metric measurement governs.

Can a module be craned onto a lot near the village core?

Craning a module onto a Port Carling village-core lot depends on three things: whether the route reaches the lot at legal width and turning, whether there is firm level ground for the crane within reach of the placement point, and the season. District of Muskoka half-load restrictions close roads to vehicles over 5 tonnes per axle, generally March to May with dates set annually — in 2026 they lifted on May 16.

Can a cottage be delivered to an island lot near Port Carling?

Yes. A module cannot drive to an island, so the water leg goes by barge, and what the crossing involves depends on the launch point, the distance and the landing. On the lot itself, the Township’s Tree Conservation By-law exempts one temporary access road no wider than 4.5 metres, or 15 feet, on a property accessible only by water, subject to re-vegetation once the building or septic permit is complete.

Who does the site work on a Port Carling build, and what is turnkey?

Foundation, site preparation and servicing are carried out by licensed-trade installation affiliates — contracted, not employees — quoted separately against your lot and set in the agreement before the build. My Own Cottage helps with municipal permits. A preconfigured model price covers the structure and its delivery; turnkey finishing, permits and municipal charges are quoted separately.

What does a custom cottage builder quote that a prefab builder does not?

A site-built custom cottage builder generally quotes design and construction together on the lot. A prefab quote covers the structure and its delivery, with foundation, site preparation, servicing, permits and turnkey finishing quoted separately against the lot. Compare the two on what sits inside the number, not on the number alone.

What is the first step on a Port Carling lot?

A zoning confirmation, a survey and a look at the access route. Bring those three to a free site consultation and you will leave knowing what is buildable, what needs a hearing, and what delivery day requires.

Start with the lot

Port Carling cottage builders can only quote what the lot allows. Send the address and we will tell you what it allows before anyone talks about a design.

My Own Cottage Inc. · 12 Lankin Blvd #3, Orillia, ON L3V 7B6 · 1 (705) 345-9337 · [email protected]

Book a free consultation.

MY OWN COTTAGE

Contact Us

We usually respond within 24 hours!

DIRECT ENQUIRIES

About the Author

Sean Stevenson, Chief Marketing Officer at My Own Cottage, an Ontario prefab home builder based in Orillia specializing in small prefab homes and modular cottages.

Sean Stevenson is Chief Marketing Officer and Buyer Experience Lead at My Own Cottage Inc., an HCRA-licensed, Tarion-enrolled prefab home and cottage builder based in Orillia, Ontario.

For five years he has worked alongside the company’s build team, guiding Ontario buyers through the prefab cottage process: lot assessment, budgeting beyond the model price, zoning and permits, development charges, and final occupancy. His focus is the part most buyers underestimate — what a prefab cottage costs to complete once foundation, servicing and approvals are added to the model price.

© 2026 All rights reserved.
