Prefab Homes Muskoka: The Complete 2026 Guide to Building in Cottage Country
Last updated: May 31st, 2026
Written by building specialists at My Own Cottage
Why Muskoka Makes Prefab the Smarter Choice
Prefab homes in Muskoka offer a strategically specific advantage over traditional site-built construction — not as a generic cost-cutting measure but as the building method best matched to the region’s defining site challenges.
Canadian Shield bedrock, water-access-only lots, Conservation Authority shoreline requirements, and Muskoka’s compressed six-month building season all favor factory-built construction in ways that no other Ontario market does.
Most prefab guides tell you factory-built homes are faster and more consistent than site-built.
That is true everywhere. What those guides miss is that Muskoka specifically — its geology, its lakes, its conservation regulations, and its building season — makes prefab the strategically superior building technique in ways that have nothing to do with general construction efficiency.
The image below reflects a real Muskoka condition — a prefab home designed and installed directly on granite terrain, where engineering decisions are driven by the site from the very beginning.
A completed prefab home on a Muskoka lakefront lot — where Canadian Shield bedrock, waterfront setbacks, and real site conditions define how the build is engineered from day one.
For buyers planning a new home or Muskoka cottage in cottage country, the advantages of prefab homes in Ontario are not generic.
They are specific to this terrain, these lakes, and these building codes.
Four site realities define every Muskoka building project. My Own Cottage’s prefab construction model addresses all four better than traditional site-built methods do.
We build OBC compliant prefab homes across Muskoka and cottage country Ontario — from compact lakeside bunkies to spacious year-round family homes — delivered directly to your lot with complete site assessment before any commitment is made.
Most Muskoka buyers discover site surprises after signing. We find them before.
Canadian Shield Bedrock — The Cost Comparison That Changes the Decision
Muskoka sits squarely on the Precambrian Shield.
Exposed or near-surface bedrock is encountered on the majority of waterfront lots, and that geology creates the foundation challenge that most first-time Muskoka buyers discover after purchasing land rather than before.
Conventional basement excavation on Shield rock frequently requires mechanical cutting or blasting — adding CAD $30,000 to $80,000 or more to a project before a single foundation element is placed.

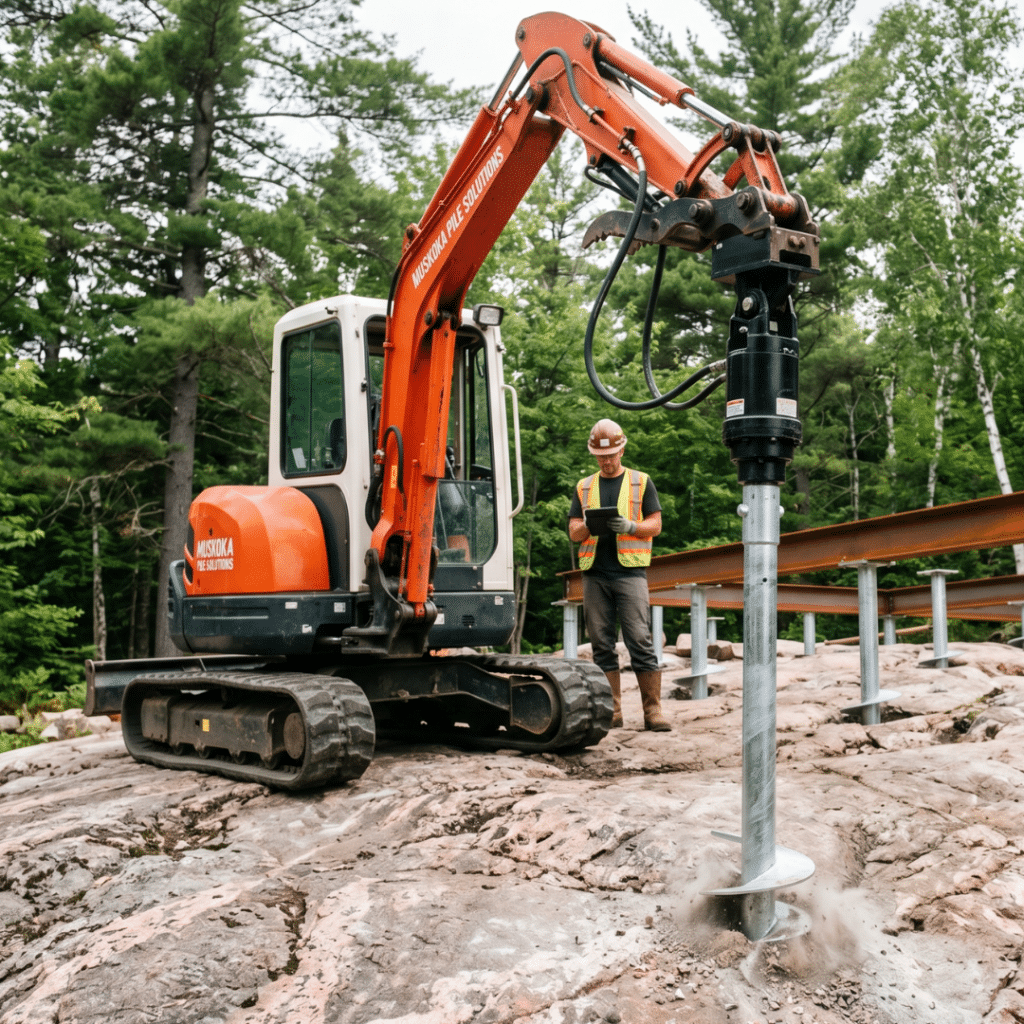

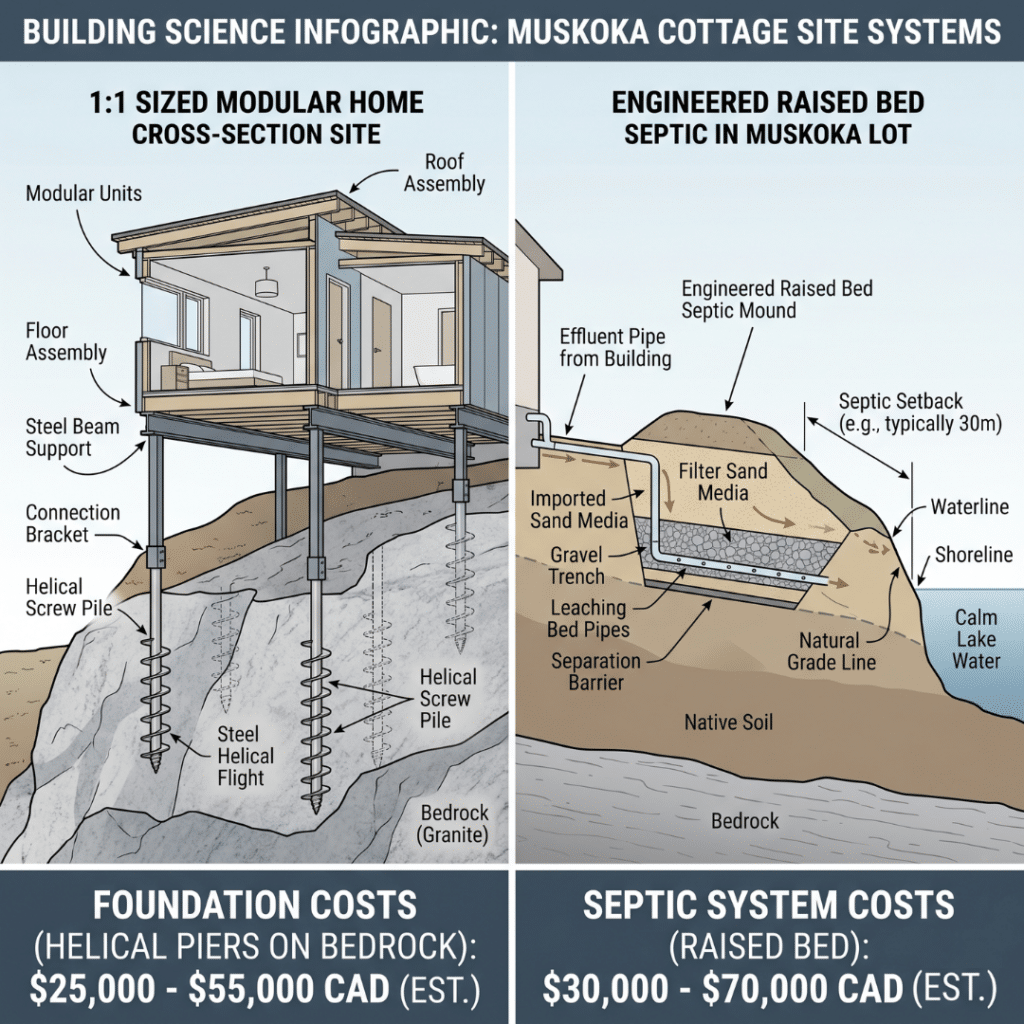

The alternative is helical piers — steel screw piles hydraulically driven into bedrock-adjacent soils or keyed directly into rock with grout.
Helical pier foundations on Canadian Shield bedrock eliminate excavation — typical cost CAD $10,000–$25,000 vs. $30,000–$80,000 for blasted or excavated foundations on Muskoka lots.
Want to know which foundation type works for your specific lot? We’ll confirm it before any design is selected.
No excavation. No concrete forms. No spoil removal.
Pier heads adjust in height to create a level bearing surface across uneven granite outcrops, and modules can be set the same day piers are installed with no concrete cure time.
A standard Muskoka modular home requires six to sixteen helical piers at CAD $800 to $1,800 per pier — total foundation cost CAD $10,000 to $25,000.
That is the comparison that changes the decision: CAD $10,000 to $25,000 for a helical pier system versus CAD $30,000 to $80,000-plus for bedrock excavation — with the pier system producing less site disturbance and enabling faster module installation on the same day.
My Own Cottage’s modular homes are engineered to sit on exactly this kind of adjustable pier bearing surface.
The structural frame transfers loads to a steel bearing beam distributed across the pier grid — making Muskoka’s irregular bedrock topography a solvable engineering problem rather than a prohibitive site cost.
Water-Access-Only Lots — One Delivery vs Months of Material Transport
Approximately 15 to 20 percent of Muskoka waterfront properties are accessible only by boat, floatplane, or snowmobile.
For these lots, traditional site-built construction means barge delivery of every individual material across the entire build duration — lumber, insulation, roofing, windows, mechanical components, and trades equipment moving on and off the property for months.
My Own Cottage’s modular approach changes that equation entirely — and the best part is what it does not require.

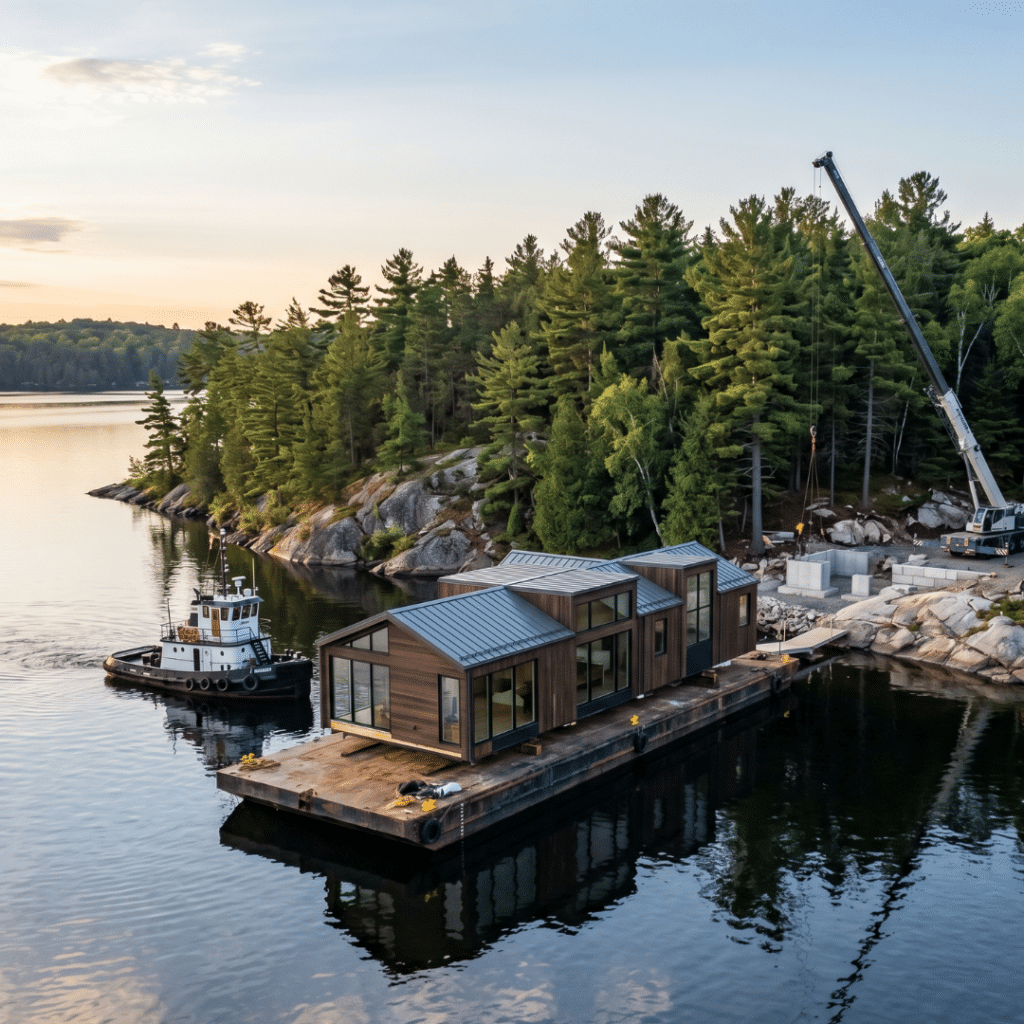

A nearly-complete prefab home can be transported by barge and crane-set onto a prepared helical pier foundation with near-zero terrestrial site disturbance.
One marine delivery. One crane day.
A nearly-complete high-quality product placed on a foundation with minimal disruption to the shoreline vegetation that Conservation Authority regulations protect.
This is not theoretical.
Water-access modular delivery to Muskoka waterfront lots follows a documented engineering process used by experienced prefab builders across Ontario’s cottage country.
A completed modular home delivered by barge across Lake Muskoka — one transport replaces months of material deliveries to a water-access-only lot.
On water-access-only Lake Muskoka properties — where road-based heavy equipment cannot reach the shoreline — prefab is often the only construction method that is genuinely practical.
A nearly-complete modular unit shipped in by boat and crane-set onto a prepared foundation in a single day produces less shoreline disturbance, less ecological impact, and less logistical complexity than months of sequential material deliveries on a remote waterfront lot.
My Own Cottage’s site assessment process confirms water access delivery logistics for every Muskoka project before any design commitment is made.
Water-access barge delivery adds CAD $30,000 to $80,000 to the project budget — incurred once rather than across months of sequential material deliveries.
Building on a water-access lot? We’ve delivered to them. Let’s talk about yours.
Conservation Authority Requirements — Minimal Site Disturbance as a Permit Advantage
Under Ontario Regulation 179/06 administered under the Conservation Authorities Act, any development within a regulated area — typically a 30-metre buffer from a shoreline, wetland, or floodplain — requires a Section 28 permit from the applicable Conservation Authority in addition to the municipal building permit.
Conservation Authority reviewers assess shoreline vegetation disturbance, fish habitat impacts, and stormwater management.
My Own Cottage’s crane-set modular installation — completed in a single day on pre-installed piers — disturbs a fraction of the ground that months of on-site framing, trade vehicle traffic, and material staging requires.
This minimal disturbance footprint is a huge advantage in Conservation Authority permit applications that My Own Cottage can quantify for every Muskoka build.
Initiate the Conservation Authority application simultaneously with the municipal building permit application — never sequentially.
Processing times range from four to sixteen weeks, and complex shoreline properties may require a Natural Heritage Evaluation adding CAD $5,000 to $25,000 to the soft cost budget.
For the complete Conservation Authority permit framework — including Section 28 application triggers, processing timelines by township, and how to prevent the CA review from becoming the critical path delay that costs you a full Muskoka build season — see our complete permit framework for Muskoka builds.
Muskoka’s Six-Month Building Season — Why Parallel Manufacturing Eliminates Timeline Risk
Muskoka’s practical on-site building window runs from approximately late April to early November.
Spring road weight restrictions — enforced annually from late February through April on Ontario municipal roads — restrict heavy equipment access during the critical foundation period.
Early snowfall compresses the assembly window at the other end of the season.
Traditional site-built construction loses weeks within that window to rain delays, frost events, and trade scheduling gaps.
My Own Cottage’s factory-built homes are manufactured in a controlled environment completely unaffected by Muskoka weather.
The quick build time advantage that prefab delivers in cottage country is not simply speed — it is predictability.

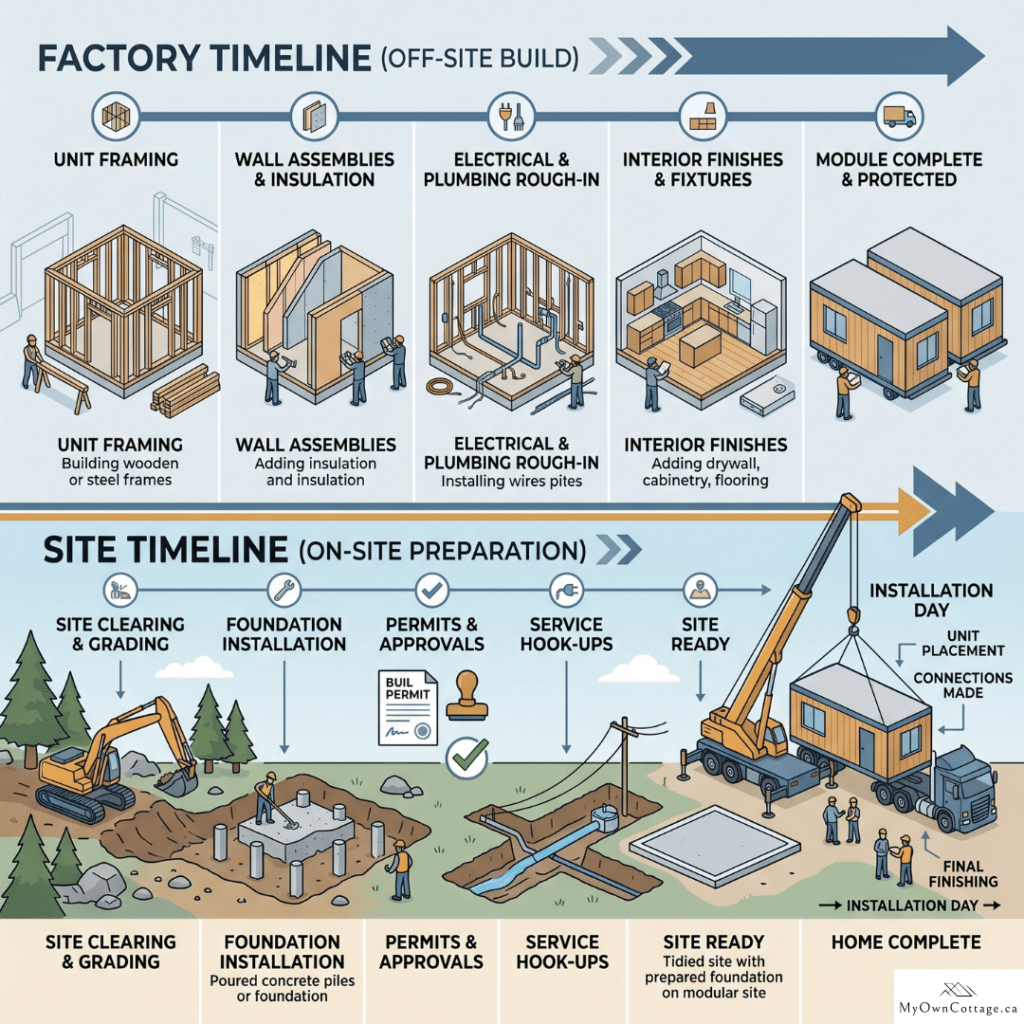

Modules are built indoors while site preparation, foundation installation, and Conservation Authority approvals proceed simultaneously on your lot.
Prefab construction in Muskoka runs on a parallel timeline — your home is built in a controlled factory environment while site preparation, foundation installation, and permits progress simultaneously, converging on a single installation day.
See how the parallel build model maps to your Muskoka lot and target occupancy date.
That is the parallel build model that compresses Muskoka construction time — not any single phase running faster than traditional construction, but two phases running at the same time.
For project managers and buyers who have experienced the frustration of losing an entire cottage season to weather delays and trade scheduling conflicts, this is the single most compelling operational advantage that prefab construction offers in Northern Ontario.
→ Prefab Homes Ontario — complete overview │ → External link: More Homes Built Faster Act
Which My Own Cottage Prefab Home Works Best on Your Muskoka Lot?
Not all prefab construction methods perform equally in Muskoka’s physical and regulatory environment.
Understanding which type of build suits your unique needs — based on access route, terrain, setback constraints, and intended use — is the starting point for every My Own Cottage Muskoka project.
Our team guides you through every step of the way from first site assessment through occupancy permit.
Full Modular — Maximum Factory Completion, CSA A277 Certified
My Own Cottage builds every home as fully enclosed three-dimensional modules in a climate-controlled manufacturing facility — complete with framing, insulation, vapour barrier, electrical rough-in, plumbing rough-in, and often interior finishes including flooring, cabinetry, and fixtures.
Modules arrive substantially complete and are crane-set onto a prepared foundation, where they are joined and finished on site.
A completed My Own Cottage prefab home being installed on a Muskoka waterfront lot — delivered as a near-finished modular structure with interiors completed in the factory and placed by crane onto a prepared Canadian Shield foundation.
Every My Own Cottage home is built in a CSA A277 certified manufacturing facility — the Canadian Standards Association’s factory certification standard confirming that the quality management systems, engineering processes, and construction methods used to build your home consistently meet Ontario Building Code requirements.
This certification matters in Muskoka specifically because area municipalities have limited building inspection capacity.
CSA A277 factory inspection records substitute for many on-site inspection visits — a significant scheduling advantage when municipal inspectors are traveling to remote shoreline lots.
Your local building inspector can focus their Muskoka visits on site-specific work that the factory inspection has already addressed.
The build quality achievable in a factory environment — where every trade works in dry, climate-controlled conditions with complete material access and no weather delays — consistently exceeds what is possible on a remote Muskoka jobsite.
Our modular platform produces a tighter building envelope, more consistent insulation installation, and higher overall finish quality than conventional site-built construction in cottage country conditions.
Our Muskoka-ready home designs range from the compact Modern Living at 718 square feet to the Titan at 3,660 square feet.
Every model is engineered for delivery to Muskoka lots including water-access properties. Every model is available as a custom home adapted to your specific lot and lifestyle requirements.
The Most Important Decision — Seasonal or Four-Season?
This single specification decision determines your insulation requirements, foundation type, heating system, water system, Ontario Building Code classification, Tarion warranty coverage, and mortgage financing eligibility.
It is the decision most inadequately addressed by every current Muskoka prefab resource — and the one that most consistently produces buyer surprises when it is made after signing a contract rather than before.
Muskoka falls within Climate Zone 6 to 7 under the National Energy Code of Canada and Ontario’s Supplementary Standard SB-12.
Four-season occupancy under the Ontario Building Code requires a materially different building envelope from a seasonal cottage.
The comparison below illustrates how building envelope design, insulation levels, and heating systems translate into real-world comfort and year-round usability.
Seasonal vs four-season prefab homes in Muskoka — summer-use cottages compared with fully insulated year-round homes designed for -30°C winter conditions, higher R-value building envelopes, and comfortable four-season occupancy.
We provide four-season specifications — including R-28 to R-40 spray foam packages — across our full Muskoka model range.
Floor plans, specs, and pricing included!
This requires an extremely high level of design attention to thermal bridging, air barrier continuity, and mechanical system sizing that varies significantly between the two classifications.
| Specification | Seasonal Cottage | Four-Season Home |
|---|---|---|
| Above-grade wall insulation | R-12 to R-16 typical | R-20 to R-24 OBC minimum; R-28 to R-40 high-performance |
| Ceiling / attic insulation | R-20 to R-30 typical | R-40 to R-60 OBC requirement |
| Floor / underfloor insulation | Basic | R-20 minimum — critical on helical piers |
| Foundation type | Concrete piers acceptable | ICF or frost-wall below 1.2m frost depth |
| Heating system | Propane or electric baseboards | Rated for -30°C; heat pump, forced air, or in-floor |
| Water system | Seasonal lake intake or drainable | Drilled well; heat-traced lines; year-round pressurized |
| OBC classification | Part 9 seasonal dwelling | Part 9 residential — full compliance |
| Tarion coverage | Conditional | Standard 1-2-7 coverage applies |
| CMHC financing | Restricted | Eligible with CSA A277 and permanent foundation |
CMHC mortgage insurance eligibility applies to CSA A277 certified prefab homes on permanent foundations — confirm current eligibility requirements with your lender at CMHC mortgage insurance for factory-built homes.
My Own Cottage provides four-season specification options — including spray foam insulation packages targeting R-28 to R-40 walls for energy efficiency in Muskoka’s winters — across our complete model range.
Confirm whether you are building for seasonal or year-round use at your first consultation. This single decision shapes every subsequent design concept and engineering choice for your property.
For buyers specifically evaluating a recreational or investment cottage rather than a primary residence — including the Tarion seasonal exclusion, By-law 2025-049 STR licensing, and cottage mortgage financing — see our complete prefab cottages in Muskoka investment and build guide.
What a My Own Cottage Prefab Home in Muskoka Actually Costs
The single most damaging misconception in Muskoka prefab planning is treating the factory price as the project budget.
Every Muskoka build has two budgets. The factory budget covers what My Own Cottage manufactures and delivers to your lot.
The site budget covers everything required to legally place, connect, finish, and occupy your living space on your specific Muskoka property.
Every Muskoka prefab home has two budgets — the factory price and the site cost — combined into a single all-in build total.
In Muskoka’s site conditions, the site budget is consistently higher than on a standard Southern Ontario build.
My Own Cottage provides honest all-in cost estimates covering both budgets for your specific property at the first consultation — before any model is selected and before any commitment is made.
Peace of mind begins with complete cost transparency, not base-price marketing.

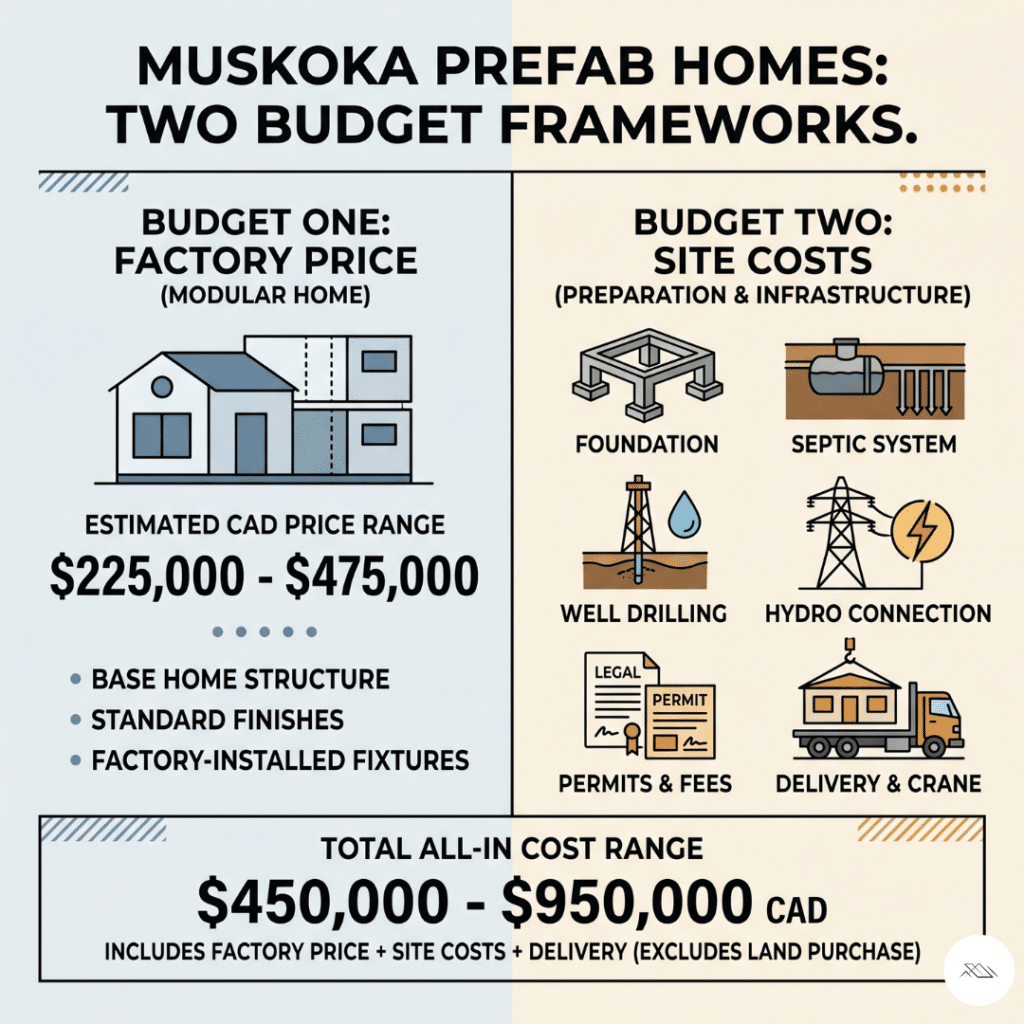

Budget One — My Own Cottage Factory Pricing
Named price anchors from our current Muskoka catalogue:
• My Own Cottage Modern Living: 718 square feet — compact entry-level reference for a small sleeping cabin or secondary dwelling
• My Own Cottage Orchard: 992 square feet, starting at CAD $289,500 — mid-range reference
• My Own Cottage Blissful Bay: 1,381 square feet — family cottage reference
• My Own Cottage Muskoka model: 2,707 square feet — larger family home reference with full living room, kitchen, and multiple bedroom configurations
Factory price ranges by tier: compact entry-level CAD $150,000 to $250,000; mid-range 1,000 to 2,000 square feet CAD $250,000 to $450,000; large custom builds CAD $450,000 to $650,000-plus.
FOB pricing delivers your home package to your site but excludes all foundation work, site preparation, servicing, and permits.
Budget Two — The Muskoka Site Budget
Every My Own Cottage Muskoka project requires a site budget calibrated for Muskoka’s specific conditions.
These costs are consistently higher than on a standard Southern Ontario prefab build due to rocky terrain, remote lot access, engineering requirements, and Conservation Authority oversight.

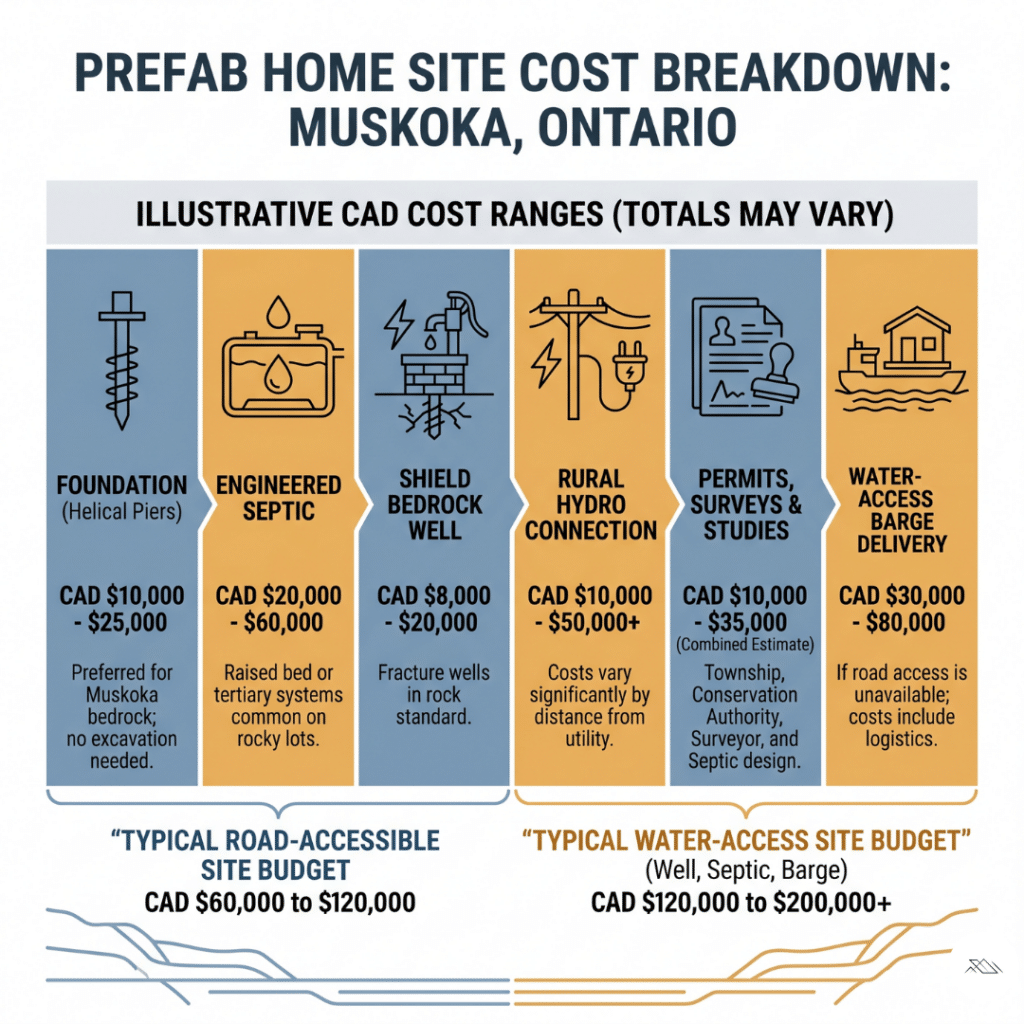

| Site Cost Component | Typical Muskoka Range | Muskoka-Specific Notes |
|---|---|---|
| Site clearing and grading | $5,000–$30,000 | Higher on forested or sloped Shield lots |
| Helical pier foundation | $10,000–$25,000 | Preferred for bedrock; no excavation required |
| ICF perimeter foundation (four-season) | $35,000–$80,000 | Full perimeter for year-round occupancy |
| Engineered septic system | $20,000–$60,000 | Raised bed or tertiary systems common on rocky lots |
| Well drilling — Shield bedrock | $8,000–$20,000 | Fracture wells in rock standard |
| Hydro connection rural Muskoka | $10,000–$50,000+ | Hydro One remote connection costs vary by distance |
| Water-access barge delivery | $30,000–$80,000 | If road access is unavailable |
| Conservation Authority permit and studies | $2,000–$25,000 | Base fees plus environmental studies if required |
| Municipal building permit Muskoka | $3,500–$12,000 | Varies by township and project complexity |
| Ontario Land Surveyor — high-water mark | $2,500–$6,000 | Required before any site plan on waterfront lots |
| Licensed Septic Designer fees | $3,000–$8,000 | Mandatory for Part 8 OBC compliance |
Total site budget on a road-accessible serviced Muskoka lot: CAD $60,000 to $120,000.
Total on a water-access-only lot requiring well, septic, and barge delivery: CAD $120,000 to $200,000 or more.
For a province-wide breakdown of delivered-and-installed home costs, site preparation expenses, development charges, and financing considerations, see our complete guide to prefab homes Ontario prices.
For reference, the breakdown below shows how foundation, septic, well, hydro, permits, and delivery combine into a complete Muskoka prefab site budget.
A transparent breakdown of Muskoka site costs for prefab homes — including foundation, septic, well, hydro, permits, and delivery — showing how the site budget contributes to total project cost beyond factory pricing.
The site budget is where most Muskoka builds become unpredictable — but it doesn’t have to be. Every project follows the same core cost structure.
All-In Muskoka Turnkey Range
Road-accessible serviced Muskoka lot with a mid-range My Own Cottage home: CAD $350,000 to $600,000 all-in excluding land.
Water-access-only lot with full servicing: CAD $450,000 to $900,000 or more depending on site complexity and model selection.
The Muskoka premium over a comparable Southern Ontario prefab build — attributable specifically to site complexity — typically runs CAD $50,000 to $150,000.
For verified all-in cost scenarios organized by lot type — road-accessible, waterfront bedrock, and water-access-only — see our complete Muskoka prefab home prices guide.
For buyers focused on the most cost-efficient path to Muskoka ownership — including the five specific decisions that determine whether your all-in build lands at CAD $290,000 or CAD $700,000 on the same factory model — see our complete guide to affordable prefab homes in Muskoka.
Soft Costs That Consistently Surprise First-Time Muskoka Buyers
Four professional fees add CAD $15,000 to $50,000 to Muskoka projects that buyers consistently omit from initial estimates.
• Ontario Land Surveyor for formal high-water mark establishment: CAD $2,500 to $6,000
• Geotechnical engineer for bedrock assessment: CAD $3,000 to $8,000
• Licensed Septic System Designer: CAD $3,000 to $8,000
• Natural Heritage Evaluation when Conservation Authority requires it: CAD $5,000 to $25,000
HST applies to new home construction and course-of-construction insurance is required during the build period — neither is optional and neither is typically included in factory price quotations.
My Own Cottage’s site assessment confirms all applicable soft costs for your specific property before any contract is signed — giving you the full Muskoka site cost framework to ensure there are no surprises after commitment.
→ Cost of Prefab Homes Ontario — complete pricing guide │ → Prefab Home Financing Ontario — construction mortgage guide
Muskoka’s Regulatory Environment — What My Own Cottage Confirms Before Any Build Begins
The layered regulatory environment governing Muskoka waterfront development is one of the most commonly misunderstood aspects of any Muskoka prefab project — and one of the top sources of delay, cost overrun, and post-purchase regret.

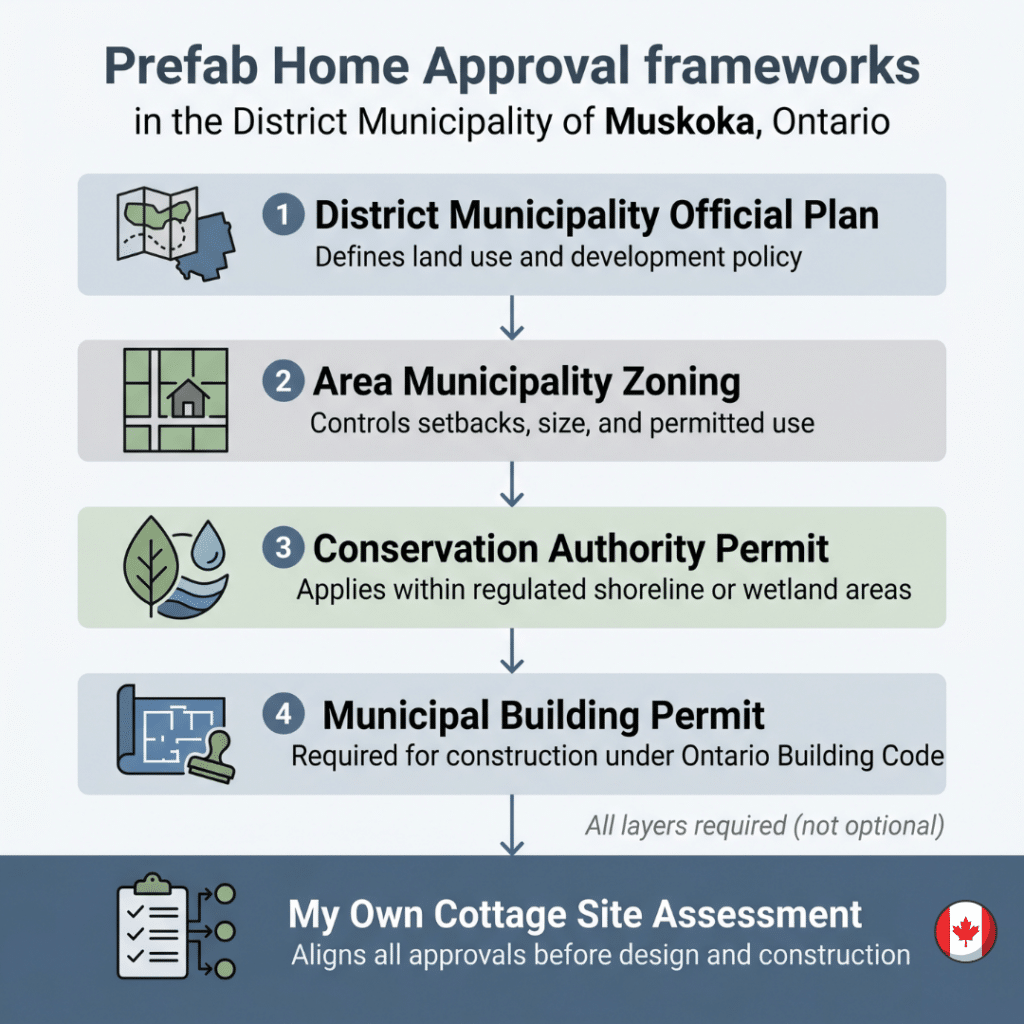

Every Muskoka build must pass through four distinct regulatory layers — planning, zoning, environmental, and building — each enforced by a different authority and all required in parallel.
Building in Muskoka requires four layered approvals — planning, zoning, environmental, and building — all managed together through a single coordinated process.
My Own Cottage’s site assessment process addresses every regulatory layer for your specific property — and every applicable building code requirement — before any design selection is made.
The District Municipality of Muskoka Official Plan
The District Municipality of Muskoka administers the upper-tier Official Plan that sets the policy framework for all six lower-tier area municipalities.
Key provisions affecting every My Own Cottage Muskoka project include:
Shoreline setbacks: Principal structures are generally required to be set back a minimum of 20 to 30 metres from the high-water mark depending on the area municipality’s zoning bylaw.
The high-water mark must be formally established by a licensed Ontario Land Surveyor — it is not estimated from current water level. Structures placed even slightly within the setback zone are subject to stop-work orders.
Near-shore zone lot coverage: Within the first 60 metres from the high-water mark, total lot coverage by buildings and impervious surfaces is typically restricted to approximately 10 percent — preserving natural vegetation and reducing stormwater runoff into Muskoka’s lake ecosystems.
Natural vegetation buffer: A 15-metre natural vegetation buffer is generally required along the water’s edge. My Own Cottage’s crane-set modular installation minimizes disturbance within this buffer compared to months of on-site framing activity.
Accessory structure size limits: Secondary structures including bunkies, small sleeping cabins, and guest cottages are typically limited to approximately 600 square feet in most Muskoka townships.
My Own Cottage’s compact models — including the Modern Living at 718 square feet and our smaller single-bedroom home designs — are sized specifically with these secondary structure rules in mind.
Township-by-Township Variation
Each of Muskoka’s six area municipalities applies the District Official Plan through its own zoning bylaw.
The Township of Muskoka Lakes — governing Lake Muskoka, Lake Rosseau, and Lake Joseph — has some of the most stringent shoreline controls in Ontario. For buyers with a Lake Muskoka lot specifically, the complete guide to WR zoning provisions, Conservation Authority permit triggers, barge delivery logistics, and all-in cost ranges by lot type is in our prefab homes Lake Muskoka guide.
For buyers with a Lake Rosseau lot — including the Port Carling lock system delivery constraint, Site Plan Control process, boathouse compound regulations, and all-in cost ranges from CAD $1,000,000 to $3,500,000-plus by lot type — see our complete guide to prefab homes on Lake Rosseau.
For buyers with a Lake Joseph lot — including Tree Conservation By-law 2022-107 permit sequencing, barge delivery logistics from Port Sandfield and Foots Bay, compound estate programming across main cottage, boathouse, and bunkie structures, and all-in cost ranges from CAD $1,500,000 to $10,000,000-plus by lot type — see our complete guide to prefab homes on Lake Joseph.
The Town of Bracebridge, the Township of Lake of Bays, the Town of Huntsville, and the Town of Gravenhurst each apply their own layered requirements.
For buyers with a Bracebridge lot — including the Town’s development charges, OBC permit pathway, and proximity to Lake Muskoka waterfront access — see our prefab homes in Bracebridge guide.
For Gravenhurst-specific permit fees, development charges, and Conservation Authority jurisdiction on Lake Muskoka waterfront lots, see our complete prefab homes Gravenhurst guide.
For Huntsville-specific permit fees, By-law 2024-130 development charges, Northeastern Public Health sewage permit authority, and North Muskoka terrain realities on Fairy Lake and Lake of Bays waterfront lots, see our complete prefab homes in Huntsville guide.
My Own Cottage’s site assessment confirms the specific zoning designation, setback requirements, and permitted uses for your lot before any floor plan is selected — eliminating the risk of commissioning home designs that cannot receive permit approval in your specific township.
Conservation Authority Permits
A Section 28 permit under Ontario Regulation 179/06 is required for any development within a regulated area — in addition to the municipal building permit, not instead of it.
My Own Cottage manages Conservation Authority engagement as part of the permit application process for every Muskoka build, initiating both applications simultaneously to prevent Conservation Authority processing from becoming the critical path item that delays your occupancy.
For the complete four-layer approval framework — verified permit fees by township, development charges for all six Muskoka municipalities, and the January 1 deadline that determines your rate — see our prefab home permits Muskoka guide.
Why CSA A277 Certification Matters More in Muskoka
Muskoka’s area municipalities have limited building inspection capacity during the peak cottage construction season.
My Own Cottage’s CSA A277 certified factory inspection documentation substitutes for many on-site municipal inspection visits — allowing building inspectors to focus their Muskoka field time on site-specific work.
This administrative advantage is more pronounced in rural Muskoka townships than anywhere else in Ontario.
→ Prefab Home Permits Ontario — complete permit guide │ → External link: District Municipality of Muskoka │ → External link: Ontario Building Code O. Reg. 332/12 │ → External link: HCRA — Home Construction Regulatory Authority │ → External link: Tarion — The New Home Warranty
Foundations and Septic — The Two Site Decisions That Set Your Muskoka Budget
These are the two project decisions most consistently underestimated in Muskoka prefab planning and the two topics most frequently discussed in Ontario cottage country owner communities.
Before selecting a design or finalizing pricing, every Muskoka prefab project comes down to two core site decisions: how the home is supported on Canadian Shield bedrock, and how wastewater is managed on a constrained waterfront lot.
The diagram below shows how these two systems work — and why they represent the most significant variables in your total site budget.
The two decisions that define every Muskoka prefab project: foundation type and septic system design. Helical pier foundations minimize excavation on Canadian Shield bedrock, while engineered septic systems are designed to meet shoreline and soil constraints — each with predictable cost ranges that shape your total site budget.
My Own Cottage’s site assessment addresses both for your specific lot before any design commitment is made. We confirm the foundation type and septic system approach that works for your specific site conditions before any factory production is scheduled.
Helical Piers, ICF, or Concrete Piers
Helical piers are often the preferred foundation solution for My Own Cottage builds on Muskoka’s Canadian Shield. No excavation, no concrete forms, same-day module installation, and adjustable pier heads that level across uneven bedrock outcrops. Cost: CAD $10,000 to $25,000 for a standard Muskoka build. Best for rocky or sloped lots, water access properties, and any site where Conservation Authority requirements restrict ground disturbance near the shoreline.
Insulated Concrete Form (ICF) foundations provide continuous insulation achieving effective R-values of R-22 to R-28 and are the appropriate choice for four-season year-round occupancy requiring conditioned basement or crawlspace space. Appropriate where lot topography allows full excavation below Muskoka’s 1.2 metre frost depth. Cost: CAD $35,000 to $80,000 for a full perimeter ICF foundation.
Concrete piers bearing on sound bedrock are frequently acceptable for seasonal accessory structures within the approximately 600 square foot secondary structure size limit at building inspector discretion.
My Own Cottage co-ordinates foundation engineering with module structural drawings during the permit process — ensuring the bearing beam layout is confirmed against your specific lot conditions before any factory production begins.
Engineered Septic Systems for Rocky Muskoka Lots
In the vast majority of Muskoka cottage properties, municipal sewer service is unavailable.
A private septic system approved under Part 8 of the Ontario Building Code is required — with permits issued by the District Municipality of Muskoka. Muskoka’s shallow bedrock makes conventional gravity-fed leaching beds frequently impossible.
Engineered alternatives include raised-bed mound systems importing fill material above natural grade, pressurized low-dose distribution systems, and tertiary treatment systems from manufacturers such as Waterloo Biofilter that reduce nutrient load and allow reduced setback distances on tight waterfront lots.
Budget CAD $20,000 to $60,000 for an engineered septic system on a Muskoka Shield lot.
For water supply, drilled wells into bedrock fractures are standard at CAD $8,000 to $20,000 including pump equipment.
For seasonal use a lake-fed surface water intake with UV and multi-barrier filtration is a common alternative.
For four-season year-round use a drilled well is strongly preferred — winterizing a surface intake through Muskoka’s freeze-thaw cycles is labour-intensive and prone to failure in ways that a properly cased drilled well is not.
My Own Cottage’s site assessment initiates septic design co-ordination early — the designer’s findings affect lot layout and floor plan feasibility before permit applications can be submitted, and discovering a septic engineering constraint after design is finalized is one of the most costly errors in Muskoka prefab planning.
→ External link: Simcoe Muskoka District Health Unit
My Own Cottage Prefab Homes Designed for Muskoka — Browse Our Complete Collection
My Own Cottage offers one of Ontario’s broadest Muskoka-ready modular home catalogues.
From compact prefab cottages suited to Muskoka’s secondary structure accessory rules to spacious multi-bedroom family homes designed for year-round lakeside living with lake views and open-concept living rooms that capture the best of the Muskoka modern design aesthetic.
Every model is available with four-season specifications for Muskoka’s Climate Zone 6 to 7 requirements and every model is engineered for delivery to Muskoka lots including water-access properties.
All My Own Cottage homes are built on our OBC certified modular platform in a controlled environment — with consistent build quality, precise dimensional tolerances for helical pier installation, and complete factory inspection documentation for Muskoka’s municipal permit process.
Our design concept for every Muskoka home begins with the lot — its orientation, its lake views, its terrain, and its regulatory constraints — before any floor plan is finalized.
The result is a home design that feels like it belongs on your specific Muskoka property rather than a catalogue model placed on any available lot.
Compact Prefab Cottages, Cabins, and Bunkie Models — For Muskoka’s Accessory Structure Rules
For buyers adding a small sleeping cabin, prefab bunkie, or guest cottage to an existing cottage property within Muskoka’s approximately 600 square foot accessory structure limits — and for buyers seeking an efficient entry-level lakeside retreat on a compact lot.
These prefab garden suites and ADUs in Ontario deliver an extremely high level of design and build quality in a footprint sized specifically for Muskoka’s secondary structure rules.
- 988 SQ. FT
- Bedrooms: 2
- Bathrooms: 1
Preconfigured model starting at: $324,500
- 1170 SQ. FT
- Bedrooms: 3
- Bathrooms: 1
Preconfigured model starting at: $369,500
- 1269 SQ. FT
- Bedrooms: 3
- Bathrooms: 2
Preconfigured model starting at: $379,500
For buyers specifically seeking compact designs within Muskoka’s accessory structure size limits, our dedicated small prefab homes Muskoka guide covers every compact model in detail.
This includes foundation options for tight lots, seasonal versus four-season specification choices, and pricing for builds within the 600 square foot secondary structure rules.
Mid-Range Cottage and Four-Season Models
For buyers planning a primary Muskoka cottage, a four-season retirement home, or a family-sized retreat specified for year-round OBC compliance.
These models offer open-concept living space, flexible home plans, and modern design features including large windows for lake views and optional Muskoka Room additions.
They are all available with sliding glass partitions, modern white oak flooring, and the architectural product quality that makes a Muskoka prefab home a genuine dream home rather than a standard catalogue build.
- 1752 SQ. FT
- Bedrooms: 3
- Bathrooms: 2
Preconfigured model starting at: $519,500
Larger Family and Custom Muskoka Builds
For buyers planning a full-sized family home, a multi-generational retreat, or a fully custom home built to precise lifestyle and real estate investment specifications.
My Own Cottage’s design team works with you on every custom design from concept through engineering — whether you are adapting an existing model or building your dream home from your own floor plan and home design vision.
- 2307 SQ. FT
- Bedrooms: 3
- Bathrooms: 2
Preconfigured model starting at: $619,500
- 2513 SQ. FT
- Bedrooms: 3
- Bathrooms: 3
Preconfigured model starting at: $899,500
With our prefab homes for sale in Ontario, every model is available with a Muskoka Room addition — the screened outdoor living space that extends your usable square footage through the full Muskoka season.
Whether you are replacing an existing cottage with a new home on the same footprint, adding a beautiful glass box bunkie to an existing property, or building from scratch on a raw lakeside lot — custom design consultations are available at no charge.
What Our Clients Say
“There is excellent support behind My Own Cottage. They walk you right through the design and build process for prefab homes. If you have any questions or concerns, they’ll go over that and explain the best options available to achieve your goals.” ⭐⭐⭐⭐⭐ — Stephen Culbert, CEO, Alternate Power International Ltd., Ontario
“We felt absolutely well taken care of. Feedback was always prompt, very professional, yet personal and individualized. Above all, the information provided in advance was very detailed and extremely helpful. My Own Cottage Inc. is absolutely recommendable!” ⭐⭐⭐⭐⭐ — Ilva Drumm, Muskoka, Ontario
My Own Cottage — Prefab Home Builders Serving Muskoka and Cottage Country Ontario
My Own Cottage is based in Orillia and delivers OBC compliant prefab homes across Muskoka.
Our service area includes waterfront Lake Muskoka and Lake Rosseau lots to prefab homes in Bracebridge, Huntsville, Gravenhurst, prefab homes on Georgian Bay and Parry Sound properties, and water-access-only lots where barge delivery is the only viable construction method.
We are one of the few prefab home builders in Ontario with the site assessment process, engineering relationships, and delivery logistics experience to serve the full range of Muskoka lot types.
A completed prefab home on a Muskoka waterfront lot in peak autumn — the finished result of a fully managed build across permits, site preparation, and installation.
We build on everything from serviced road-accessible properties to remote Northern Ontario waterfront lots requiring marine delivery.
Every project begins with a complete site assessment covering soil and bedrock conditions, Conservation Authority jurisdiction, foundation type suitability, module delivery access route, and utility servicing requirements — before any model is selected or any commitment is made.
We are HCRA registered and Tarion enrolled on every build, with CSA A277 certified manufacturing providing the factory inspection documentation that streamlines permit approval across Muskoka’s area municipalities.
Whether you are adding a bunkie to an existing cottage property, replacing an existing cottage on a grandfathered footprint, building a four-season retirement home on a lakeside lot, or planning a spacious family home in cottage country.
Every consultation includes honest all-in cost estimates covering both the factory budget and the Muskoka-specific site budget for your property.
Our project managers guide you through every step of the way from the first site assessment through your occupancy permit.
No surprises. No hidden costs. No pressure.
Get started with your free Muskoka consultation today.
🧑💼 Request a Free Consultation
📲 Call Us Directly: (705) 345-9337
🏘️ View Our Design Catalogue
✅ Ontario-Built | ⚡ Energy-Efficient | 🏡 Fully Customizable | 🚚 Fast Delivery
Alternatively, for your convenience, you can also simply fill out the contact form below and we’ll get back to you soon! 👇
Frequently Asked Questions — Prefab Homes Muskoka
Do I need a building permit for a prefab home in Muskoka?
Yes — building permits are required for all prefab and modular homes in Muskoka regardless of construction method or factory certification status.
Applications are filed with the relevant area municipality — the Township of Muskoka Lakes, the Town of Bracebridge, the Town of Gravenhurst, the Town of Huntsville, or the Township of Lake of Bays — under the Ontario Building Code. CSA A277 factory certification streamlines the inspection pathway but does not eliminate the permit requirement.
Properties within regulated Conservation Authority areas also require a Section 28 permit in addition to the municipal building permit.
My Own Cottage manages the complete permit application process for every Muskoka build as a standard part of every project.
How much does a prefab home in Muskoka cost all-in?
All-in costs vary by lot conditions, model size, and whether the property is road-accessible or water-access-only.
My Own Cottage’s factory price ranges from our compact models at CAD $150,000 to $250,000 through mid-range family homes at CAD $250,000 to $450,000 and larger custom builds at CAD $450,000 to $650,000-plus.
The Muskoka site budget adds CAD $60,000 to $120,000 on a road-accessible lot and CAD $120,000 to $200,000 or more on a water-access-only property.
Total all-in range: CAD $350,000 to $600,000 for a mid-range family home on a road-accessible lot; CAD $450,000 to $900,000-plus on a complex waterfront property.
My Own Cottage provides complete all-in estimates for your specific lot at the first consultation.
How long does it take to build a prefab home in Muskoka?
My Own Cottage’s factory manufacturing typically takes eight to sixteen weeks once engineering is finalized and a deposit is placed.
Site preparation, foundation installation, and Conservation Authority approvals run concurrently with factory production through our parallel build model.
From contract signing to occupancy, most Muskoka projects take seven to fourteen months — with Conservation Authority permit processing adding four to sixteen weeks on regulated waterfront lots.
Buyers who complete land due diligence and septic design before signing consistently achieve shorter overall timelines.
Can a My Own Cottage prefab home be delivered to a water-access-only Muskoka lot?
Yes — and water-access delivery is one of the scenarios where My Own Cottage’s prefab approach holds a decisive advantage over traditional construction.
Our modular homes can be transported by barge and crane-set onto a prepared helical pier foundation with minimal terrestrial site disturbance.
My Own Cottage’s site assessment confirms water-access delivery logistics — including barge platform dimensions, crane positioning requirements, and marine delivery scheduling — for every water-access Muskoka project before any design commitment is made.
Water-access delivery adds CAD $30,000 to $80,000 to the project budget for marine transport and crane co-ordination.
What is the minimum shoreline setback for a cottage in Muskoka?
Shoreline setbacks in Muskoka range from 20 to 30 metres from the high-water mark depending on the area municipality and specific zoning designation.
The high-water mark must be formally established by a licensed Ontario Land Surveyor before any site plan is prepared — it cannot be estimated from current water level.
My Own Cottage’s site assessment confirms the specific setback applicable to your lot as part of the pre-design zoning review, eliminating the risk of commissioning floor plans that cannot receive permit approval.
What foundation type does My Own Cottage recommend for Muskoka’s Canadian Shield bedrock?
Helical piers are My Own Cottage’s preferred foundation solution for most Muskoka builds on Shield terrain — no excavation, same-day module installation, and adjustable pier heads that level across uneven bedrock outcrops.
Cost: CAD $10,000 to $25,000 for a standard build. ICF perimeter foundations are recommended for four-season year-round occupancy requiring conditioned basement space where lot topography allows excavation below the 1.2 metre frost depth — cost CAD $35,000 to $80,000.
My Own Cottage co-ordinates foundation engineering with module structural drawings during the permit process for every build.
Do I need a Conservation Authority permit for my Muskoka prefab home?
Yes if your property is within a regulated area — typically a 30-metre buffer from a shoreline, wetland, or floodplain.
A Section 28 permit from the applicable Conservation Authority — either the Muskoka Watershed or the Lake Simcoe Region Conservation Authority in southern portions — is required in addition to the municipal building permit.
My Own Cottage initiates both applications simultaneously as part of our standard Muskoka project management process, preventing Conservation Authority processing from becoming the critical path delay that extends overall timelines.
What is the difference between a seasonal and a four-season My Own Cottage prefab cottage?
A seasonal My Own Cottage cottage is designed for May through October use with a reduced thermal envelope appropriate for Muskoka’s shoulder seasons.
A four-season home built to year-round OBC standards for Muskoka’s Climate Zone 6 to 7 requires minimum effective R-20 to R-24 in above-grade walls — with our high-performance four-season specification targeting R-28 to R-40 using spray polyurethane foam — R-40 to R-60 at the ceiling, R-20 minimum underfloor, a heating system rated for -30°C, and a drilled well rather than a seasonal surface intake.
My Own Cottage provides both seasonal and four-season specifications across our full Muskoka model range. Confirm which classification you require at the first consultation.
Can I install a septic system on my rocky Muskoka lot?
Yes — but it requires an engineered solution rather than a conventional gravity-fed leaching bed.
My Own Cottage co-ordinates with a Licensed Septic System Designer as part of the Muskoka site assessment process — the designer’s findings affect lot layout and floor plan feasibility before any permit applications are submitted.
Engineered septic system costs on Muskoka Shield lots range from CAD $20,000 to $60,000 depending on soil conditions, system type, and lot access.
My Own Cottage includes septic design co-ordination in our standard Muskoka project process to ensure no late-stage surprises affect your floor plan or budget.
Are there size restrictions on bunkies and sleeping cabins on Muskoka cottage properties?
Yes. Sleeping cabins and bunkies on Muskoka cottage properties are generally limited to approximately 600 square feet of floor area depending on the specific area municipality’s zoning bylaw.
My Own Cottage’s compact model range — including designs under and around this size threshold — is specifically suited to buyers adding a secondary structure to an existing Muskoka cottage property within these accessory structure size limits.
My Own Cottage’s site assessment confirms the specific secondary structure rules for your lot before any design selection is made.
Is a My Own Cottage prefab home covered by Tarion warranty?
Yes. Every My Own Cottage home is enrolled with Tarion Warranty Corporation — Ontario’s statutory new home warranty program covering one year for workmanship and materials, two years for major systems including plumbing, heating, and electrical, and seven years for major structural defects, with coverage up to CAD $300,000.
My Own Cottage is registered with the Home Construction Regulatory Authority and Tarion enrollment is confirmed for every project before the occupancy permit application is submitted — satisfying both the regulatory requirement and the construction mortgage lender’s final draw release condition simultaneously.
Can My Own Cottage build a prefab home for off-grid use on a remote Muskoka property?
Yes. Many Muskoka properties are not connected to the Hydro One distribution grid — with connection costs ranging from CAD $10,000 to $50,000-plus for remote properties.
My Own Cottage designs accommodate solar panel integration, battery storage, propane or wood-pellet heating systems, composting or engineered septic, and UV-filtered lake water or drilled well supply as standard options.
Off-grid energy and utility packages for Muskoka applications add CAD $40,000 to $120,000 to the project budget depending on capacity and comfort level.
My Own Cottage’s site assessment confirms off-grid system requirements for your specific lot and usage pattern.
How does My Own Cottage manage the Muskoka building permit process?
My Own Cottage manages the complete building permit application process for every Muskoka build — preparing engineered drawings, CSA A277 factory certification documentation, site plan, grading plans, and foundation engineering, and submitting the complete package to the area municipality before factory production is scheduled.
We initiate Conservation Authority applications simultaneously with building permit applications, co-ordinate septic design with the Licensed Septic System Designer, and engage with the chief building official early to establish an inspection schedule compatible with our factory delivery timeline.
Our goal is to have permit approval and factory manufacturing running simultaneously through the parallel build model — eliminating the permit wait from the critical path.
Does a My Own Cottage prefab home hold its value in Muskoka?
Yes. My Own Cottage homes are built to CSA A277 standards on permanent foundations and are assessed and valued by MPAC — the Municipal Property Assessment Corporation — and by Canadian mortgage lenders equivalently to conventionally built homes.
Muskoka real estate has historically appreciated strongly due to limited lakefront supply and sustained demand from urban buyers.
A well-specified My Own Cottage home in a desirable Muskoka location achieves market values comparable to traditionally built properties in the same area.
Confirm mortgage eligibility with your lender before signing any contract — My Own Cottage provides the complete CSA A277 documentation package that most lenders require for factory-built home mortgage approval.
Verified External Resources
Ontario Building Code — O. Reg. 332/12 — The primary provincial standard governing all prefab and modular home construction in Ontario including factory-built housing certification, Part 9 residential requirements, and Part 8 on-site sewage system standards.
Ontario.ca — Building a Modular House — Official Ministry of Municipal Affairs and Housing guide to modular home construction, CSA A277 certification, and the municipal permit process in Ontario.
District Municipality of Muskoka — Building and Planning — Upper-tier planning authority governing shoreline setbacks, lot coverage restrictions, natural vegetation buffer requirements, and accessory structure size limits across all six Muskoka area municipalities.
Prefab Home Permits Muskoka — Complete Four-Layer Approval Guide — Verified permit fees by township, confirmed development charges for all six Muskoka municipalities, Conservation Authority Section 28 permit triggers, shoreline setback tables, and the January 1 indexing deadline — the complete Muskoka-specific permit framework in one resource.
Muskoka Prefab Home Prices — Verified All-In Cost Scenarios by Lot Type — The complete five-layer cost framework across road-accessible, waterfront bedrock, and water-access-only lots — with named model price anchors, development charge figures, and the soft costs most Muskoka buyers omit from initial estimates.
Prefab Homes Orillia — Complete Local Guide to Costs, Permits, and Building Requirements — Verified Orillia-specific framework covering building permits, LSRCA shoreline regulations, development charges, and all-in prefab home costs by lot type — the authoritative local companion to broader Ontario and Muskoka resources.
CSA A277 — Canadian Standards Association — Factory certification standard for modular buildings — the mechanism by which My Own Cottage homes demonstrate Ontario Building Code compliance and streamline municipal permit approval in Muskoka’s townships.
Tarion — The New Home Warranty — Ontario’s statutory new home warranty program — every My Own Cottage home is enrolled before the occupancy permit application is submitted.
HCRA — Home Construction Regulatory Authority — Ontario Builder Directory confirming My Own Cottage’s active builder licensing status — verify any builder’s registration before signing a purchase agreement.
CMHC — Mortgage Loan Insurance for Factory-Built Homes — Federal housing authority confirming mortgage insurance eligibility for CSA A277 certified prefab homes on permanent foundations with as little as 5% down.
Muskoka Watershed Council — Environmental oversight body for Muskoka’s lake ecosystems — relevant to shoreline buffer requirements and Conservation Authority jurisdiction for waterfront prefab builds.
Simcoe Muskoka District Health Unit — Regional health authority administering septic system approvals and well water safety standards for the majority of Muskoka prefab home projects — confirm jurisdiction for your specific lot.
More Homes Built Faster Act — Bill 23 — Provincial legislation enabling as-of-right secondary unit construction and development charge eliminations relevant to Muskoka accessory structure and garden suite applications.
