Building a custom home in Ontario runs in nine stages: check the lot, choose a build route, bring in a designer, write the design brief, value-engineer and draw for permit, sign the contract, clear approvals, build through inspections, then walk through and reach occupancy. The lot comes first because it limits every stage after it.

By Sean Stevenson, Chief Marketing Officer and Buyer Experience Lead at My Own Cottage Inc., an HCRA-licensed, Tarion-enrolled prefab home and cottage builder based in Orillia, Ontario.
This page is for you if you plan a year-round custom home on your own lot in Ontario and have not picked a builder or a town yet. Costs and each town's rules live on other pages, and each section says where. If you already want a builder, start with how we take on a year-round home on a lot you own. If the build is a seasonal cottage, our seasonal and recreational designs are the better starting point.
The lot is the first thing worth having reviewed. The consultation is free, with no obligation.
There are nine key steps, and each one fixes something the next depends on.
| Stage | What happens | What it fixes |
|---|---|---|
| 1. Land feasibility | Confirm the land can take the house you want | Whether, and where, you can build |
| 2. Build route | Choose site-built, factory-built, kit or a customised preconfigured design | Which stages run side by side |
| 3. Design team | Engage whoever will produce the permit drawings | Who carries the design |
| 4. Design brief | Write down what the house must include and the limits it must stay within | The scope everyone prices against |
| 5. Value engineering and permit drawings | Trim cost and complexity, then draw the house for permit | What gets submitted |
| 6. Contract | Sign the scope, inclusions, exclusions and allowances | Who pays for what |
| 7. Approvals | Building permit review, plus any other approval the lot triggers | When work on the lot can start |
| 8. Construction | Build in stages, with municipal inspections at each stage the Code sets | That the work meets the Ontario Building Code |
| 9. Walkthrough and occupancy | Owner walkthrough, deficiency list, final inspection | When you can move in |

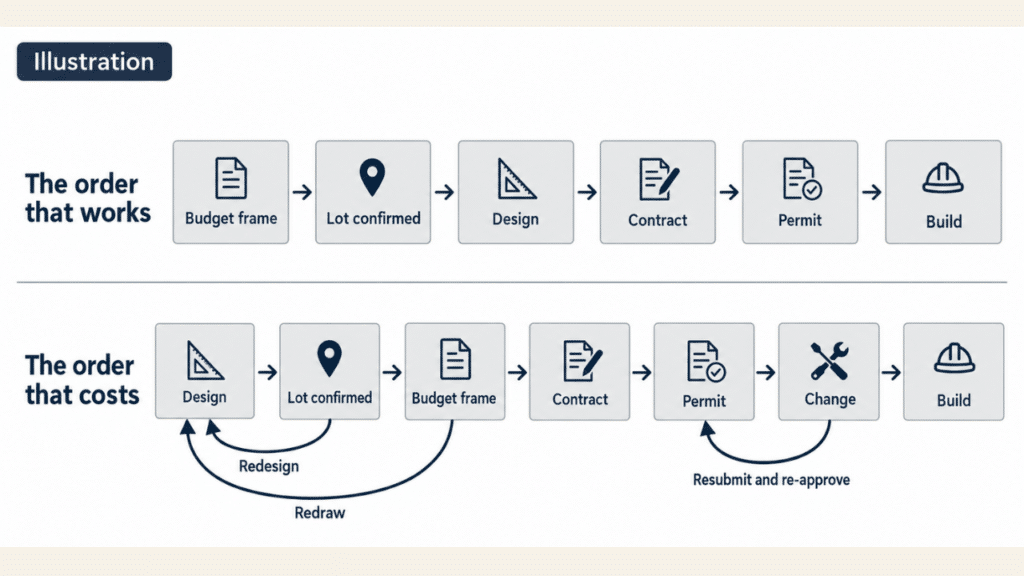

Stage 6 sits before or after the permit application, depending on the builder. What matters is that the contract is signed before anyone starts work on your lot.
Approvals sit between the finished drawings and the first work on the lot. You need a building permit before you excavate or build a foundation, and the municipality reviews the application against the Ontario Building Code and the zoning by-law.
Some approvals come first. A zoning change or minor variance, conservation authority approvals, and site plan approval where it applies generally have to be in place before the permit can issue. Once the application is complete, the Code gives the municipality a set timeframe to issue or refuse it. What makes an application complete is covered in what goes into a permit submission.
Municipal inspections sit inside construction. The Code sets the stages at which a new house is inspected, and the permit holder calls the municipality when the work reaches each one. The inspector has to be able to see the work, so keep each stage open until it has been inspected. The full list of stages is in the rules that govern how a new home is built.
Occupancy is the last stage. Ask your municipality early what it needs before you can move in, including whether an occupancy permit applies to your house.
If permits and approvals are the part that worries you, My Own Cottage helps with municipal permits. The consultation is free, with no obligation.

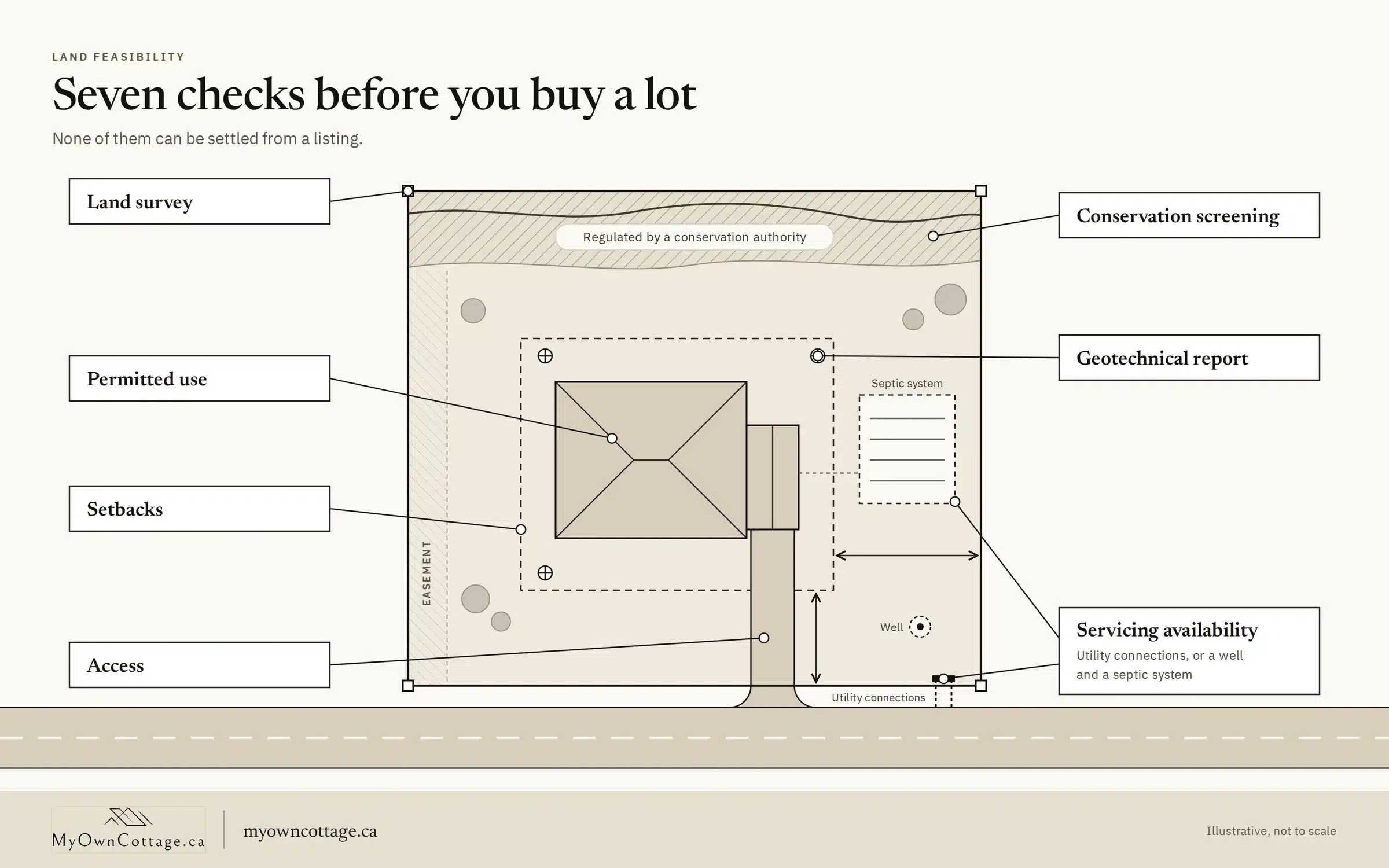

Choose a lot that passes seven land feasibility checks. Each one has someone who can answer it, and none of them can be settled from a listing.

| Check | What to confirm | Who can confirm it |
|---|---|---|
| Permitted use | The zoning by-law allows a detached, year-round house | The municipality's planning department |
| Setbacks | The house you want fits inside the required distances from the lot lines | The municipality, then your designer |
| Access | The lot can be reached year-round, by construction traffic as well as by you | The municipality or road authority, and your builder |
| Servicing availability | Municipal water and sewer can reach the house through utility connections, or the lot can take a well and a septic system | The municipality and the utilities |
| Conservation screening | Whether any part of the lot is regulated by a conservation authority | The conservation authority for that area |
| Land survey | Where the boundaries, easements and existing features actually are | An Ontario land surveyor |
| Geotechnical report | Whether the soil and rock can carry the foundation the house needs | A geotechnical engineer |
Each municipality sets its own zoning rules on use and setbacks, so the answer comes from the town, not from a province-wide figure. What utility connections cost is on the servicing and hookup budget page.
Run the checks before you firm the offer.
If the offer is conditional, the conditional period is when they happen, so ask your lawyer to write conditions that cover them.
A lot that fails one check is not always finished. A setback problem may be solved by a smaller footprint. What you need before you firm is an answer, not a guess.
Not sure your lot clears all seven checks? Bring the address, and anything the seller has given you, to a free consultation before you firm the offer.
The build route decides which stages run one after another and which run side by side. Every route still needs the land feasibility check, permit drawings, approvals, inspections and occupancy.
| Route | What it is | What changes in the sequence | What changes in the timeline |
|---|---|---|---|
| Site-built | Residential framing and finishing happen on your lot | Every construction stage runs on site, in order, from the foundation up | Weather and trade availability on site set the pace |
| Factory-built construction | The structure of a prefab home is built off site, then delivered and installed | The structure is built while the foundation and site work go ahead | The delivery date becomes a fixed point the site work must meet |
| Kit | Components ship to the lot for someone else to assemble | Assembly replaces framing, and someone must take the builder's role | Set by whoever assembles it |
| Customised preconfigured design | You start from an existing design and change it | The design stage starts from drawings that already exist | Design time goes on the changes, not on a whole house |
At My Own Cottage, the factory-built route runs Design → Build → Deliver → Install, inside the nine stages above, and we deliver anywhere in Ontario. How the routes compare on price is on how factory-built and site-built budgets compare. Whether a prefab home arrives as a modular home or a panelized home is covered in what each factory-built term means.
My Own Cottage · Factory-built route
A preconfigured design is a house that already has a floor plan and a set of drawings. You customise it rather than commission it from a blank sheet. The page on how a plan works when the same company designs and builds it covers how far a layout can change.
The design brief becomes a list of changes. Value engineering then starts from a known base rather than a first draft.
If starting from an existing plan suits you, look through the preconfigured designs and note what you would change.
An owner-builder is an owner who takes the builder's role on their own home. You hire and schedule the trades, deal with the inspector, and answer for the defects.
The Home Construction Regulatory Authority (HCRA) says a person building a home for their own use, on land they own, may not need a builder's licence. That depends on not selling the home after construction. The same guidance says an owner-built home has no statutory new home warranty coverage under the Ontario New Home Warranties Plan Act.

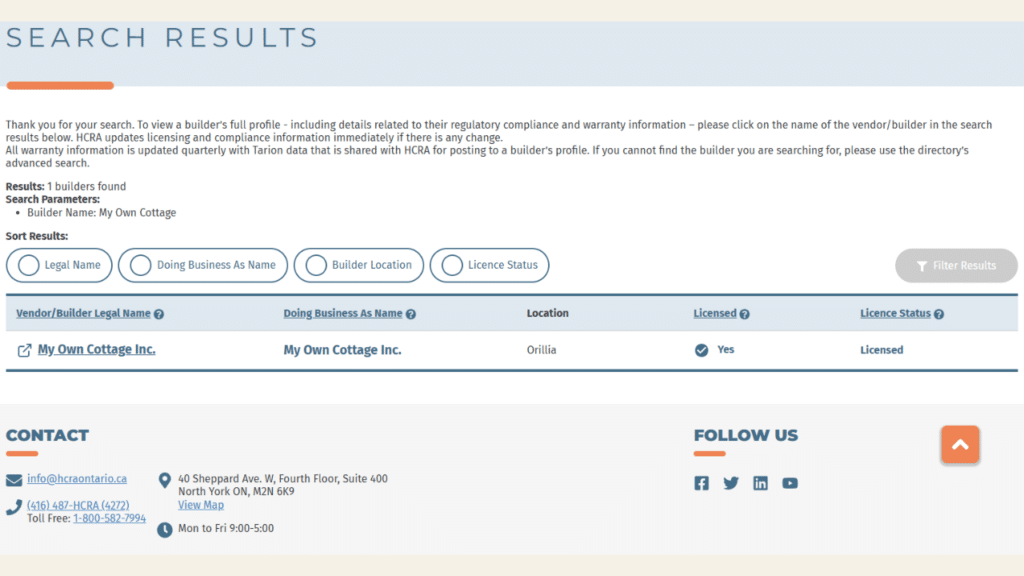

The Ontario Builder Directory is the one public lookup for Ontario builders, so it is where the licensed side of this decision can be checked. Kits and running the trades yourself are covered on building from a kit or managing the trades yourself. The rest of this page assumes you hire a builder.
Architectural design starts once the lot has passed its land feasibility checks and the route is chosen. The designer stays at least until the permit review comments are answered.

Permit drawings for a house are prepared by a designer qualified under the Ontario Building Code, or by a licensed architect or professional engineer. A qualified designer is identified by a BCIN, a Building Code Identification Number. Before you hire or pay anyone to prepare them, the province advises checking the Ministry of Municipal Affairs and Housing's QuARTS public registry.
On a factory-built or preconfigured route, the builder's design team may produce them. On a site-built route, you usually hire the designer yourself or use a design-build firm. An architect-led, bespoke design runs a longer process of its own, and this page does not cover it.
Bring the designer in before you firm a lot if you can. A designer who sees the lot early can tell you whether the house you want fits on it.
A design brief is the written list of what the house must include, the limits it must stay within, and which parts are fixed or open. Everyone prices against it, so vague lines become vague quotes.

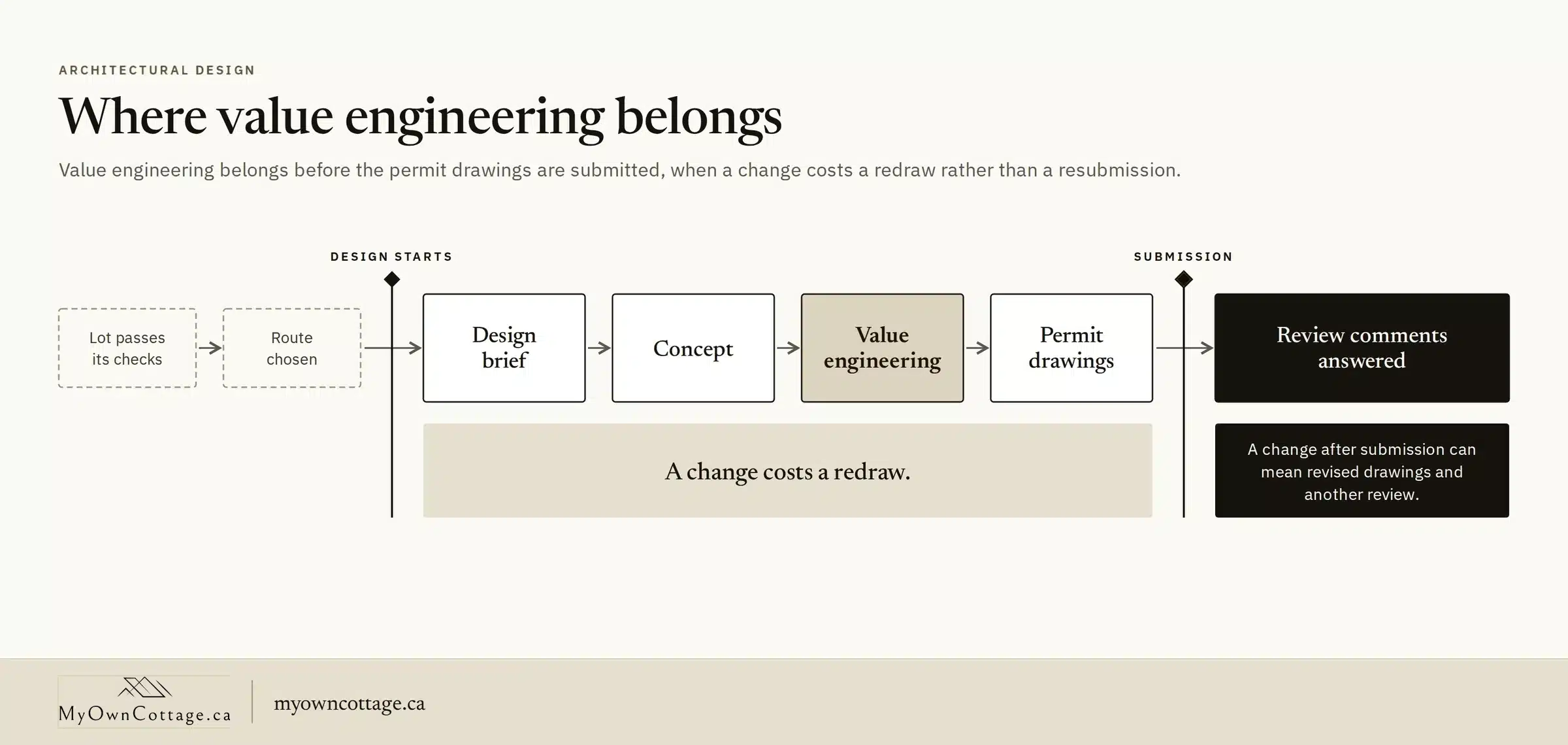

Value engineering is the review that removes cost and complexity without removing anything the brief requires. It belongs after the concept and before the permit drawings. A change after submission can mean revised drawings and another review.
Envelope decisions sit in the brief too. Insulation, air sealing and energy efficiency and which materials suit which part of the house each have their own page.
Changes are easiest before the permit drawings. Bring your design brief, or a design you are considering, to a free consultation.
Two kinds of time make up a custom build: time set by someone else's process, and time set by your decisions. A builder can give you a schedule worth planning on only once the lot, the route and the municipality are all known.
| Stage | Set by rule or varies | What sets it |
|---|---|---|
| Land feasibility | Varies | How quickly the municipality, surveyor and engineer can answer |
| Design and brief | Varies | How quickly you make decisions and hold to them |
| Building permit review | Set by rule | The Ontario Building Code's timeframe, which applies once the application is complete |
| Other approvals | Set by rule | The approving body's own process |
| Construction | Varies | Build route, weather, trade availability and selections |
| Municipal inspections | Set by rule | Called in by the permit holder at each stage the Code sets |
| Walkthrough and occupancy | Both | The deficiencies you raise, then the final inspection |
The stages that vary are where your own decisions show up in the schedule.

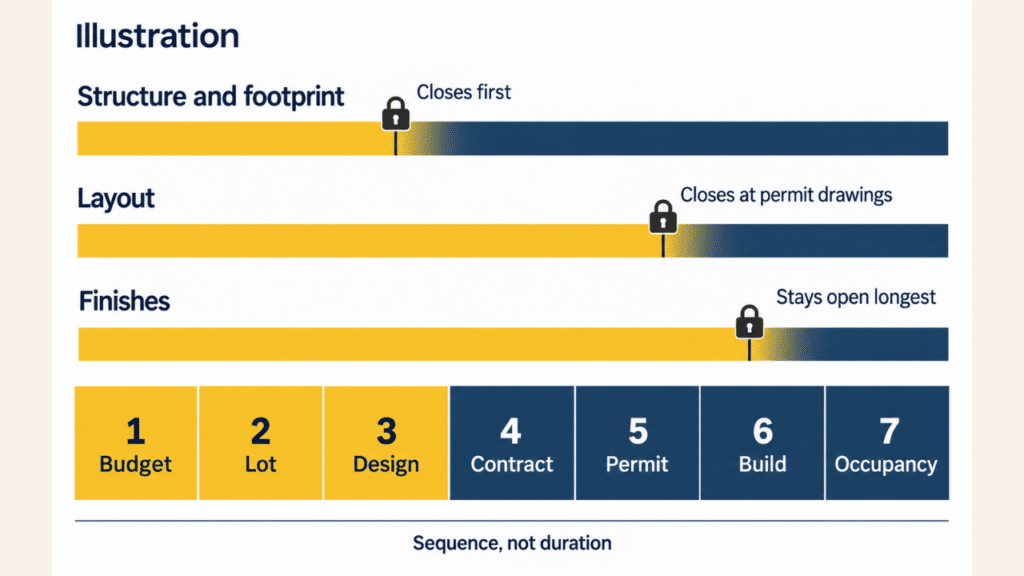

Before permit submission, lock any selection that changes the drawings: window and door sizes, the heating and other mechanical systems, and anything that moves a wall or an opening.
Once the contract is signed, order anything with a long lead time, so it arrives before the stage that needs it. Leave only finishes that change nothing structural for later, and put a date on each one.
If a construction loan pays for the build, the lender adds checkpoints of its own, covered in how construction financing and insurance work.
A schedule you can plan around depends on your lot, your route and your municipality. Bring all three to a free consultation.
The contract with your custom home builder should say who does what at each stage, what the price covers, and how a change gets approved.
| Stage | You | Designer or architect | Builder | Municipality |
|---|---|---|---|---|
| Land feasibility | Commission the land survey and geotechnical report | Test whether the house fits | Review access and site conditions | Answer zoning questions |
| Design | Write and approve the brief | Draw the concept and the permit set | Price it and value-engineer it | Answer zoning questions, if asked |
| Contract | Approve scope and set allowances | Not usually involved | Define inclusions and exclusions | Not involved |
| Approvals | Approve the application | Answer review comments | Coordinate the submission, if agreed | Review and issue the building permit |
| Construction | Make selections on time; attend walkthroughs | Answer questions from site | Run the trades; call in inspections, if the builder holds the permit | Inspect at each stage the Code sets |
| Occupancy | Final walkthrough and deficiency list | Not usually involved | Fix the deficiencies | Final inspection |
On a My Own Cottage build, foundation, site preparation and servicing are carried out by licensed-trade installation affiliates — contracted, not employees — quoted separately against the lot and set in the agreement before the build. My Own Cottage helps with municipal permits. What to compare when you vet builders is covered in how to weigh builders' quotes, references and insurance.
Inclusions list what the price covers, item by item. Exclusions list what it does not, so nothing sits in between. An allowance is an amount held in the contract for an item you have not chosen yet. The contract should say who pays if your choice costs more.
A change order is a signed record of a change to scope, price or schedule, agreed before the work is done. Agree at signing that no change goes ahead without one.
A decision log records every selection and approval with its date. It settles what was agreed when two memories differ. How much construction contingency each budget line should carry is set out in the full build budget, category by category.
Want the exclusions in writing before you commit? Foundation, site preparation and servicing are quoted separately against your lot and set in the agreement before the build.
A municipal inspection checks the work against the Ontario Building Code.
An owner walkthrough checks it against your contract: the inclusions, the selections and the finish you agreed to.
A house can pass inspection and still miss the contract. Schedule walkthroughs at fixed points, before drywall and before occupancy at the least, and write down what you find.

It changes the order. On a lot you already own, the seven land feasibility checks shape the house you design. If you are still shopping, the same checks decide whether to buy, so they come before you firm the offer.
Yes. A building permit is required before you construct a new house, and before you excavate or build a foundation. Approvals such as a zoning change, a minor variance or a conservation authority permit generally have to be in place before the permit can issue. If the lot needs an on-site sewage system, that needs a permit too, and in some areas it comes from a board of health or conservation authority rather than the municipal building department.
A custom home's schedule depends on the lot, the build route and the municipality. Once a building permit application is complete, the Ontario Building Code gives the municipality a set timeframe to decide it. Design, selections and construction follow decisions and site conditions you can plan for, so a reliable schedule comes only after all three are known.
An owner-builder takes the builder's role on their own home. The HCRA says someone building a home for their own use on land they own may not need a builder's licence, provided they do not sell it after construction. An owner-built home has no statutory new home warranty coverage. Kits and owner-managed builds are covered on building from a kit or managing the trades yourself.
No, but you can hire one. An architect holds a licence from the Ontario Association of Architects. The association’s public OAA Directory lists its architects. Permit drawings for a house can also come from a designer qualified under the Ontario Building Code and identified by a BCIN, and the province advises checking the QuARTS public registry before you hire one.
A custom home contract should set out the scope by stage, written inclusions and exclusions, allowances for items not yet chosen, and a change-order process. It should also say who calls in inspections and who fixes deficiencies. Keep a dated decision log alongside it.
| What we checked | Source | Date checked |
|---|---|---|
| The Ontario Builder Directory is the public lookup for Ontario builders | HCRA, Ontario Builder Directory | September 24, 2026 |
| Building permit before a new house, excavation or a foundation; review against the Code and zoning; other approvals first; decision timeframe for a complete application; inspections called in by the permit holder; QuARTS advice; on-site sewage system permits | Government of Ontario, Citizen's guide to land use planning: Building permits (updated July 27, 2026) | September 24, 2026 |
| Owner-built homes: licence and statutory warranty | HCRA, Do I need a licence? | September 24, 2026 |
| Architects (licensed by the Ontario Association of Architects) and engineers alongside BCIN designers on house permit drawings | Application for a Permit to Construct or Demolish, Schedule 1: Designer Information (City of Mississauga copy, effective February 16, 2026) | September 24, 2026 |
| The OAA Directory lists architects and other members of the Ontario Association of Architects | Ontario Association of Architects, OAA Directory | September 24, 2026 |
| Which conservation authority covers a lot | Conservation Ontario, Find a Conservation Authority | September 24, 2026 |
The first decision in building a custom home in Ontario is the lot, because every later stage inherits what it allows. Have it checked before you firm an offer or commission drawings.
If you are choosing a custom home builder for a specific town, start from rebuilding on a City of Toronto lot, a rural or village lot in the City of Ottawa, a lot inside the City of Hamilton, a lot in the City of Belleville, a lot in the District of Muskoka, a lot in the Town of Bracebridge, a lot in the Town of Collingwood or a lot in the City of Orillia.
If you have a lot in mind, send it to us before you commit to it. The consultation is free and carries no obligation.
My Own Cottage · Our facility: 12 Lankin Blvd #3, Orillia, ON L3V 7B6 · 1 (705) 345-9337 · [email protected]
About the author
Sean Stevenson is Chief Marketing Officer and Buyer Experience Lead at My Own Cottage Inc., an HCRA-licensed, Tarion-enrolled prefab home and cottage builder based in Orillia, Ontario.
For five years, Sean has worked alongside the company's build team, guiding Ontario buyers from lot assessment and budgeting beyond the model price through zoning, permits, development charges and final occupancy. Sean focuses on the part most buyers underestimate: what a prefab home costs to complete once the foundation, servicing and approvals are added to the model price.
Connect with Sean on LinkedIn · View My Own Cottage's HCRA licence in the Ontario Builder Directory
