Prefab Homes Georgian Bay 2026: What Island and Waterfront Buyers Need to Know

Last updated: May 1st, 2026
Written by building specialists at My Own Cottage

Georgian Bay is not a single destination — and that distinction matters more for a prefab build than for almost any other purchase decision you will make.

The bay stretches from Collingwood and the Blue Mountains in the south — where the Niagara Escarpment Commission adds a Development Permit layer that exists nowhere else in Ontario cottage country — to the 30,000 Islands archipelago in the north, where roughly 15 to 20 percent of lots are accessible only by boat.

Between those two extremes sit Tiny Township, Tay Township, Midland, Penetanguishene, Wasaga Beach, and the Parry Sound District.

Each area has its own municipal zoning authority, its own conservation authority jurisdiction, and its own logistical realities for delivering a prefab home.

Every Georgian Bay builder catalogue and lifestyle article answers exactly one question: can a quality prefab home exist on a Georgian Bay lot?

The answer is yes.

Completed Georgian Bay prefab home on island shoreline with Canadian Shield granite, open bay water, pine treeline, and warm interior lighting showing a lived-in four-season modular cottage in late summer

A completed Georgian Bay prefab home on a natural island shoreline—open water, Canadian Shield granite, and a lived-in cottage setting that reflects the real outcome buyers are planning toward.

What those pages never address is whether your specific lot is buildable, which regulatory bodies govern your shoreline, what barge and crane delivery actually costs, and what you must confirm before purchasing land or signing any builder contract.

This guide covers all of it — organized around the five Georgian Bay lot scenarios that determine which permits apply, how delivery works, what foundation is appropriate, and what the complete all-in cost looks like for your specific property.

My Own Cottage is based in Orillia, within the Georgian Bay watershed and on the primary Highway 400/Highway 69 delivery corridor for the Near North.

We deliver OBC compliant prefab homes across the Georgian Bay region — from the Township of Georgian Bay and Tiny Township to the Parry Sound District and the 30,000 Islands — including water-access and island lots where barge delivery is the only viable construction path.

For the complete District-wide guide to prefab home construction across Muskoka and the Near North see our prefab homes Muskoka buyer’s guide.

Buyers comparing Georgian Bay waterfront lots against the Lake Muskoka market will find the regulatory frameworks share significant overlap — see our prefab homes Lake Muskoka guide for the complete lake-specific framework.

Book a free Georgian Bay site assessment — lot type, Conservation Authority jurisdiction, NEC status, and verified all-in cost confirmed before any commitment is made.

Why Georgian Bay Makes Prefab the Rational Construction Choice

The case for prefab in Georgian Bay is not about generic efficiency. It is about the specific site challenges that define this region and the ways prefab construction addresses them better than every alternative.

Canadian Shield bedrock at or near surface on the majority of waterfront and island lots makes conventional basement excavation either impractical or prohibitively expensive.

Approximately 15 to 20 percent of Georgian Bay waterfront properties are accessible only by boat — a logistical reality that makes sequential site-built material deliveries across an entire build season both expensive and ecologically disruptive.

The region’s compressed April to November practical build season means every week lost to weather delays or trade scheduling gaps is a week that cannot be recovered without waiting for the following year.

Instead of waiting for one phase to finish before starting the next, prefab construction on Georgian Bay runs two coordinated tracks at the same time — one in the factory, one on your lot.

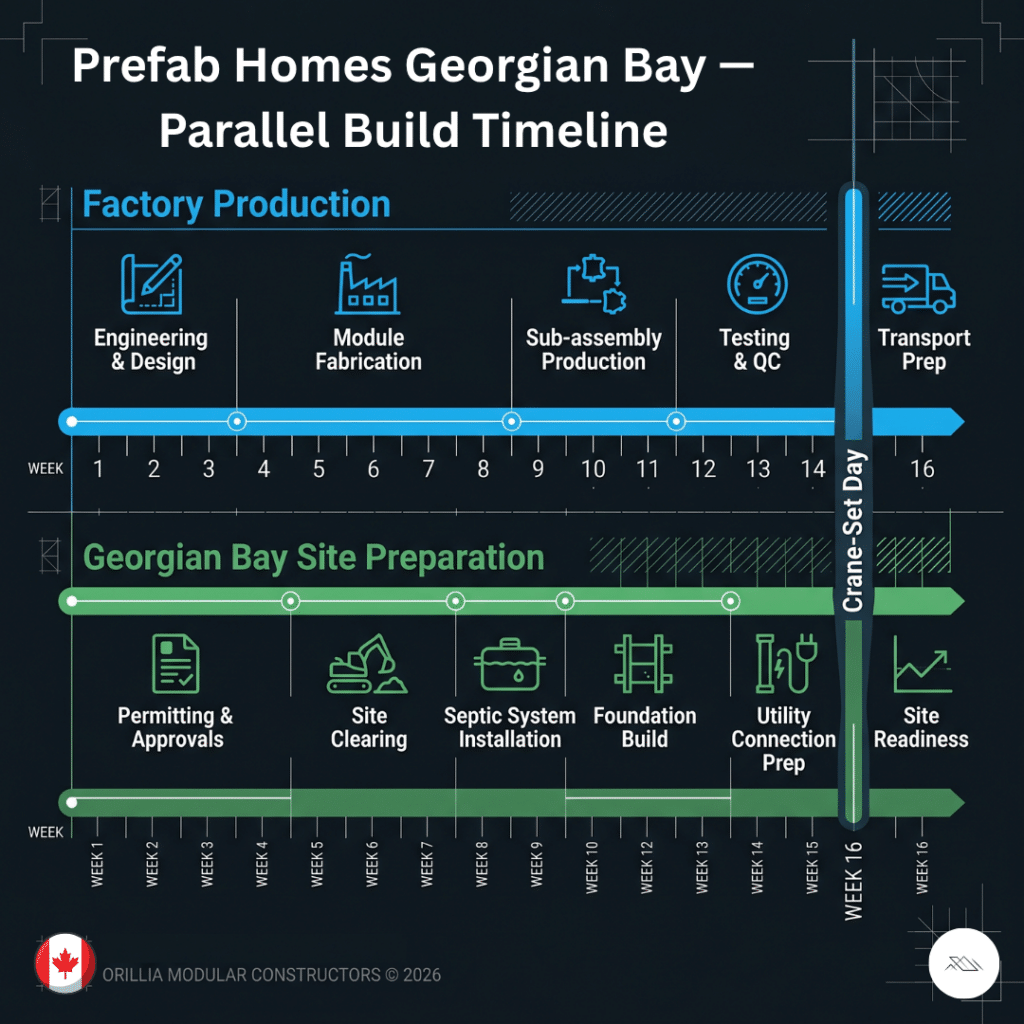

Prefab homes Georgian Bay parallel build timeline infographic showing factory production and site preparation running simultaneously over sixteen weeks converging on single crane-set installation day with seasonal and permitting constraints 2026

Prefab construction on Georgian Bay runs two parallel tracks—factory production and site preparation—converging on a single crane-set installation day.

Importantly, the multi-agency Conservation Authority permit environment across the entire Georgian Bay watershed specifically rewards construction methods that minimize site disturbance within regulated shoreline buffers.

My Own Cottage’s crane-set modular installation — completed in a single day on pre-installed helical piers — disturbs less ground within the Conservation Authority’s regulated shoreline buffer than weeks of conventional framing activity.

On island lots accessible only by barge, a near-complete prefab home delivered in one marine logistics sequence replaces months of sequential material transport.

The parallel build model — factory production running simultaneously with foundation installation, septic design, and Conservation Authority pre-consultation — compresses the Georgian Bay build timeline in a region where losing a single season costs a full year of occupancy.

This is not a theoretical advantage. It is the operational reality that makes the efficient construction of a beautiful home on a Georgian Bay waterfront lot genuinely achievable within a realistic timeline and a realistic budget.

Your Georgian Bay Lot Type Determines Everything That Follows

Before any floor plan is selected, any engineering is commissioned, or any builder conversation is scheduled, one determination shapes every decision that follows: which of the five Georgian Bay lot scenarios applies to your property.

Every decision that follows—what approvals apply, how materials arrive, what foundation is viable, and what your real all-in cost looks like—is determined by that single factor.

Prefab homes Georgian Bay modular home under construction on helical pier foundation with exterior finishing trades and undisturbed Canadian Shield shoreline showing minimal site disturbance on waterfront lot 2026

A small prefab home on helical piers under construction on a Georgian Bay waterfront lot — showing minimal site disturbance compared to conventional excavation-based building methods.

This is not a framing device. It is the literal organizing principle of every prefab build on Georgian Bay.

Your lot type determines your delivery method, your permit pathway, your foundation approach, your site budget, and your all-in cost range.

Getting it wrong before purchasing real estate is the most consequential and most common mistake Georgian Bay prefab buyers make.

Lot TypeDelivery MethodEst. All-In Range
Road-accessible, southern corridorFlatbed + craneCAD $450,000–$800,000+
Water-access-only, 30,000 IslandsBarge + craneCAD $500,000–$900,000+
Island lot, remote archipelagoFull marine logisticsCAD $700,000–$1,200,000+
Grandfathered footprintDepends on accessConfirm at site assessment
Near-escarpment, NEC zoneFlatbed + craneCAD $500,000–$900,000+

Excludes land cost and HST at 13 percent. Confirm with a My Own Cottage site assessment before budgeting.

Road-Accessible Shoreline Lots — Southern Georgian Bay Corridor

The most common and most predictable Georgian Bay prefab scenario for the Collingwood, Wasaga Beach, Stayner, Meaford, and Blue Mountains corridor.

Standard flatbed delivery via Highway 400 and Highway 26. Niagara Escarpment Commission (NEC) Development Permit required for lots within the Escarpment Plan area.

Nottawasaga Valley Conservation Authority (NVCA) permit required for development within regulated shoreline areas. This is the most predictable permit pathway in the Georgian Bay region.

Water-Access-Only Lots — 30,000 Islands and Parry Sound Archipelago

The dominant lot type north of Honey Harbour. Barge delivery from Parry Sound Harbour, Honey Harbour, or Pointe au Baril staging areas.

Open Georgian Bay water exposure requires more conservative weather-window scheduling than protected lake deliveries.

Barge adds CAD $30,000 to $80,000 to the project budget — incurred once rather than accumulated across months of sequential material transport.

Island Lots — Remote Archipelago Properties

Everything arrives by water: modules, foundation materials, equipment, and construction crews.

Long-term access planning for mechanical servicing, propane delivery, and emergency response is a fundamental design requirement on island properties — not an item to revisit after delivery.

Financing and insurance for island properties are more restrictive than mainland waterfront; a mortgage broker experienced with Near North recreational property should be consulted before any island lot purchase is finalised.

Grandfathered Footprint Lots — Existing Cottage Replacement

A significant number of Georgian Bay lots have existing seasonal cottages on footprints that pre-date current shoreline setback requirements.

Demolishing and replacing on the same footprint preserves a lakefront or bay-front position that current zoning would not permit as a new build — a meaningful structural advantage on a water where buildable shoreline is finite.

Requires pre-consultation with the Township building department and the applicable Conservation Authority to confirm grandfathering eligibility before any design is commissioned.

Near-Escarpment Lots — Collingwood and Blue Mountains Corridor

The most complex regulatory environment in the southern Georgian Bay corridor. NEC Development Permit required above all other municipal and Conservation Authority approvals.

The Niagara Escarpment Development Permit is the approval layer most consistently absent from Georgian Bay prefab buyer conversations — and the one most likely to produce a costly surprise after a purchase offer is signed.

Properties within the Escarpment Plan area require this permit in addition to every other municipal and Conservation Authority approval in the southern corridor.

It is a real, material, and time-sensitive approval that buyers targeting the Blue Mountains and Collingwood corridor must understand before selecting a builder, commissioning any drawings, or finalising any purchase offer on escarpment-zone land.

The Regulatory Framework — What Georgian Bay Buyers Must Navigate

Georgian Bay buyers face a regulatory environment more layered than any other Ontario cottage country destination.

The specific agencies involved depend on your sub-region — but most Georgian Bay waterfront prefab builds require at least three and often four or five separate approvals. All of them must be initiated simultaneously.

Sequential applications are the most consistent cause of Georgian Bay permit timelines extending to 12 months or more when 6 months is achievable on a complete first submission.

The diagram below shows exactly how these five approval streams run in parallel, and why submitting them simultaneously is the difference between a six-month timeline and a year-long delay.

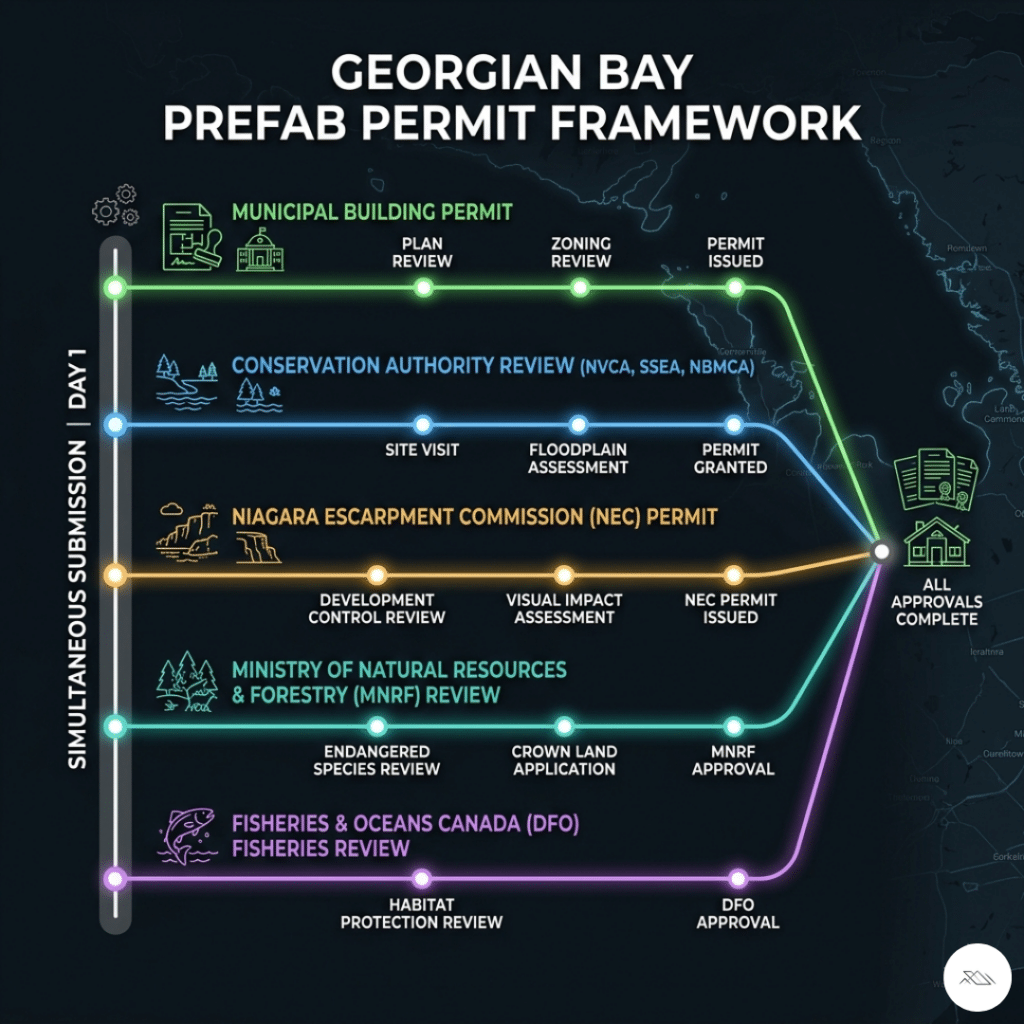

Prefab homes Georgian Bay permit framework diagram showing five simultaneous approval streams including municipal building permit Conservation Authority NVCA SSEA NBMCA Niagara Escarpment Commission MNRF and DFO converging into one permit package for waterfront and island lot construction 2026

Most Georgian Bay prefab builds require up to five approvals across municipal, Conservation Authority, and provincial agencies — submitted simultaneously to avoid 12+ month delays.

Municipal Building Permit — Ontario Building Code Compliance

Issued by the applicable area municipality — Township of Georgian Bay, Tiny Township, Tay Township, Town of the Blue Mountains, or the Town of Collingwood.

CSA A277 factory certification streamlines the inspection pathway in Georgian Bay’s area municipalities where building inspection capacity is limited during peak cottage construction season.

Factory inspection records substitute for many on-site municipal inspection visits — a significant scheduling advantage when inspectors are traveling to remote shoreline and island lots.

Conservation Authority Permits — NVCA, SSEA, and NBMCA

Three Conservation Authorities govern different portions of the Georgian Bay watershed, and knowing which one has jurisdiction over your specific lot is a prerequisite for any pre-application consultation.

• The Nottawasaga Valley Conservation Authority (NVCA) governs the southern Georgian Bay watershed — Collingwood, Wasaga Beach, and the Nottawasaga River corridor.

• The Severn Sound Environmental Association (SSEA) covers the Midland, Penetanguishene, and Tay Township shorelines of Georgian Bay’s inner bay.

• The North Bay-Mattawa Conservation Authority (NBMCA) covers the northern reaches toward Parry Sound District.

Each requires a Section 28 permit for development within 30 metres of a regulated shoreline — a separate approval from the municipal building permit, not a substitute for it.

My Own Cottage’s crane-set modular installation disturbs less ground within the regulated shoreline buffer than months of conventional framing — a quantifiable advantage in Conservation Authority permit applications across all three jurisdictions.

Niagara Escarpment Commission — The Southern Layer

Properties along the escarpment edge from the Blue Mountains toward Collingwood require a Niagara Escarpment Development Permit in addition to all other approvals.

The NEC publishes online mapping of its plan area.

Verify your lot’s NEC status before finalising any purchase offer in the southern Georgian Bay corridor — this approval adds timeline and cost that must be factored into your project schedule from the outset.

MNRF, DFO, and Biosphere Reserve Considerations

MNRF involvement is triggered by provincially significant wetlands, endangered species habitat, or Crown land proximity.

DFO review applies to any in-water or shoreline work with potential to harm fish or fish habitat — this includes dock construction adjacent to a prefab delivery site and certain foundation work near the waterline.

The Georgian Bay Biosphere Reserve is a UNESCO-designated area covering portions of the Georgian Bay shoreline and the 30,000 Islands archipelago.

It does not create its own separate permit stream, but it reinforces the Conservation Authority and municipal requirements already in place and informs the ecological sensitivity standards against which planning decisions are evaluated.

Minimal site disturbance construction methods are a planning preference for lots within the Biosphere area.

For the complete four-layer Muskoka-specific permit framework with verified development charges and the January 1 indexing deadline see our prefab home permits Muskoka guide — many of the same provincial regulatory layers apply across the Georgian Bay region.

Canadian Shield Foundations — The Decision That Sets Your Georgian Bay Site Budget

Foundation choice on a Georgian Bay waterfront lot is the most consequential single site decision before any model is selected.

The Precambrian Shield bedrock underlying the majority of Georgian Bay waterfront and island lots makes conventional basement excavation either impractical or prohibitively expensive on most properties.

The cost differences between these foundation types come down to one factor: how each system interacts with Canadian Shield bedrock.

The diagram below shows exactly why some approaches require excavation or blasting—while others, like helical piers, can be installed directly into rock with minimal site disruption.

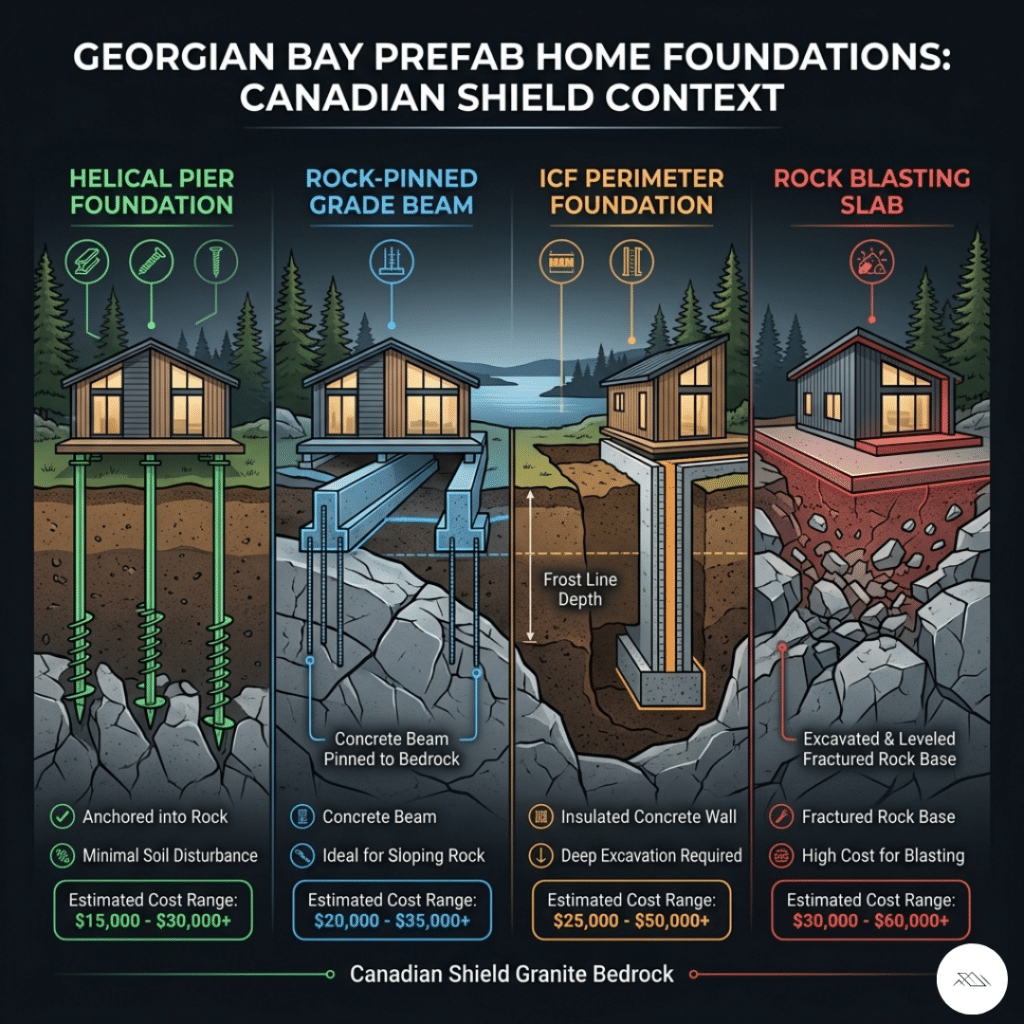

Prefab homes Georgian Bay foundation comparison cross-section showing helical piers, rock-pinned grade beams, ICF foundations, and rock-blasting slab options on Canadian Shield bedrock with cost ranges and suitability

How each foundation type interacts with Canadian Shield bedrock—why helical piers are typically the most efficient and least disruptive solution for Georgian Bay builds.

Conventional poured concrete basement excavation on Shield rock frequently requires mechanical cutting or blasting before a single foundation element is placed — adding CAD $50,000 to $100,000-plus to the project before any home arrives on the lot.

My Own Cottage modular homes are engineered specifically to eliminate this cost.

Helical Piers — The Standard Solution on Canadian Shield

Helical piers are steel screw piles driven into bedrock-adjacent soils or grouted directly into rock.

No excavation. No concrete forms. No spoil removal.

Pier heads adjust in height to create a level bearing surface across uneven granite outcrops, and modules can be crane-set the same day piers are inspected — no concrete cure time required.

Cost: CAD $10,000 to $25,000 for a standard My Own Cottage build.

Compact tracked equipment required for pier installation can be barged to island lots, producing minimal site disturbance within the Conservation Authority’s regulated shoreline buffer — a documented permit application advantage across all three Georgian Bay CA jurisdictions.

Grade Beams, ICF, and Rock-Blasting When Required

Where bedrock is at or near the surface with insufficient soil depth for pier installation, rock-pinned grade beams — poured concrete beams anchored to the granite by embedded rods — are the appropriate engineered alternative.

ICF foundation perimeter construction is the appropriate choice for four-season year-round occupancy requiring a conditioned basement or crawlspace, where lot topography permits excavation below Georgian Bay’s 1.2-metre frost depth.

Effective R-values of R-22 to R-28 continuous. Cost: CAD $35,000 to $80,000.

Rock-blasting where required is a regulated activity — a municipal permit and adherence to provincial blasting regulations are both mandatory.

A geotechnical assessment (CAD $3,000 to $8,000) is recommended before any foundation type is specified for a specific Georgian Bay lot.

Foundation TypeTypical CostBest Scenario
Helical piersCAD $10,000–$25,000Rocky or sloped lots, island, CA buffer
Rock-pinned grade beamCAD $20,000–$40,000Surface bedrock, no pier penetration
ICF perimeterCAD $35,000–$80,000Excavatable terrain, four-season year-round
Rock-blasting + slabCAD $40,000–$100,000+Constrained footprint, level pad required

Delivering Prefab Homes to Georgian Bay — Barge, Crane, and Access Logistics

Delivery method is entirely determined by lot access and module size.

For road-accessible southern Georgian Bay lots, the logistics follow the same Highway 400/Highway 26 flatbed route as any other Near North delivery.

For water-access-only lots and island properties in the 30,000 Islands and Parry Sound archipelago, barge delivery is not a complication. Instead, it is the precisely coordinated construction sequence that makes prefab the only genuinely practical construction method on remote Georgian Bay shoreline and island lots within a single build season.

Road-Accessible Delivery — Highway 400 and Highway 26 Corridor

Modular sections travel from the Orillia manufacturing facility to the lot via flatbed trailer on Highway 400 and Highway 26.

Sections exceeding Ontario highway legal load dimensions require Oversize/Overweight permits from the MTO issued through the HiQ system — approved routes, daylight-only travel hours, and escort vehicle requirements specified per permit.

A mobile crane positioned at the road edge or on the lot crane-sets a two to three module home in a single day.

This is the construction technique that eliminates rain delays, trade scheduling conflicts, and the sequential material deliveries that compress six months of available Georgian Bay build season into a series of weather-dependent holding patterns.

Barge Delivery to the 30,000 Islands — Costs, Timing, and Module Pre-Engineering

For water-access Georgian Bay lots, modular sections are transported from a marine staging area by barge.

The three primary staging areas serving the Georgian Bay prefab market are Parry Sound Harbour, Honey Harbour, and Pointe au Baril — each serving different portions of the archipelago and offering different draft depths and load capacity.

Prefab home module transported by barge across open Georgian Bay water to a 30,000 Islands site, showing modular delivery logistics for water-access-only island construction

A prefab home module in transit across Georgian Bay by barge—documenting the real delivery process used for water-access-only island builds in the 30,000 Islands.

Barge platform weight limits govern module sizing. Sections must be pre-engineered for available barge deck dimensions during the design stage — not adapted after factory production has begun.

This is a design-phase conversation between My Own Cottage’s engineering team and the marine contractor, coordinated before any floor plan is finalised.

Practical delivery window: ice-out in late April to early May through freeze-up in late November.

Open Georgian Bay water conditions — including prevailing westerly swells and afternoon thermal winds — require more conservative weather-window scheduling than protected lake deliveries in Muskoka.

Cost addition: CAD $30,000 to $80,000 for marine transport, crane co-ordination, and staging — incurred once, not accumulated across months of individual material deliveries.

The emotional appeal of barge delivery to a Georgian Bay island is well documented in cottage country publishing — the romance of a nearly complete home arriving by water and being assembled in days on a remote Canadian Shield lot is a genuinely compelling story.

What has never been documented for Georgian Bay buyers is what that process actually costs, where staging areas are located, how modules must be pre-engineered for barge deck dimensions, and what the seasonal delivery window looks like on open Georgian Bay water versus a protected lake.

That operational guidance is what follows.

Crane Operations and the Seasonal Build Window

Crane-set on island lots uses a floating crane barge where water depth alongside the shoreline permits. For lots with restricted dock access, compact tracked crane equipment is barged to site.

For truly constrained sites where water depth or shoreline geometry prevents both options, helicopter-slung equipment handles lighter panelised loads — expensive but viable and occasionally the only option on the most remote 30,000 Islands properties.

Georgian Bay’s ice-road and freeze-up windows open equipment access routes to some water-access lots during winter that are inaccessible in summer — foundation installation during freeze-up, factory production during winter, and spring barge delivery and module installation converging on a single crane-set day.

My Own Cottage’s parallel build model is designed precisely for this sequencing.

All-In Costs for a Prefab Home on Georgian Bay

Factory pricing is the starting point — and consistently the most misunderstood component of a Georgian Bay prefab project budget.

The factory price covers what My Own Cottage manufactures and delivers to your lot: a near-complete home including framing, insulation, vapour barrier, electrical rough-in, plumbing rough-in, and interior finishes, produced in a controlled environment.

The ranges below consolidate complete all-in project costs by lot type, including site preparation, foundation, permits, and delivery logistics specific to the region.

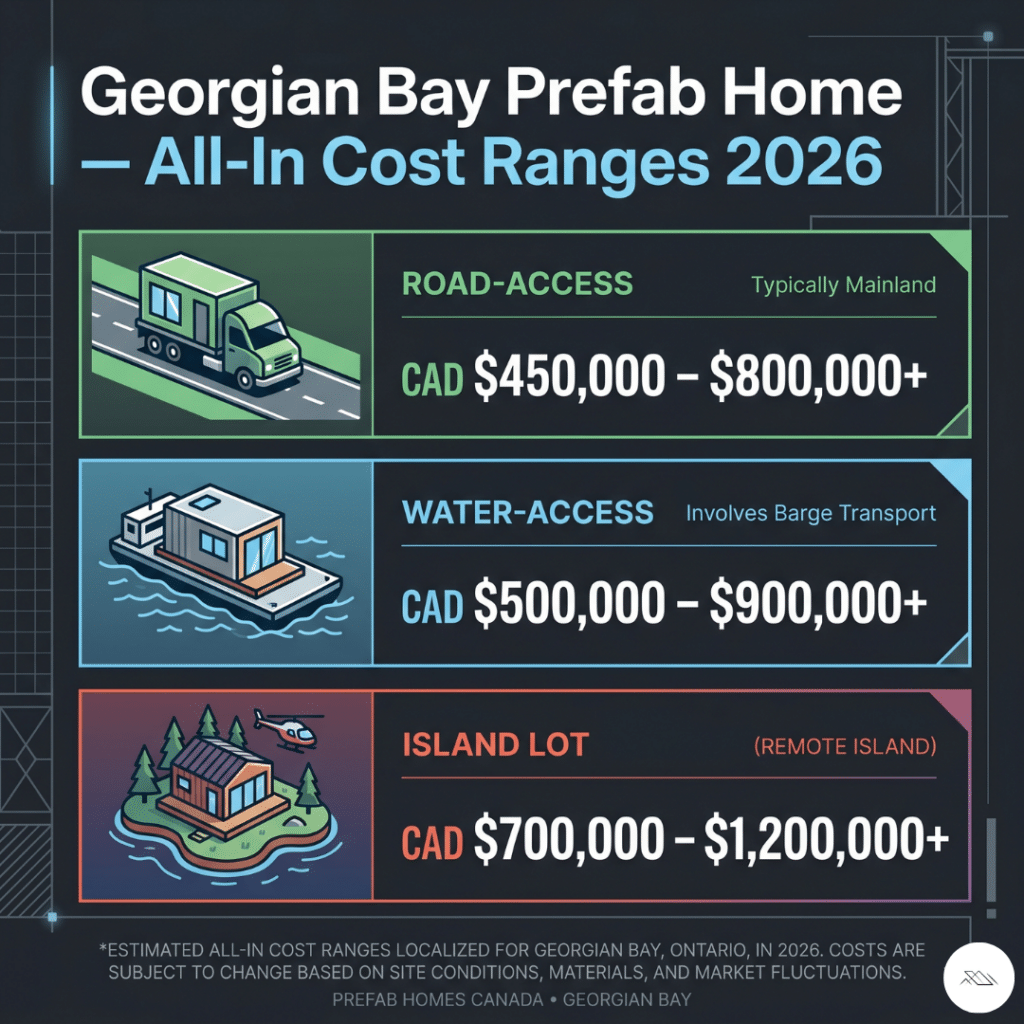

Prefab homes Georgian Bay all-in cost ranges 2026 showing road-access CAD 450000 to 800000 water-access CAD 500000 to 900000 and island lot CAD 700000 to 1200000 by lot type

Verified all-in cost ranges for Georgian Bay prefab homes by lot type—reflecting full project costs beyond factory pricing.

In our facility, every trade works in dry, climate-controlled conditions with no rain delays and no weather-dependent scheduling gaps.

What the factory price does not cover is everything that happens between the boundary of your lot and the module’s bearing beam — and on Georgian Bay’s waterfront and island lots, that gap is where projects become unpredictable for buyers who did not model it at the outset.

ScenarioFactory Price RangeEst. All-In
Road-accessible, mid-range four-seasonCAD $289,500–$619,500CAD $450,000–$800,000+
Water-access-only, mid-range four-seasonCAD $289,500–$619,500CAD $500,000–$900,000+
Island lot, premium four-seasonCAD $519,500–$949,500CAD $700,000–$1,200,000+

HST at 13 percent applies. Development charges: confirm with the applicable municipality before budgeting. NEC Development Permit fees and studies additional in escarpment zone.

Site-Work Add-Ons Unique to Georgian Bay

The site costs most consistently underestimated by Georgian Bay prefab buyers:

• Barge and crane logistics: CAD $30,000 to $80,000 for water-access and island lots.

• Rock-blasting where bedrock requires a level pad: CAD $15,000 to $50,000.

• Engineered septic system on Canadian Shield terrain — mound or advanced treatment unit: CAD $25,000 to $60,000.

• Well drilling into bedrock fractures: CAD $10,000 to $25,000.

• Off-grid power for lots without Hydro One connection (solar, battery, propane backup): CAD $40,000 to $120,000.

• Ontario Land Surveyor for high-water mark establishment on waterfront lots: CAD $2,500 to $6,000.

• NEC Development Permit fees and associated studies in the escarpment zone: CAD $500 to $5,000-plus.

Package pricing for Georgian Bay prefab homes is widely advertised on a per-square-foot basis — a figure that reflects the building package only and excludes every site-specific cost that makes Georgian Bay builds meaningfully more expensive than a standard Southern Ontario lot.

Barge logistics, helical pier installation on bedrock, engineered septic on Shield terrain, off-grid power, and Conservation Authority permit studies are all absent from a per-square-foot headline.

A complete, honest all-in cost estimate for a Georgian Bay build requires a site assessment before a single line item is confirmed.

My Own Cottage provides complete all-in estimates covering both the factory budget and the full Georgian Bay-specific site budget at the first consultation — before any model is selected and before any contract is signed.

For verified all-in cost scenarios across all Muskoka and Near North lot types see our Muskoka prefab home prices guide.

Off-Grid Prefab Configurations for Georgian Bay Island Lots

A significant proportion of Georgian Bay island and remote lots lack a Hydro One grid connection — with connection costs ranging from CAD $10,000 for a short existing pole run to CAD $50,000-plus for a remote island aerial or submarine cable installation.

An off-grid system is not a collection of components — it is a fully integrated, real-world solution that must perform reliably on a remote Georgian Bay island lot. The image below shows exactly how these systems come together in a completed prefab home operating without any Hydro One connection.

Off-grid prefab home Georgian Bay island lot at blue hour with solar panels warm interior lighting large picture windows helical pier foundation on Canadian Shield granite and open water showing fully powered modular cottage without Hydro One connection 2026

A completed off-grid prefab home on a Georgian Bay island lot — solar-powered, fully serviced, and operating year-round without any Hydro One connection.

My Own Cottage designs accommodate the full off-grid configuration required for four-season year-round comfort on Georgian Bay island lots, including:

• Solar panel integration sized for Climate Zone 6 to 7 demand

• Battery storage systems

• Cold-climate air-source heat pumps rated for minus 25°C sustained operation

• Propane backup heating and hot water

• UV-filtered lake water intake or drilled well supply

• Aerobic treatment or composting septic systems approved under OBC Part 8

Geothermal heating is also available where site conditions permit — though the Shield geology that defines most Georgian Bay island lots makes vertical closed-loop systems the more practical option over horizontal arrays on thin-soil properties.

Off-grid utility packages for Georgian Bay island applications add CAD $40,000 to $120,000 to the project budget depending on solar array capacity, battery bank sizing, and heating system selection.

The Georgian Bay Biosphere Reserve’s ecological sensitivity makes minimal-impact off-grid configurations a planning preference for shoreline and island lots within the Biosphere area.

Solar arrays and helical pier systems are specifically well-suited to the low-disturbance build standard that Conservation Authorities across all three Georgian Bay jurisdictions prefer on sensitive shoreline sites.

Seasonal vs Four-Season — The Classification That Shapes the Georgian Bay Build

Georgian Bay falls within Climate Zone 6 to 7 under the National Energy Code of Canada.

Four-season OBC classification requires above-grade wall insulation targeting R-28 to R-40, R-40 to R-60 attic assemblies, freeze-protected plumbing with heat-traced lines, and heating systems — including cold-climate air-source heat pumps — rated for sustained minus 25°C to minus 30°C operation.

My Own Cottage provides these specifications as standard across our Georgian Bay model range, producing a building envelope quality in a controlled factory environment that consistently exceeds what is achievable through site-built construction on a remote Georgian Bay lot under the same budget.

A cottage permitted as seasonal cannot qualify for CMHC mortgage insurance on primary residence terms, cannot qualify for full Tarion 1-2-7 year warranty coverage, and faces more restrictive insurance classification.

This is particularly relevant on island properties where replacement cost and vacancy periods create additional underwriter scrutiny.

Confirm which classification applies to your intended use at the first consultation, before any permit application is prepared.

For the complete seasonal versus four-season OBC compliance framework including SB-12 R-value requirements, Tarion implications, and CMHC eligibility conditions see our prefab cottages Muskoka guide.

My Own Cottage — Prefab Homes for Georgian Bay Waterfront and Island Lots

My Own Cottage is based in Orillia — within the Georgian Bay watershed and on the primary Highway 400/Highway 69 delivery corridor for the Near North — and delivers OBC compliant prefab homes across the full Georgian Bay region.

Our service area includes:

• Township of Georgian Bay

• Tiny Township

• Tay Township

• Penetanguishene

• Midland

• Collingwood

• Blue Mountains corridor

• The Parry Sound District

• Water-access and island lots throughout the 30,000 Islands archipelago

By this point, you’ve seen how Georgian Bay builds are defined by lot type, logistics, and regulatory constraints.

What that process ultimately delivers is not a generic cottage — but a completed home designed specifically for this shoreline, this granite, and this water.

Completed premium prefab home Georgian Bay waterfront shoreline in peak autumn foliage with large picture windows Canadian Shield granite base and open water reflection showing four-season modular cottage 2026

A completed premium prefab home on Georgian Bay—designed for Canadian Shield terrain and four-season waterfront living.

We are one of the few prefab home builders in Ontario with the site assessment process, engineering relationships, marine contractor coordination experience, and permit management capacity to serve the full range of Georgian Bay lot types.

We work everywhere, from serviced road-accessible properties in the southern Simcoe County corridor to remote island lots where every component of the construction project arrives by barge.

Our service areas span from Georgian Bay Township in the north through Tiny Township, Tay Township, Midland, and Wasaga Beach to Collingwood, Stayner, and the Blue Mountains in the south — covering every permit jurisdiction and Conservation Authority boundary across this region.

Every Georgian Bay project begins with a complete site assessment confirming lot type, Conservation Authority jurisdiction, NEC status where applicable, high-water mark setback implication, foundation type suitability for your Canadian Shield terrain, delivery access route and marine logistics, septic design requirements, and verified all-in cost.

All before any home design is selected and before any contract is signed.

Our project managers guide you through every step of the way from first site assessment through occupancy permit.

OBC compliant. HCRA-licensed. Tarion enrolled on every build. Verify our active licence at the Ontario Builder Directory before signing any purchase agreement.

“We felt absolutely well taken care of. Feedback was always prompt, very professional, yet personal and individualized. Above all, the information provided in advance was very detailed and extremely helpful. My Own Cottage Inc. is absolutely recommendable!” ⭐⭐⭐⭐⭐ — Ilva Drumm, Muskoka, Ontario

No surprises. No hidden costs. No pressure.

🧑‍💼 Request a Free Consultation
📲 Call Us Directly: (705) 345-9337
🏘️ View Our Design Catalogue

✅ Ontario-Built | ⚡ Energy-Efficient | 🏡 Fully Customizable | 🚚 Fast Delivery

Alternatively, for your convenience, you can also simply fill out the contact form below and we’ll get back to you soon! 👇

Contact Us

We usually respond within 24 hours!

Frequently Asked Questions — Prefab Homes Georgian Bay

Can you build a prefab home on a Georgian Bay island lot?

Yes — prefab and modular homes are entirely legal on Georgian Bay island lots provided they comply with the Ontario Building Code and the applicable area municipality’s zoning provisions.

Island lots in the 30,000 Islands and Parry Sound District require a Conservation Authority Section 28 permit from the applicable authority (NVCA, SSEA, or NBMCA depending on watershed location), MNRF review where provincially significant natural features are present, and potentially a DFO review for in-water dock or foundation work adjacent to fish habitat.

Delivery is managed through barge transport from Parry Sound Harbour, Honey Harbour, or Pointe au Baril, with crane-set installation on pre-installed helical piers. My Own Cottage coordinates water-access island lot deliveries and confirms logistics at site assessment before any contract is signed.


How much does a prefab home cost on Georgian Bay?

All-in costs vary significantly by lot type.

A mid-range four-season prefab on a road-accessible southern Georgian Bay lot typically runs CAD $450,000 to $800,000-plus — combining a factory price from CAD $289,500 to $619,500 with a site budget of CAD $100,000 to $200,000-plus covering foundation, Conservation Authority permits, engineered septic, and soft costs. Water-access-only lots add CAD $30,000 to $80,000 for barge and crane logistics.

Island lot builds typically run CAD $700,000 to $1,200,000-plus all-in.

For a specific scenario: a two-bedroom mid-range prefab Georgian Bay cottage in the 800 to 1,100 sq ft range — Fox Den at 505 sq ft or Lake View at 741 sq ft from My Own Cottage’s compact catalogue — typically runs CAD $350,000 to $550,000 all-in on a road-accessible lot, with barge delivery to a Georgian Bay island adding CAD $30,000 to $80,000 to that baseline.

Package pricing advertised on a per-square-foot basis reflects the building package only and excludes every site-specific cost that makes Georgian Bay builds meaningfully more expensive than a standard Southern Ontario lot.

My Own Cottage provides complete all-in estimates at the first consultation before any model is selected.


What are the advantages of prefab over stick-built construction on Georgian Bay?

The advantages of factory-built construction over conventional site-built methods are amplified specifically in Georgian Bay — and that distinction matters more here than in most Ontario markets.

Speed and predictability are the headline advantages. Factory production runs in a controlled environment completely unaffected by Georgian Bay weather — no rain delays, no frost events, no seasonal scheduling gaps.

A completed prefab home can be crane-set in a single day on road-accessible lots and delivered by barge to island lots in one marine logistics sequence — replacing months of sequential material transport that site-built construction requires on the same water-access properties.

Site disturbance is the Conservation Authority advantage.

My Own Cottage’s crane-set modular installation disturbs less ground within the regulated 30-metre shoreline buffer than weeks of conventional framing activity — a quantifiable advantage in NVCA, SSEA, and NBMCA permit applications across the Georgian Bay watershed.

Quality control in a factory environment is consistent in ways that remote site-built construction cannot match.

Every trade works in dry, climate-controlled conditions with complete material access. Building envelope quality — vapour barrier continuity, insulation installation consistency, air barrier integrity — is more reliably achieved in a manufacturing facility than on a remote Georgian Bay island in November.

Cost predictability on a Georgian Bay site-built project is nearly impossible to achieve.

Prefab’s fixed factory price and confirmed delivery date eliminate the weather-dependent variables that make remote Georgian Bay site-built budgets consistently exceed their initial estimates.


What permits are required for a prefab home on Georgian Bay?

Required permits depend on your specific lot location.

Most Georgian Bay waterfront prefab builds require:

• A municipal building permit from the applicable township

• A Conservation Authority Section 28 permit from the NVCA, SSEA, or NBMCA depending on watershed jurisdiction

• Where applicable a Niagara Escarpment Development Permit from the NEC for escarpment-zone properties in the Blue Mountains and Collingwood corridor

MNRF review may be required where provincially significant wetlands or endangered species habitat is present.

DFO review applies to in-water work with potential to harm fish habitat. All applications must be initiated simultaneously — not sequentially.

My Own Cottage manages Conservation Authority engagement and permit coordination for every Georgian Bay build as standard.

For the complete four-layer permit framework with verified development charges see our prefab home permits Muskoka guide — many of the same provincial regulatory layers apply across the Georgian Bay region.


Are there specific zoning regulations for modular homes in Georgian Bay municipalities?

Modular and prefab homes are not subject to separate or more restrictive zoning treatment than site-built homes in any Georgian Bay municipality — provided the home is built to Ontario Building Code standards and sits on an approved permanent foundation.

The OBC treats factory-built dwellings identically to site-built construction for zoning, permitting, and resale purposes once those two conditions are met.

What does vary by municipality is how shoreline residential zoning is applied to your specific lot.

Setback distances from the high-water mark, lot coverage limits, accessory structure size caps, and permitted uses all differ between the Township of Georgian Bay, Tiny Township, Tay Township, and the Town of the Blue Mountains.

These are not prefab-specific regulations — they are shoreline and waterfront residential provisions that apply to any new construction on a Georgian Bay lot.

Confirming the applicable zoning sub-category with the specific municipal planning department before purchasing land is the most consequential pre-purchase due diligence step available.

My Own Cottage confirms the applicable zoning designation for every Georgian Bay lot at site assessment before any floor plan is commissioned.


What foundation works best on Canadian Shield bedrock in Georgian Bay?

Helical piers are the preferred foundation for the majority of Georgian Bay waterfront and island lots on Canadian Shield bedrock — no excavation, no concrete forms, same-day module installation after pier inspection, and minimal site disturbance within the Conservation Authority’s regulated shoreline buffer.

Cost: CAD $10,000 to $25,000 compared to CAD $50,000 to $100,000-plus for conventional basement excavation with potential bedrock blasting.

Compact tracked equipment required for pier installation can be barged to island lots. A geotechnical assessment (CAD $3,000 to $8,000) is recommended before any foundation type is specified for a Georgian Bay lot.

Where bedrock is at surface with insufficient soil depth for pier installation, rock-pinned grade beams are the appropriate engineered alternative.

ICF foundation perimeter construction is the correct choice for four-season year-round occupancy requiring conditioned basement space where excavation is possible.


What prefab home designs are suited to the Georgian Bay climate?

Georgian Bay falls within Climate Zone 6 to 7 under the National Energy Code of Canada — one of the most demanding thermal performance environments in Ontario cottage country.

The right home plans for this climate prioritize building envelope performance above aesthetics, because a beautiful home that underperforms thermally is a costly mistake to correct after the fact.

My Own Cottage’s Georgian Bay-ready model range features four-season specifications as standard:

Above-grade wall insulation targeting R-28 to R-40 using spray polyurethane foam for genuine energy savings in Muskoka’s winters

R-40 to R-60 attic assemblies, triple-glazed Low-E argon windows — including picture windows and terrace swing doors sized for Georgian Bay lake views

Entry doors rated for sustained minus 30°C conditions, and heating systems including cold-climate air-source heat pumps

Open-concept living room and great room layouts with large lake-facing glazing maximize natural light and lake views while the tight factory-built building envelope retains heat.

Cathedral ceilings with exposed structural timbers are available across the premium model range.

Modern prefab homes built to these specifications deliver year-round comfort, genuine energy efficiency, and a living experience that compares favourably to any custom-built home in the region — at a fraction of the construction timeline.

For compact Georgian Bay cottage builds, our Fox Den at 505 sq ft and Lake View at 741 sq ft deliver efficient living space within Muskoka’s accessory structure size parameters.

For the complete sleeping cabin regulatory framework by township see our prefab bunkie Muskoka complete guide.

For family homes and primary residences in the Georgian Bay corridor, our Montebello, Muskoka, North Star, and Excelsior models offer premium sq ft ranges from 2,261 to 2,707 sq ft with customizable designs that suit your unique style and unique needs.


Can I customize a prefab home for my Georgian Bay lot?

Yes — My Own Cottage’s build process begins with your lot, not a catalogue page. Your lot’s orientation, lake views, shoreline setbacks, Conservation Authority regulated areas, and unique needs all shape the floor plan before a single factory drawing is produced.

Every model in our pre-designed homes catalogue can be adapted as a fully custom-built home, including:

• Floor plan modifications

• Window placement including picture windows and terrace swing doors sized for Georgian Bay views

• Interior design selections from flooring through cabinetry and fixtures

• Mechanical system specifications for four-season or off-grid use

• Roofline configurations suited to Georgian Bay’s snow load requirements

Structural changes are more constrained because the engineering is completed at the manufacturing facility level — but within that framework, the customizable designs available to a Georgian Bay buyer are extensive.

Common Georgian Bay-specific customizations include:

• Lake-facing glazing optimization for natural light and winter solar gain

• Muskoka Room additions for screened outdoor living space

• Off-grid utility packages for remote properties without Hydro One connection

• Wall system upgrades targeting higher R-value performance than the OBC minimum

• Open-concept living layouts with great room configurations that open to covered decks facing the water

Custom design consultations are available at no charge.

Our project managers guide you through every step of the way from the first site visit through occupancy permit — providing peace of mind at every stage of a building process that many homeowners find genuinely complex on their first Georgian Bay project.


What does site preparation involve for a Georgian Bay prefab build?

Site preparation for a Georgian Bay waterfront prefab build typically covers five categories completed before module delivery:

• Clearing and grubbing of the build footprint within Conservation Authority pre-approved limits.

• Access road or temporary driveway construction where required on road-accessible lots.

• Foundation installation — helical pier installation for most Shield terrain lots — a one to two day process with no excavation that is significantly less disruptive than the conventional site preparation required for poured foundations.

• Conservation Authority pre-approved vegetation management within the regulated shoreline buffer. Rough-in of well, septic, and hydro services to the foundation ready for module connection.

• For water-access island lots, all site preparation equipment and building materials arrive by barge — foundation materials, concrete grout for pier installation, septic system components, and mechanical rough-in materials are all marine-transported before module delivery.

Concrete floors or slab elements where applicable are designed and poured at the site preparation stage before any factory component arrives.

My Own Cottage’s project managers coordinate all site preparation trades for every Georgian Bay build — homeowners do not manage contractor scheduling, marine logistics, or Conservation Authority compliance independently.

Site preparation runs concurrent with factory production through the parallel build model, with both tracks converging on a single crane-set installation day.


How do I finance a prefab home on Georgian Bay?

CSA A277 certified modular homes on permanent foundations qualify for conventional mortgage financing, CMHC insured construction mortgages with as little as 5 percent down for a primary residence, and standard construction draw mortgages through major Canadian banks and credit unions.

Financing options for Georgian Bay prefab buyers are not materially different from financing options for site-built construction once those two conditions are met.

The financing complexity most Georgian Bay prefab buyers encounter is the construction draw misalignment: modular manufacturers typically require 80 percent of the factory price paid before modules leave the manufacturing facility, while construction draw mortgages release funds against on-site completion milestones.

Resolving this misalignment with your lender before signing any modular construction contract is essential — bridge financing, negotiated draw schedules, or a HELOC on an existing property are the standard solutions.

Island lots and off-grid properties attract additional lender scrutiny.

Water-access-only properties may require title insurance. Seasonal versus year-round occupancy classification affects mortgage product eligibility.

A mortgage broker experienced with Near North recreational property is strongly recommended before purchasing any Georgian Bay island lot intended for a prefab build.

For the complete financing framework see our affordable prefab homes Muskoka guide — the same CMHC and draw mortgage framework applies across the Georgian Bay region.


How long does a Georgian Bay prefab build take from order to move-in?

My Own Cottage’s factory manufacturing takes eight to sixteen weeks once engineering is finalised and a deposit is placed.

Site preparation — foundation installation, septic system design and permitting, Conservation Authority pre-consultation — runs concurrently with factory production through the parallel build model.

From contract signing to occupancy permit, most road-accessible Georgian Bay projects take seven to twelve months.

Water-access and island lots add barge scheduling time constrained by the Georgian Bay delivery window (late April to late November). Conservation Authority and NEC permit processing adds four to sixteen weeks depending on application complexity and the specific agencies involved.

The construction process itself — crane-set day for a two to three module home — takes one day on road-accessible lots. Barge delivery and crane-set on island lots takes one to three days depending on lot access, marine conditions, and module count.

The building solutions that make prefab genuinely faster in cottage country are not about any single phase running faster than traditional construction — they are about two phases (factory production and site preparation) running simultaneously rather than sequentially, converging on a single installation day.


What eco-friendly and energy-efficient prefab options are available for Georgian Bay?

Factory-built construction is inherently more sustainable than conventional site-built methods on Georgian Bay waterfront lots.

Controlled environment manufacturing reduces material waste significantly — a 2,500 sq ft modular home produces approximately 1,750 lbs of wood waste in a factory setting versus considerably more from an equivalent conventional site build.

The construction process eliminates weather-related material degradation. And the crane-set installation compresses the period of site disturbance within the Conservation Authority’s regulated shoreline buffer to a single day rather than months of sequential construction activity.

My Own Cottage’s four-season specifications approach net-zero ready performance without the full passive-house premium.

Our R-28 to R-40 above-grade wall assemblies, R-60 attic insulation, triple-glazed Low-E argon windows, and high-efficiency heating systems including air-source heat pumps produce a building envelope that delivers genuine energy savings over the lifetime of the home.

This is particularly relevant on Georgian Bay properties where propane or off-grid power costs are already a significant ongoing budget line.

Green building principles are embedded throughout the construction process: vapour barrier continuity, air barrier integrity, thermal bridge elimination, and high-performance wall system assemblies are all more consistently achieved in a manufacturing facility than on a remote Georgian Bay site in variable weather conditions.

For remote lots within the Georgian Bay Biosphere Reserve, our off-grid configurations — solar panel integration, battery storage, composting or advanced treatment septic — make minimal-impact, net-zero capable building solutions available even on the most ecologically sensitive shoreline properties.


Who builds prefab homes near Georgian Bay?

My Own Cottage is a OBC compliant, HCRA-licensed, Tarion enrolled prefab home builder serving the full Georgian Bay region — based in Orillia, within the Georgian Bay watershed and on the primary Highway 400/Highway 69 delivery corridor for the Near North.

We are one of the few cottage builders in Ontario with the site assessment process, engineering relationships, marine contractor coordination experience, and permit management capacity to serve the complete range of Georgian Bay lot types.

This includes everything from serviced road-accessible properties in the Collingwood and Wasaga Beach corridor through Tiny Township and Tay Township waterfront lots to remote island lots in the 30,000 Islands archipelago where every component of the construction project arrives by barge.

What distinguishes My Own Cottage from other Georgian Bay area home builders is not simply the prefab product — it is the complete build process management that begins with a site assessment confirming your lot’s regulatory framework, delivery logistics, and verified all-in cost before any floor plan is selected or any commitment is made.

No surprises at the site preparation stage. No hidden costs discovered after the factory order is placed. No pressure to commit before the due diligence is complete.

Verify our active HCRA registration at the Ontario Builder Directory before signing any purchase agreement — HCRA registration is mandatory for any builder selling a new home in Ontario.

Verified External Resources

Georgian Bay Township — Planning and Development — Zoning by-law, shoreline setback provisions, building permit applications, and coastal and island lot development policies.

Nottawasaga Valley Conservation Authority — Section 28 permit requirements for development within regulated areas in the southern Georgian Bay watershed including Collingwood and Wasaga Beach.

Severn Sound Environmental Association — Conservation authority jurisdiction for the Midland, Penetanguishene, and Tay Township shorelines of Georgian Bay’s inner bay.

Niagara Escarpment Commission — Niagara Escarpment Development Permit requirements for properties in the Blue Mountains and Collingwood corridor.

Georgian Bay Biosphere Reserve — UNESCO-designated area ecological sensitivity guidelines and shoreline naturalisation requirements.

Ontario MNRF — Public Lands Act — Crown land licence of occupation and MNRF approval requirements for structures near Crown land shorelines.

DFO — Fisheries Act — Federal review process for in-water and shoreline work with potential to harm fish or fish habitat.

Ontario Building Code — O. Reg. 332/12 — Primary provincial standard governing all prefab and modular home construction in Ontario.

CSA Group — CSA A277 Standard — Factory certification standard confirming that My Own Cottage’s quality management systems meet Ontario Building Code requirements.

HCRA — Ontario Builder Directory — Verify My Own Cottage’s active HCRA registration before signing any purchase agreement.

Tarion — New Home Warranty Program — Ontario’s statutory new home warranty — Tarion enrollment is mandatory for every My Own Cottage build.

CMHC — Mortgage Loan Insurance for Factory-Built Homes — Federal mortgage insurance eligibility for CSA A277 certified prefab homes on permanent foundations.

For the complete guide to prefab home construction across Muskoka and the Near North see our prefab homes Muskoka complete buyer’s guide.

For the complete four-layer permit framework with verified development charges and the January 1 indexing deadline see our prefab home permits Muskoka guide.

For verified all-in cost scenarios by lot type and model tier see our Muskoka prefab home prices guide.

For the complete guide to prefab construction on Lake Muskoka waterfront and island lots see our prefab homes Lake Muskoka guide.

For the cost-efficient path to cottage country prefab ownership see our affordable prefab homes Muskoka guide.

For the complete Ontario prefab overview see our prefab homes Ontario guide.
